Groundbreaking

December 17, 2025

St. Paul Catholic Church and St. Hubert Parish broke ground Tuesday for the new Parish Hall! Thank you to everyone who was able to come out on this beautiful day to experience the joy of seeing a project come to life. This is an exciting time for all of us to come together and show our support!

Construction begins

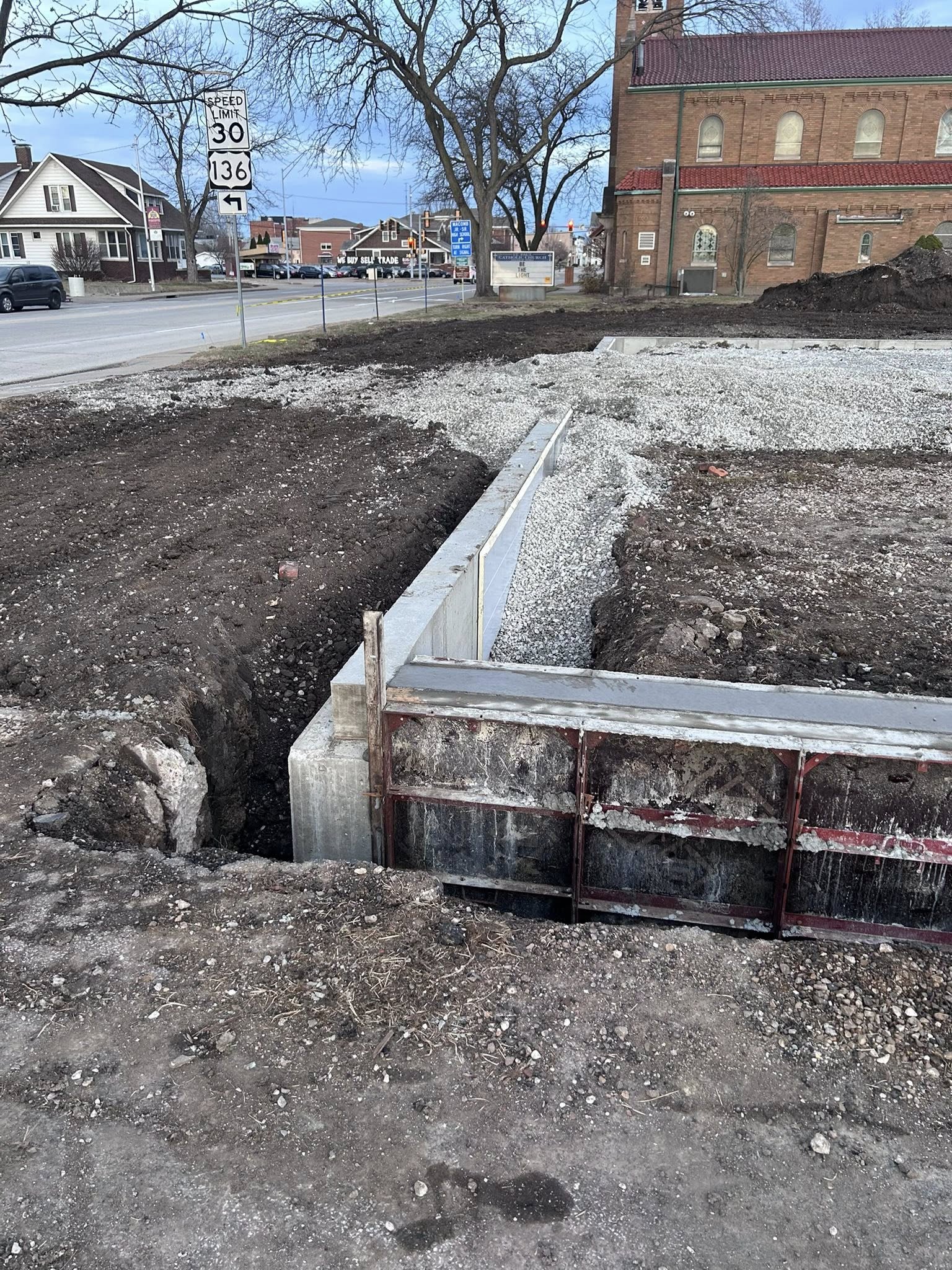

January 15, 2026

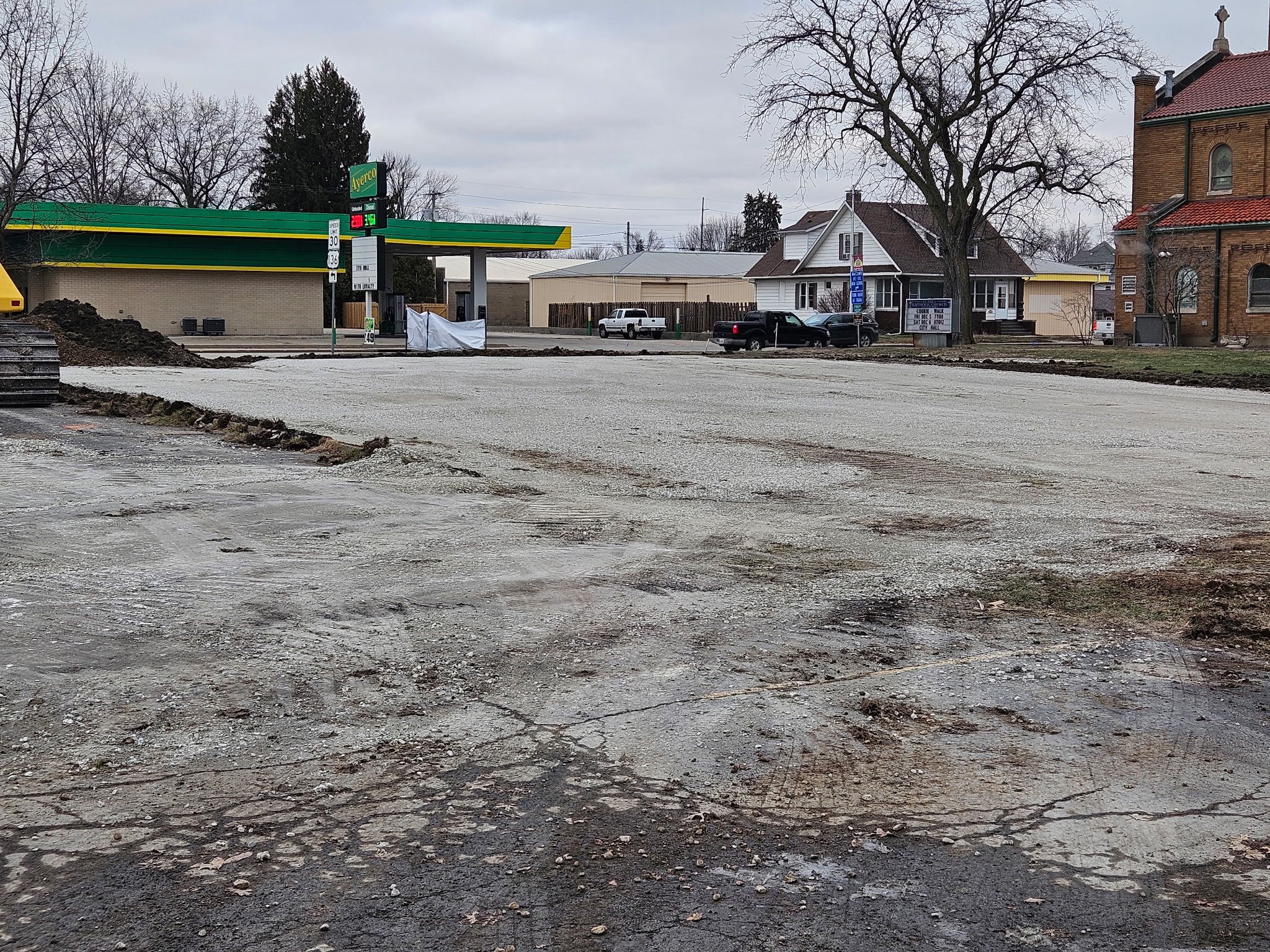

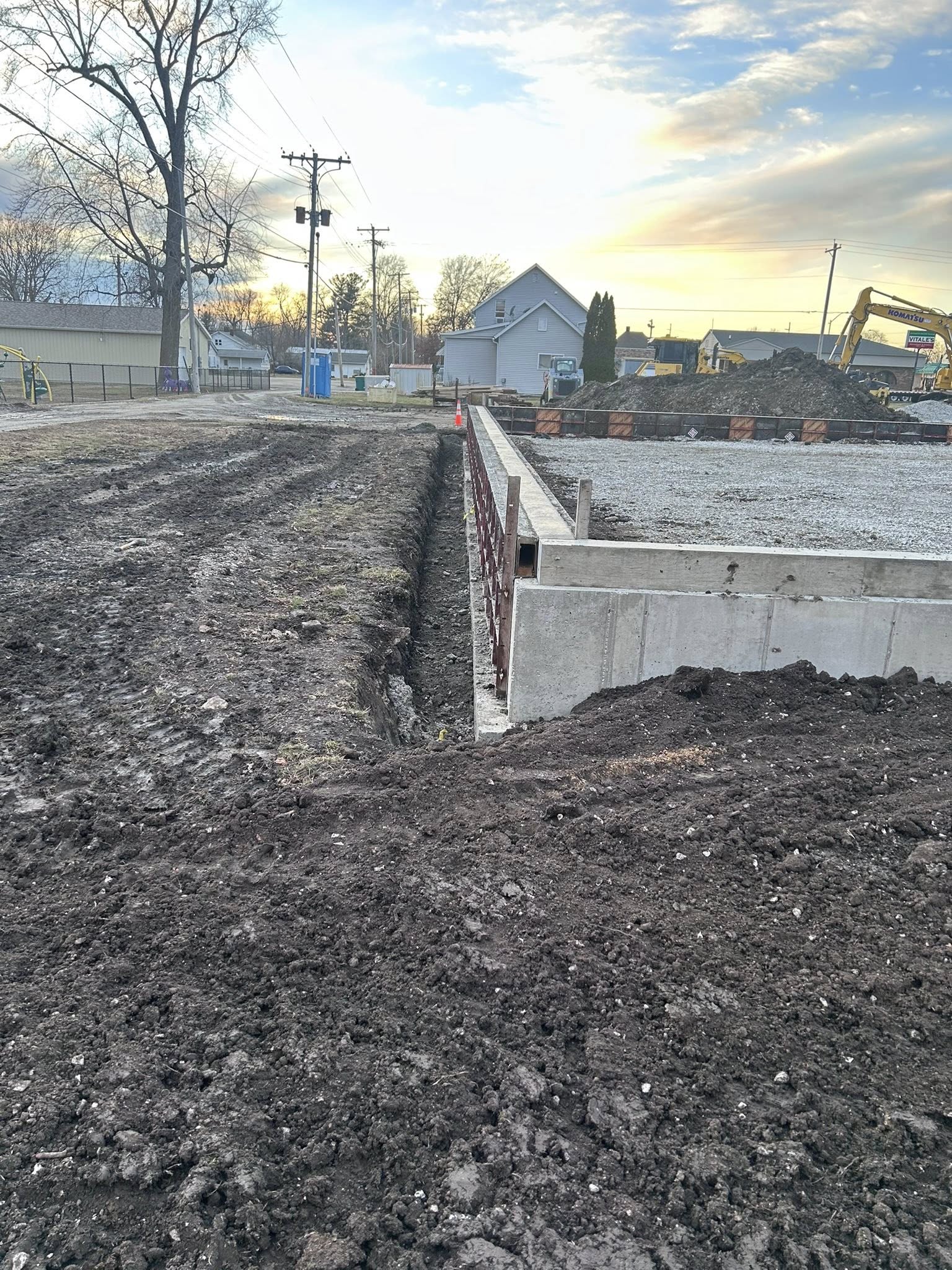

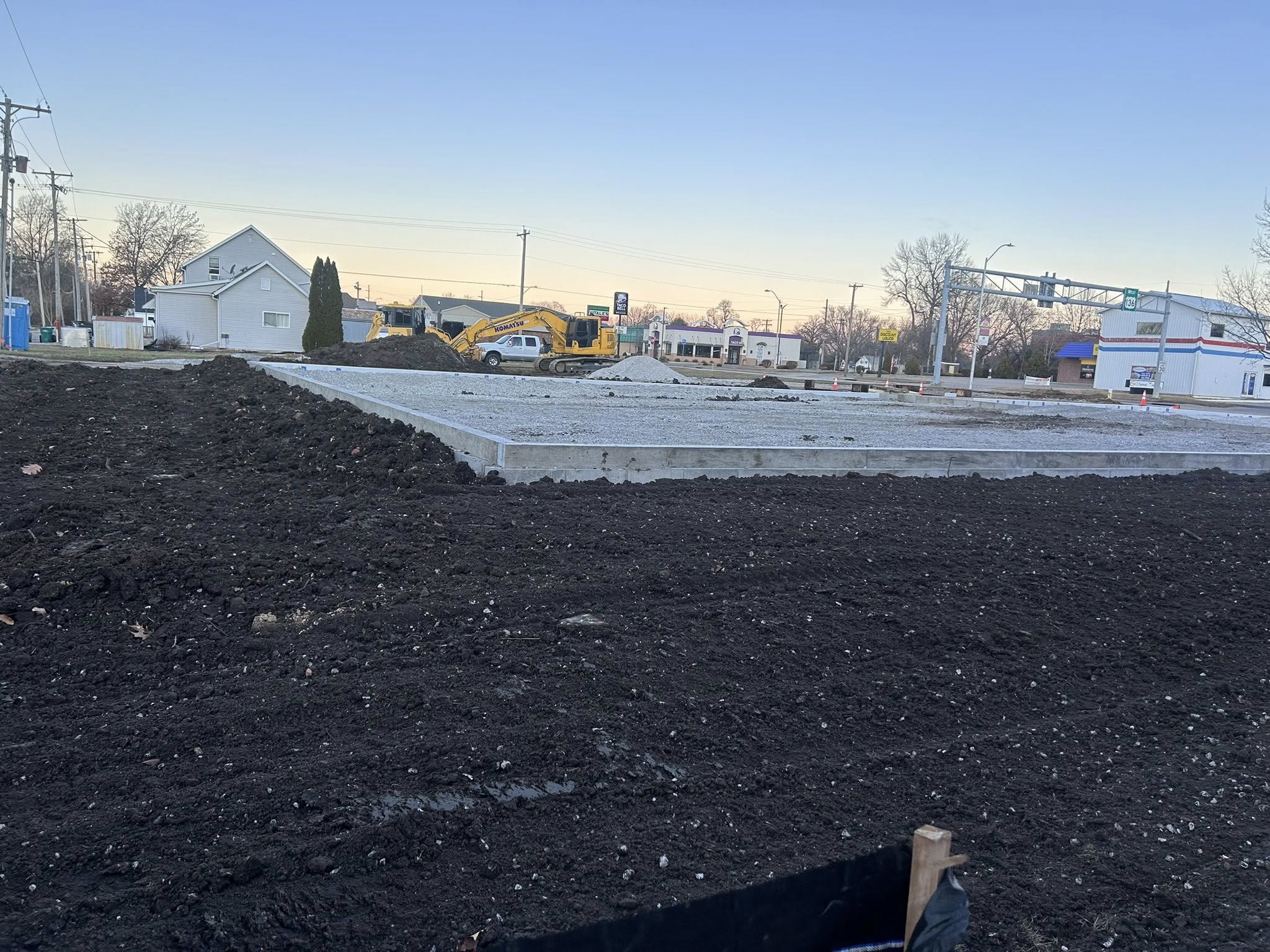

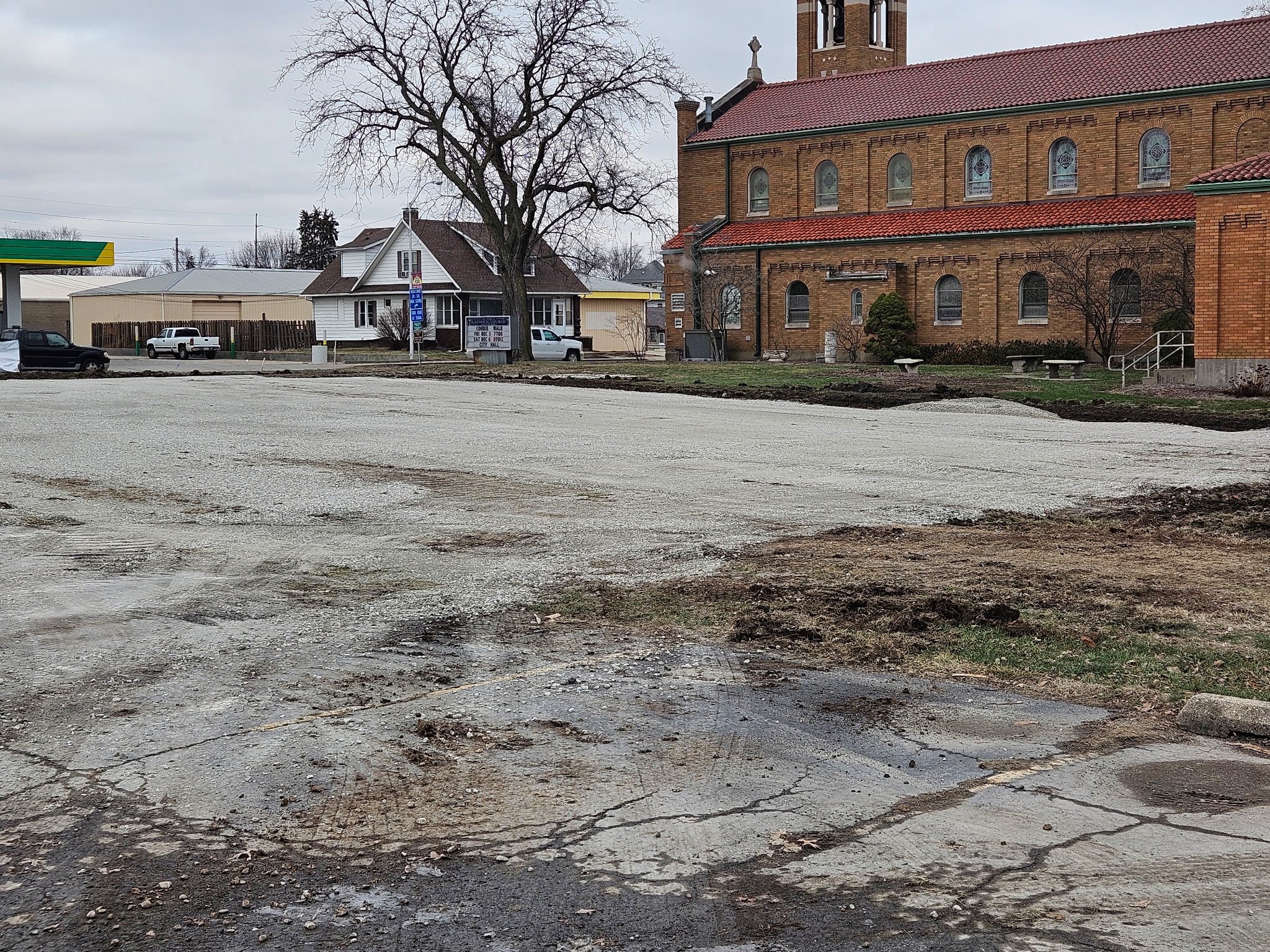

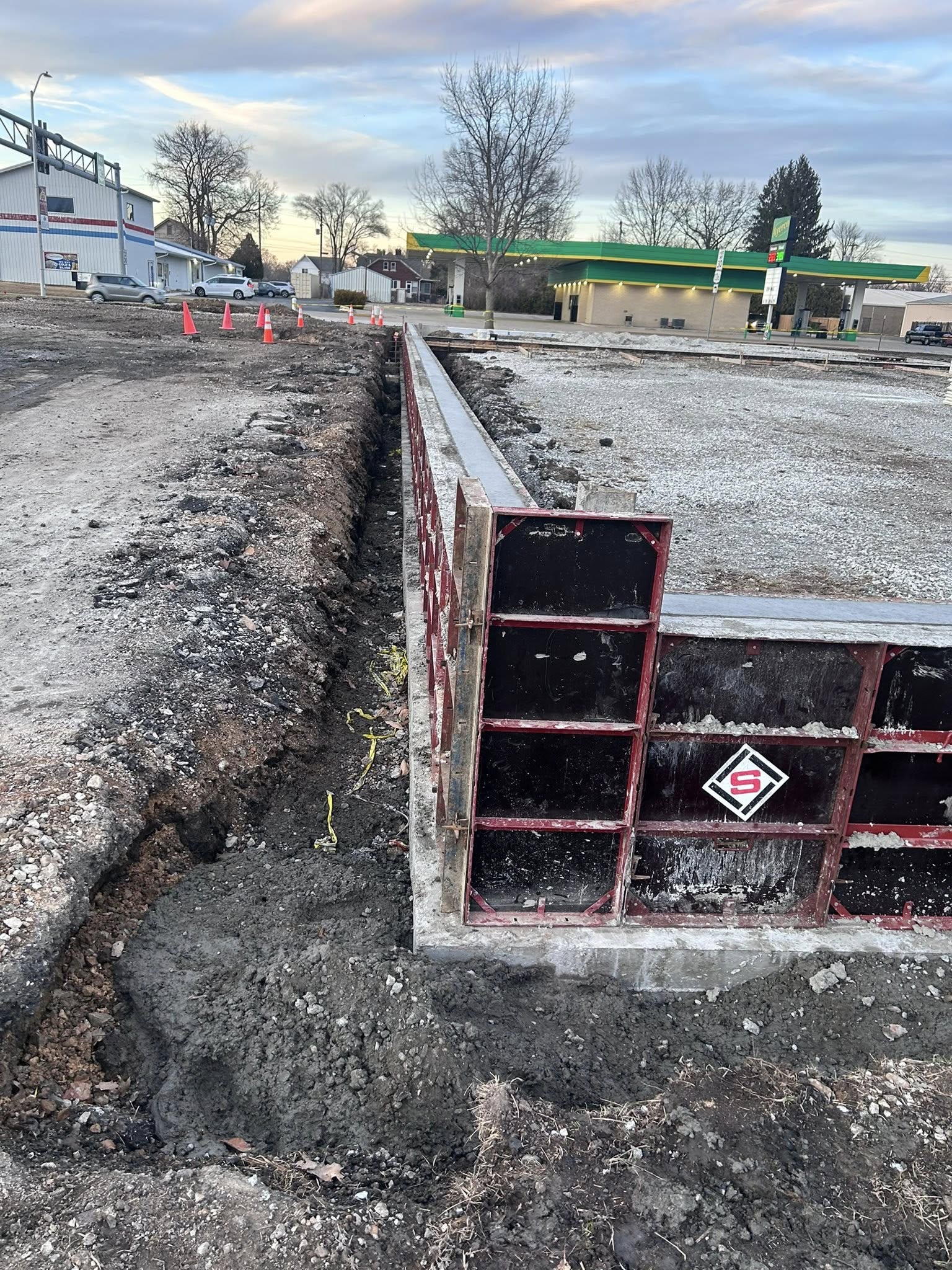

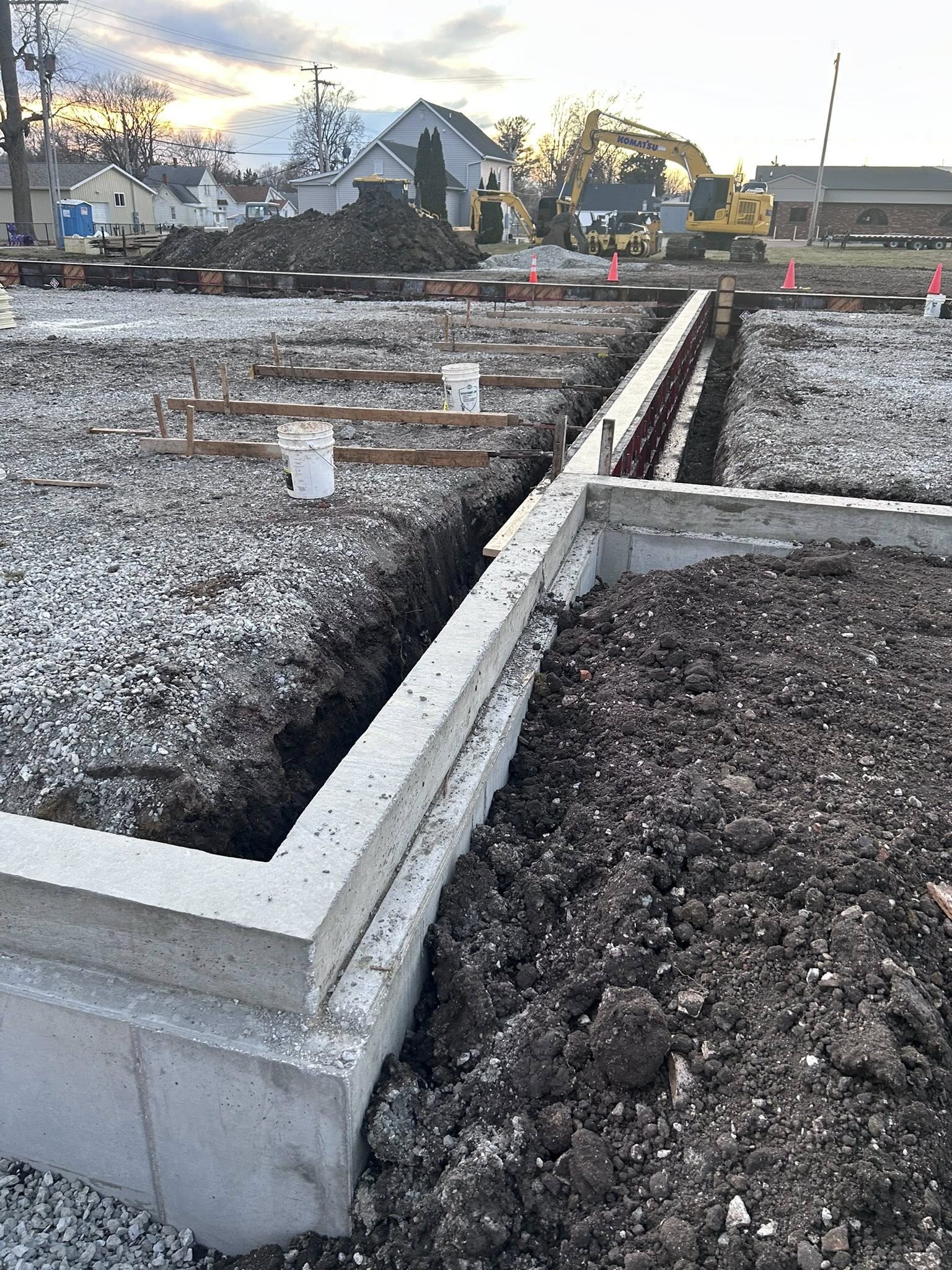

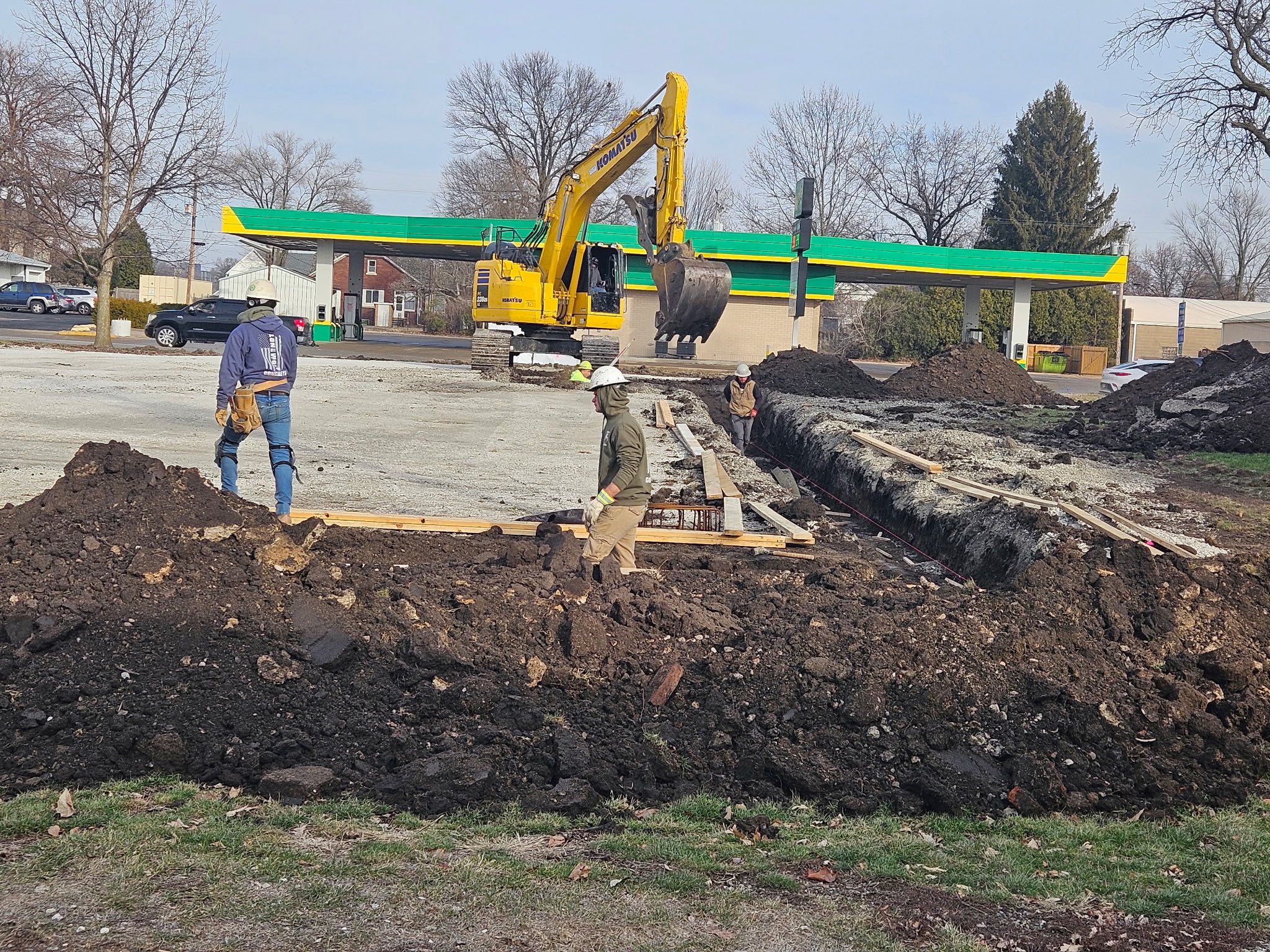

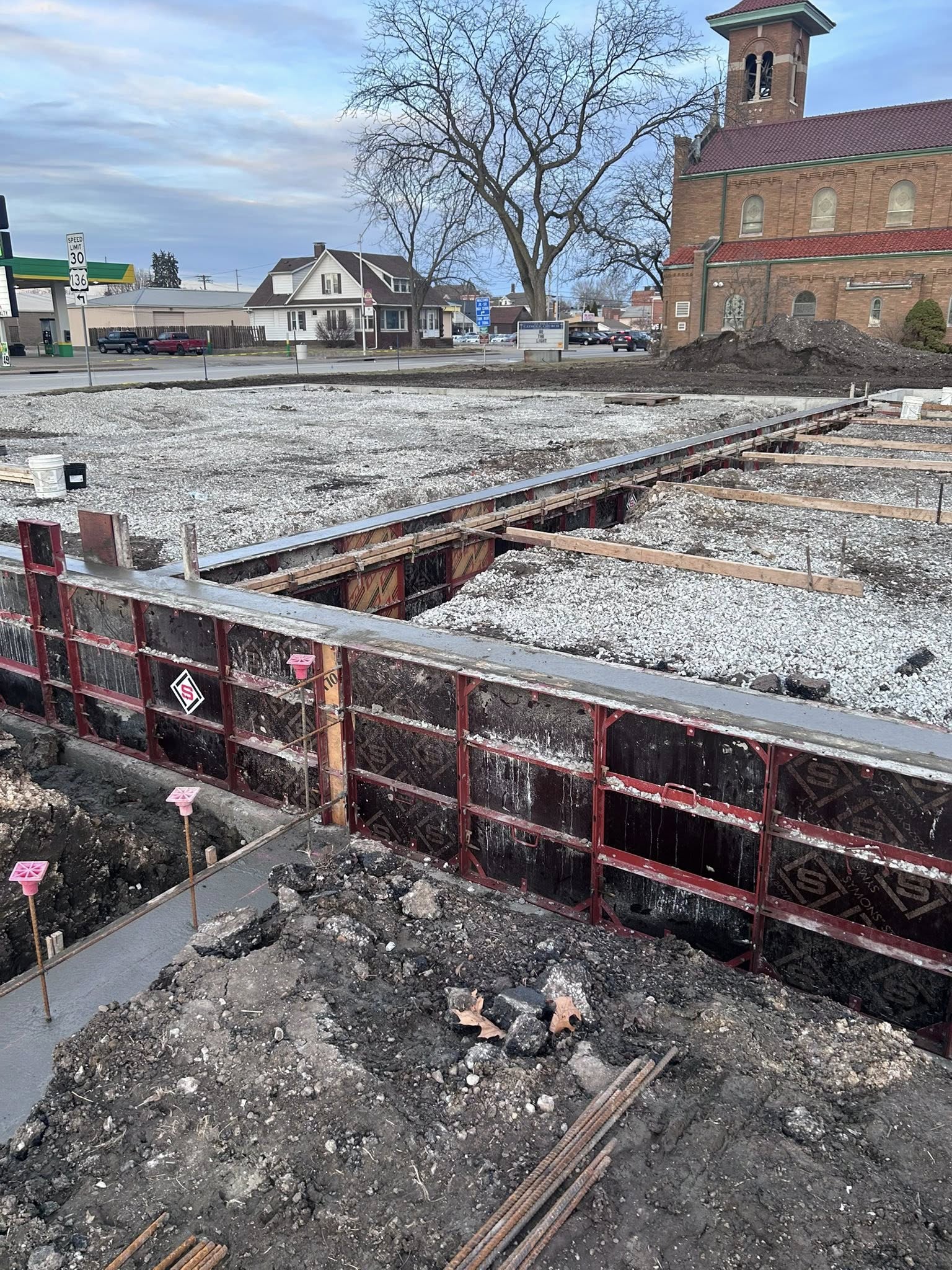

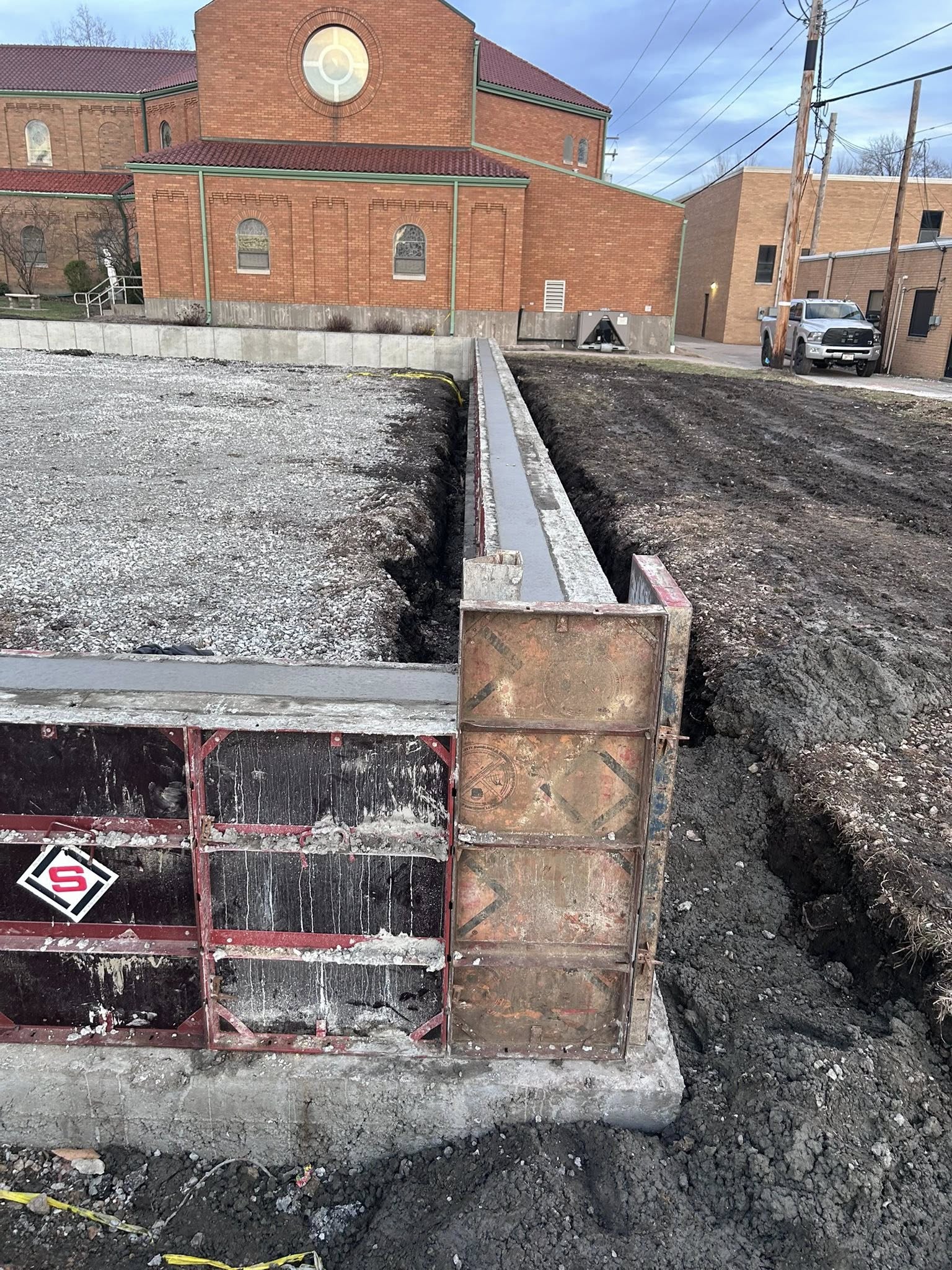

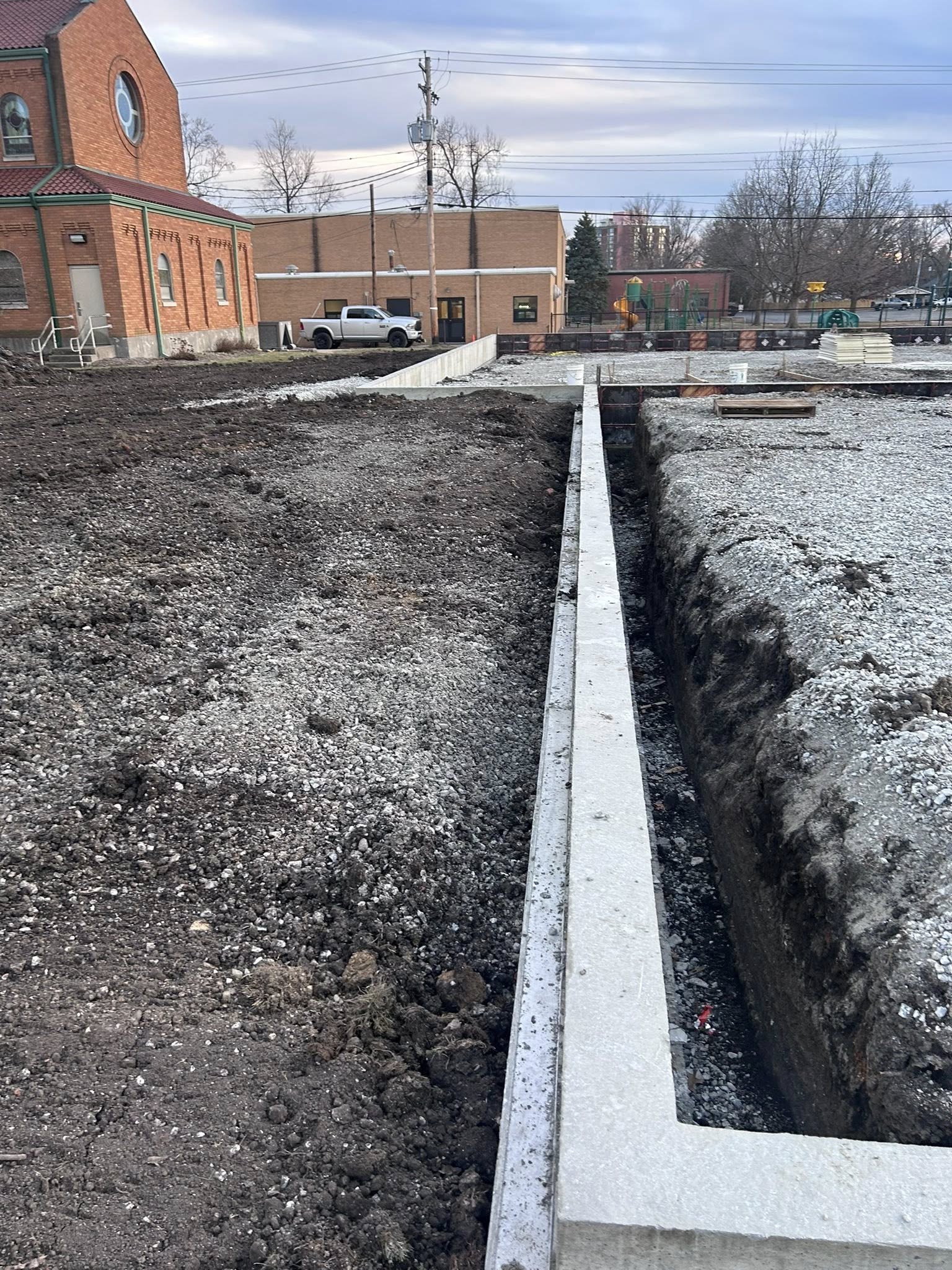

Construction of our St. Hubert parish center began on January 2, 2026. The ground was prepped, foundations and footings were poured and this week a gravel base was laid for the building’s floor. Keep watching for more updates in the coming weeks.

Installing Utilities

February 27, 2026

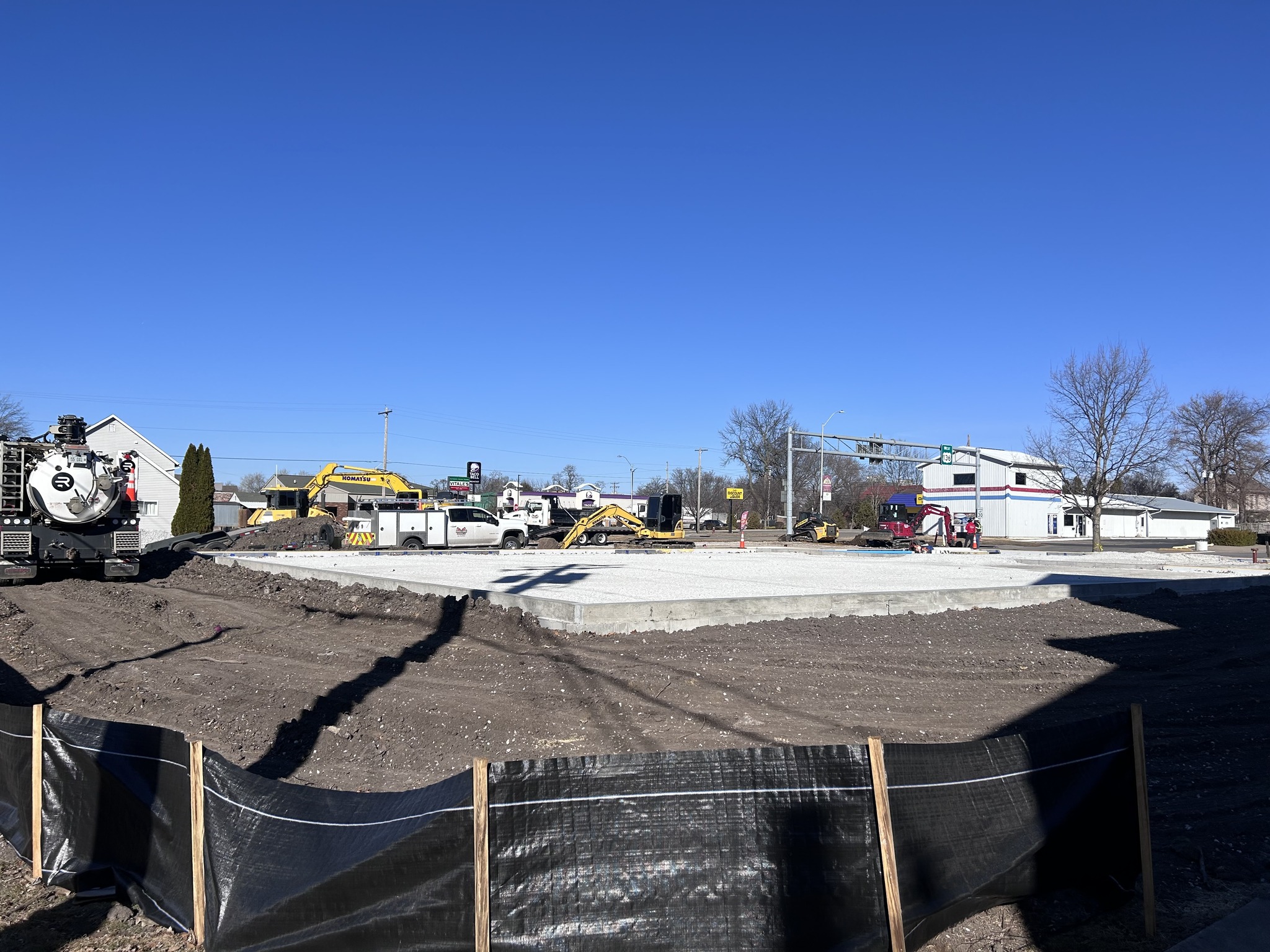

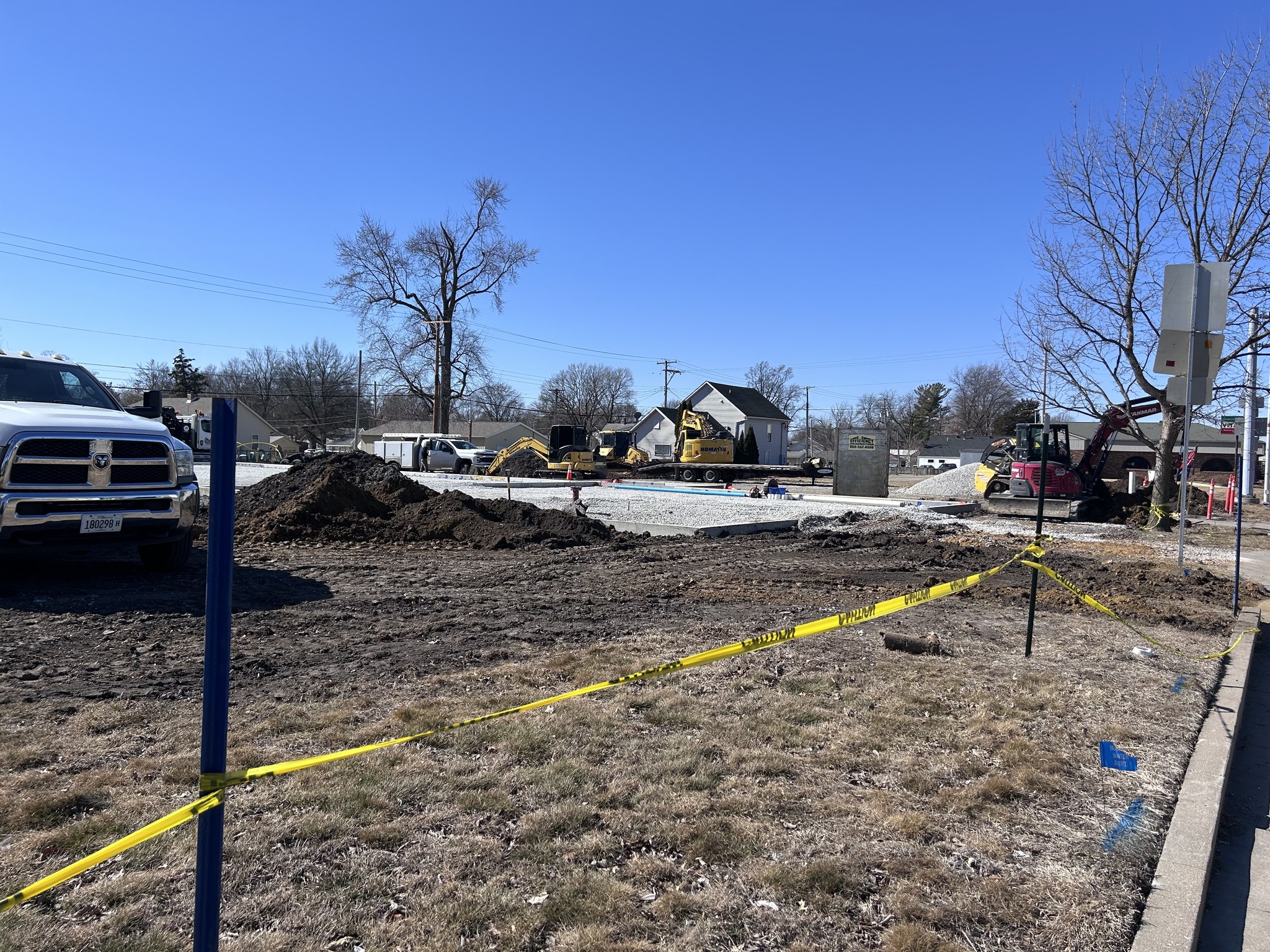

We are making progress on the new parish hall! Underground plumbing and electrical were started this week!

Pouring Concrete

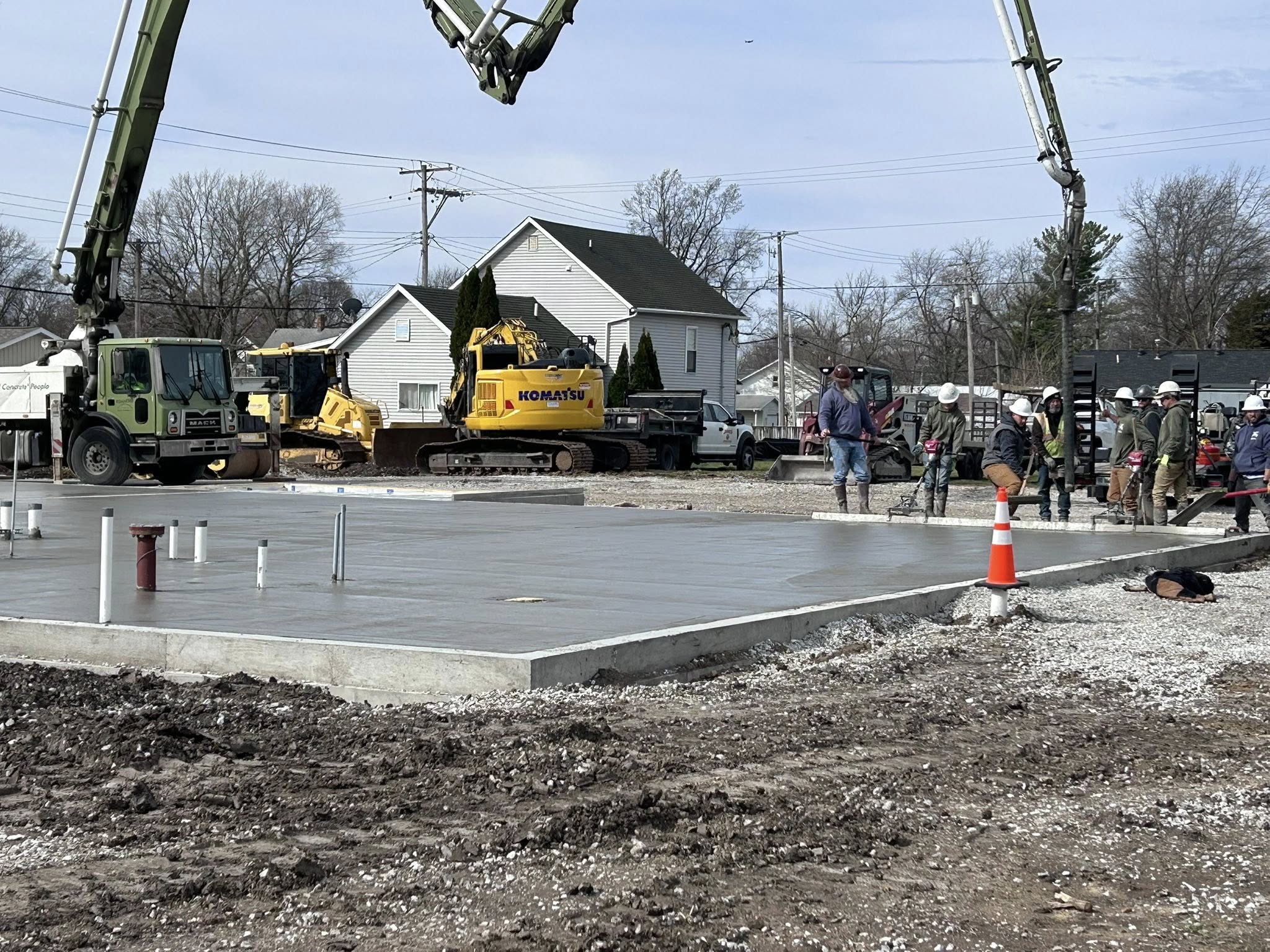

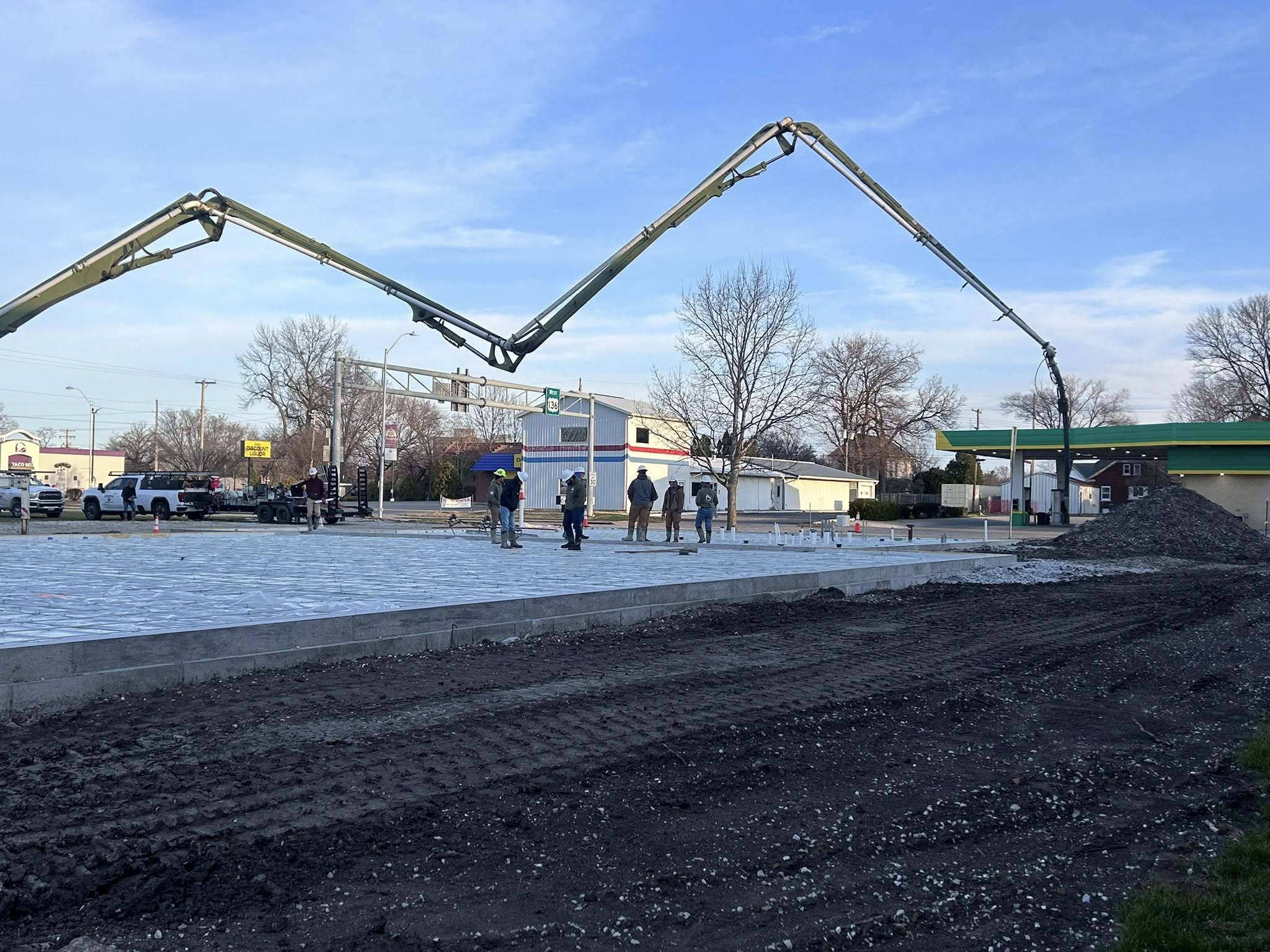

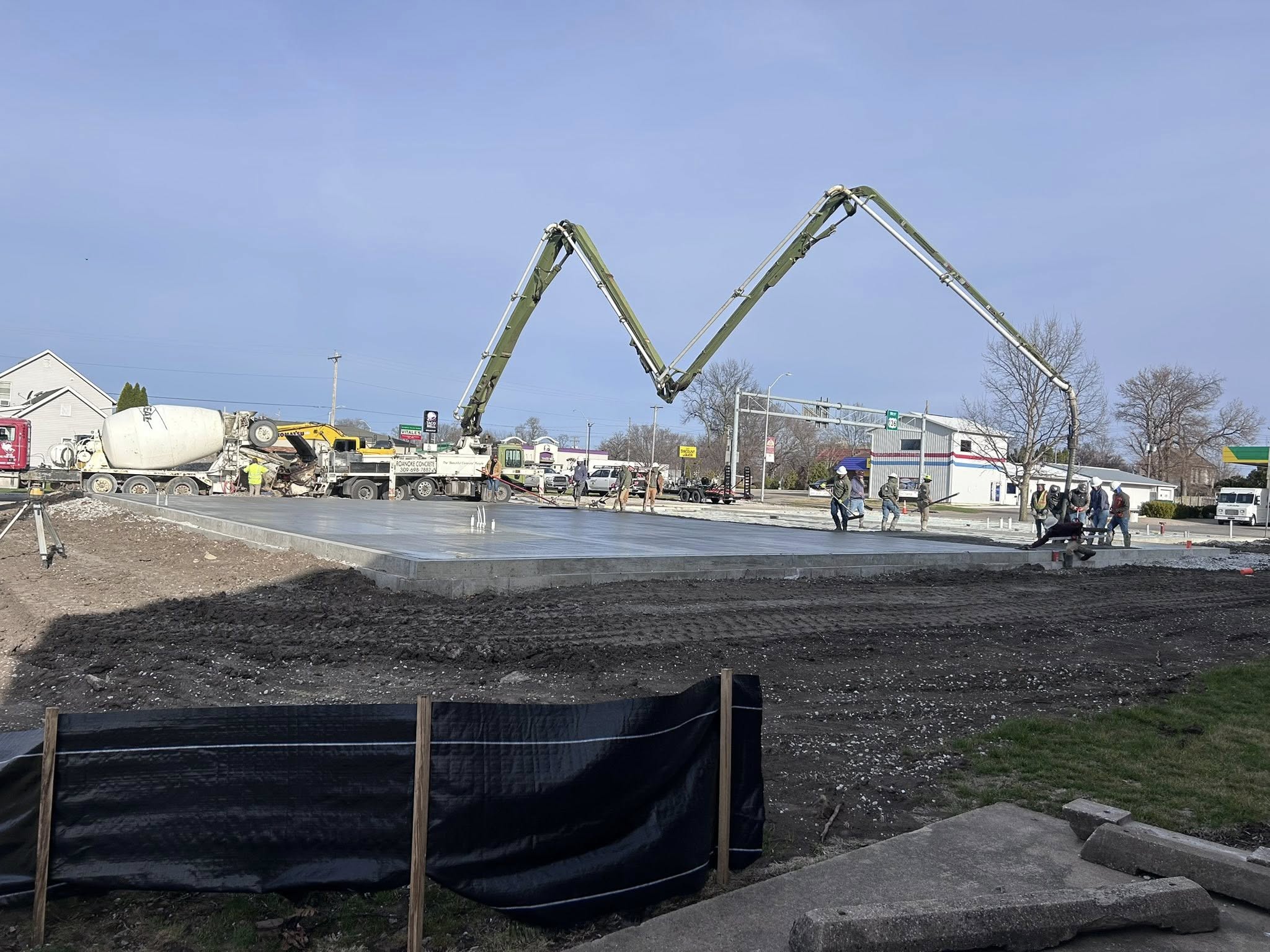

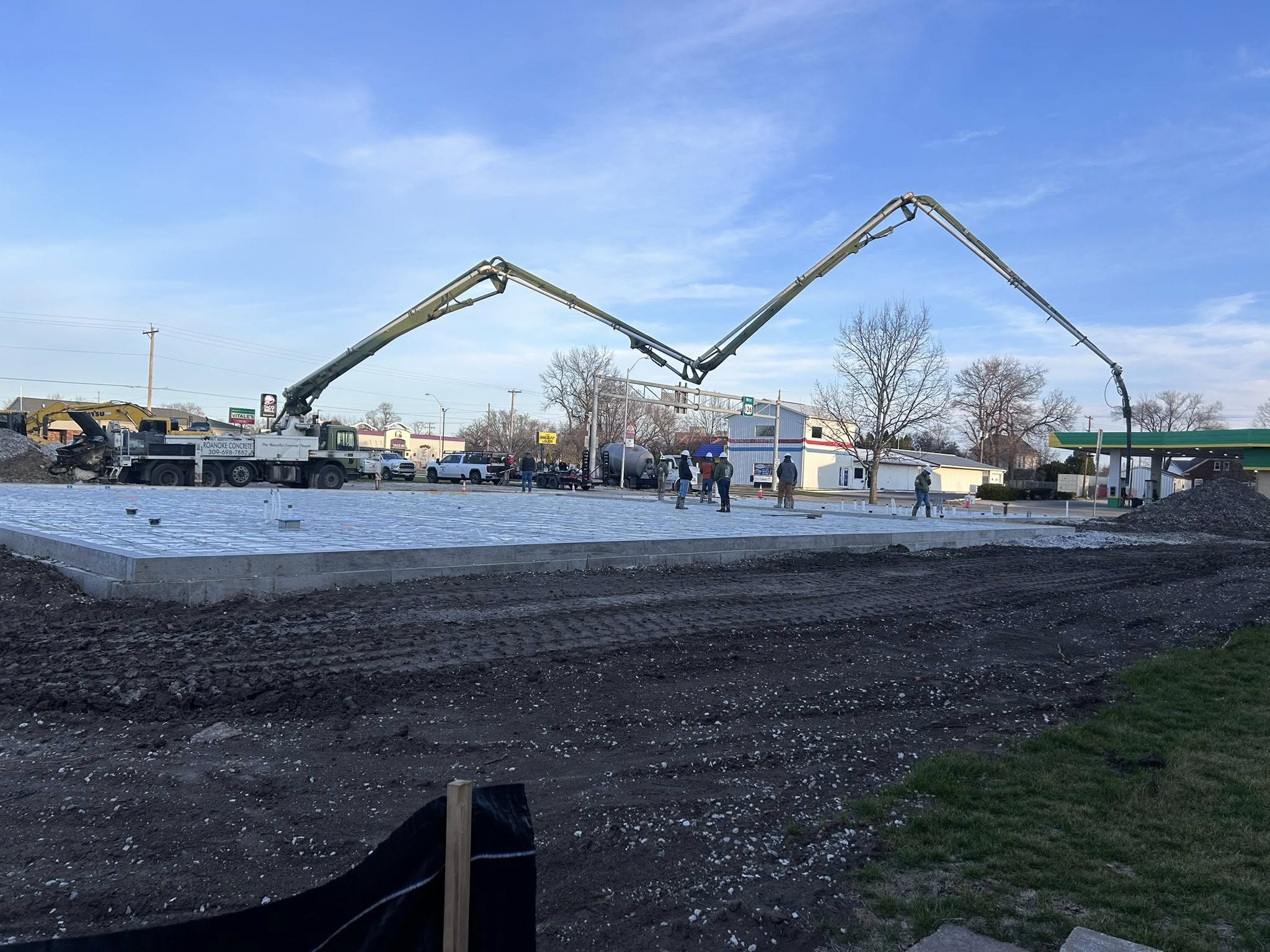

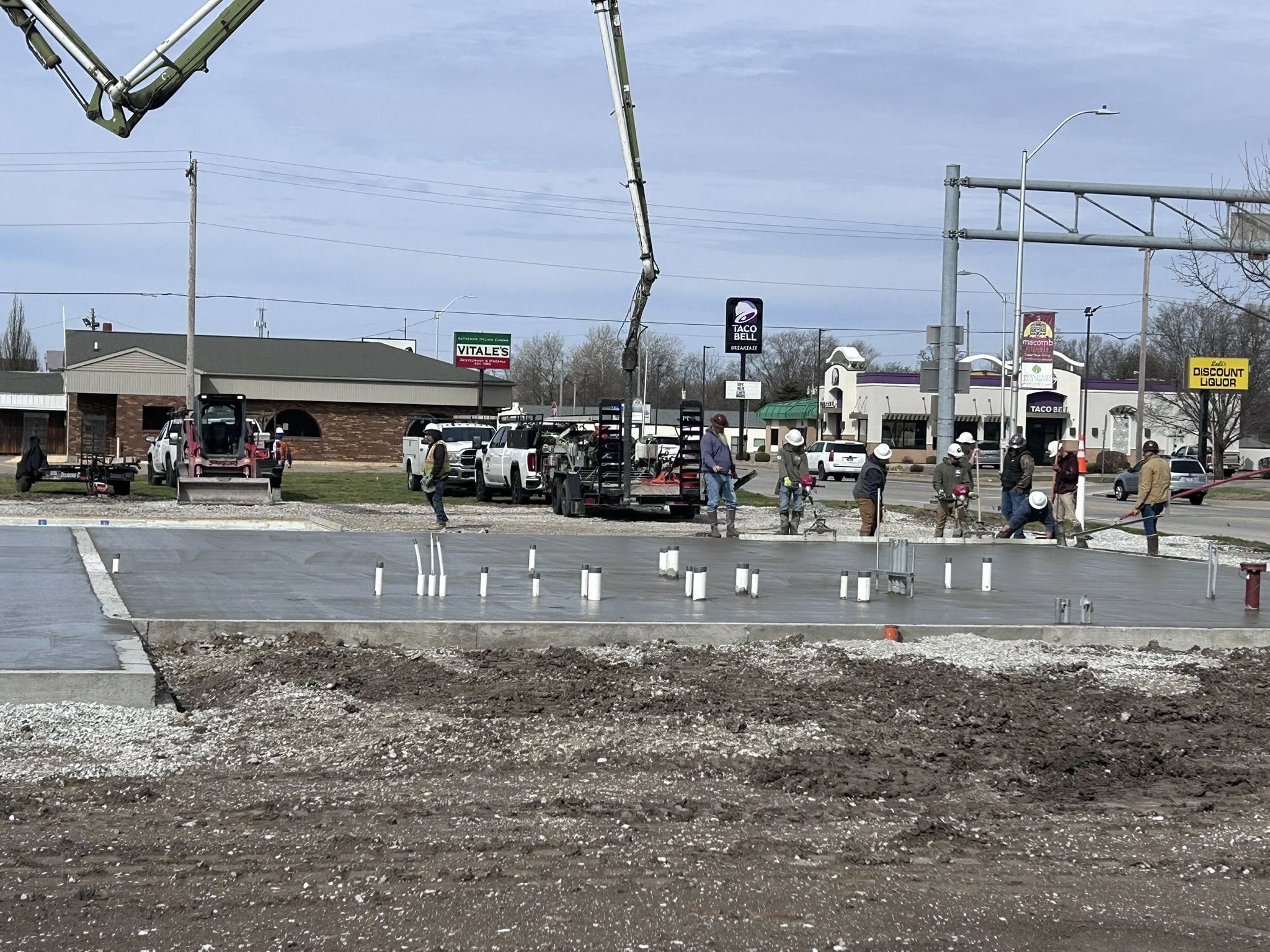

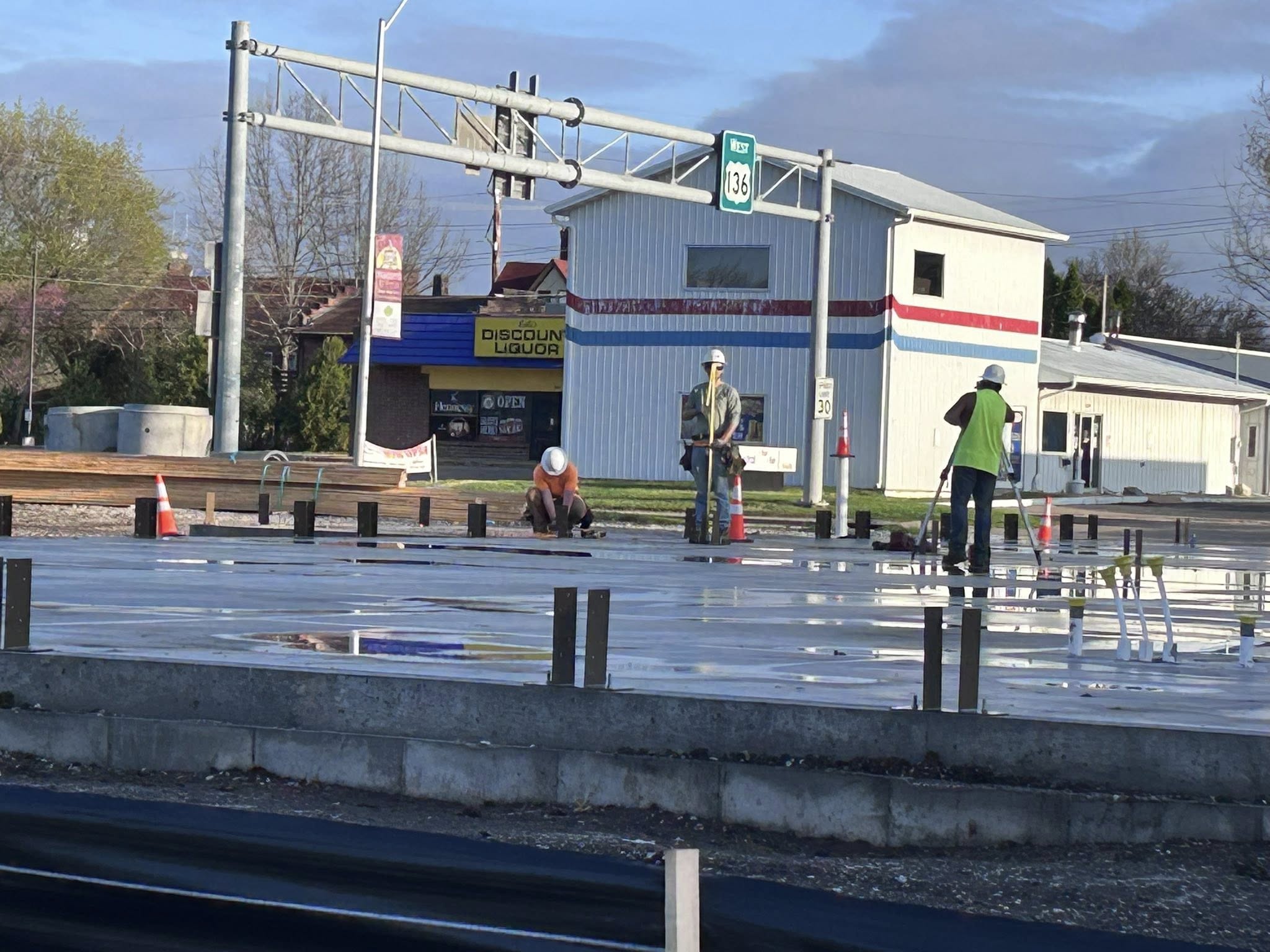

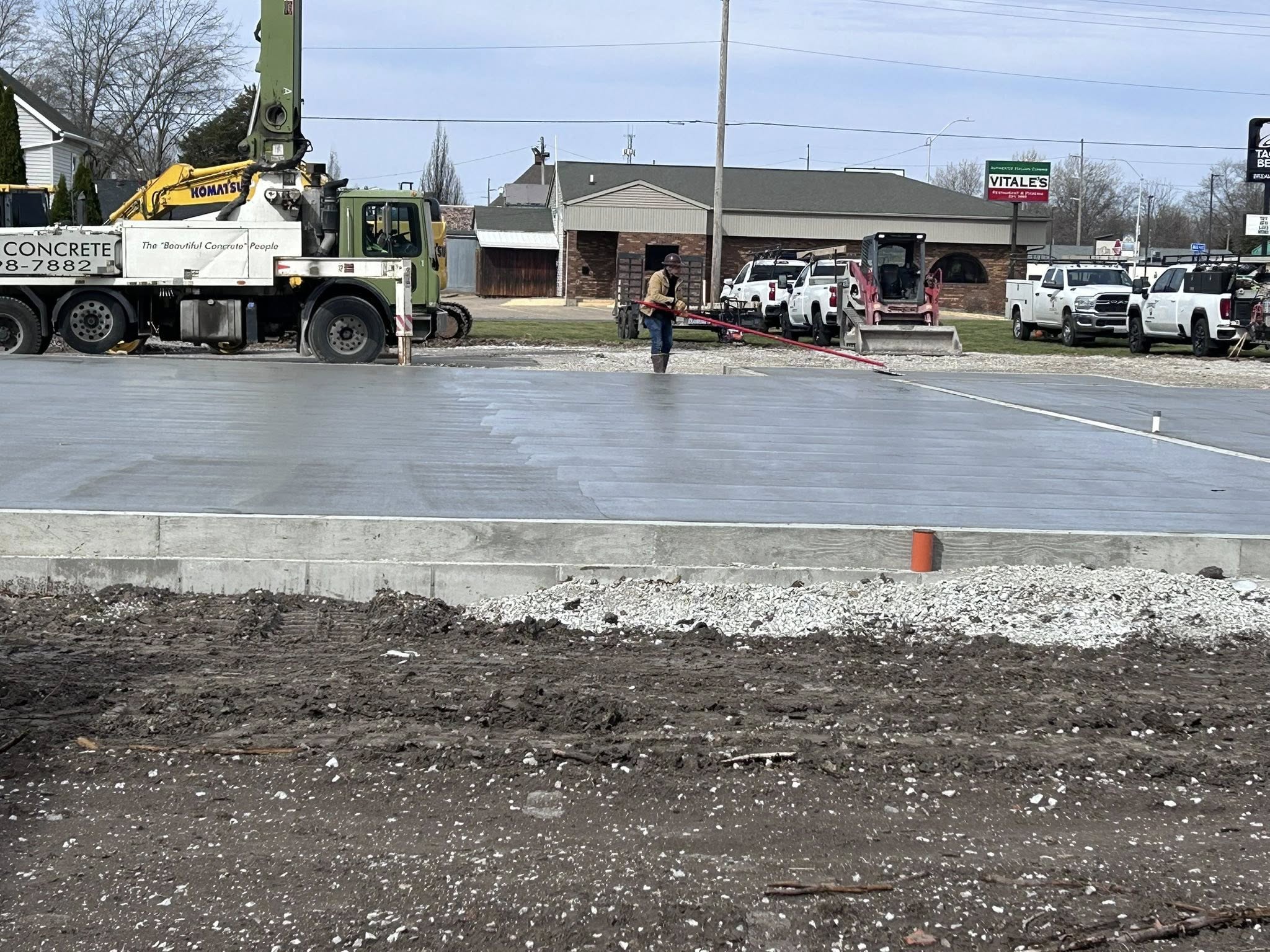

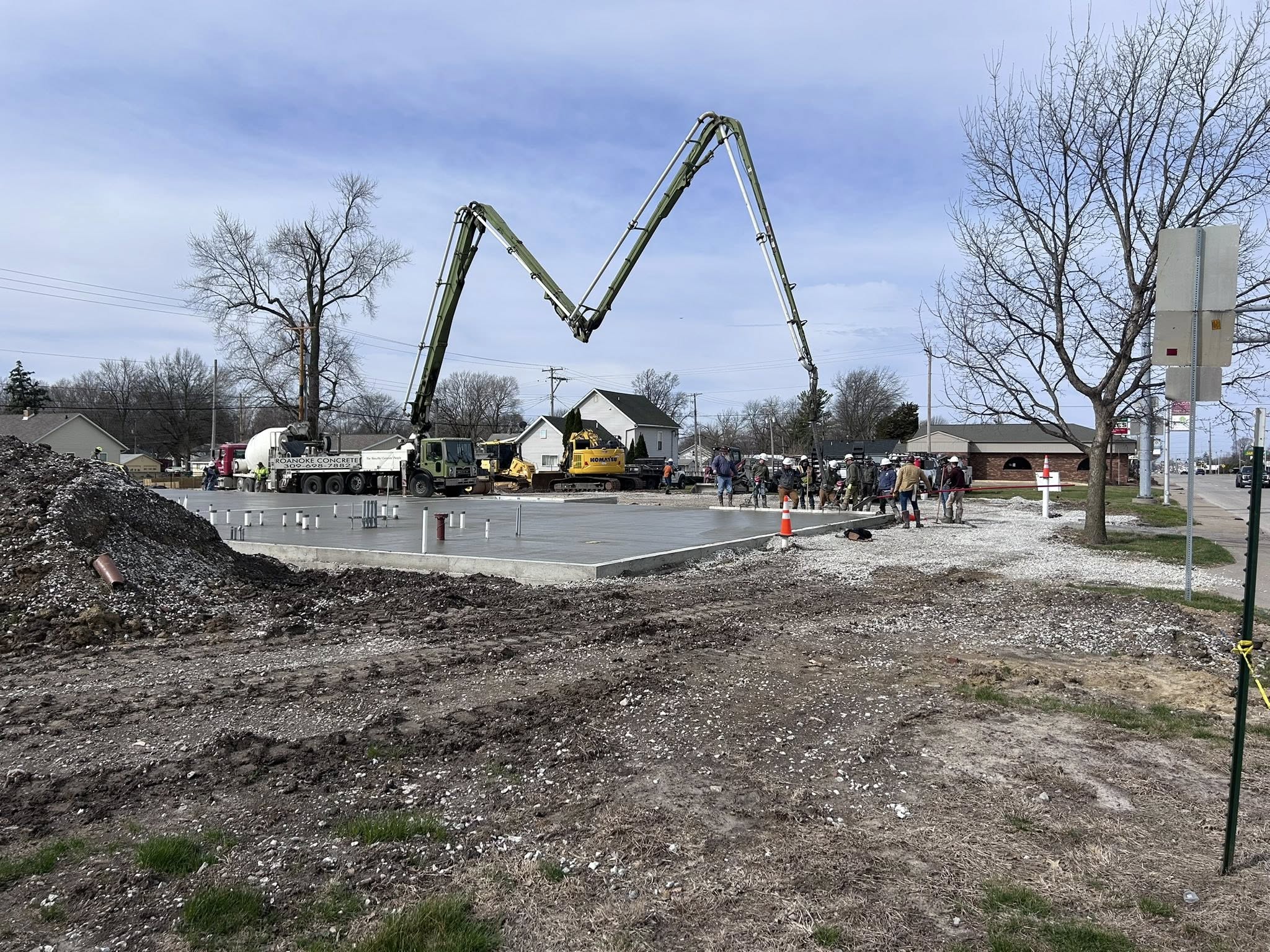

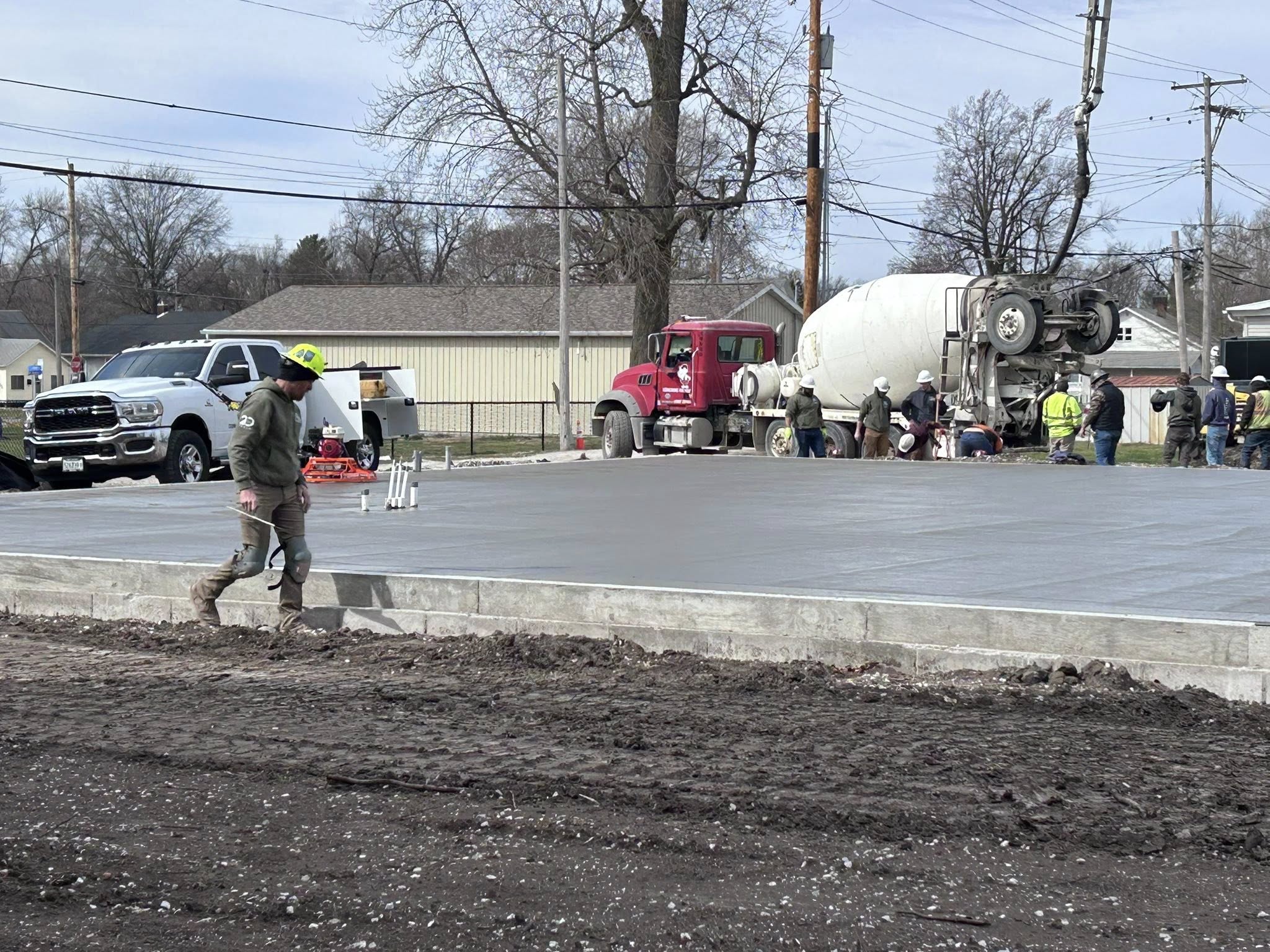

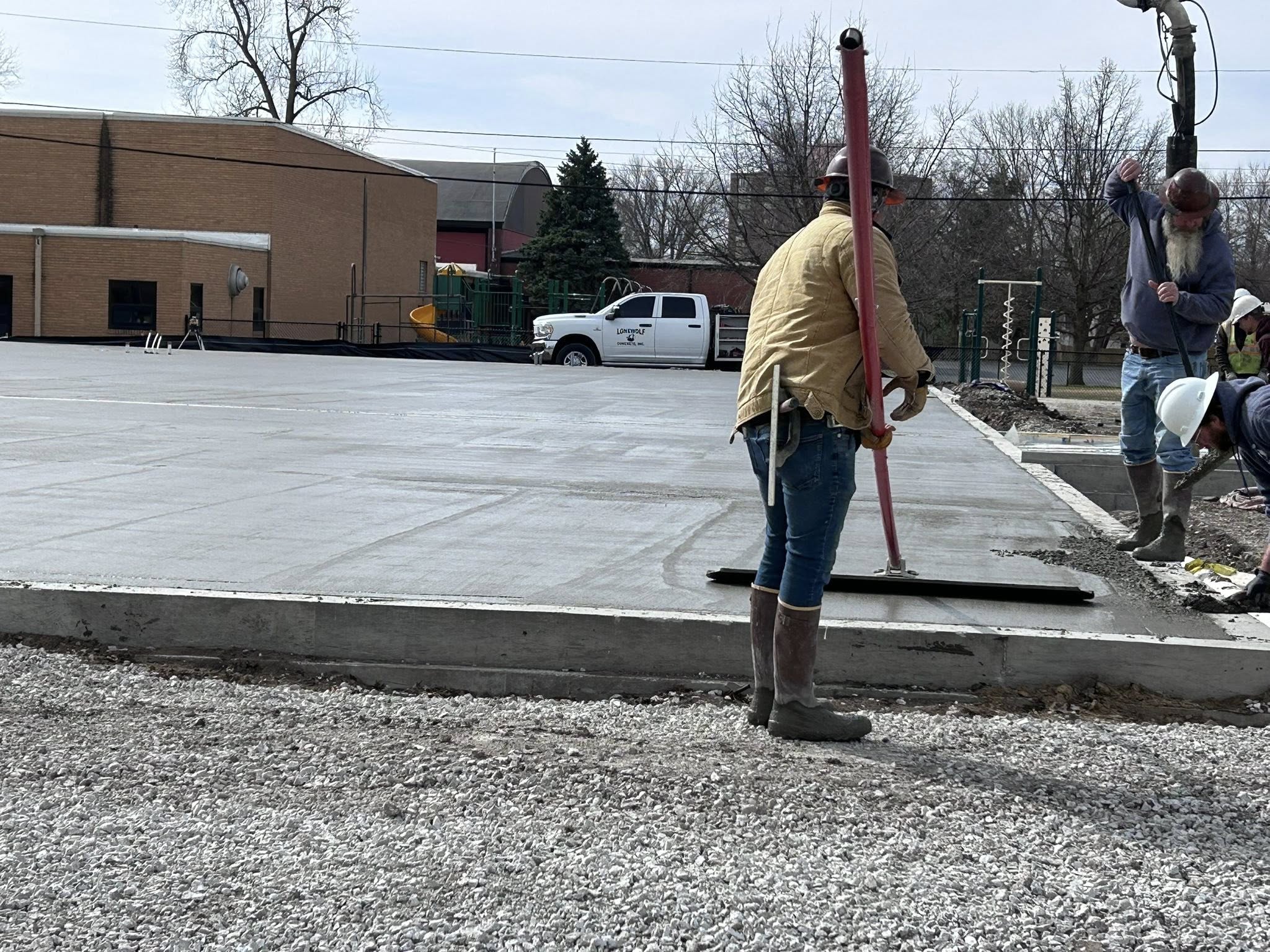

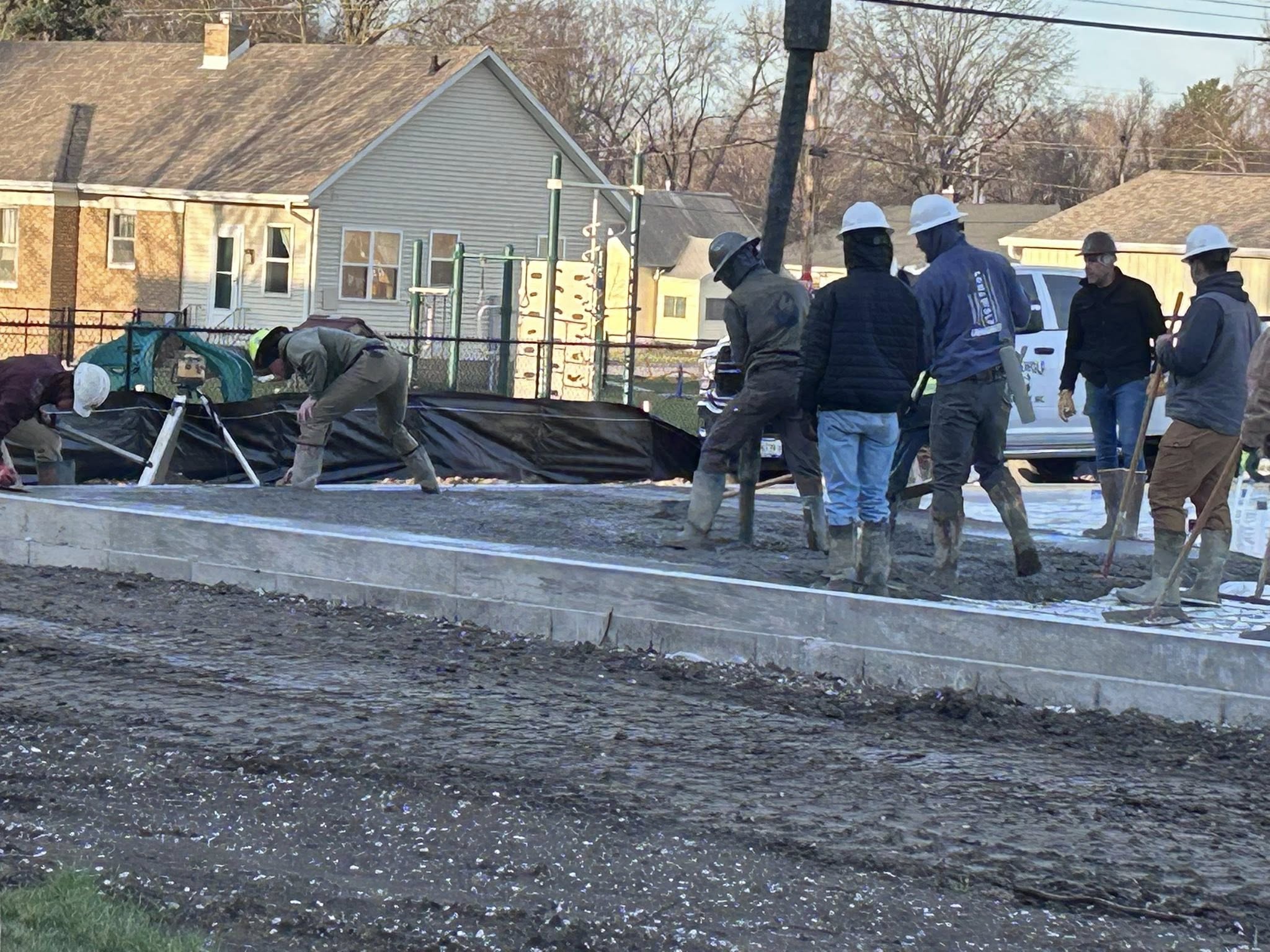

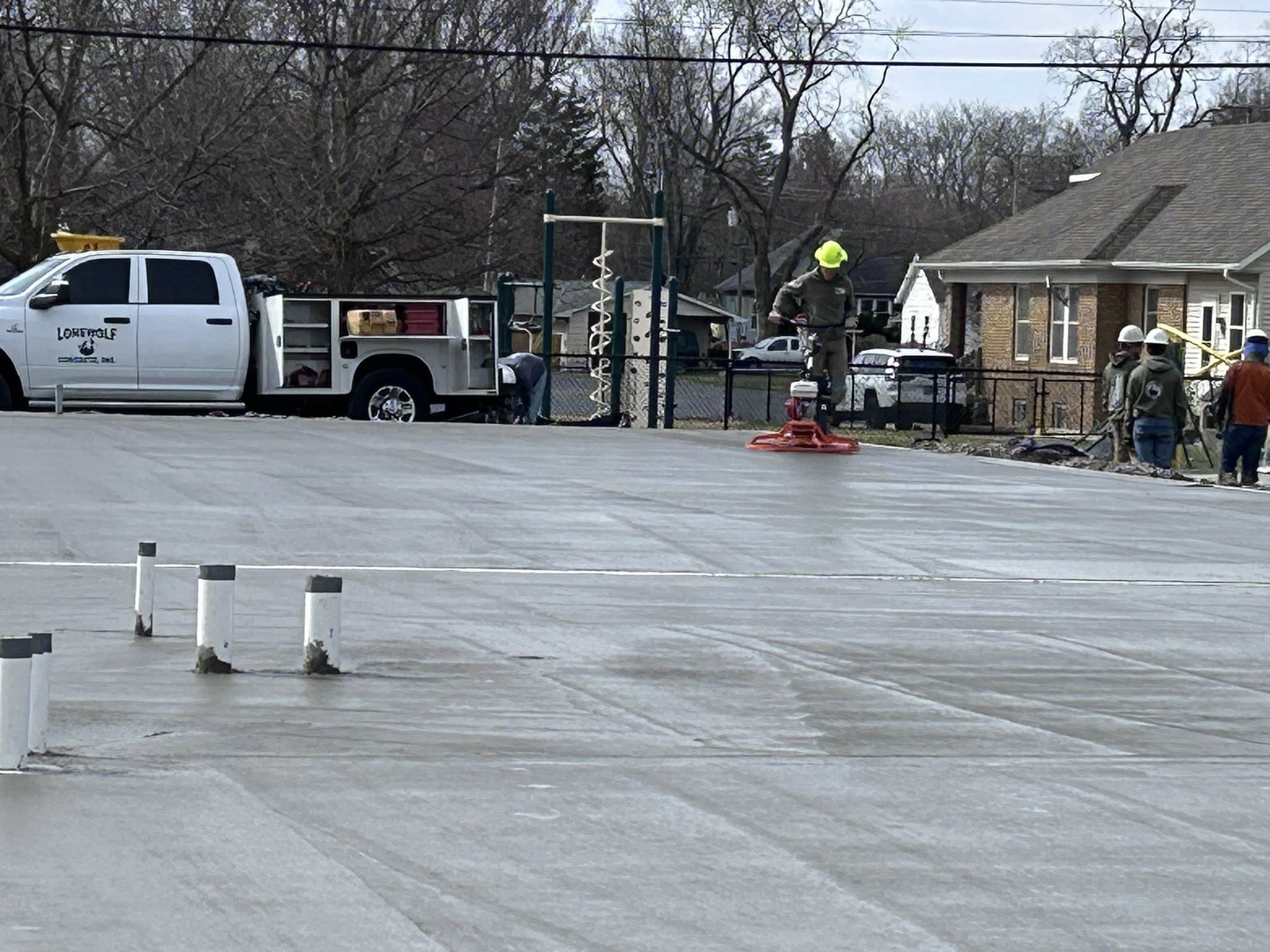

March 24, 2026

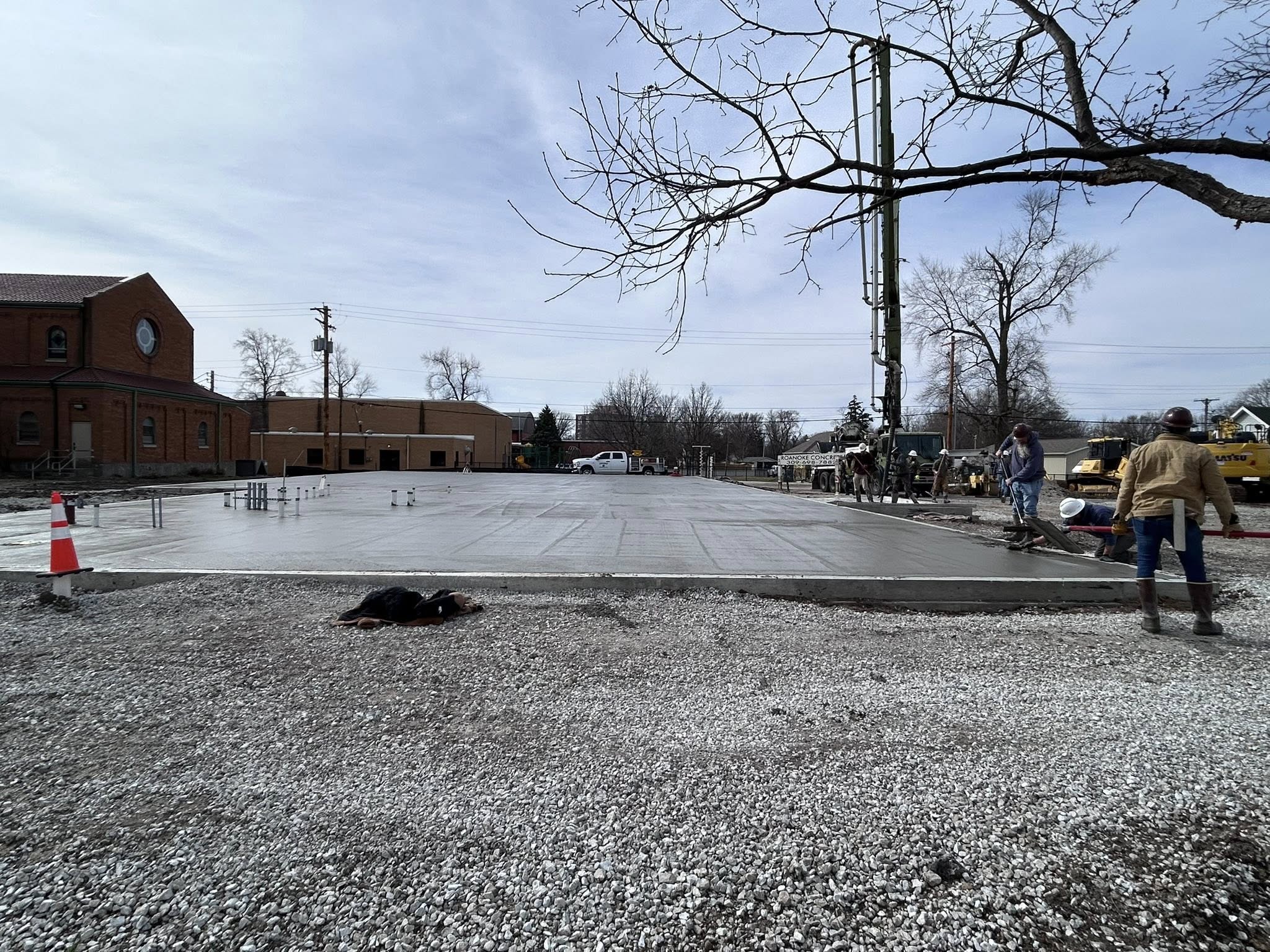

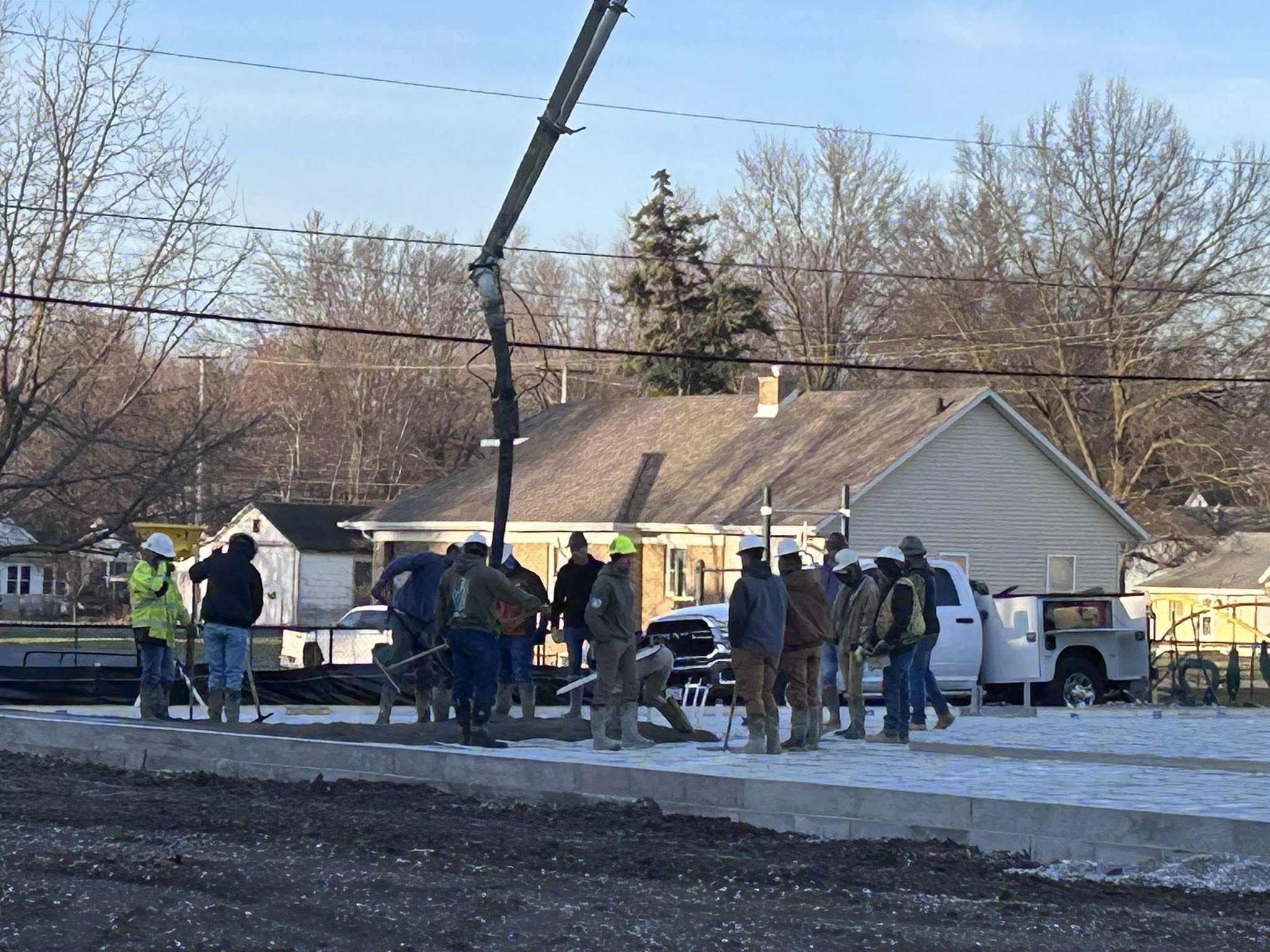

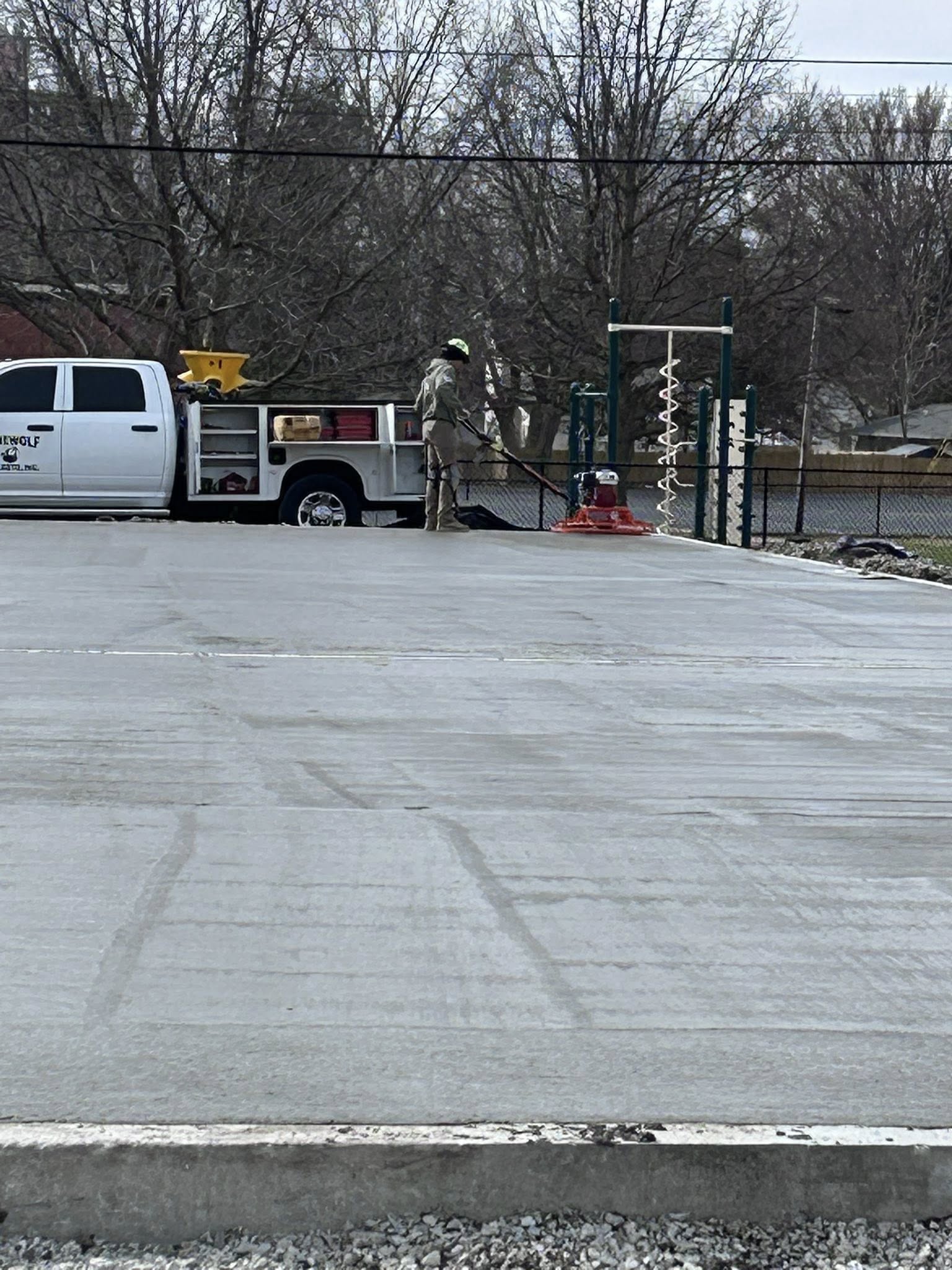

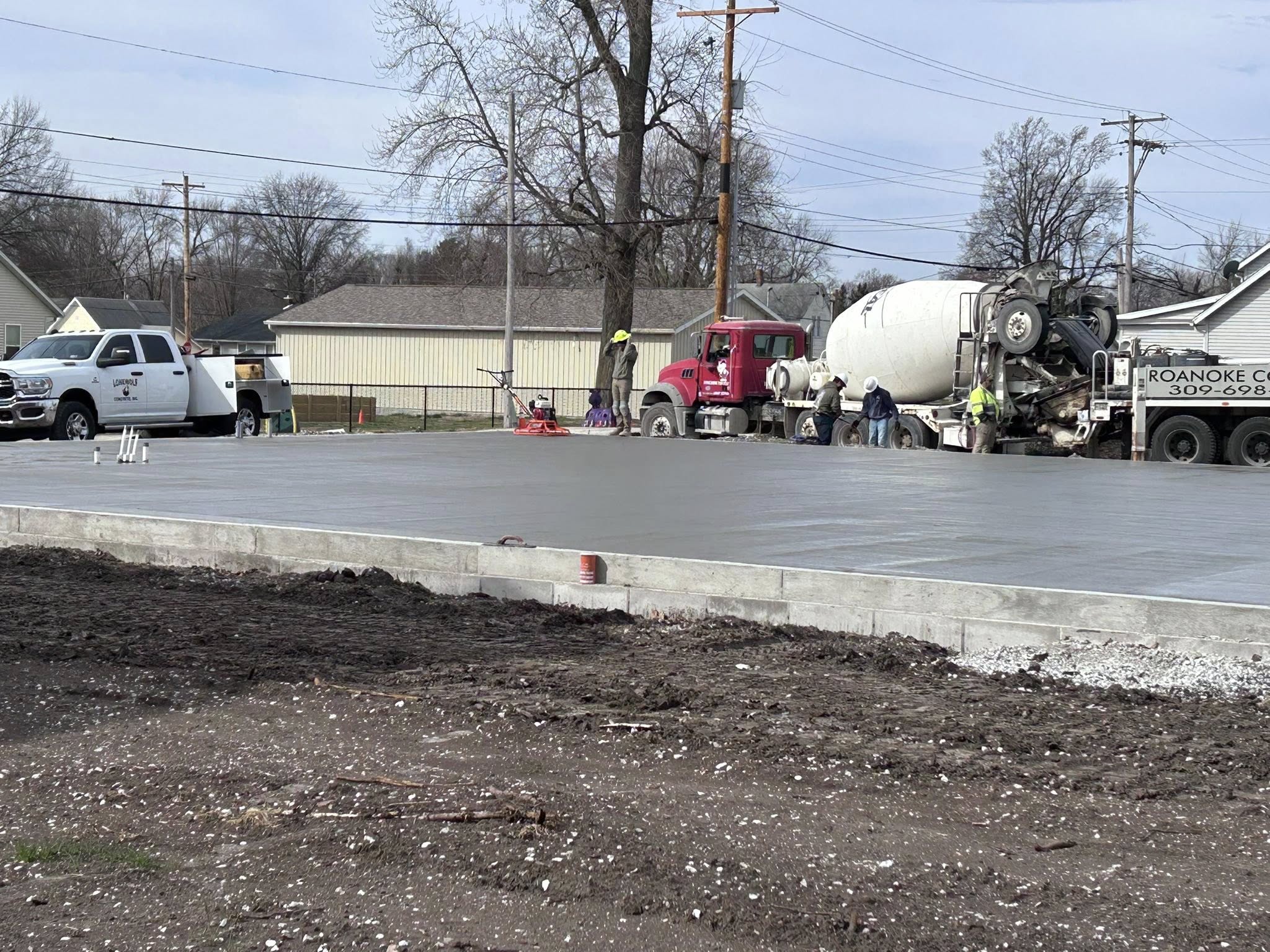

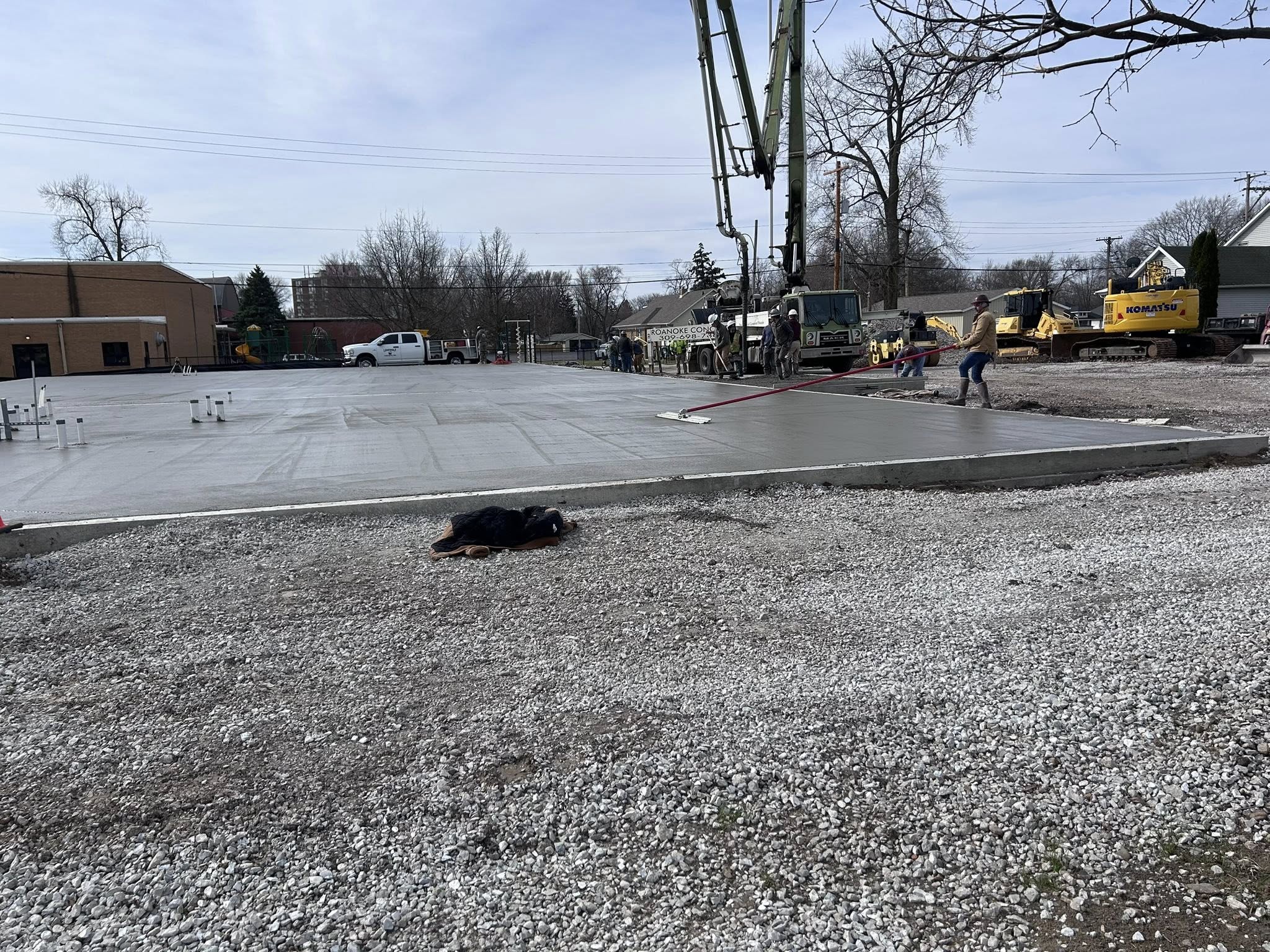

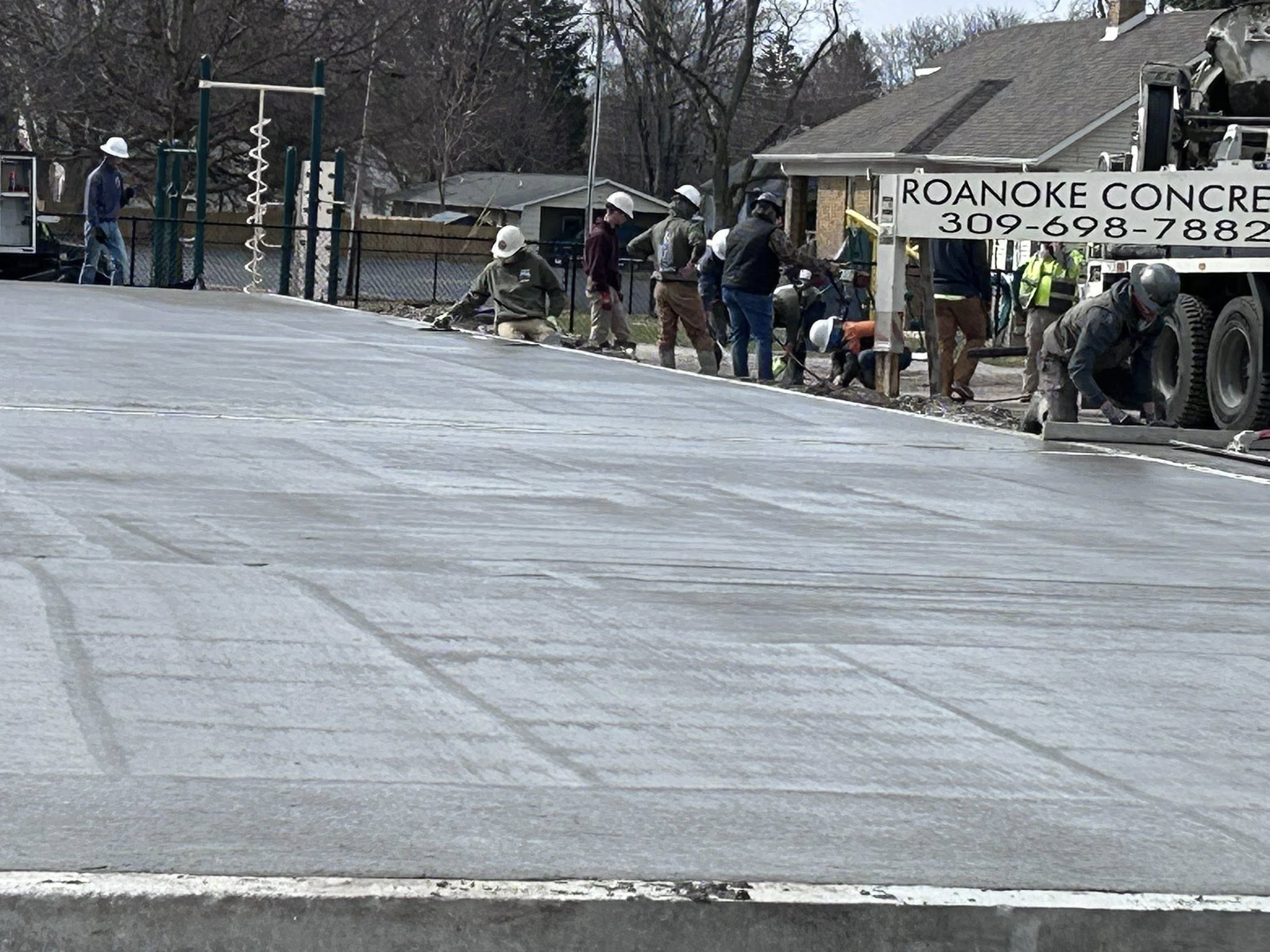

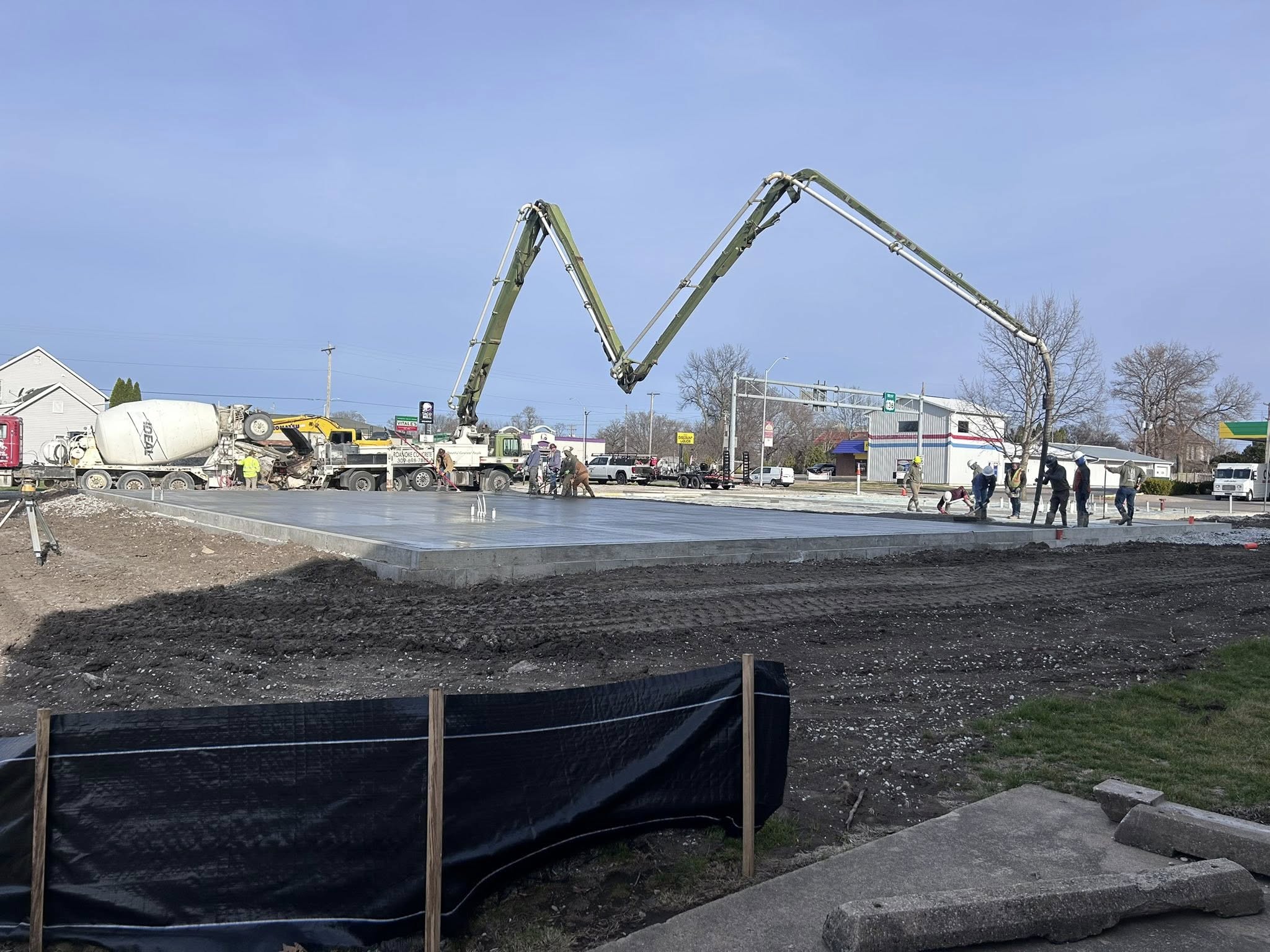

The concrete has been poured. The concrete specialists are busy leveling and smoothing the edges. Now drying time so that the concrete can cure.

Material Delivery

April 6, 2026

Building materials have arrived!

Trusses Arrive

April 9, 2026

The building trusses arrived today! So excited to see this to completion!

Installing Post Brackets

April 10, 2026

This morning the guys started early and installed the post brackets. Stay tuned for next week’s progress…

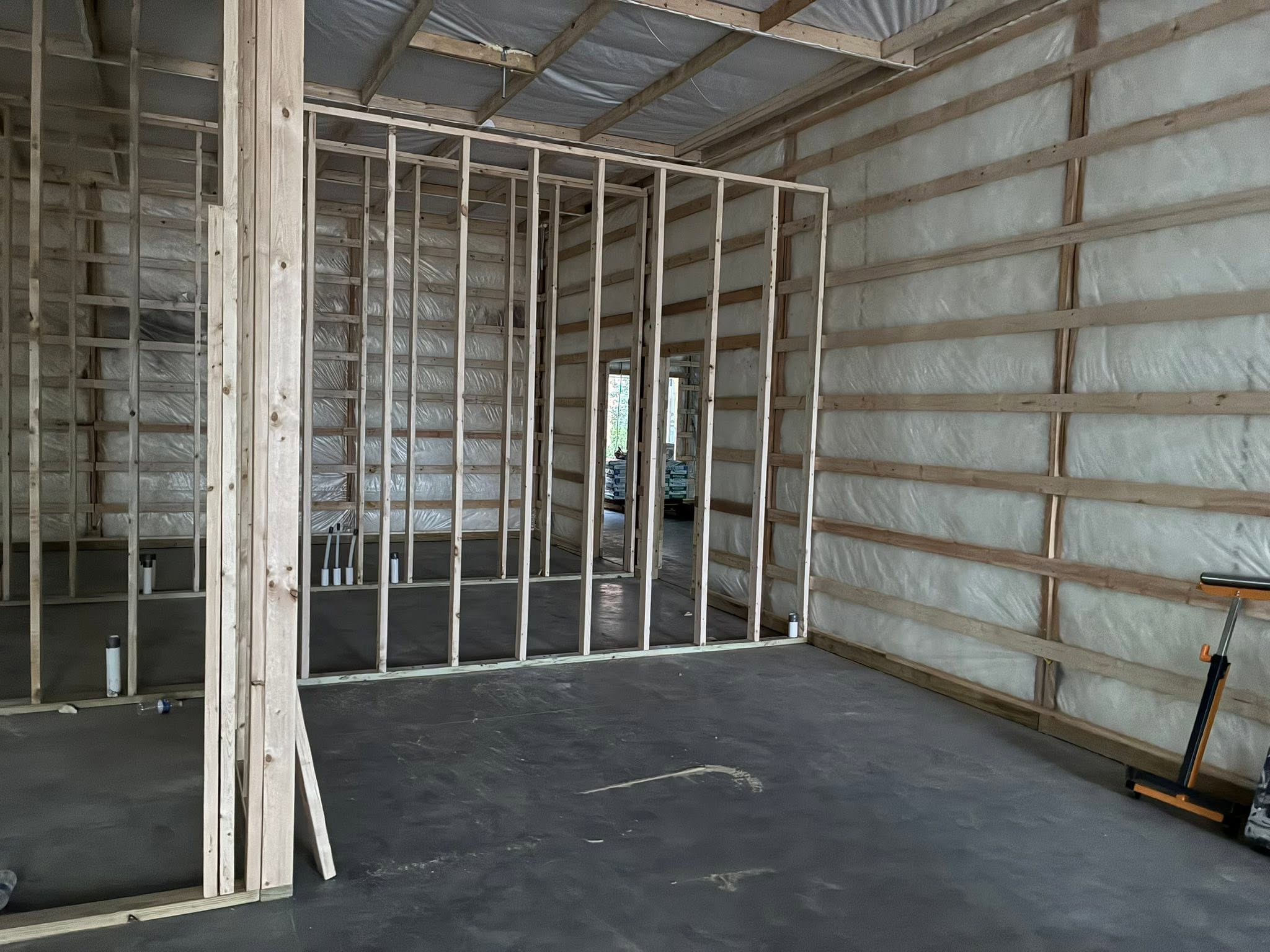

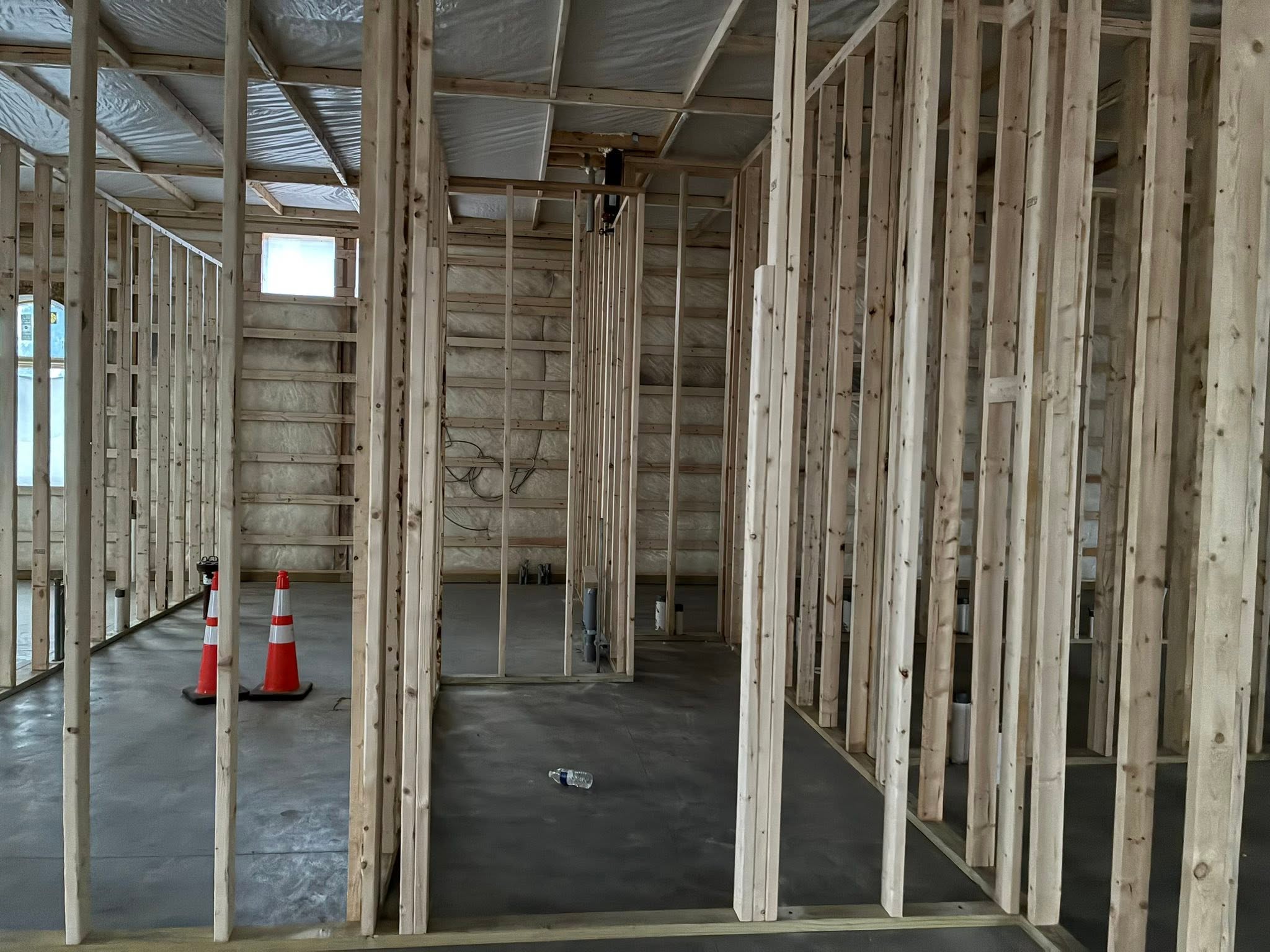

Building Walls

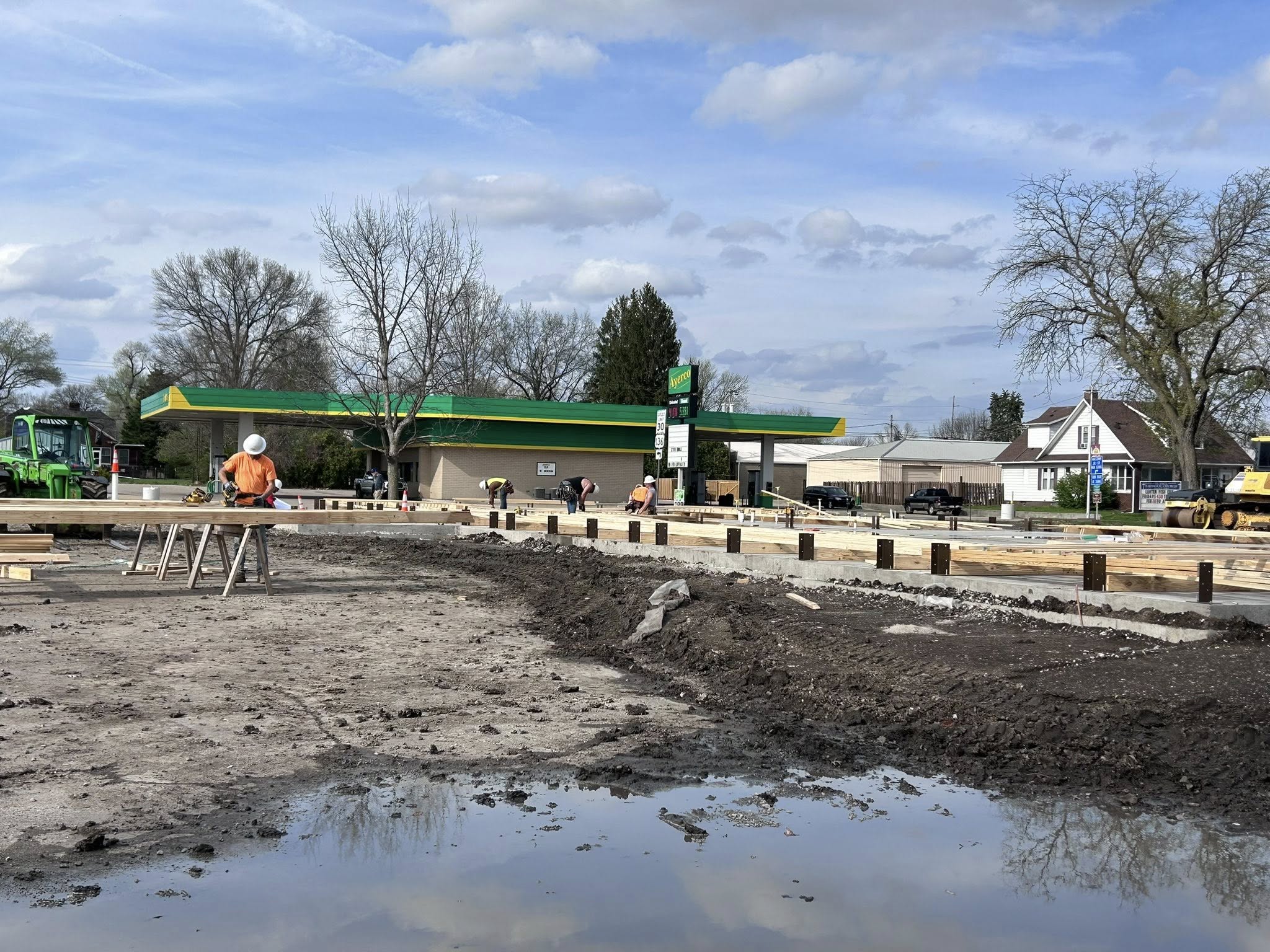

April 13, 2026

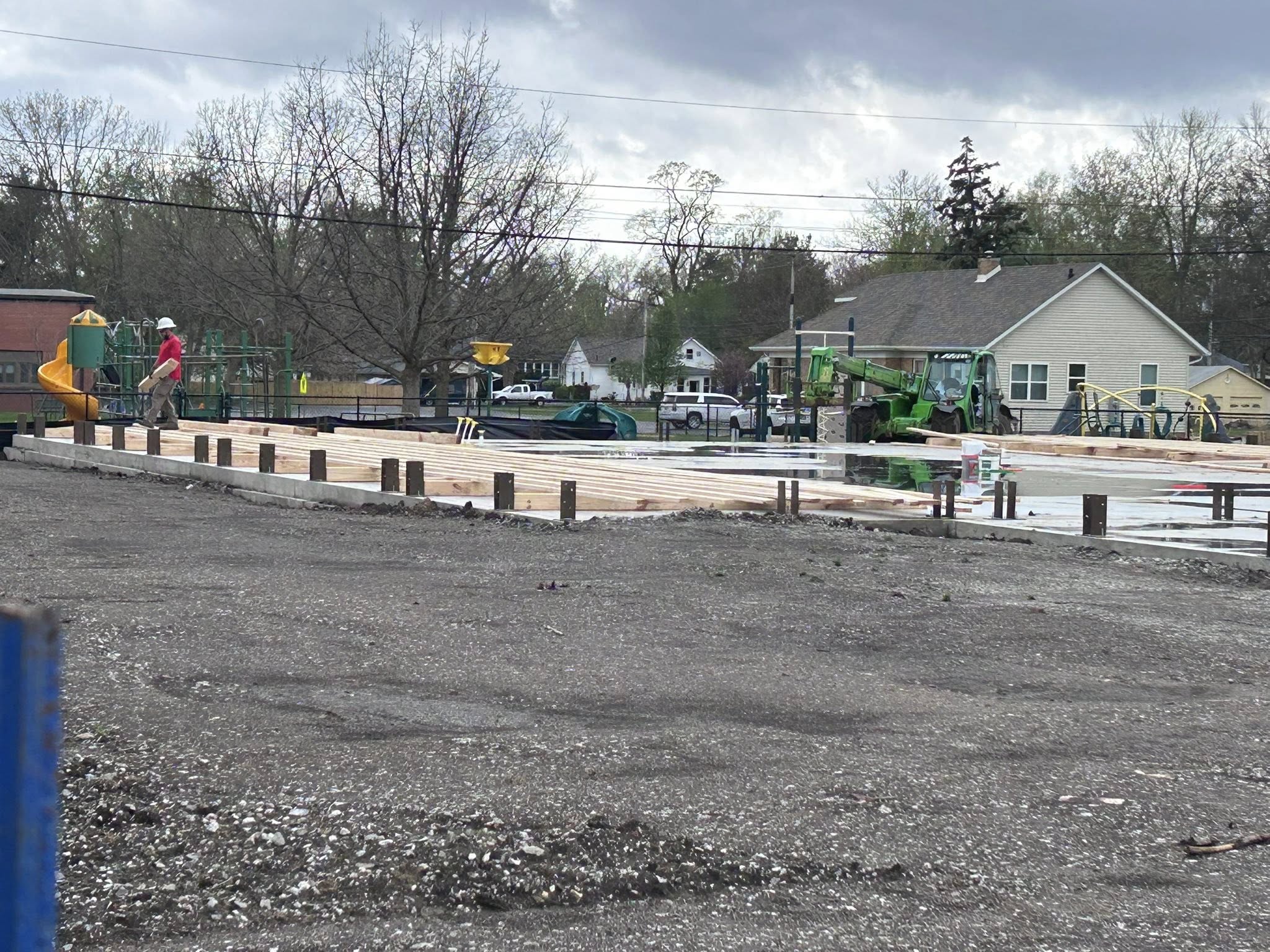

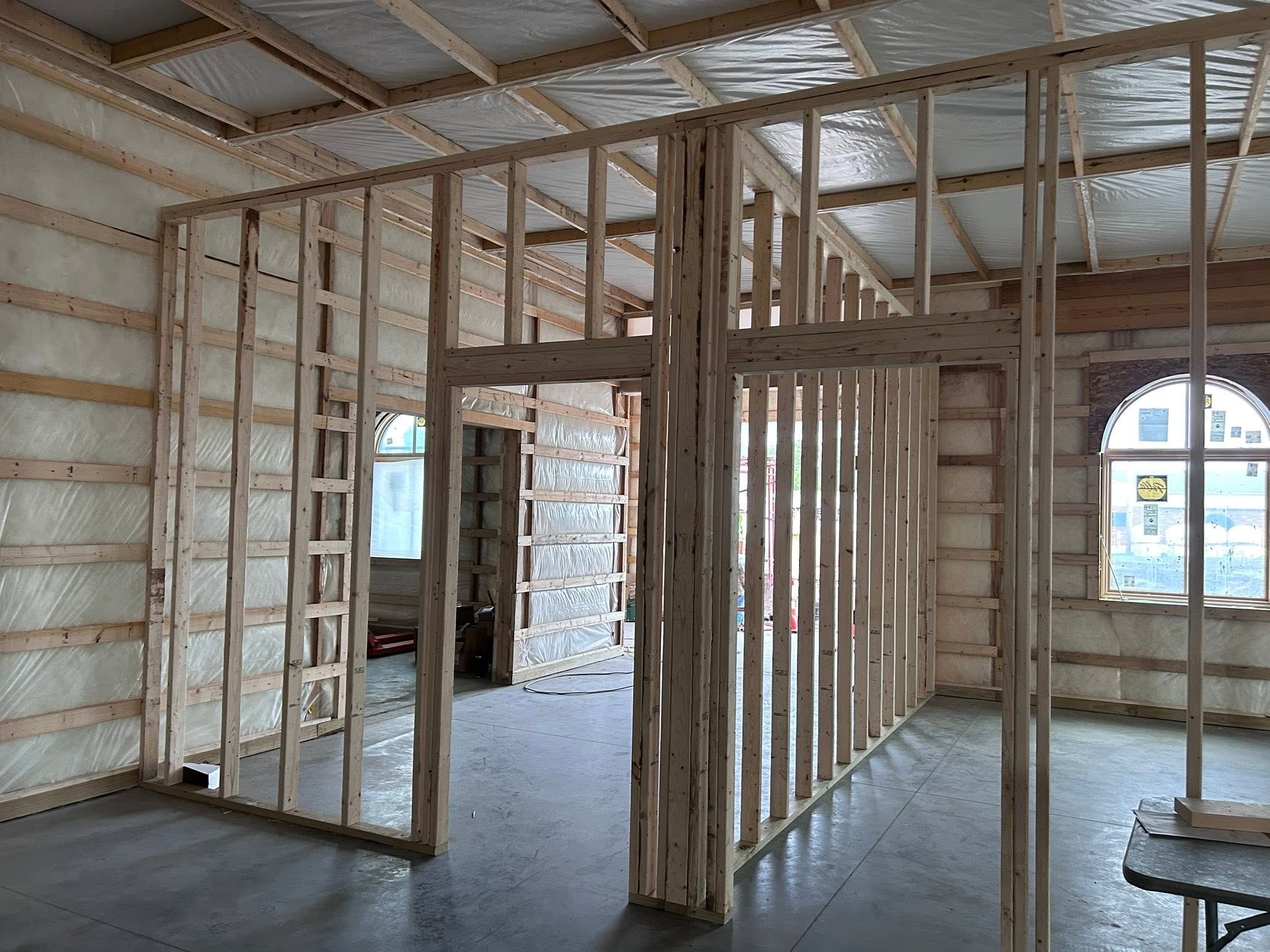

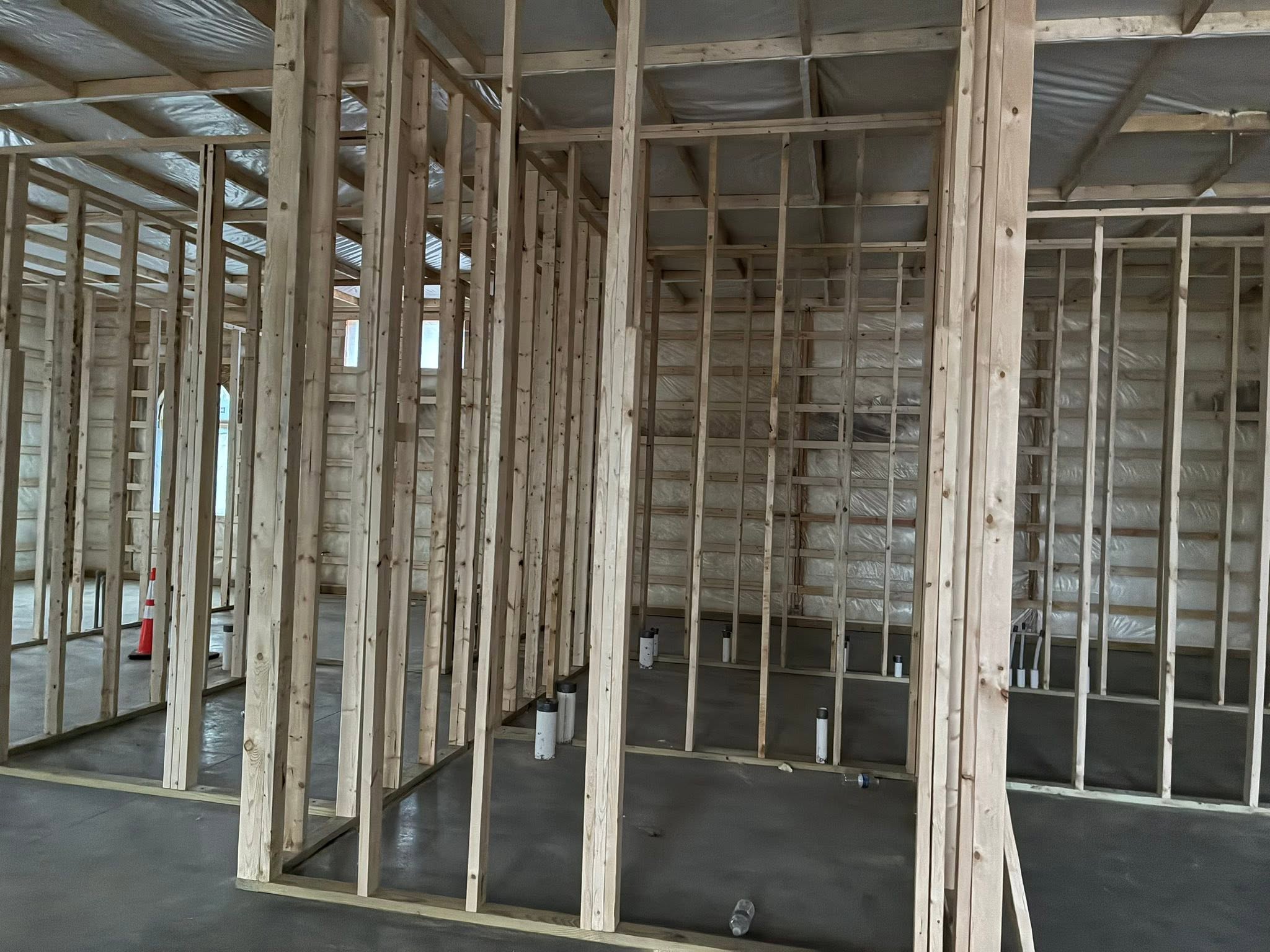

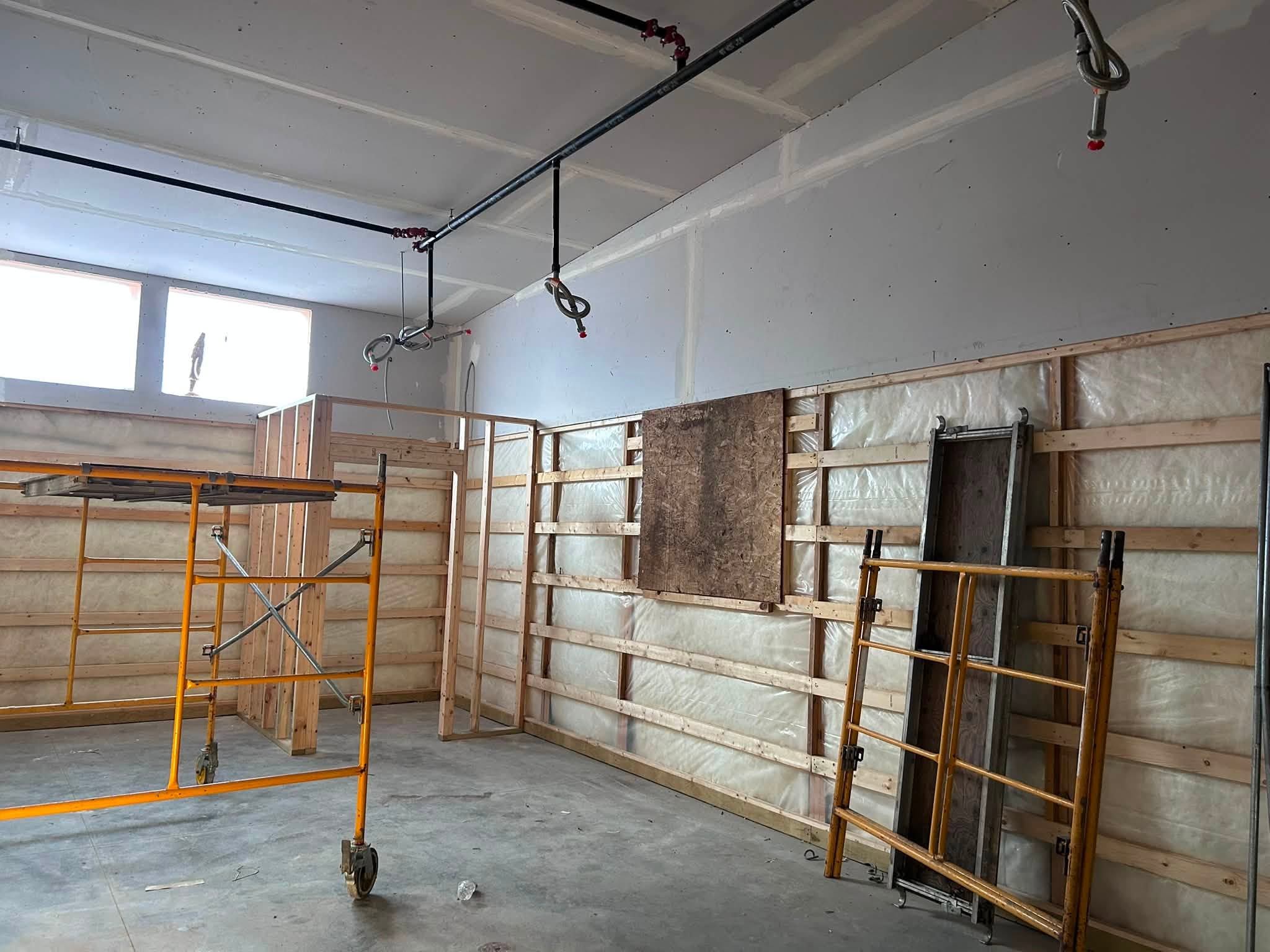

Morton Building workers started early again. Today they are building walls.

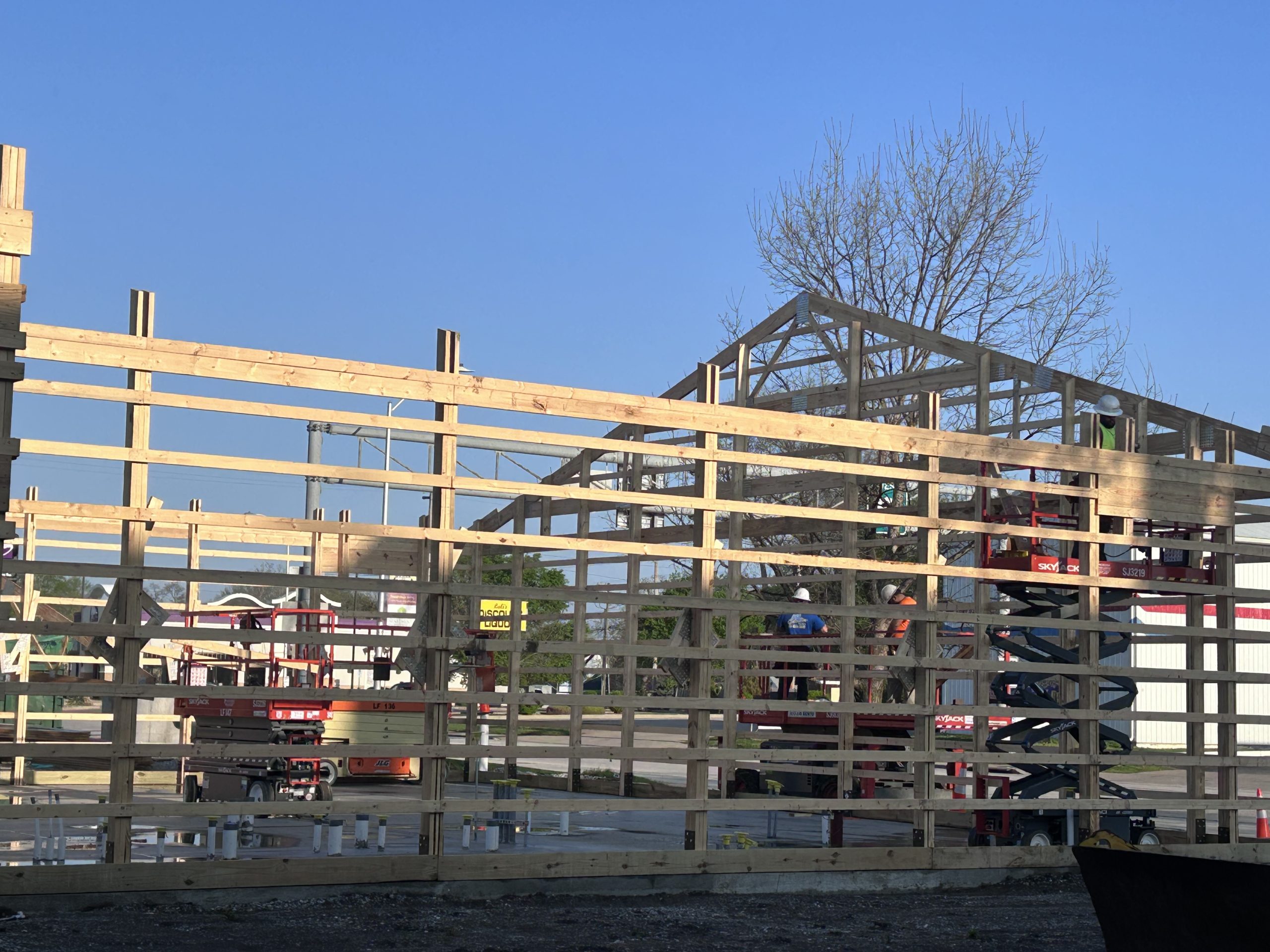

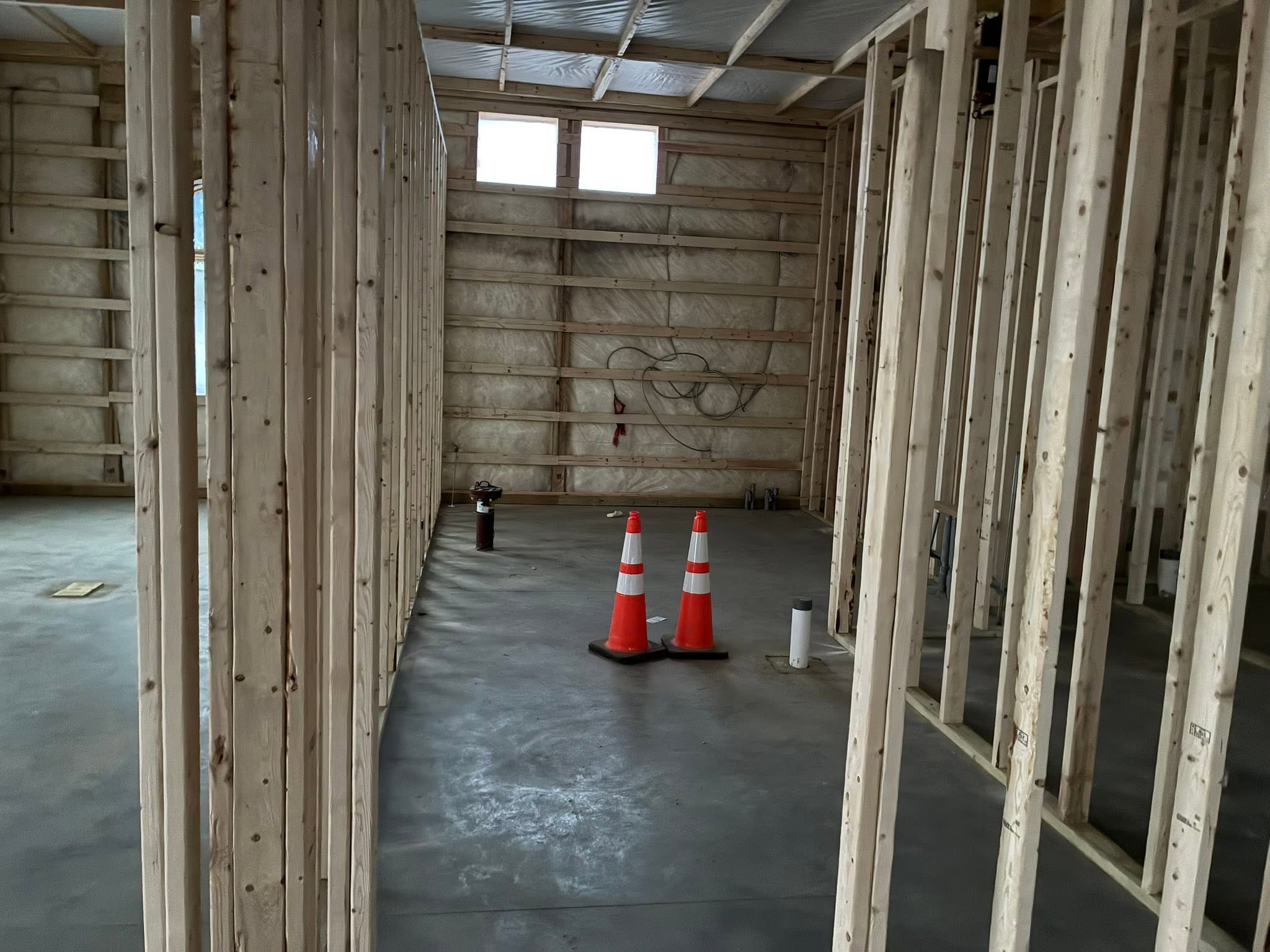

Installing Posts

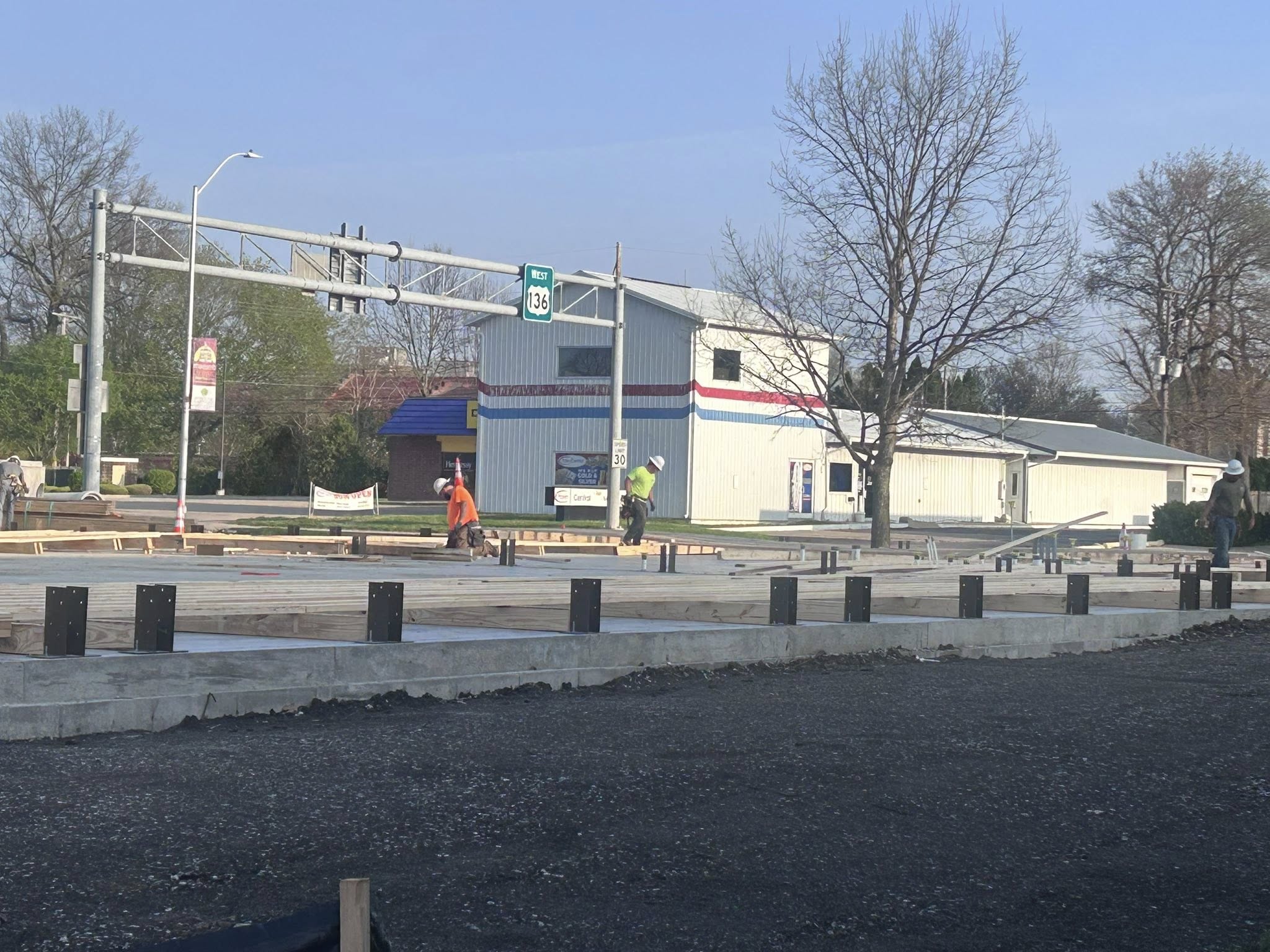

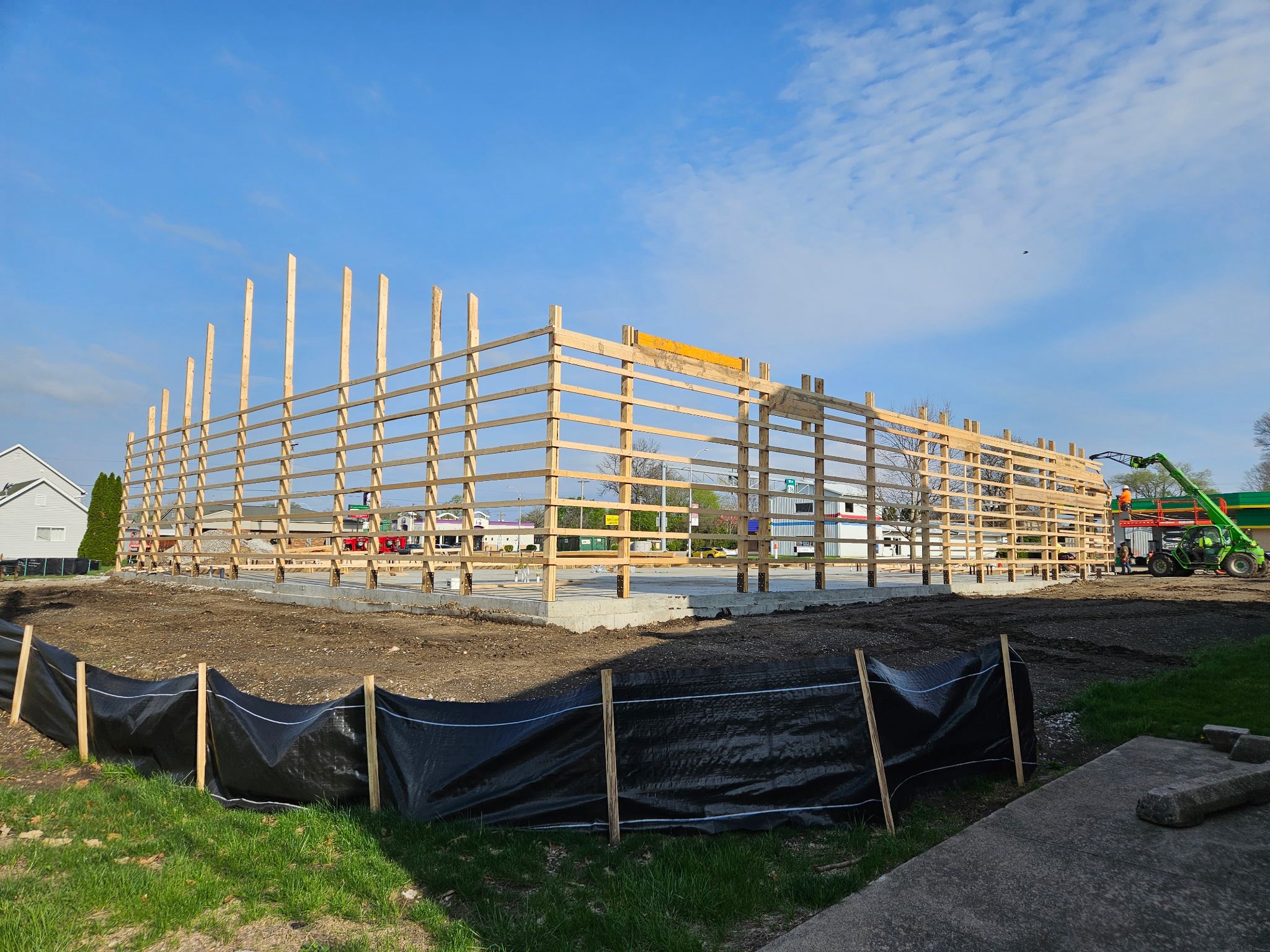

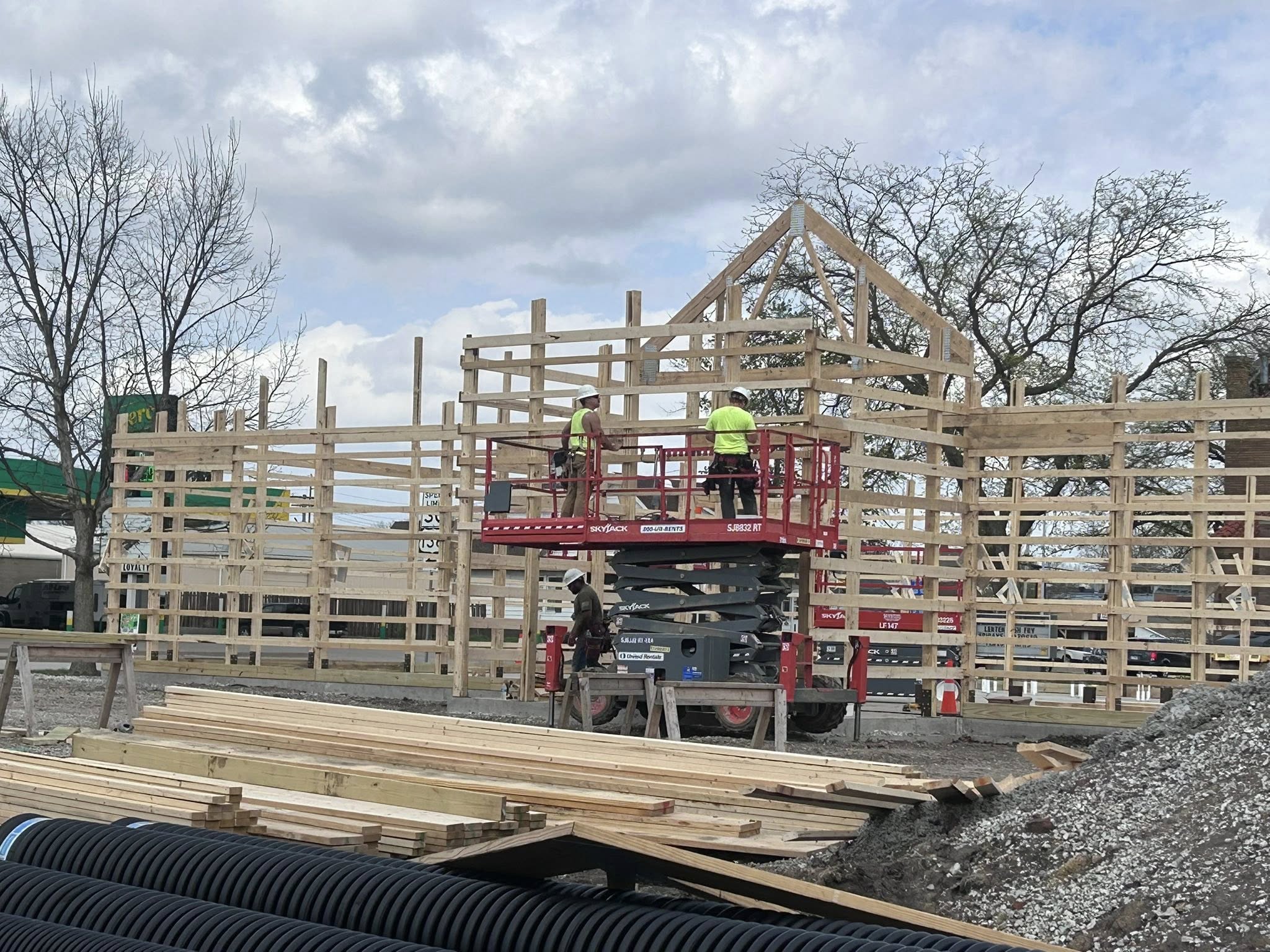

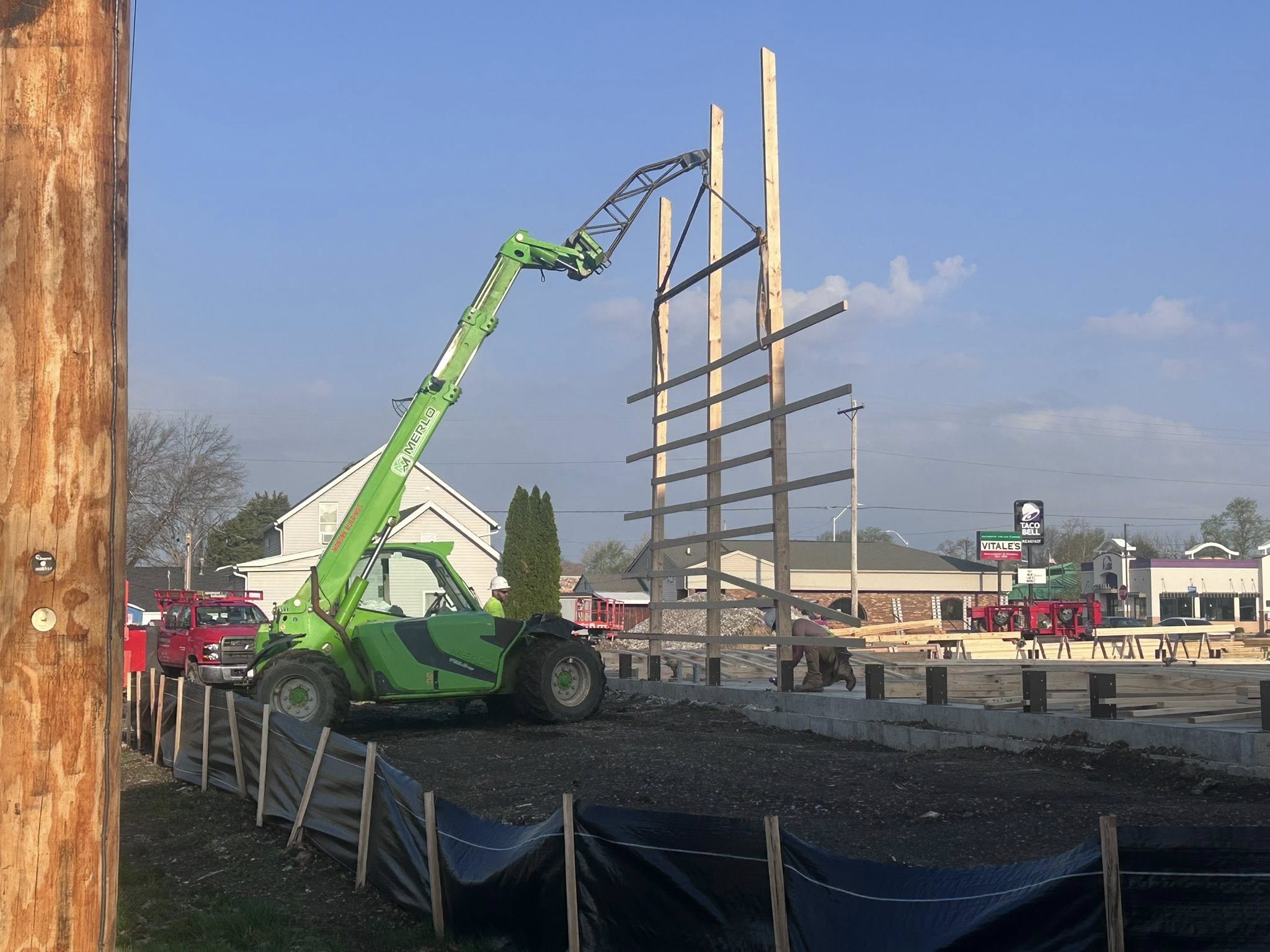

April 14, 2026

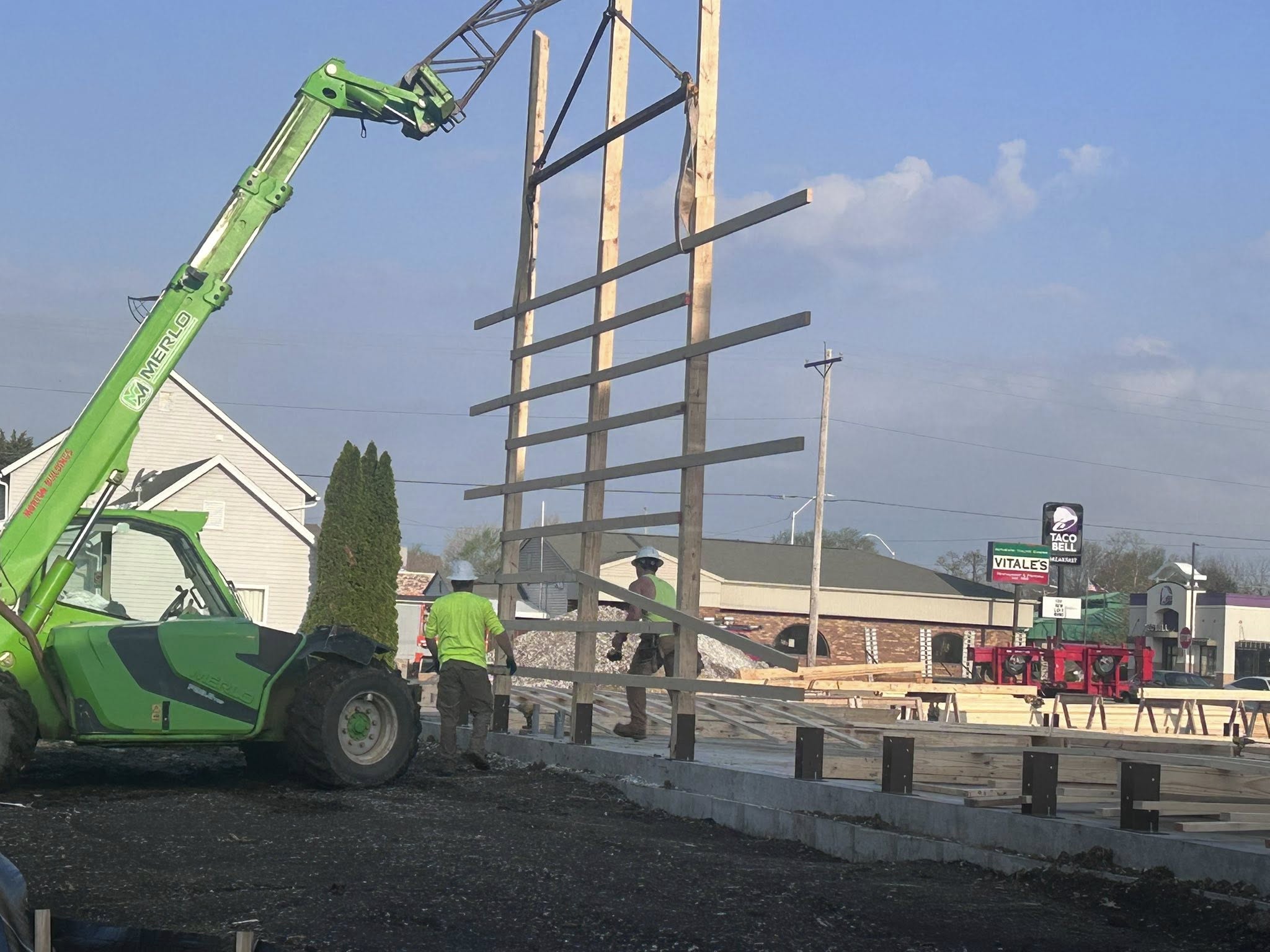

THE FIRST POSTS ARE UP!!! Progress!

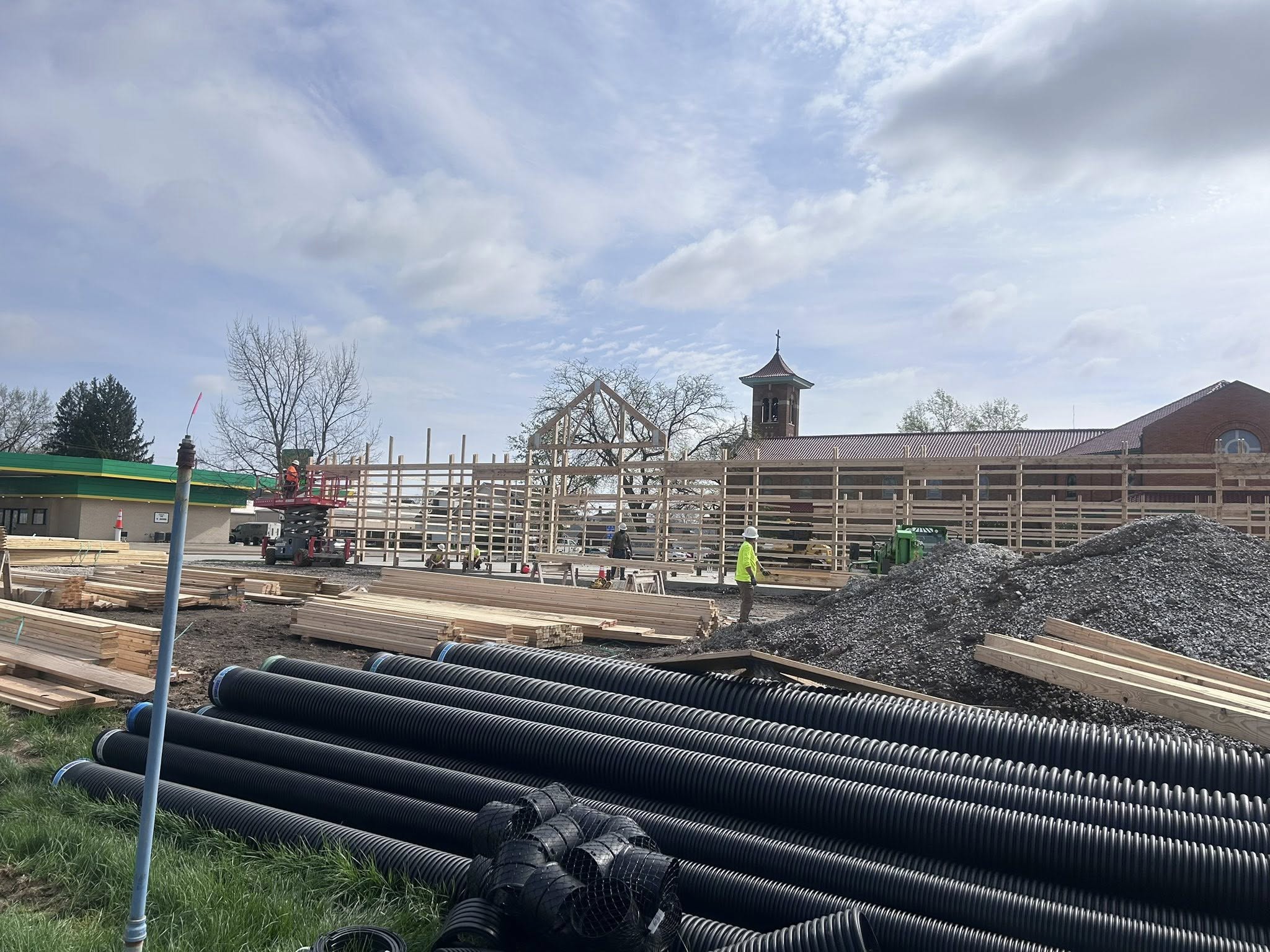

We Have Walls!

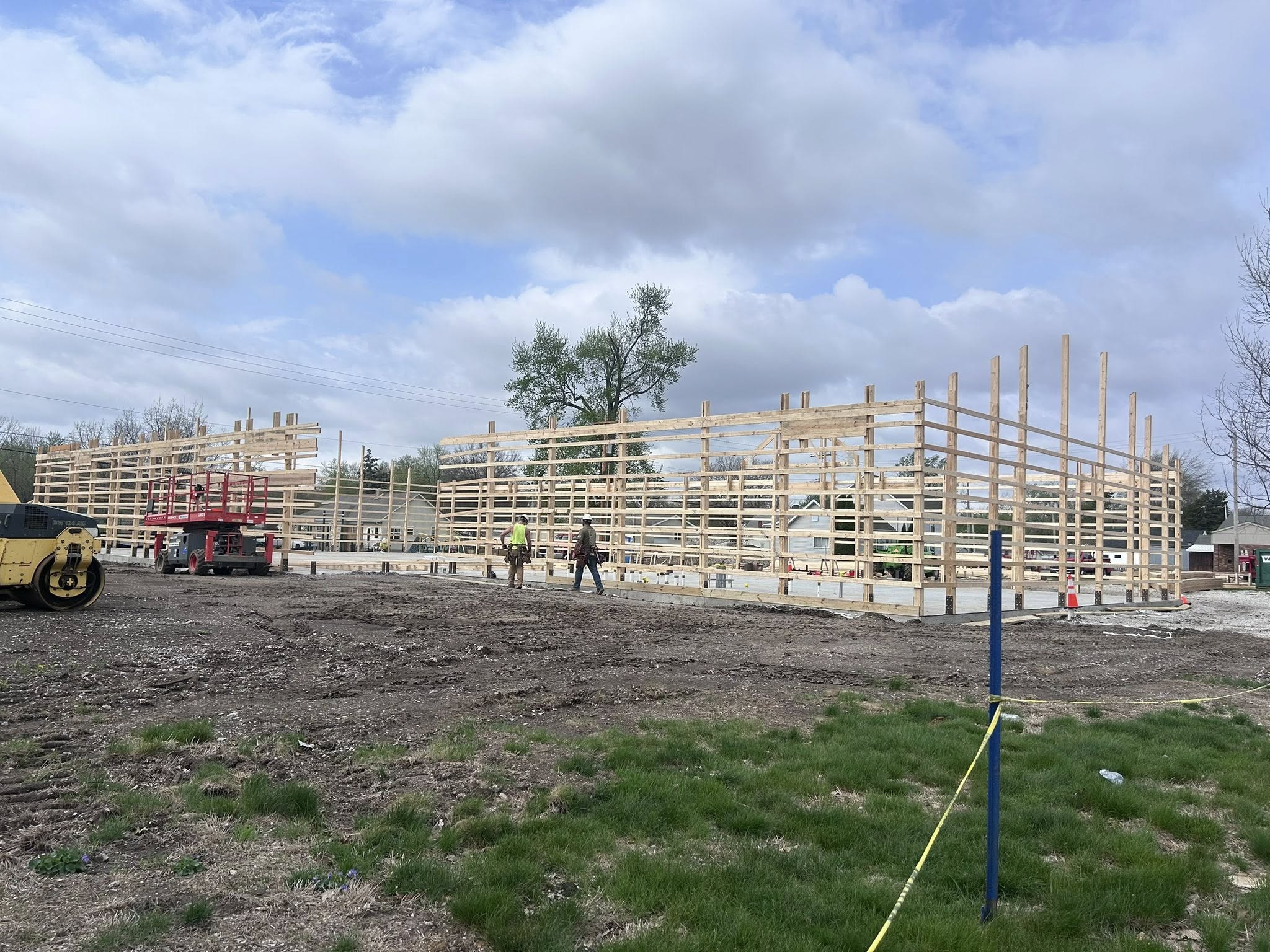

April 14, 2026

This morning’s progress…

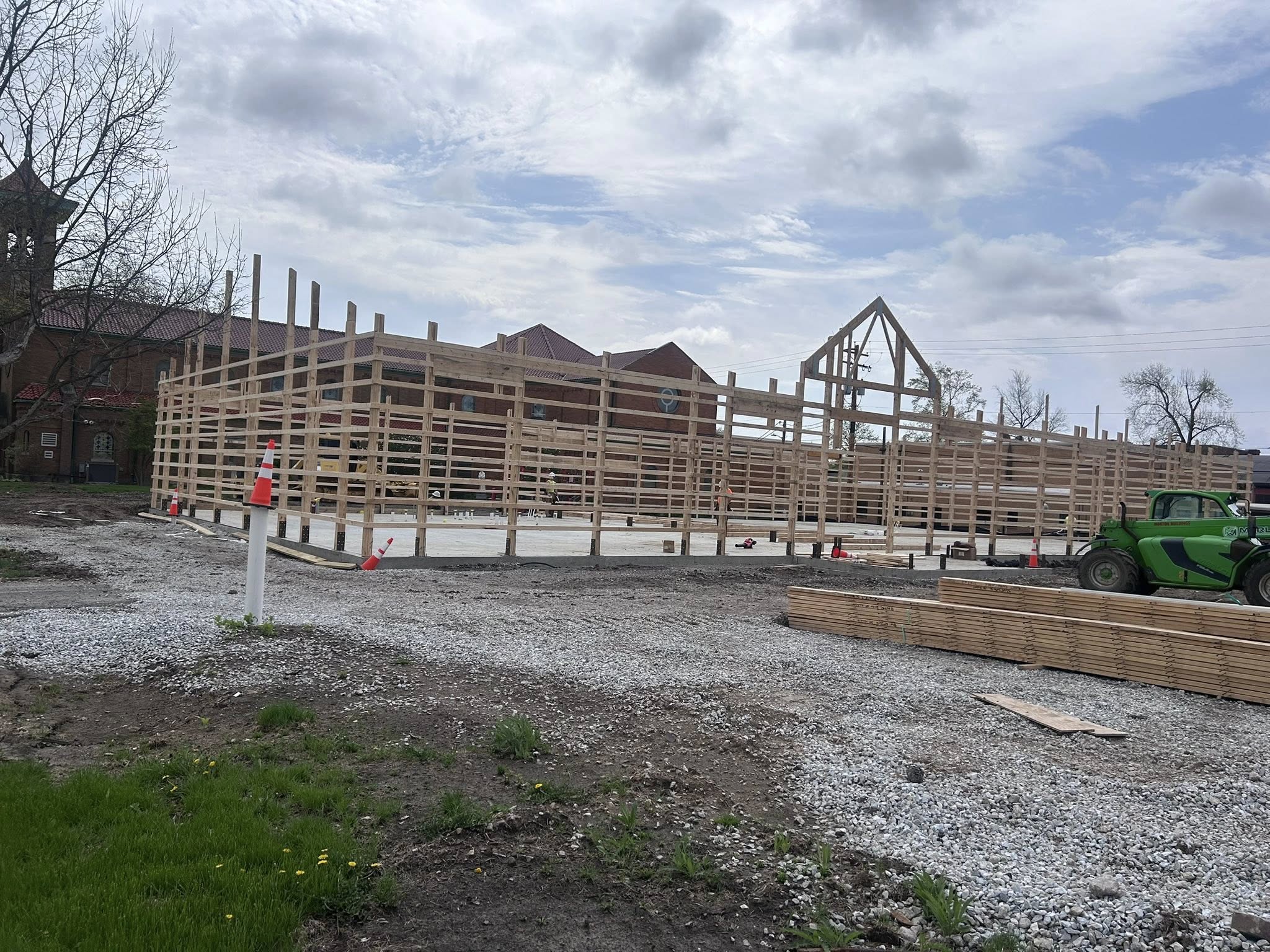

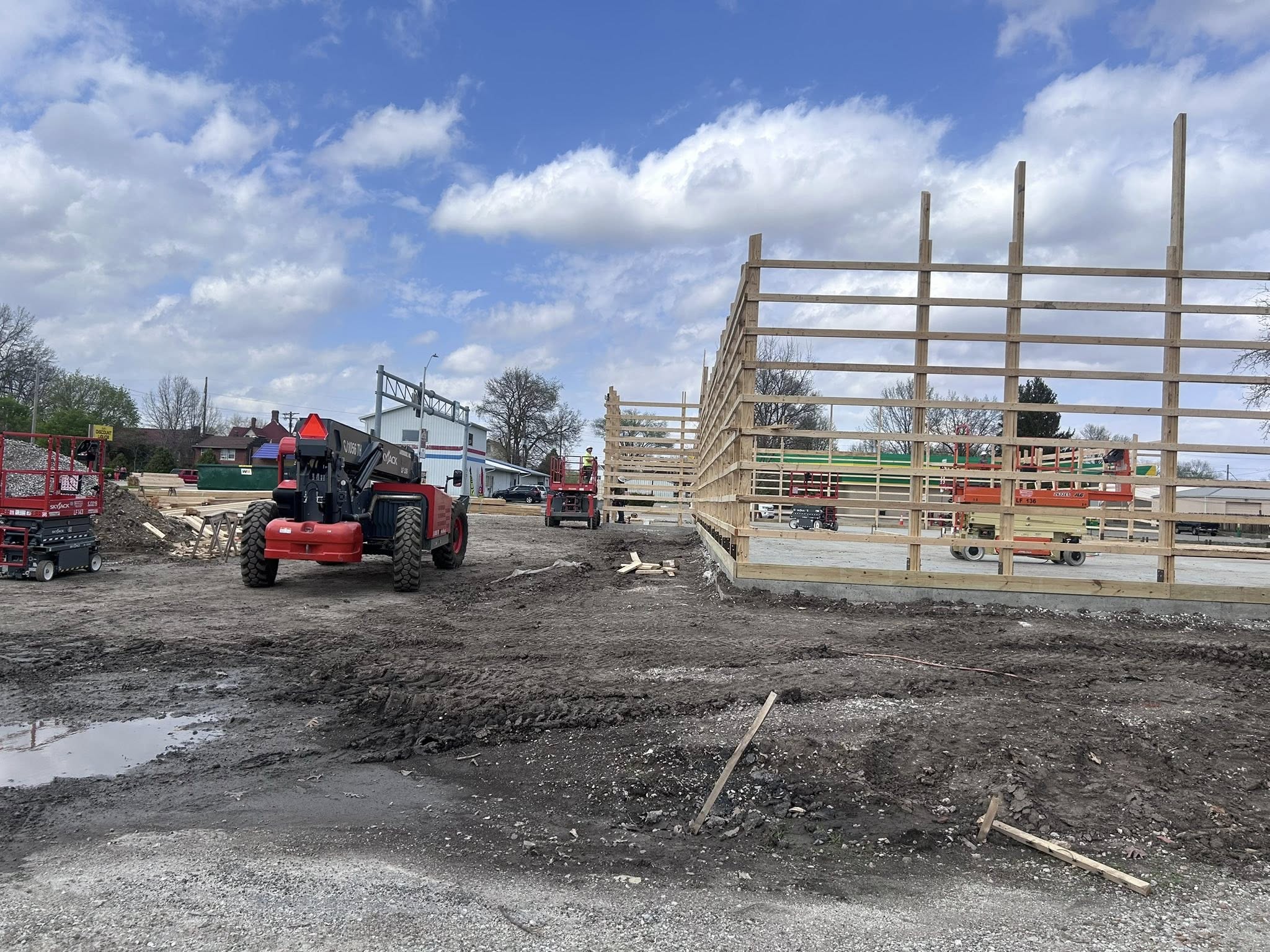

We Have More Walls!

April 14, 2026

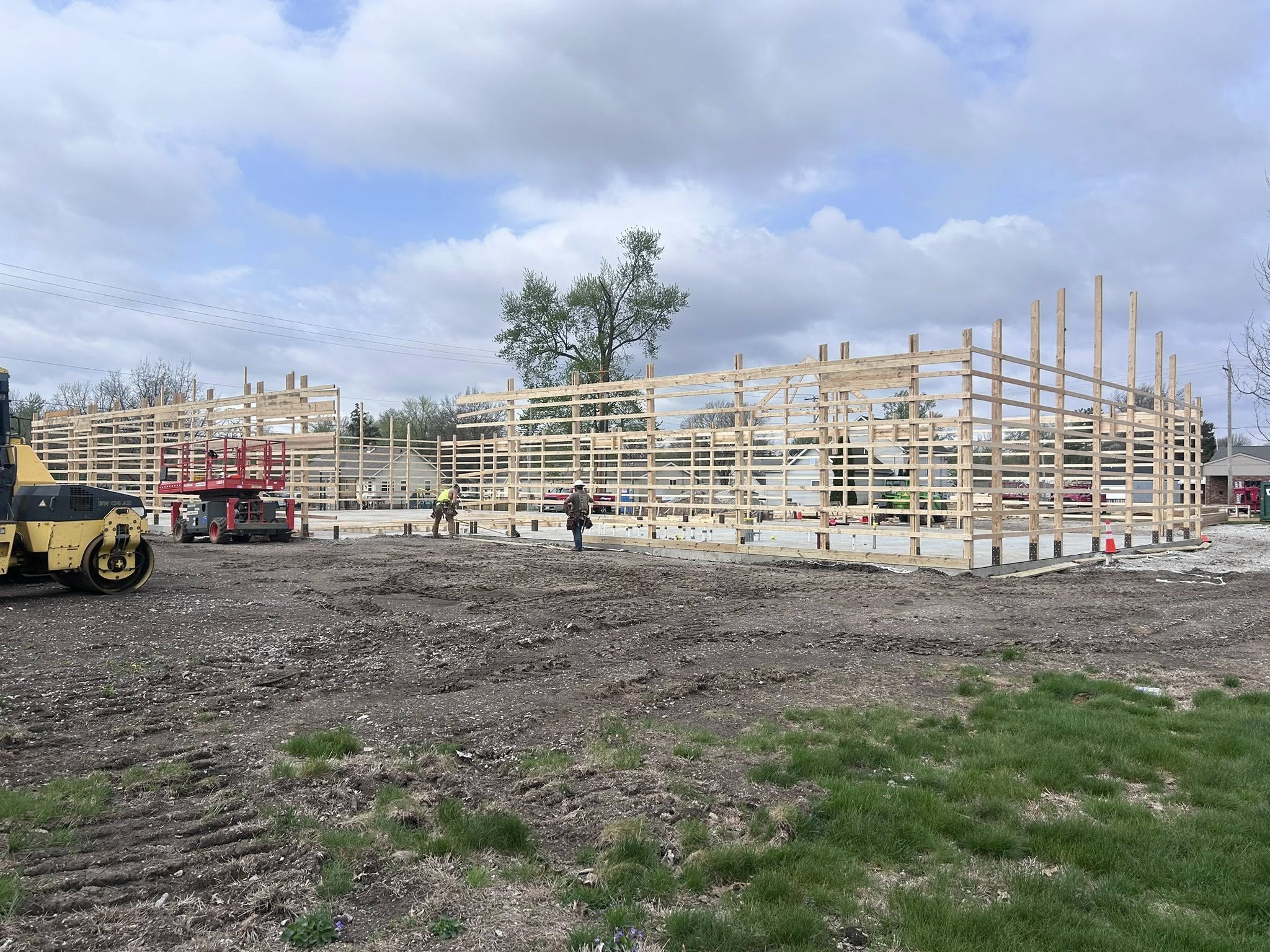

This afternoon’s progress. They are preparing for the truss installation and we have walls for the entrance. Woohoo!

Trusses Going In

April 17, 2026

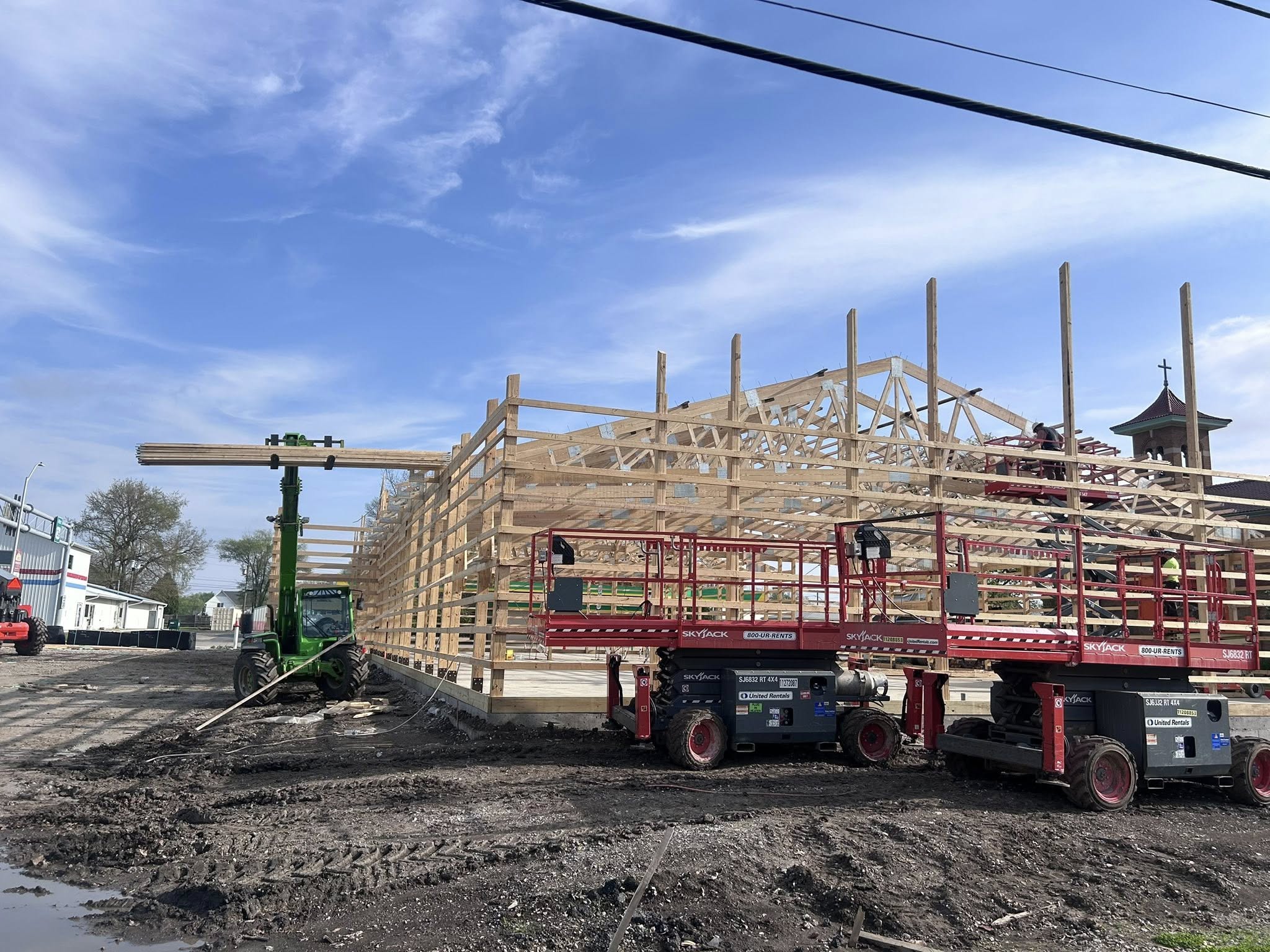

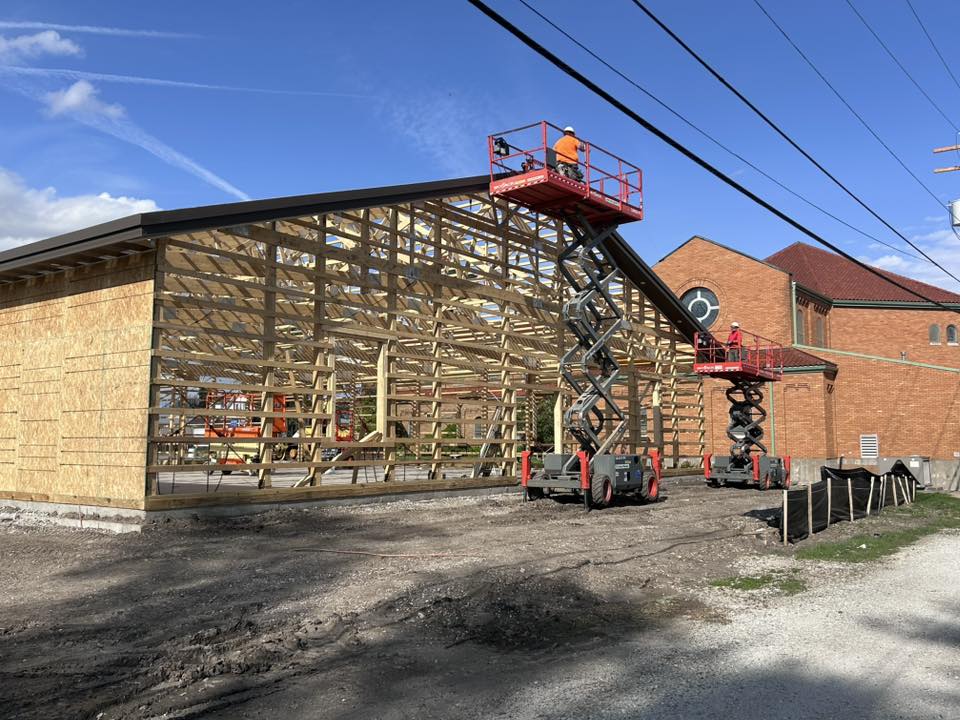

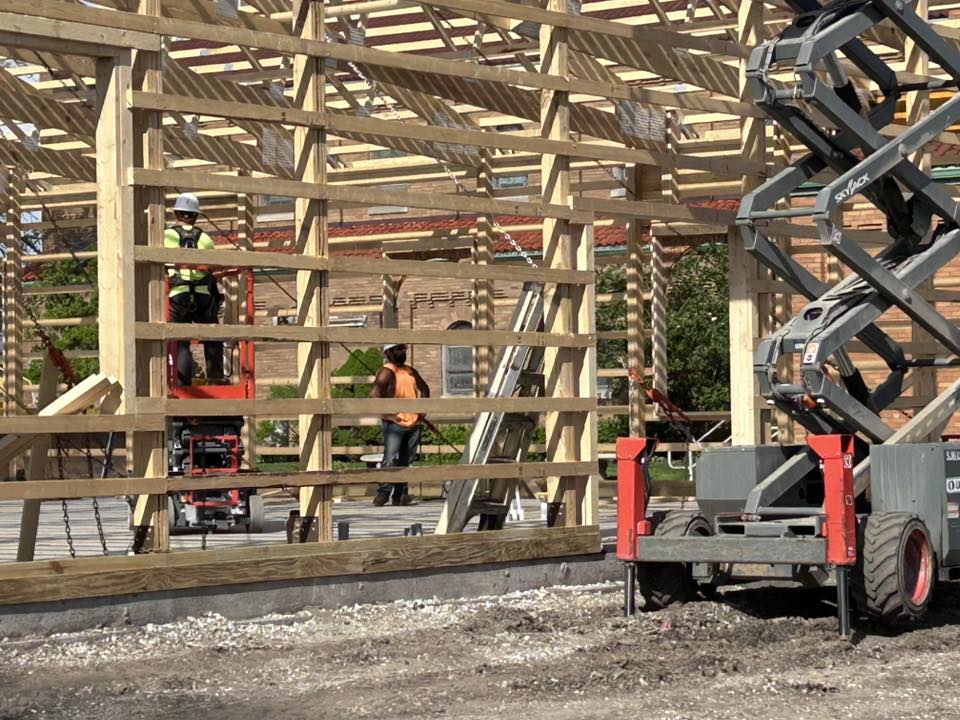

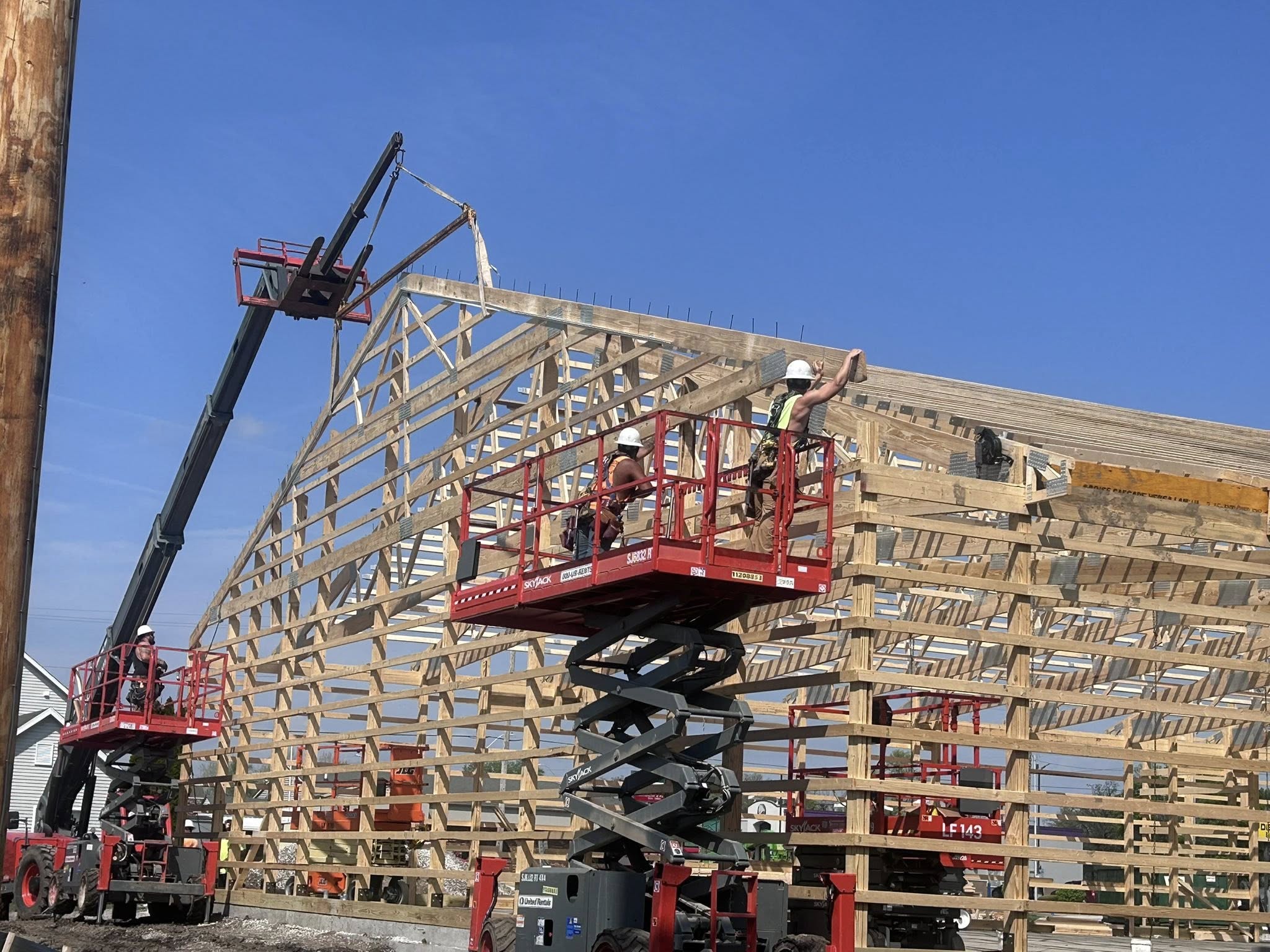

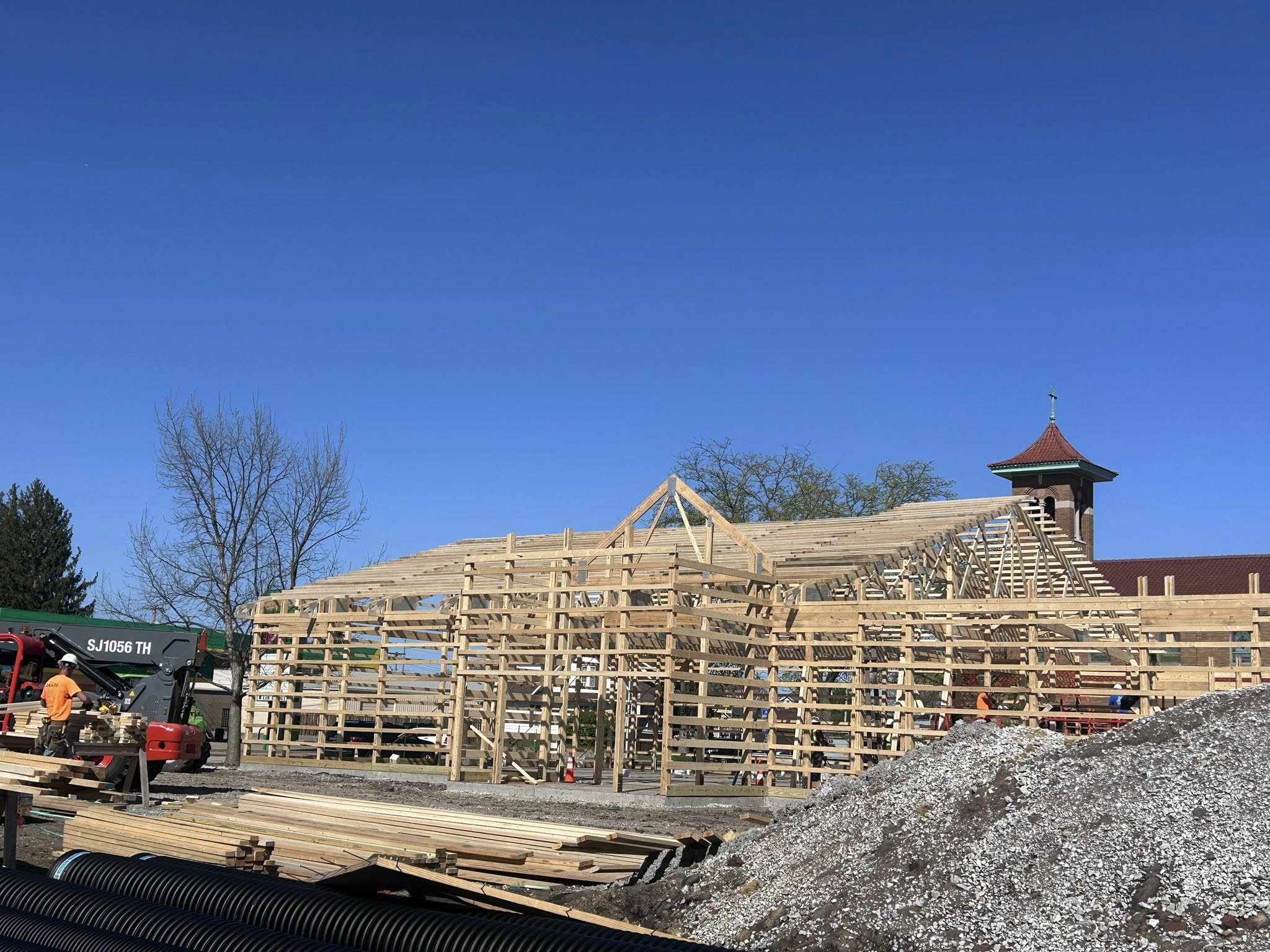

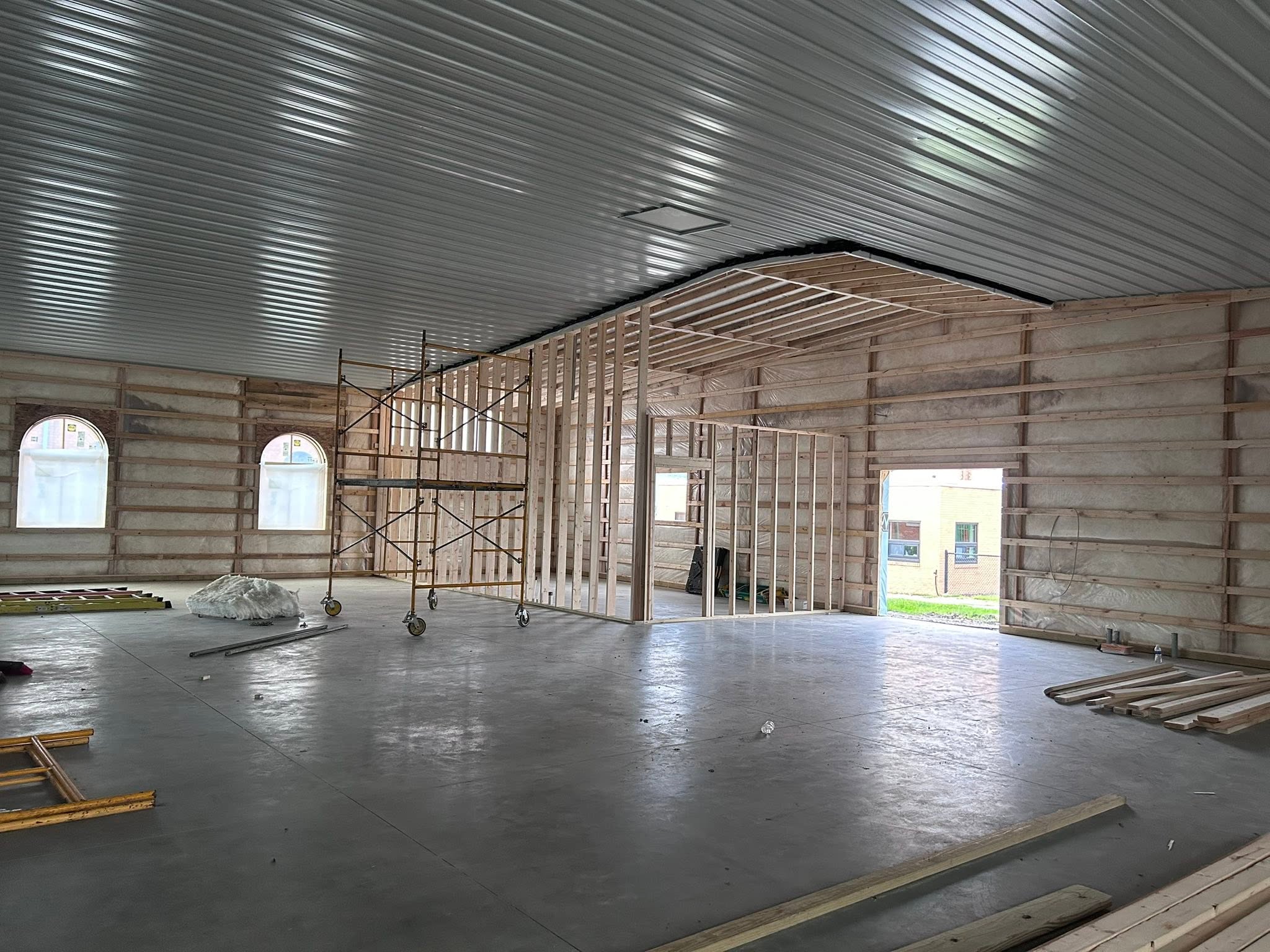

Most of the trusses are in place! They have tied them together and installed the stingers(the piece for the soffit installation). So much progress this week!

It’s Starting to Look Like a Parish Hall

April 17, 2026

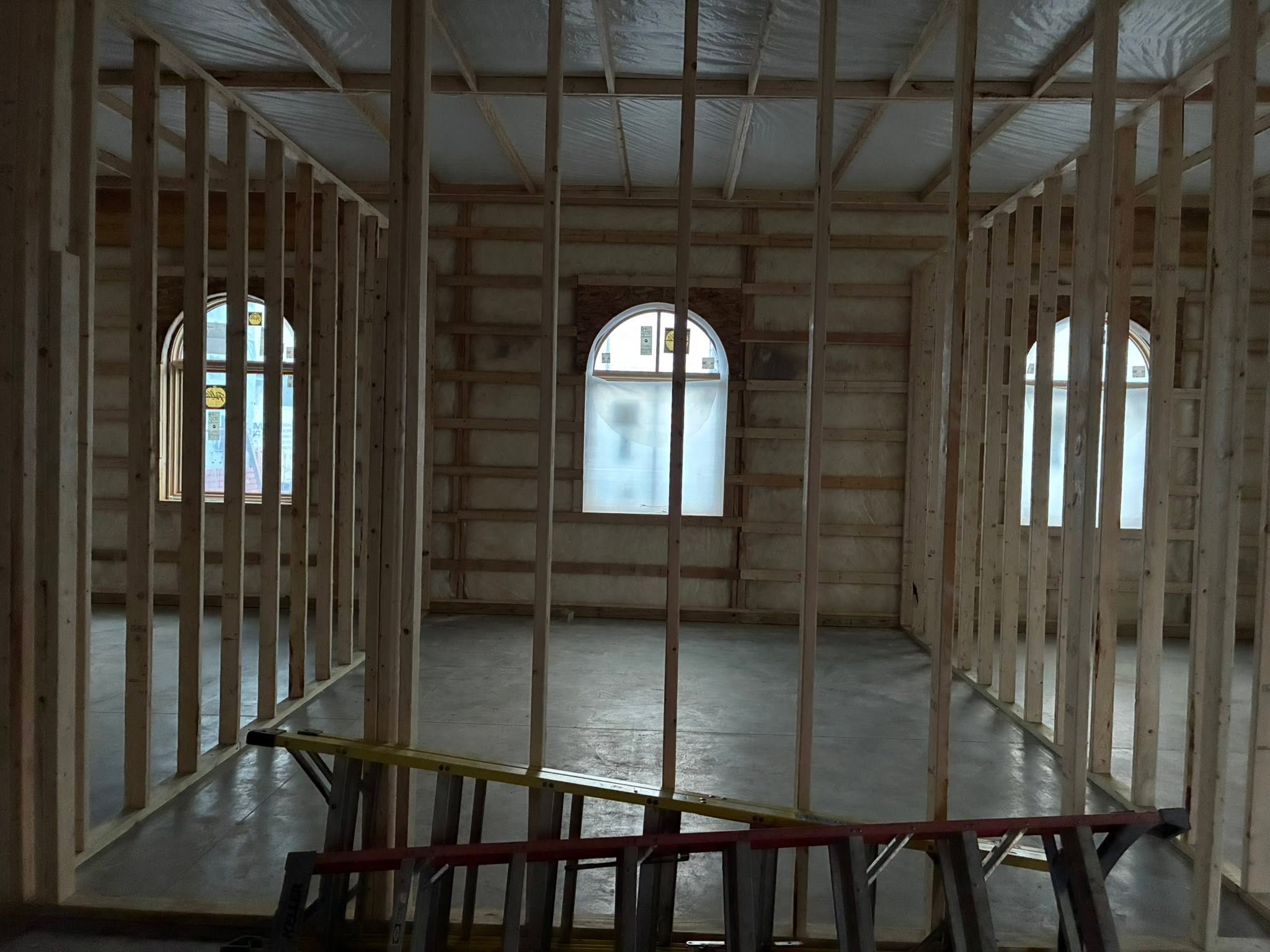

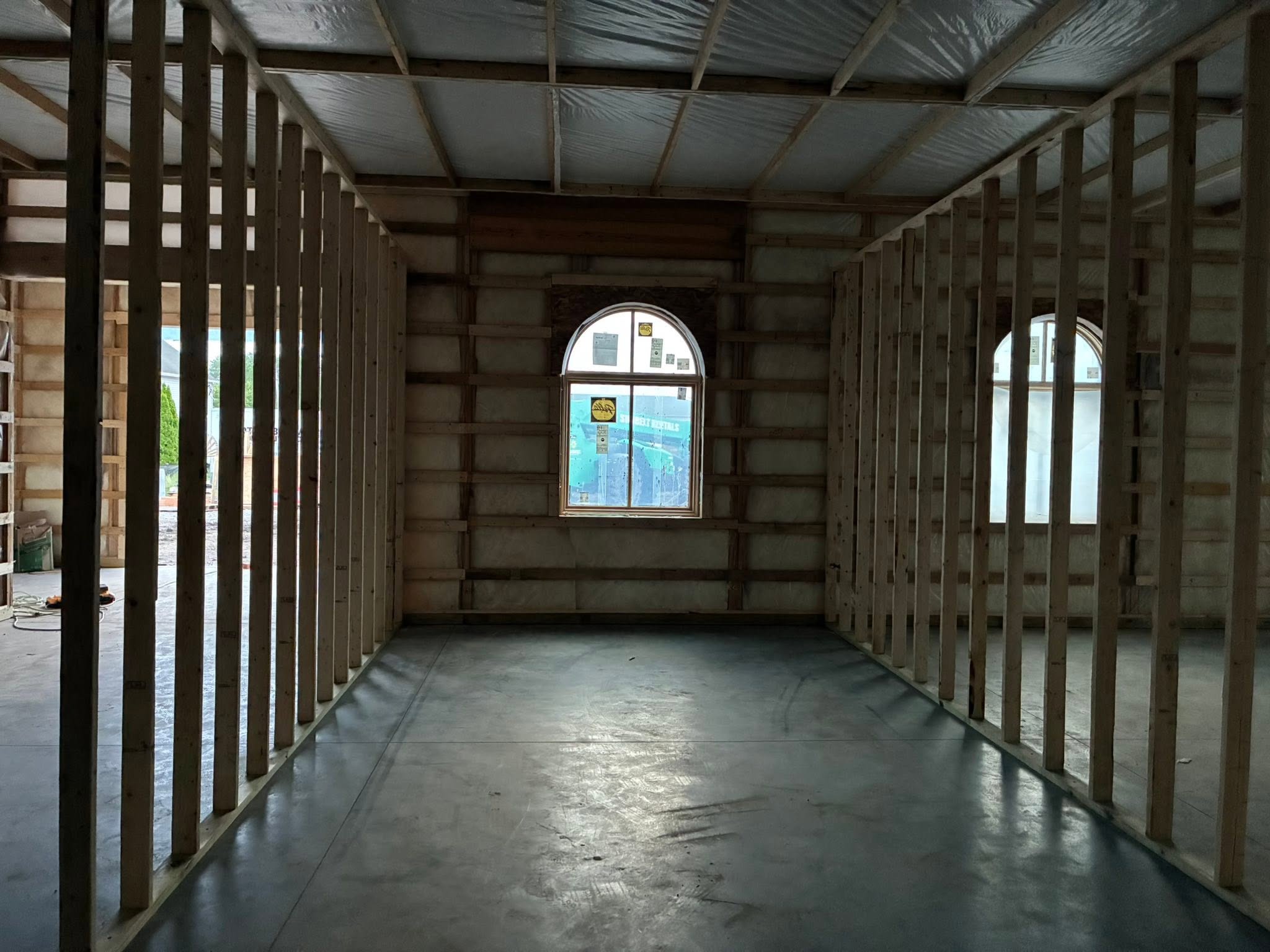

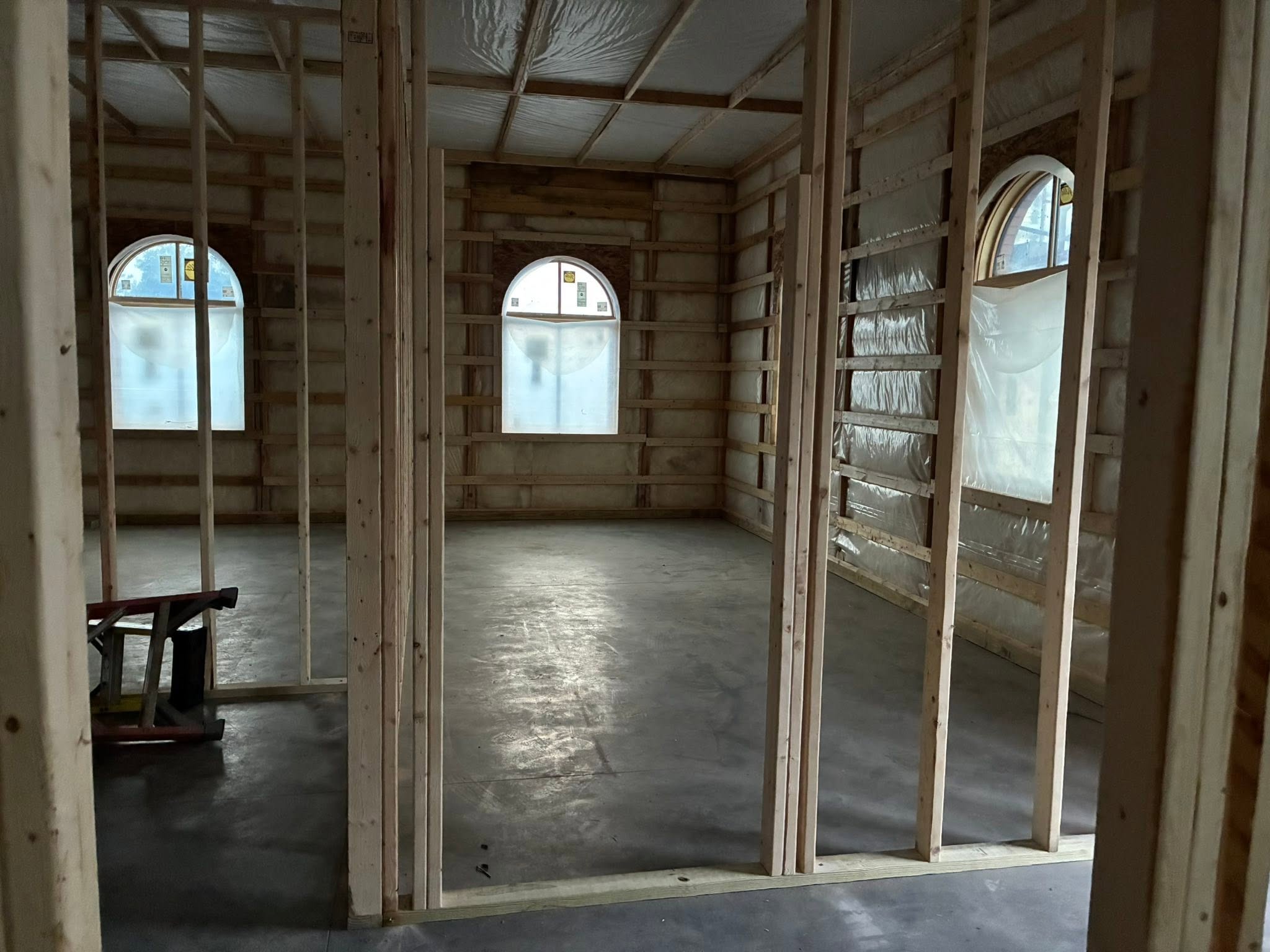

This afternoon’s progress. The office area (left side of picture 2 and 3) was mostly done by noon. Moving right along…

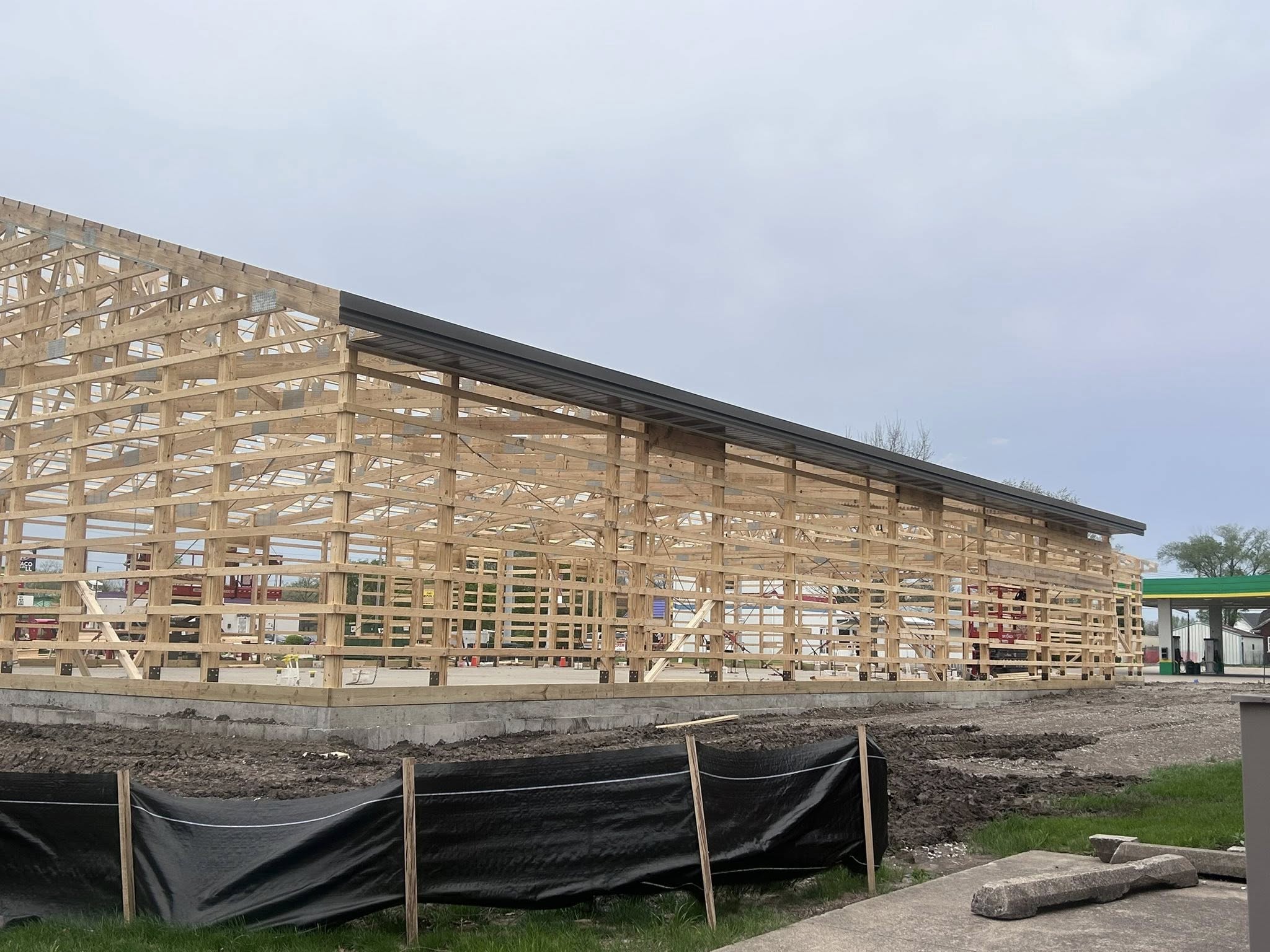

Soffit Installation

April 17, 2026

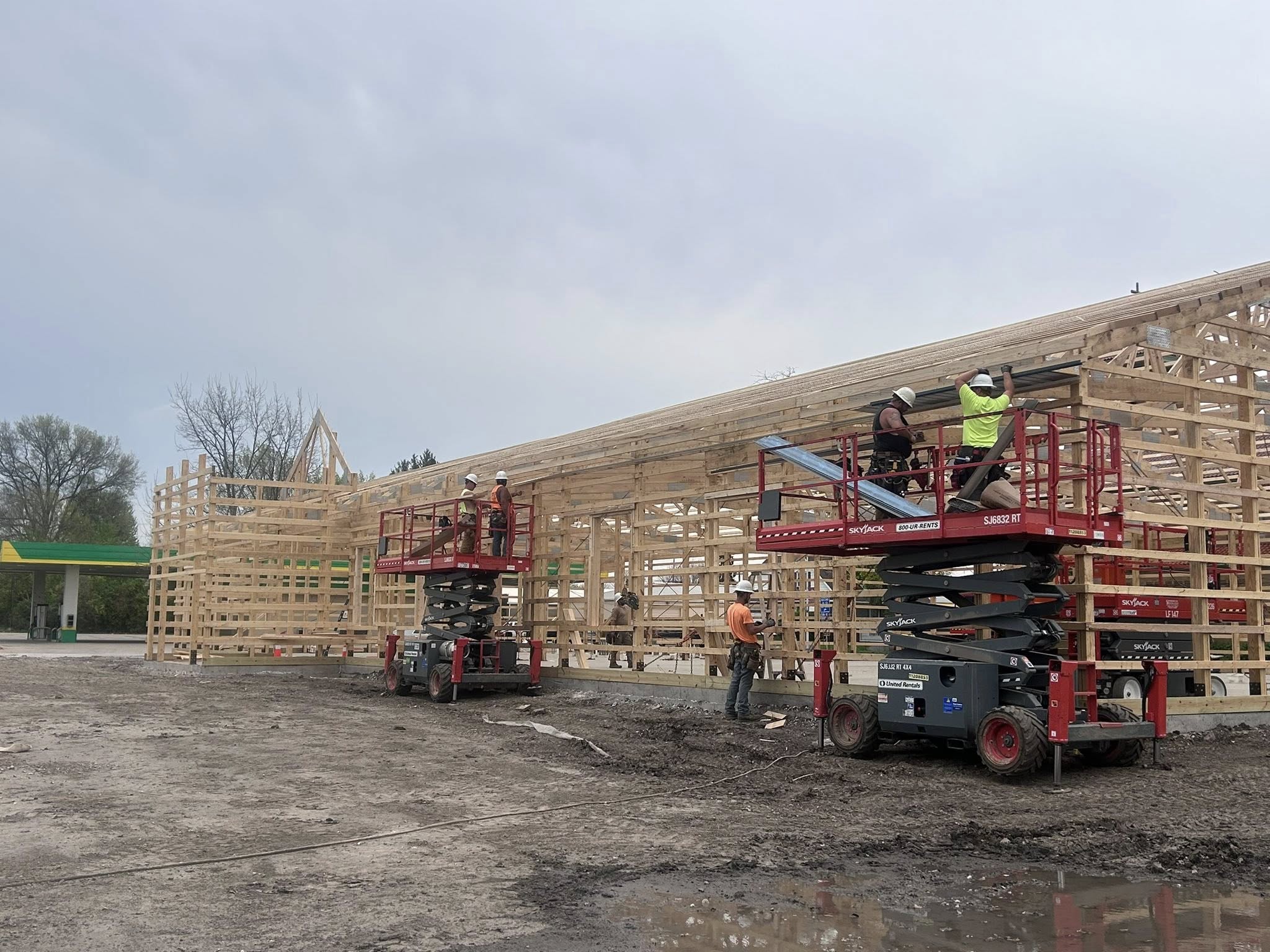

Finishing work on Friday with soffit installation.

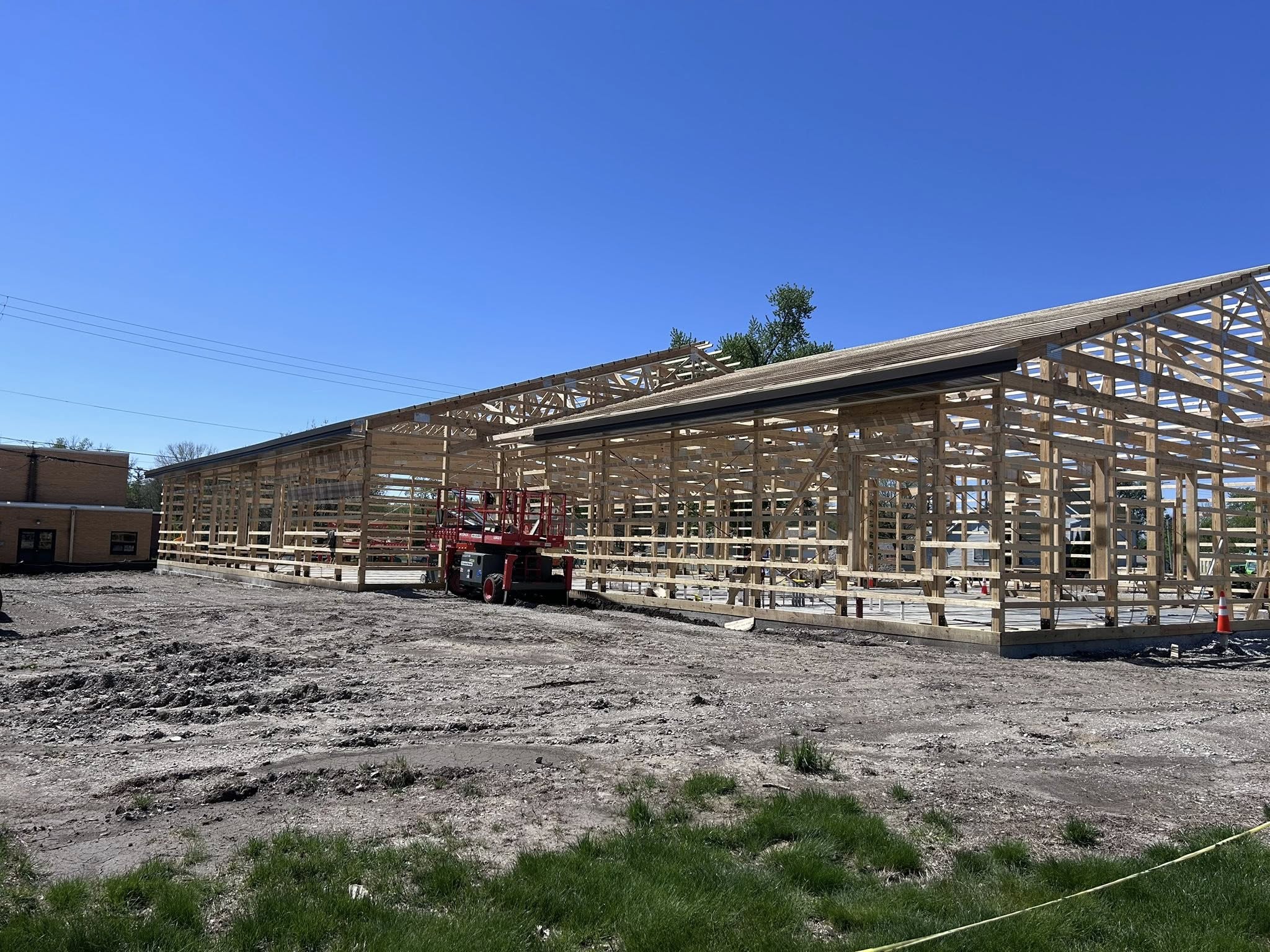

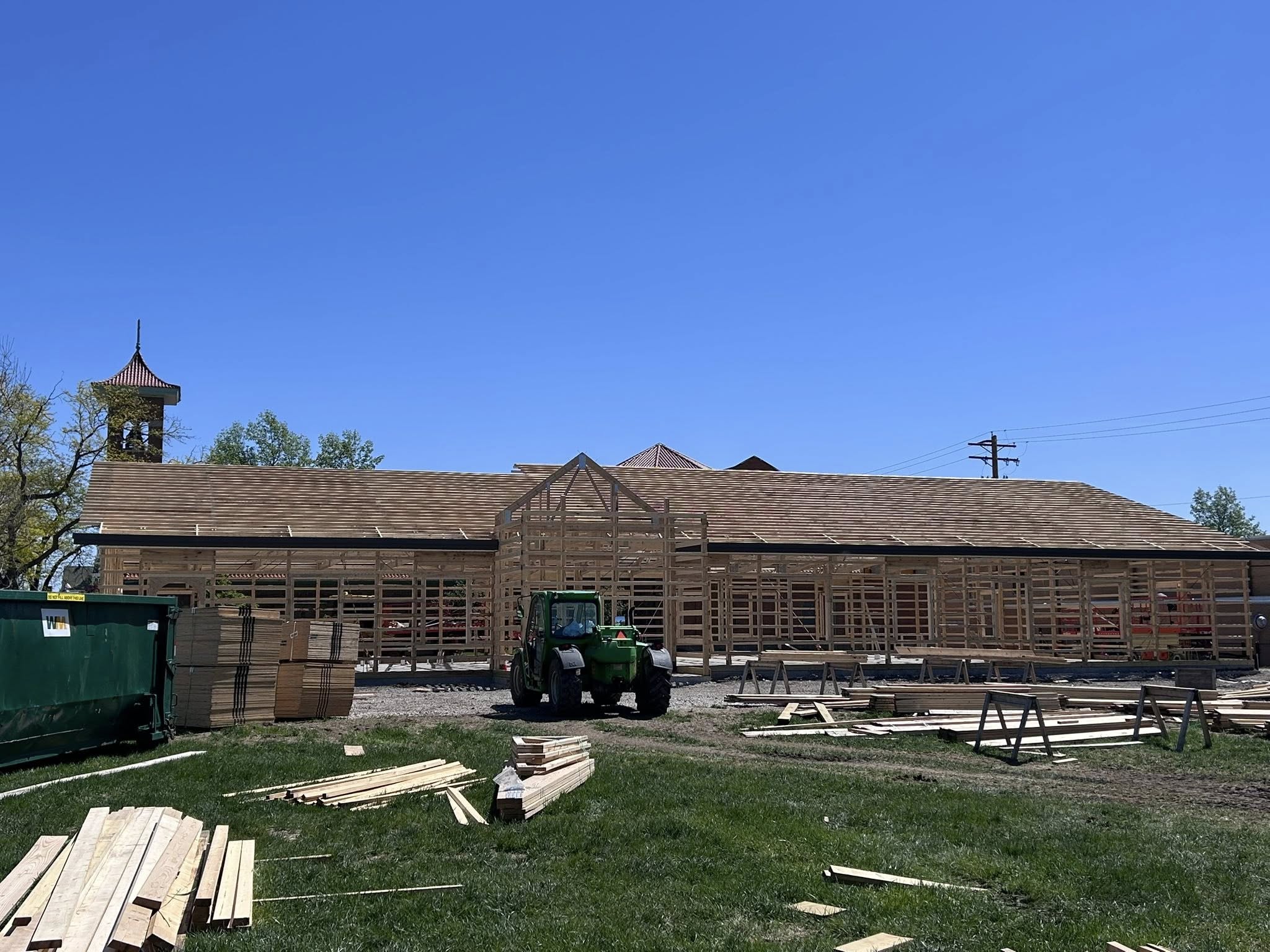

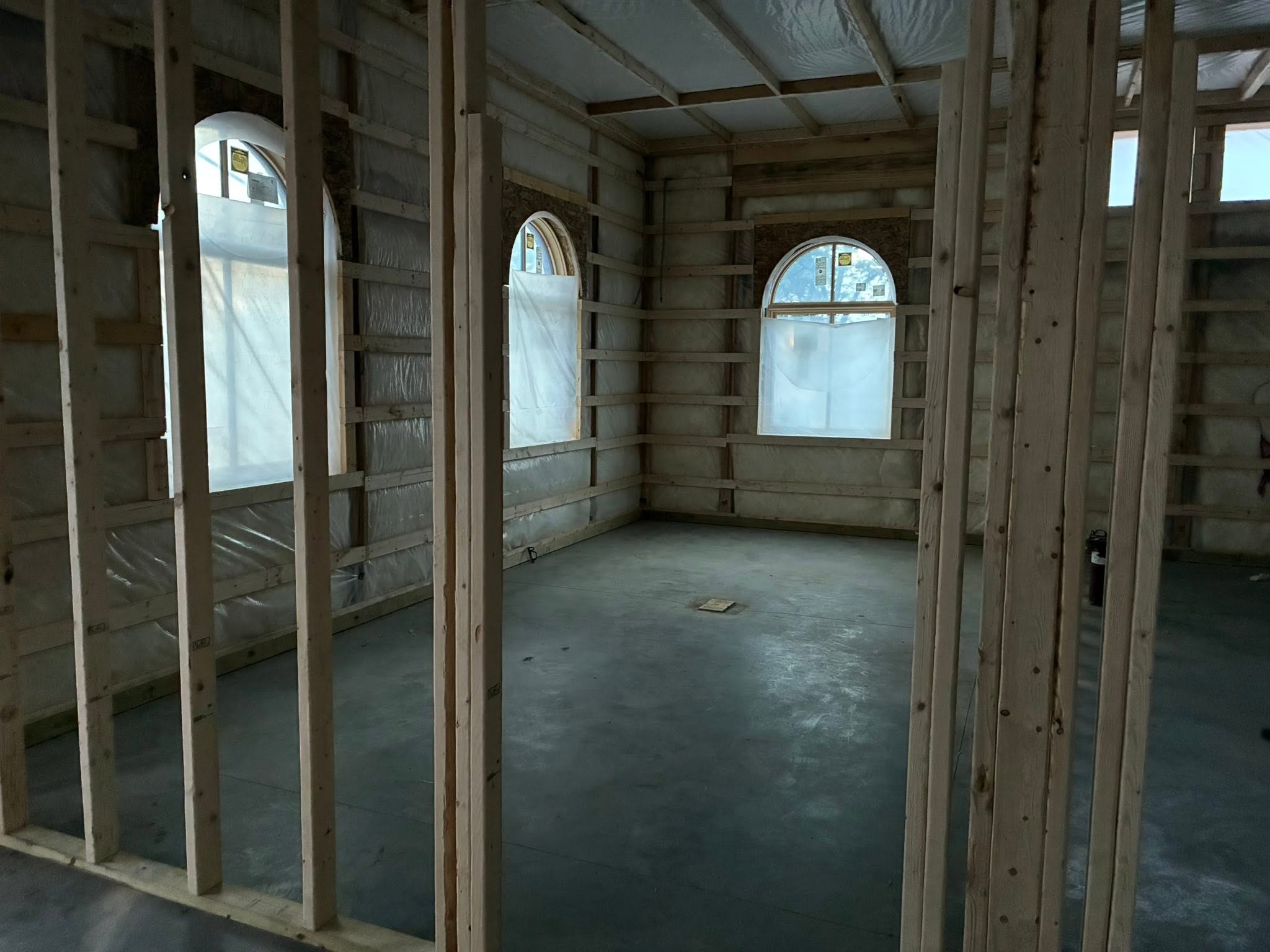

Window Framing

April 21, 2026

Today’s accomplishments-more soffits and window framing.

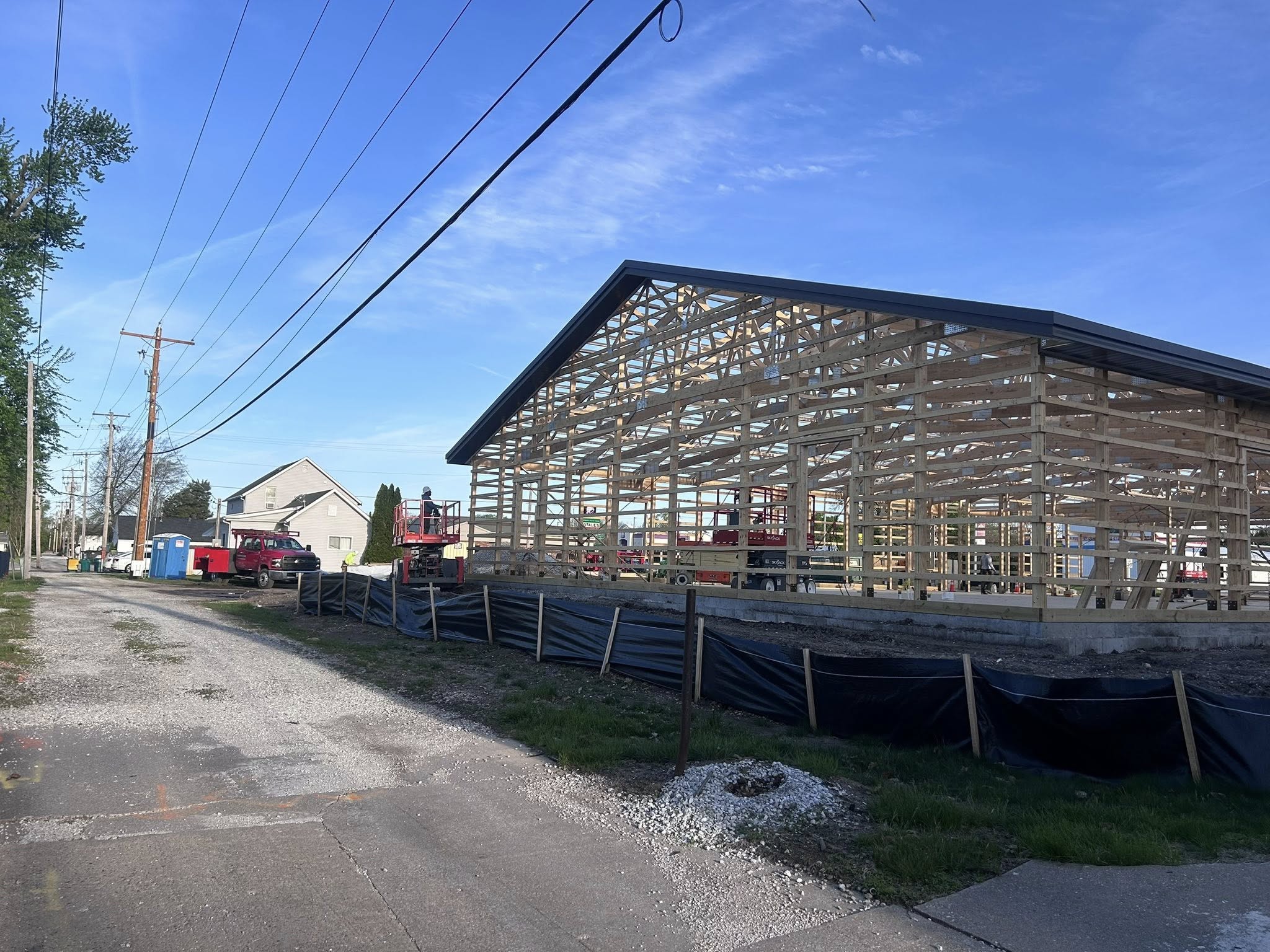

Soffit Completion

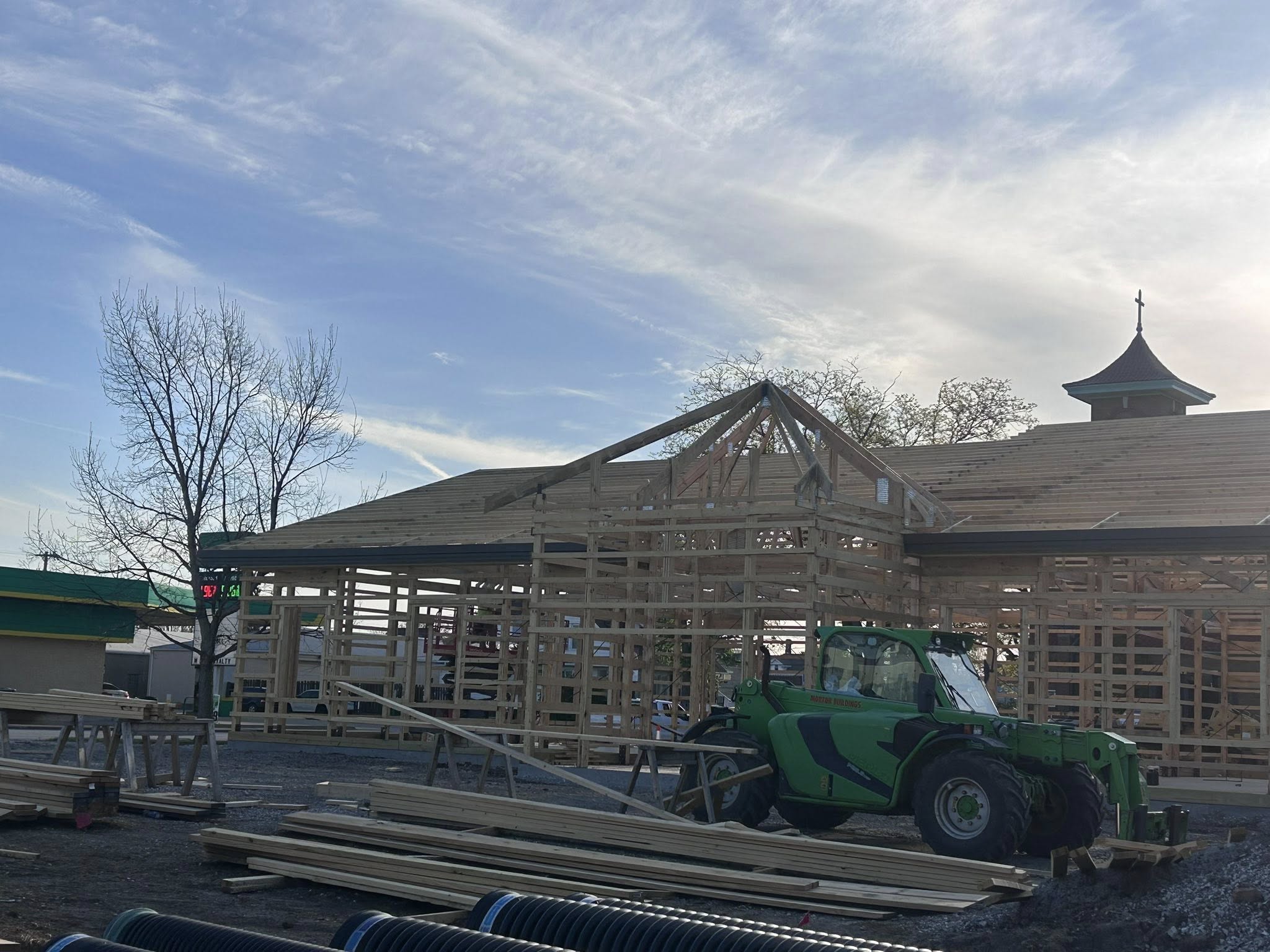

April 21, 2026

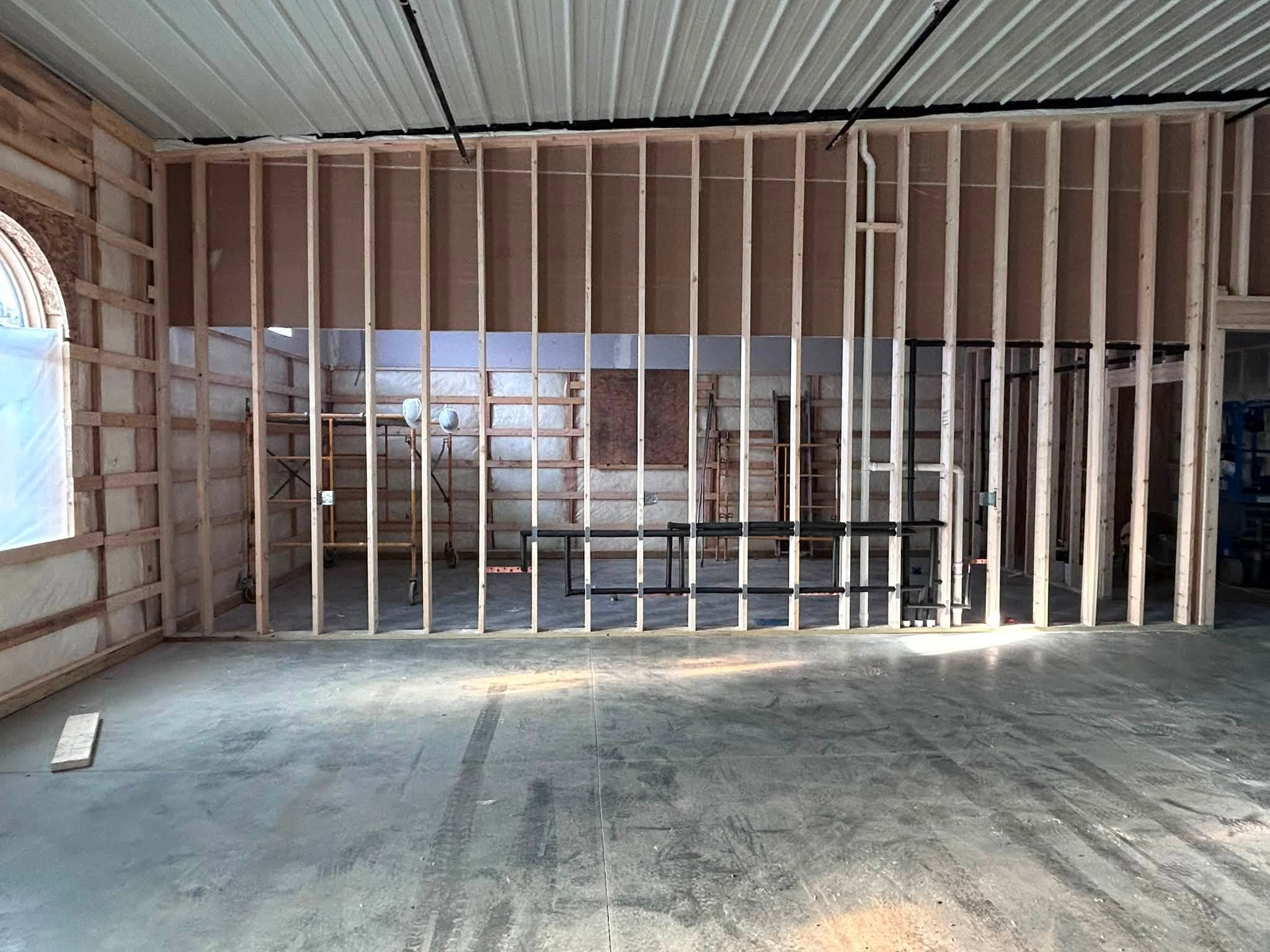

The soffits are done in the hall area and most of the office area. The beams have been added to the main entrance roof.

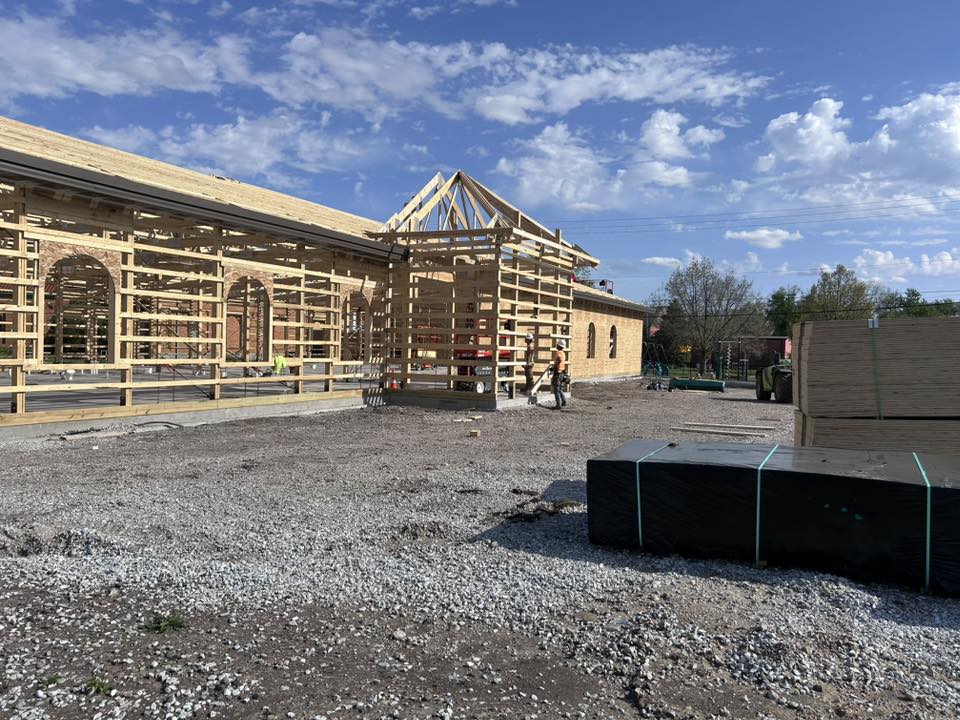

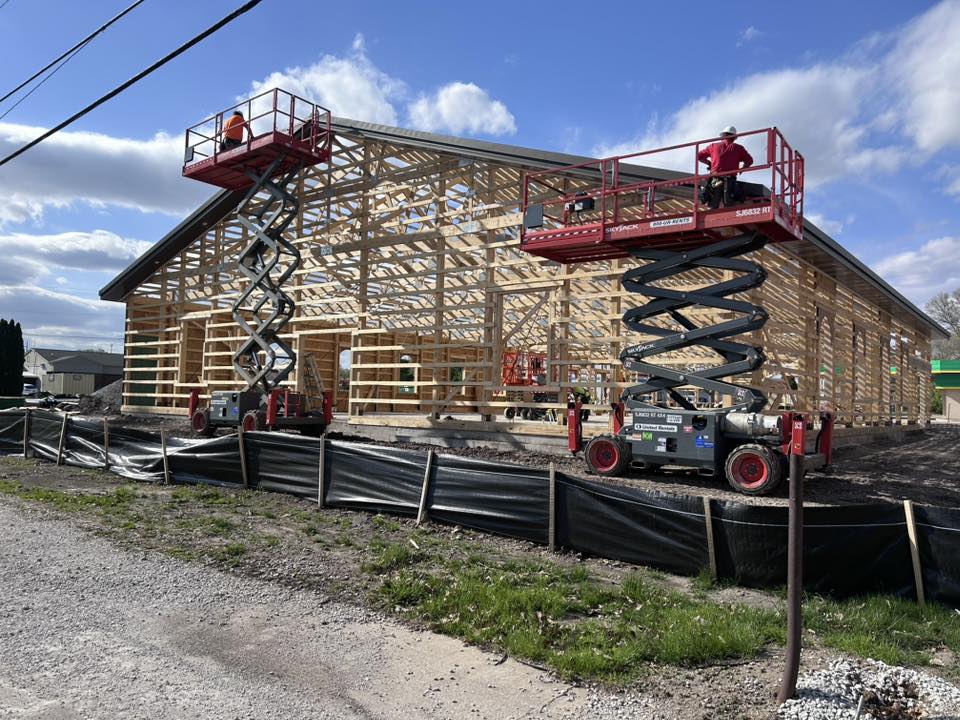

Sheathing the Exterior

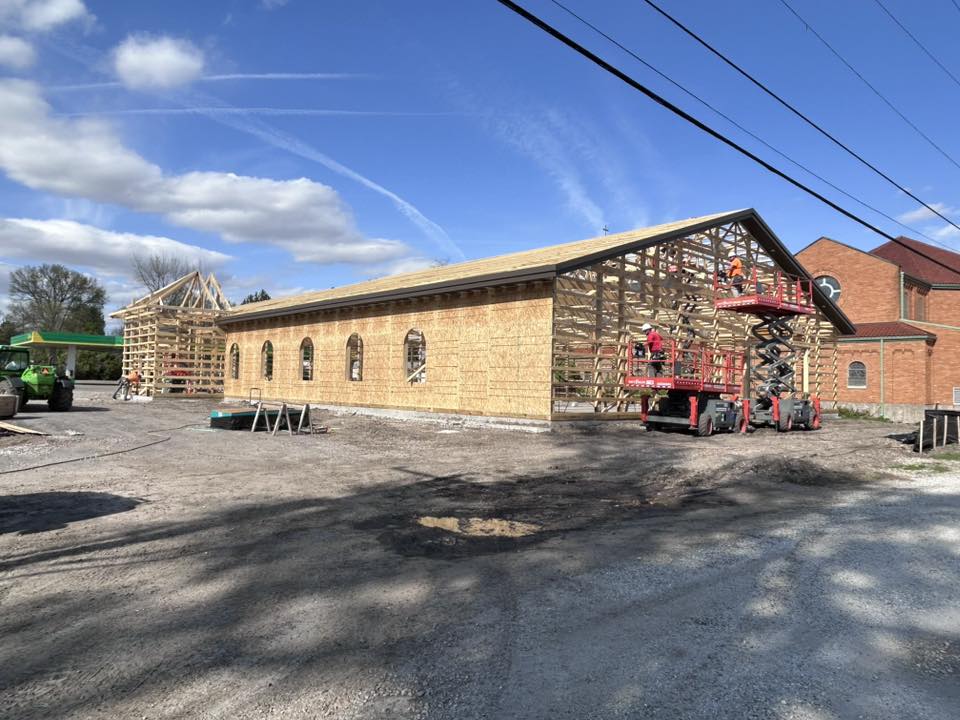

April 21, 2026

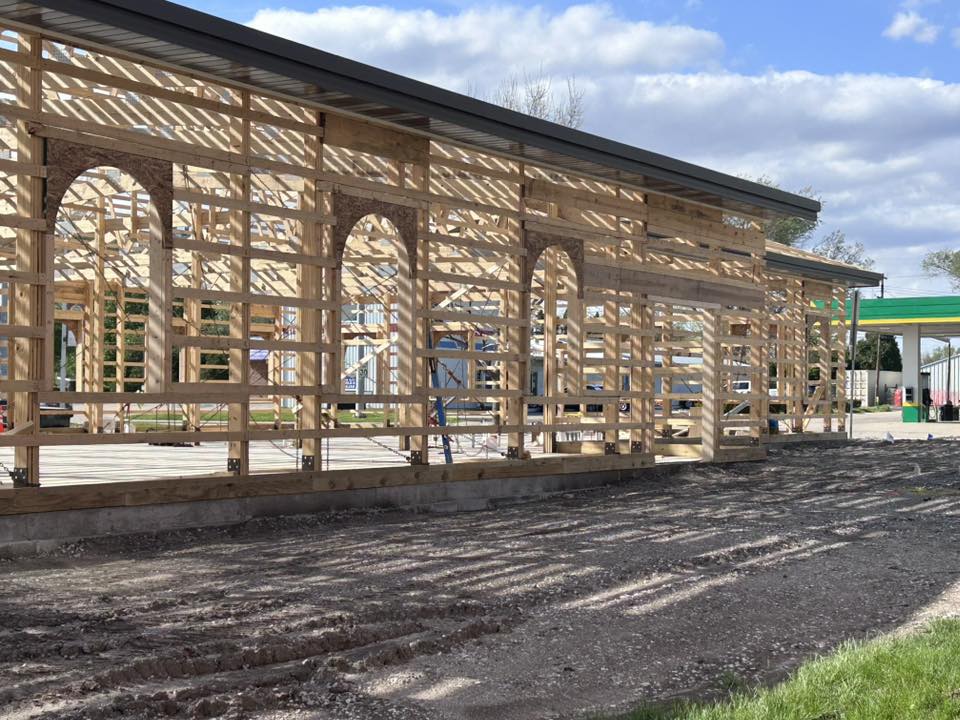

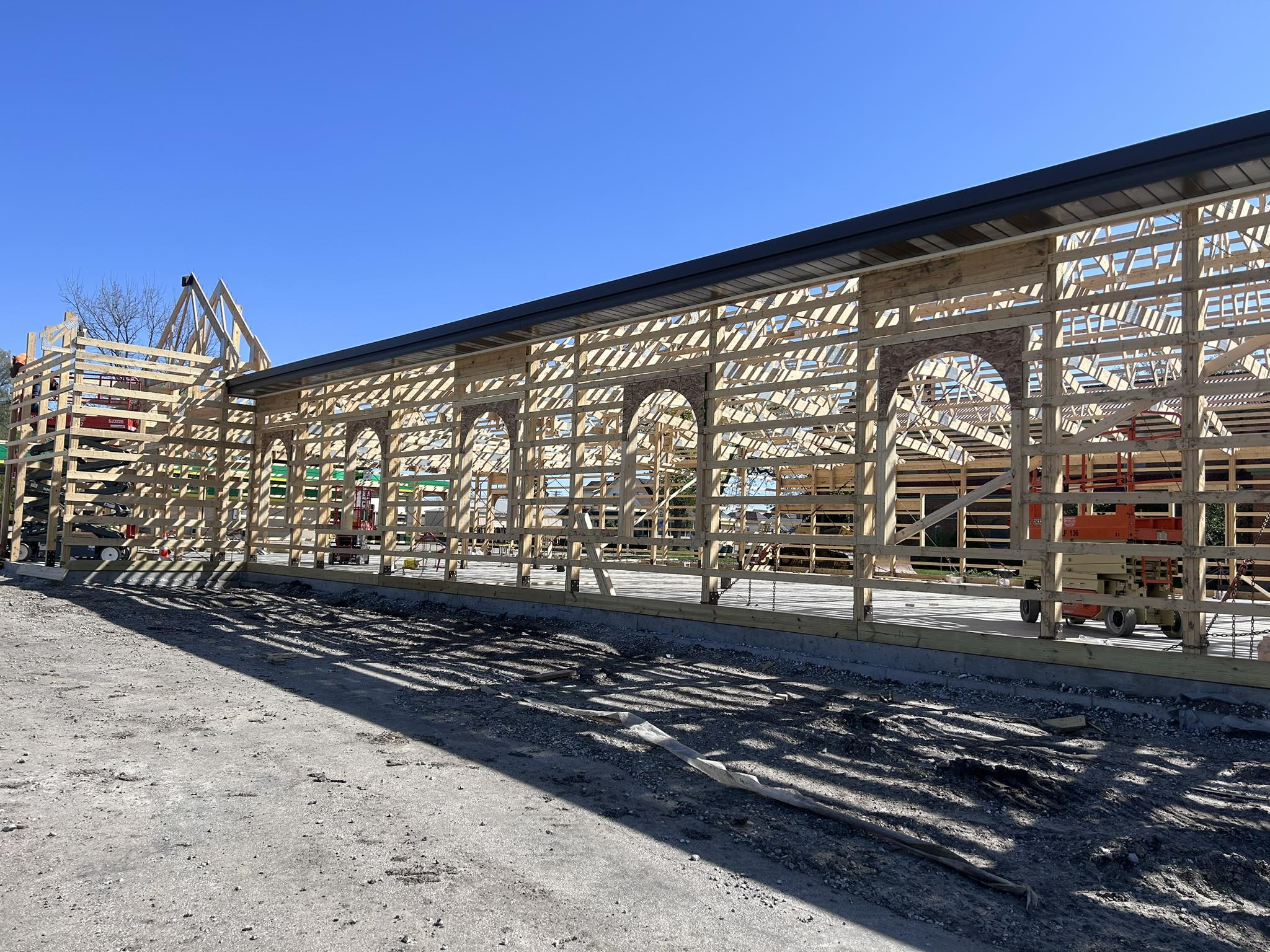

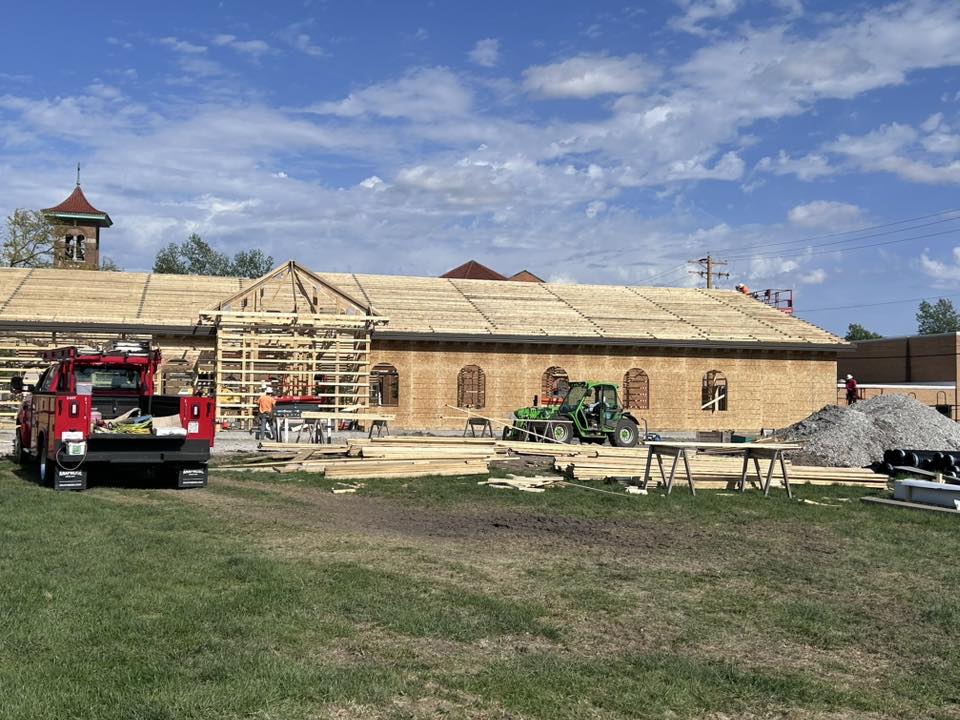

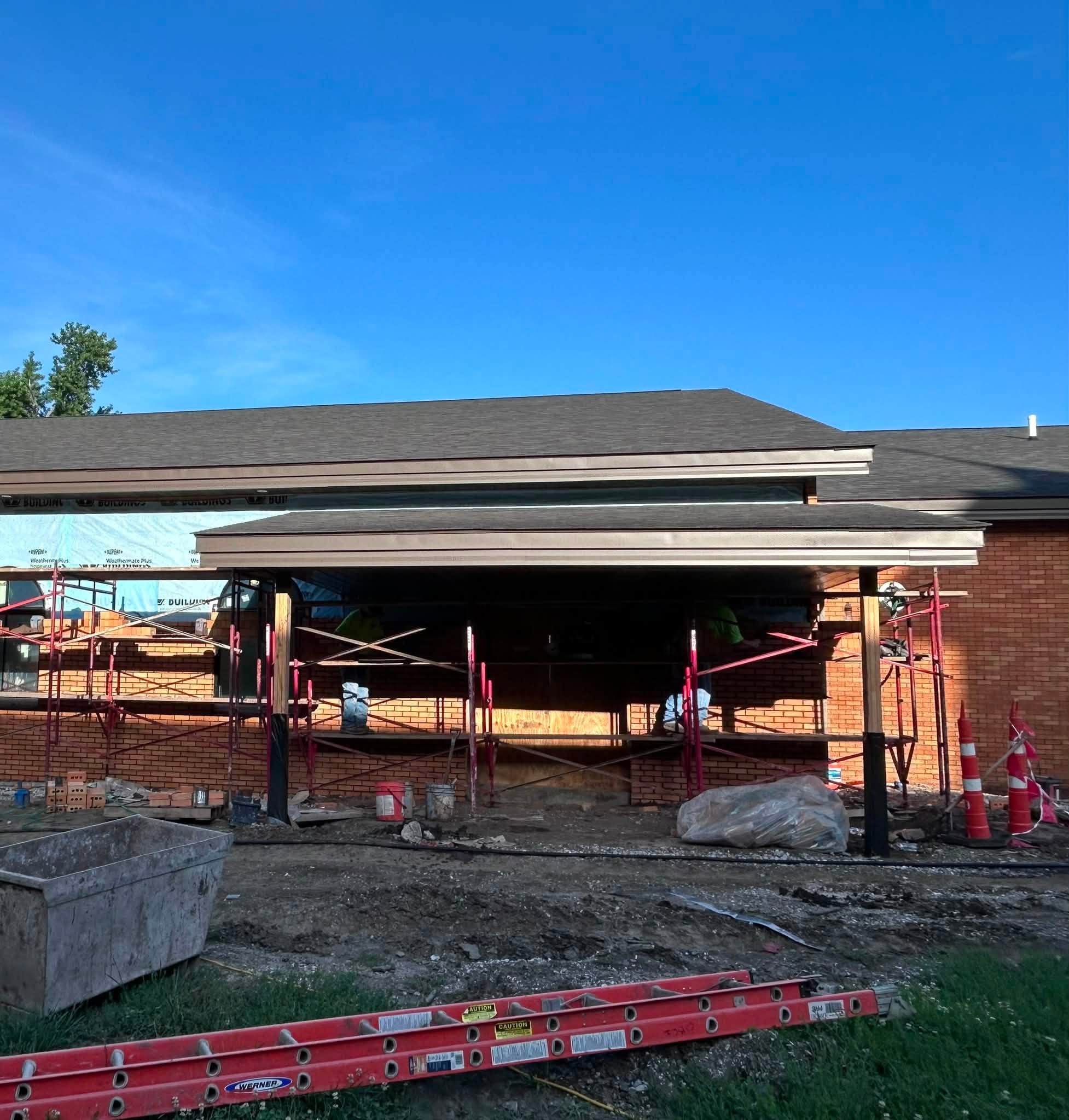

Lots of activity this afternoon! The north side lower soffit was installed along Jackson St. exterior light installation began on the south and west soffits. All of the arch windows framing was done. They started sheathing the exterior. All of the doors were cut out.

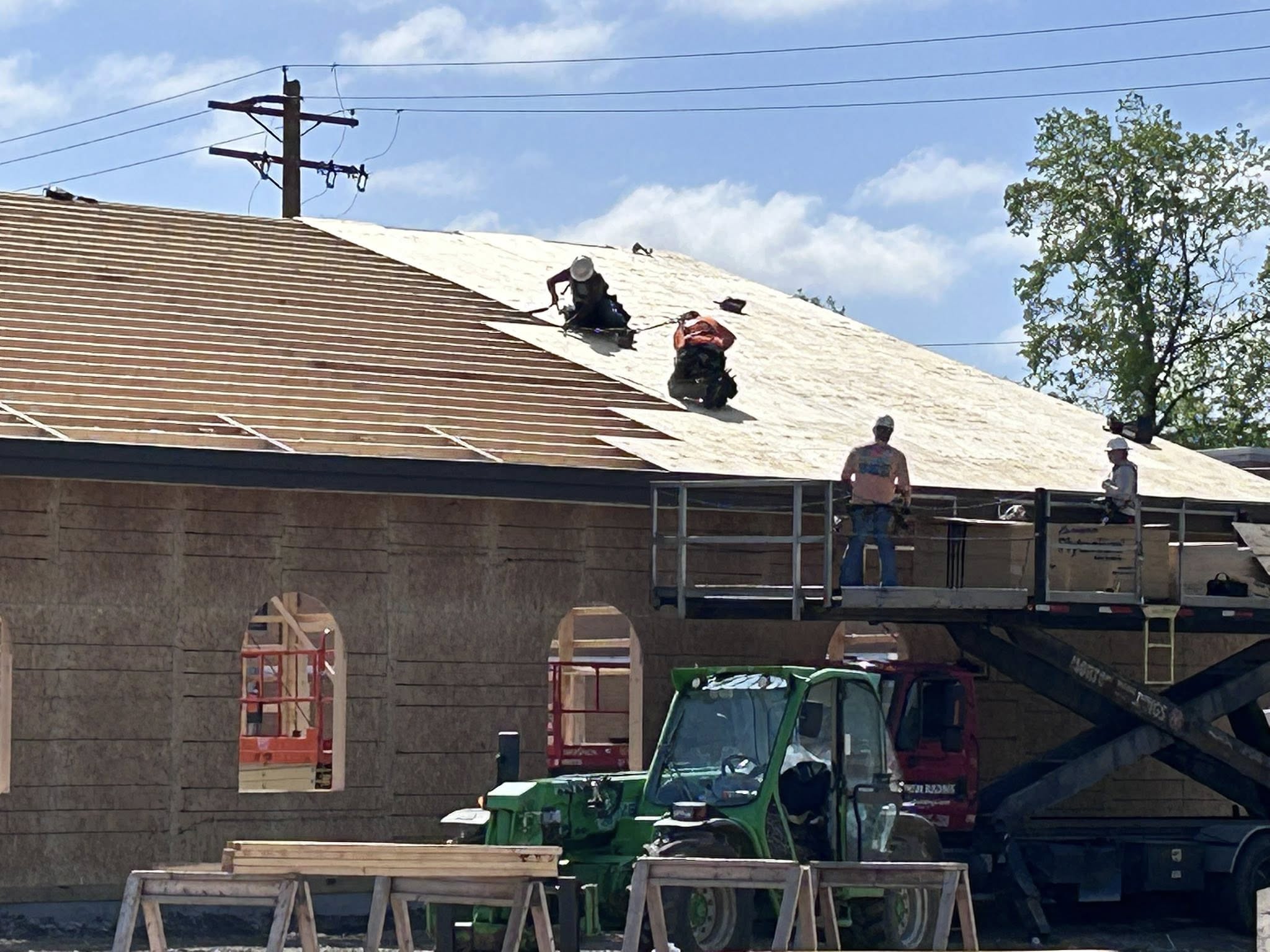

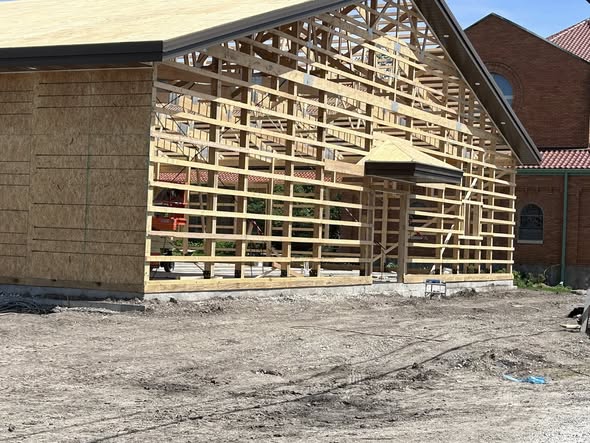

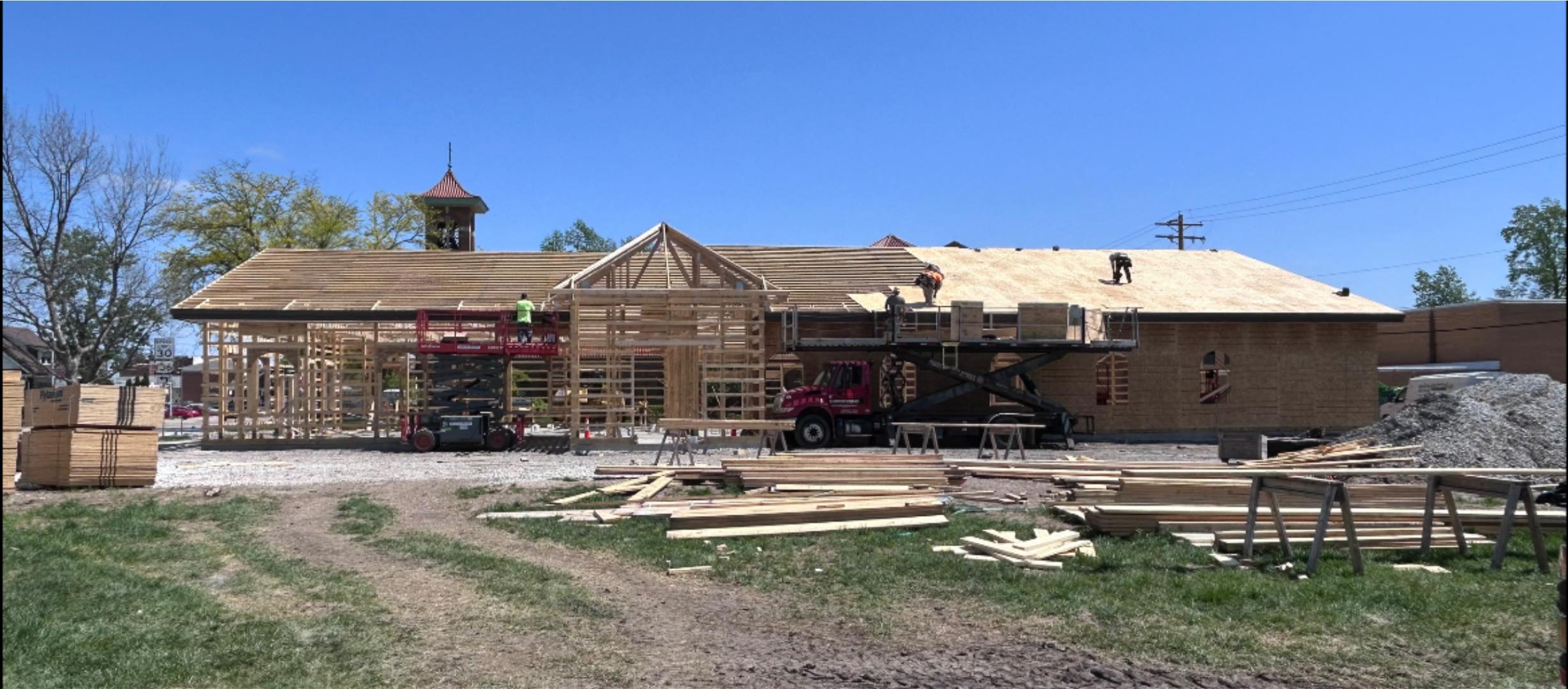

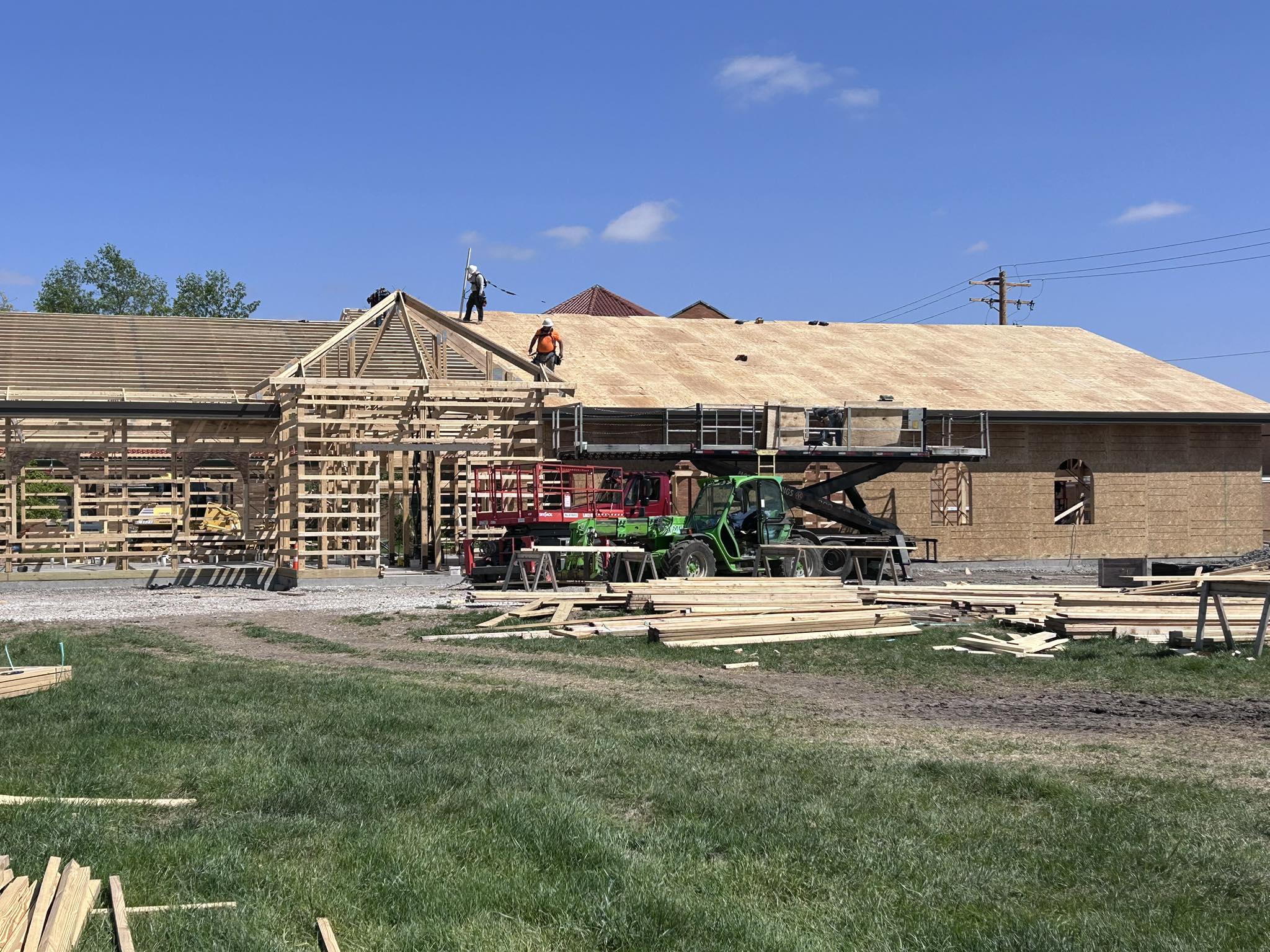

Roof Work Begins

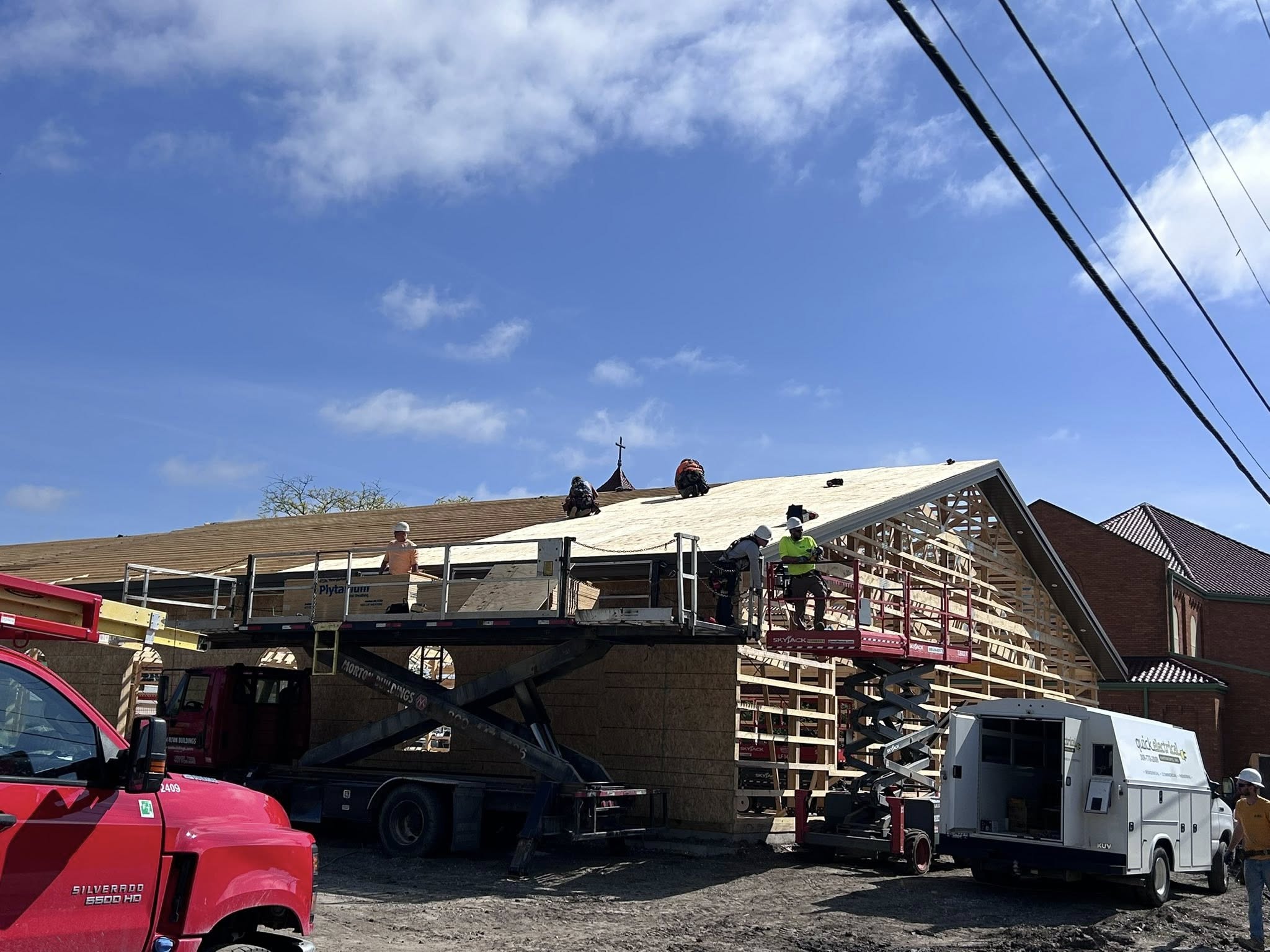

April 22, 2026

Roof work this morning!

Roof Work Continues

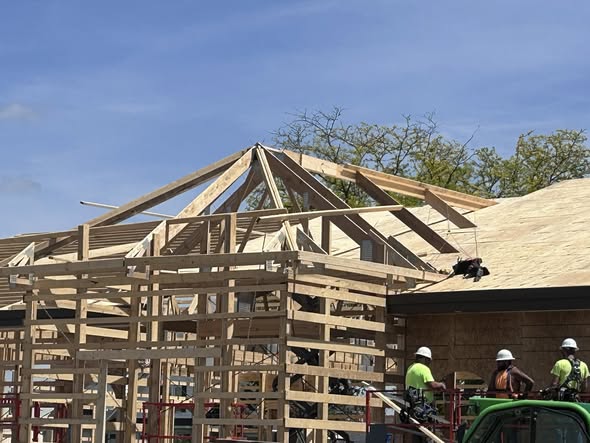

April 23, 2026

Today’s noon time update.

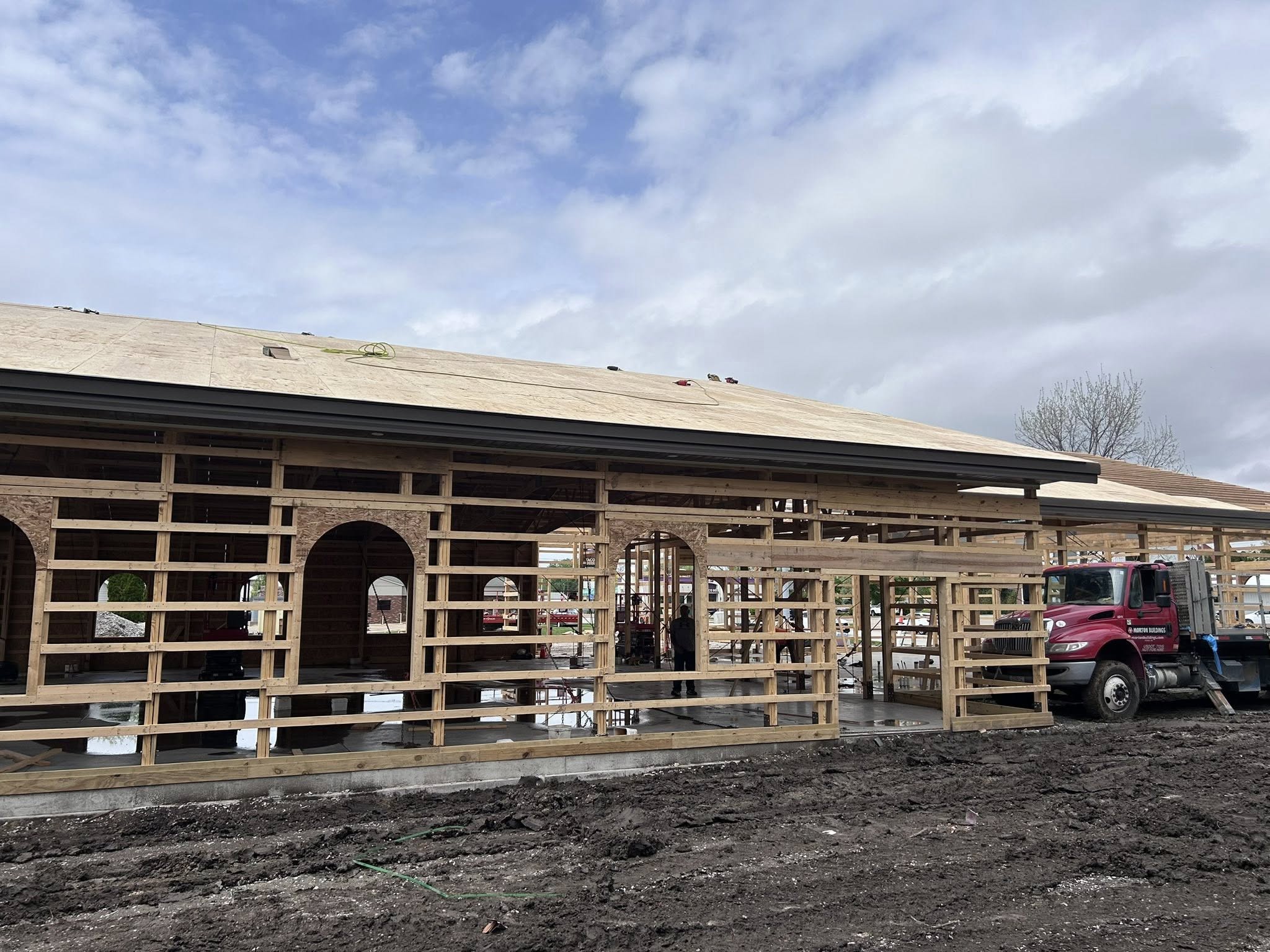

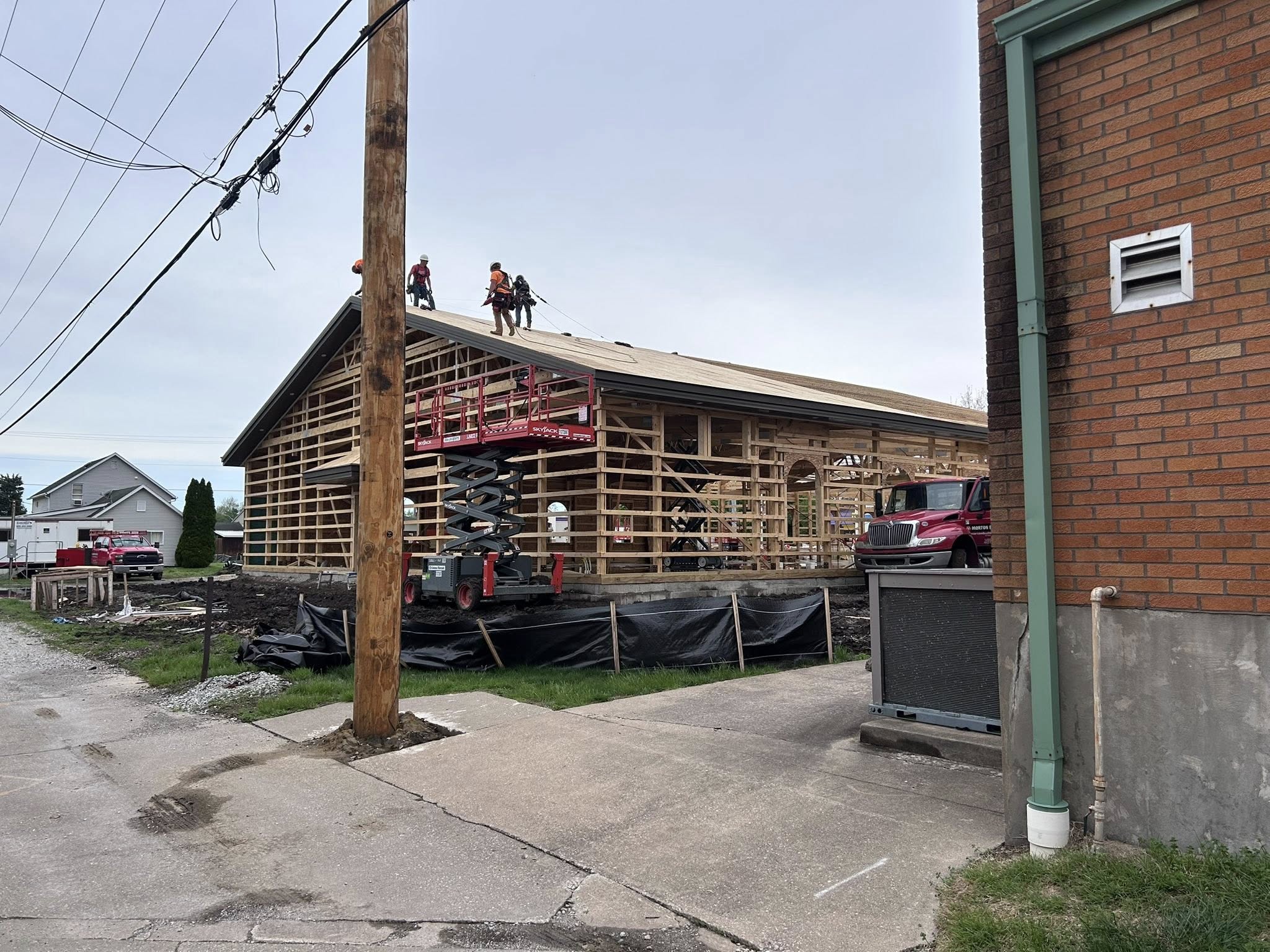

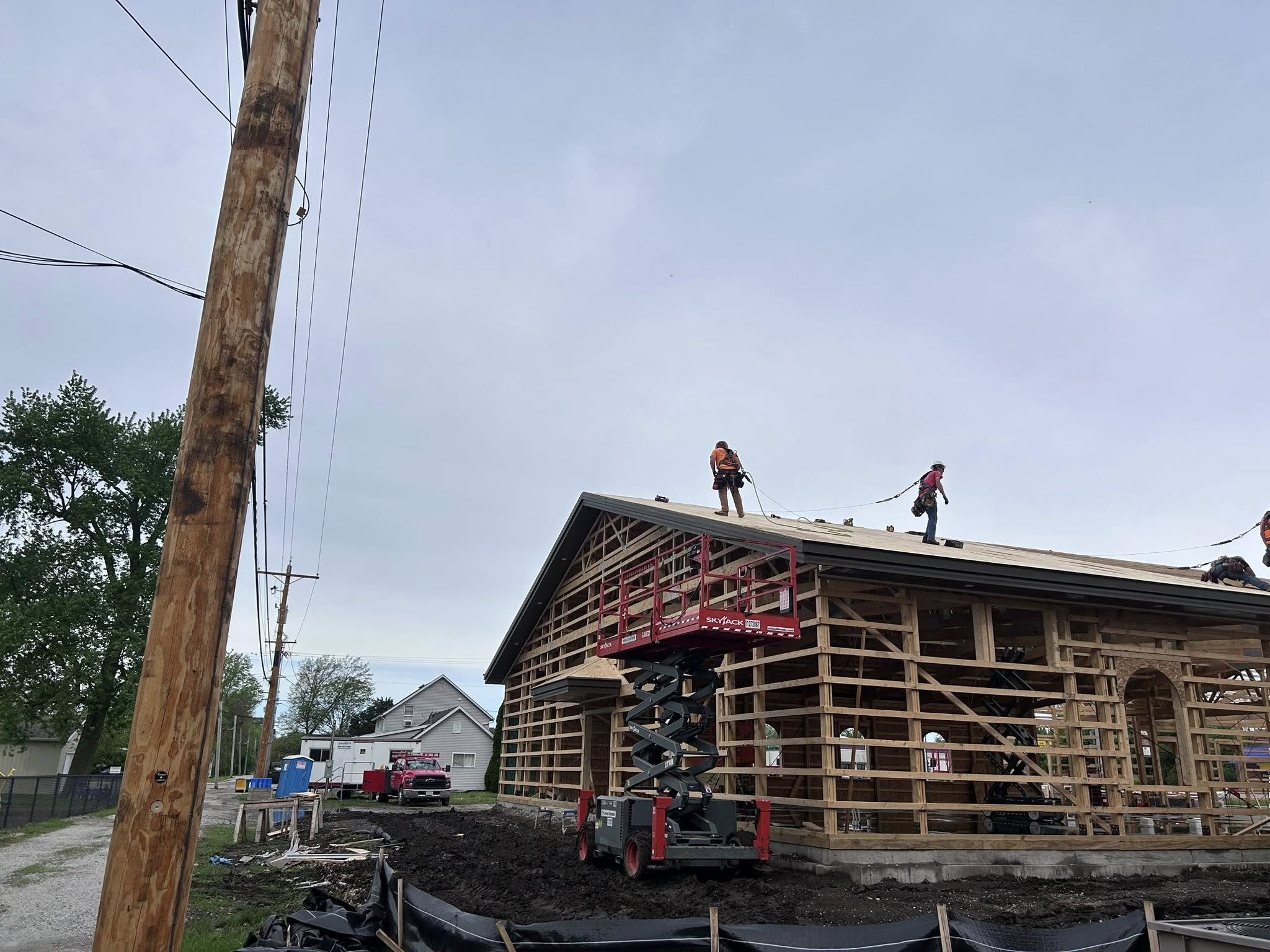

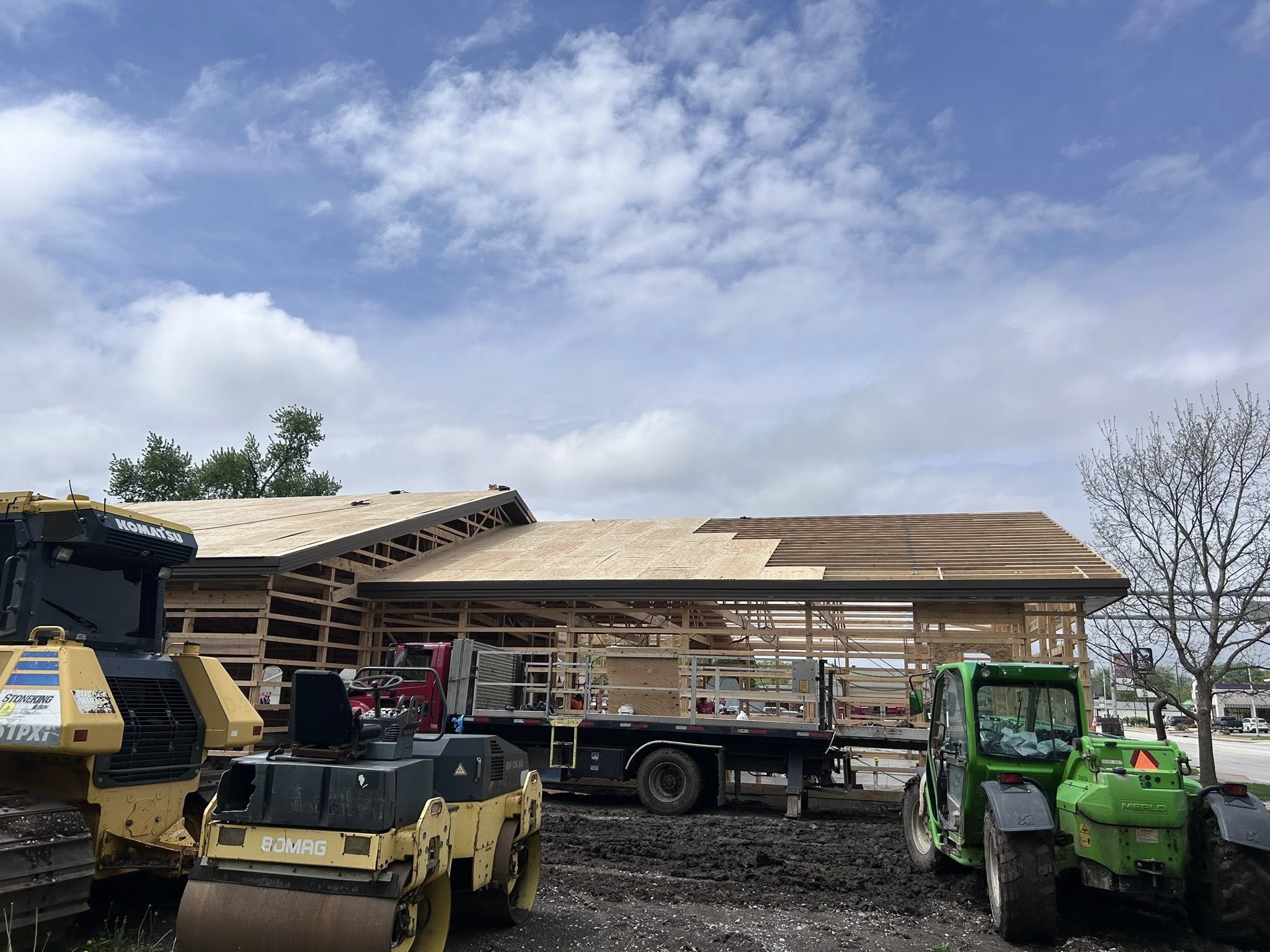

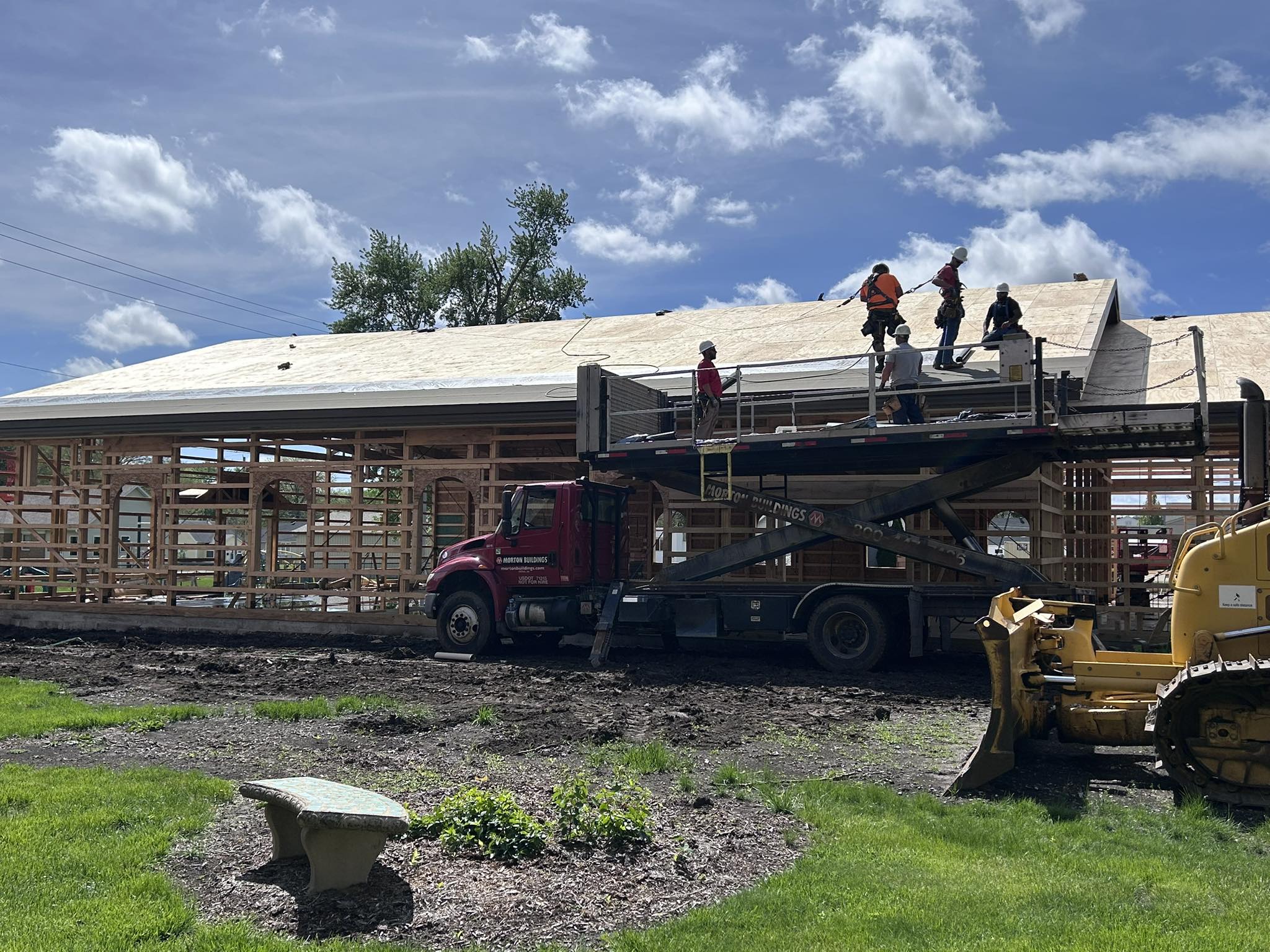

East Side Roof Work

April 24, 2026

This morning we work on the east half of the roof.

East Side Roof Work Continues

April 24, 2026

Noontime update with tar paper on the east side of the roof

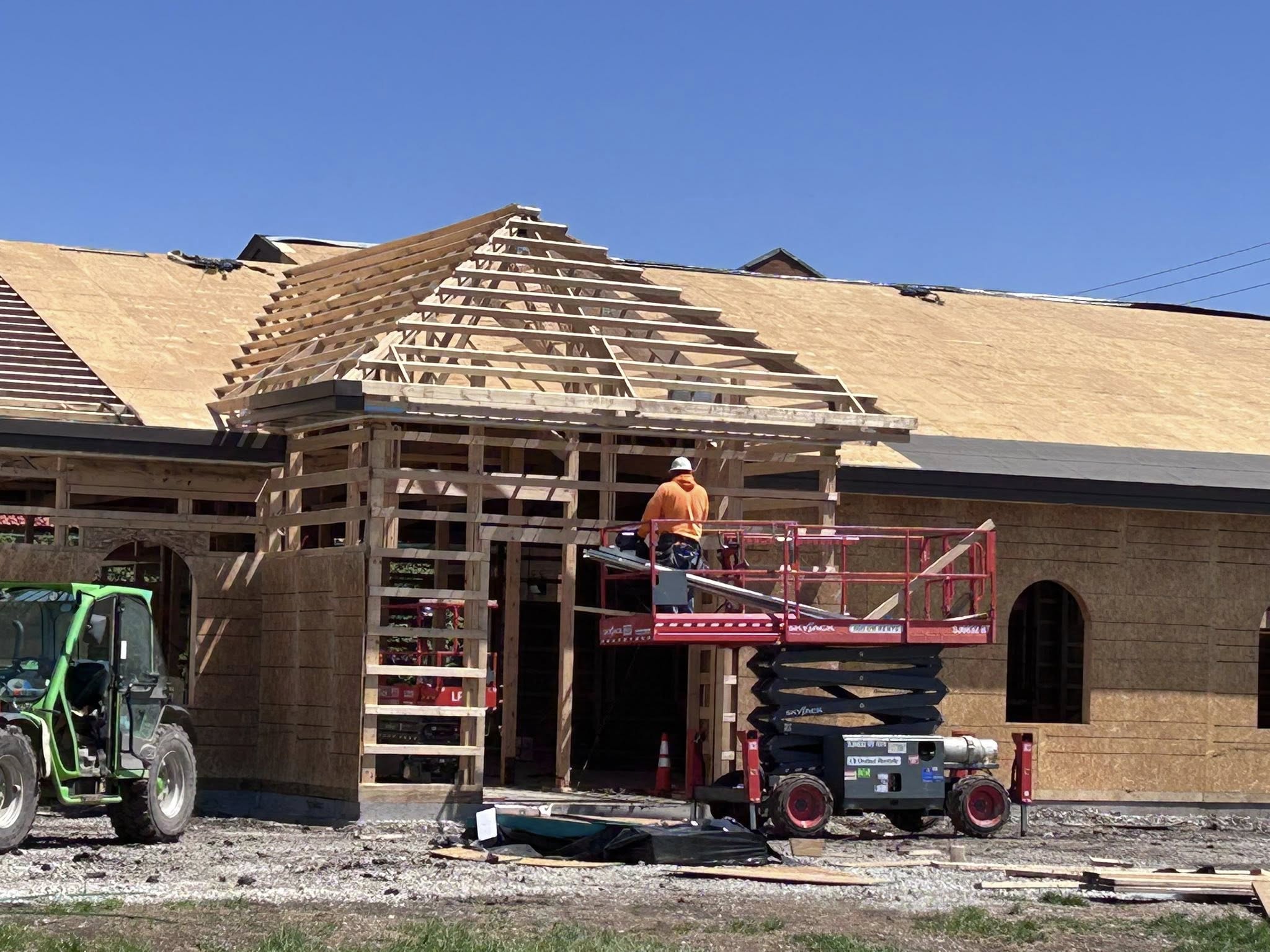

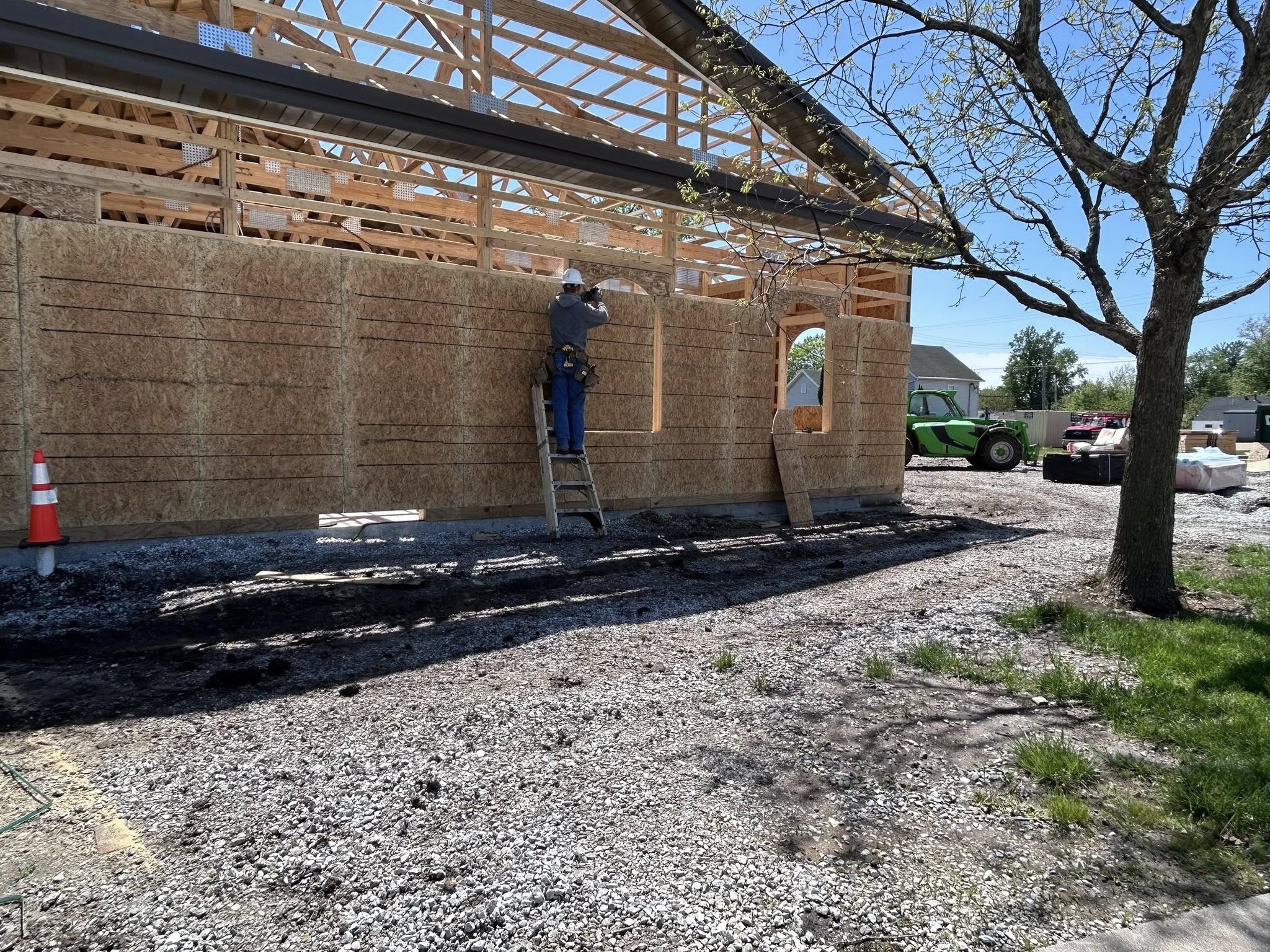

Progress Continues

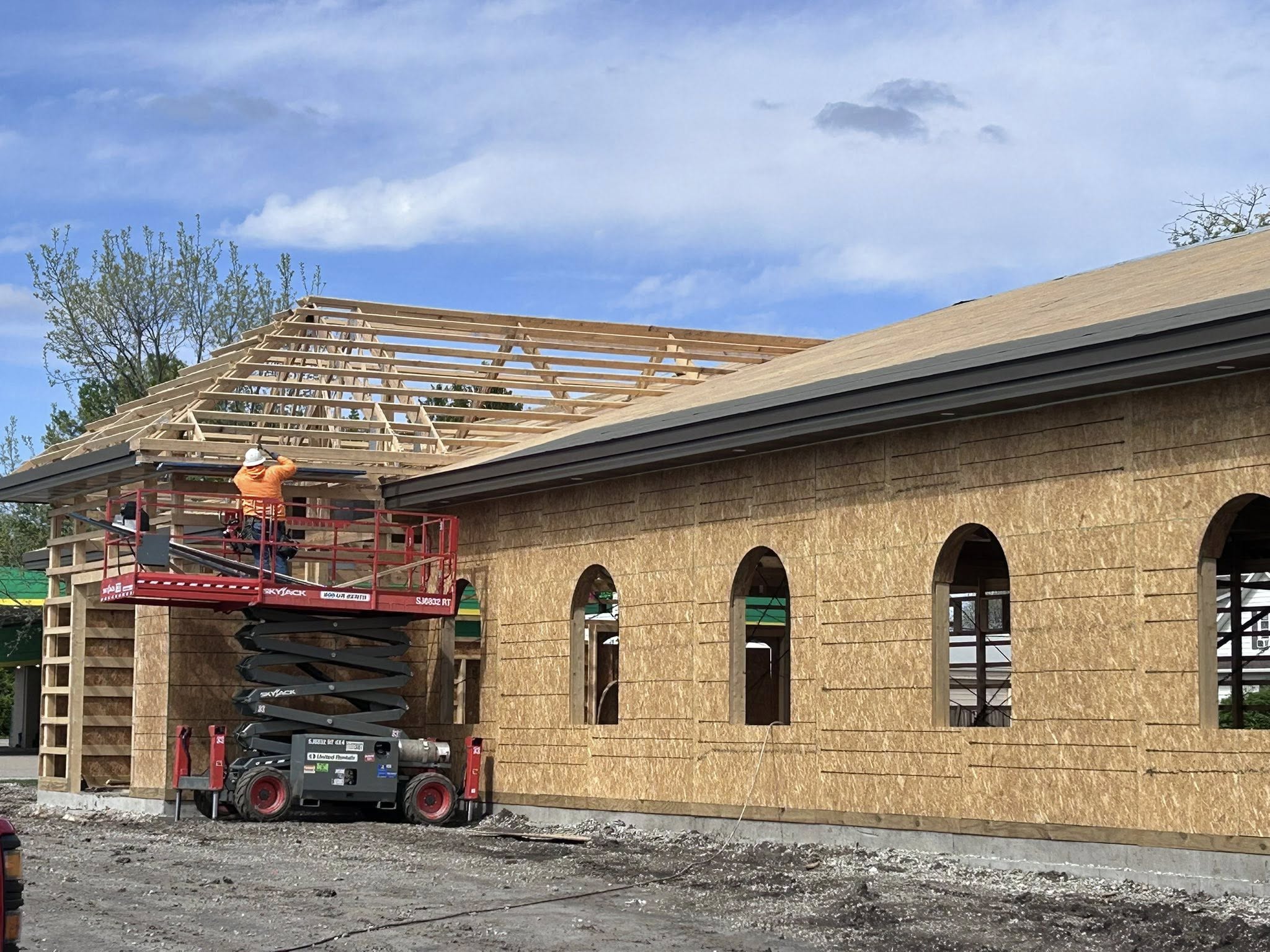

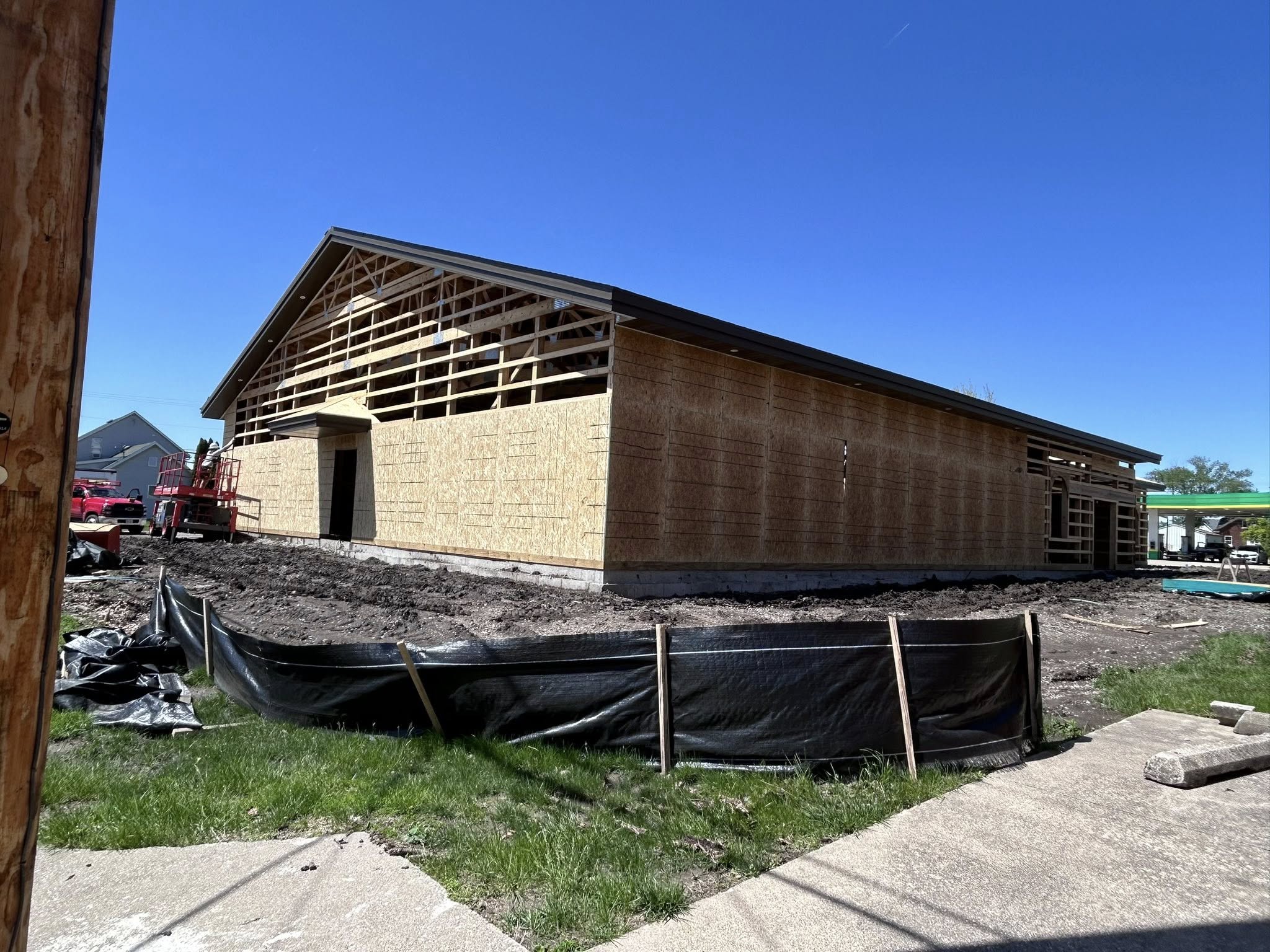

April 28, 2026

After taking time off for all of the rain yesterday, the crew is back at it today!

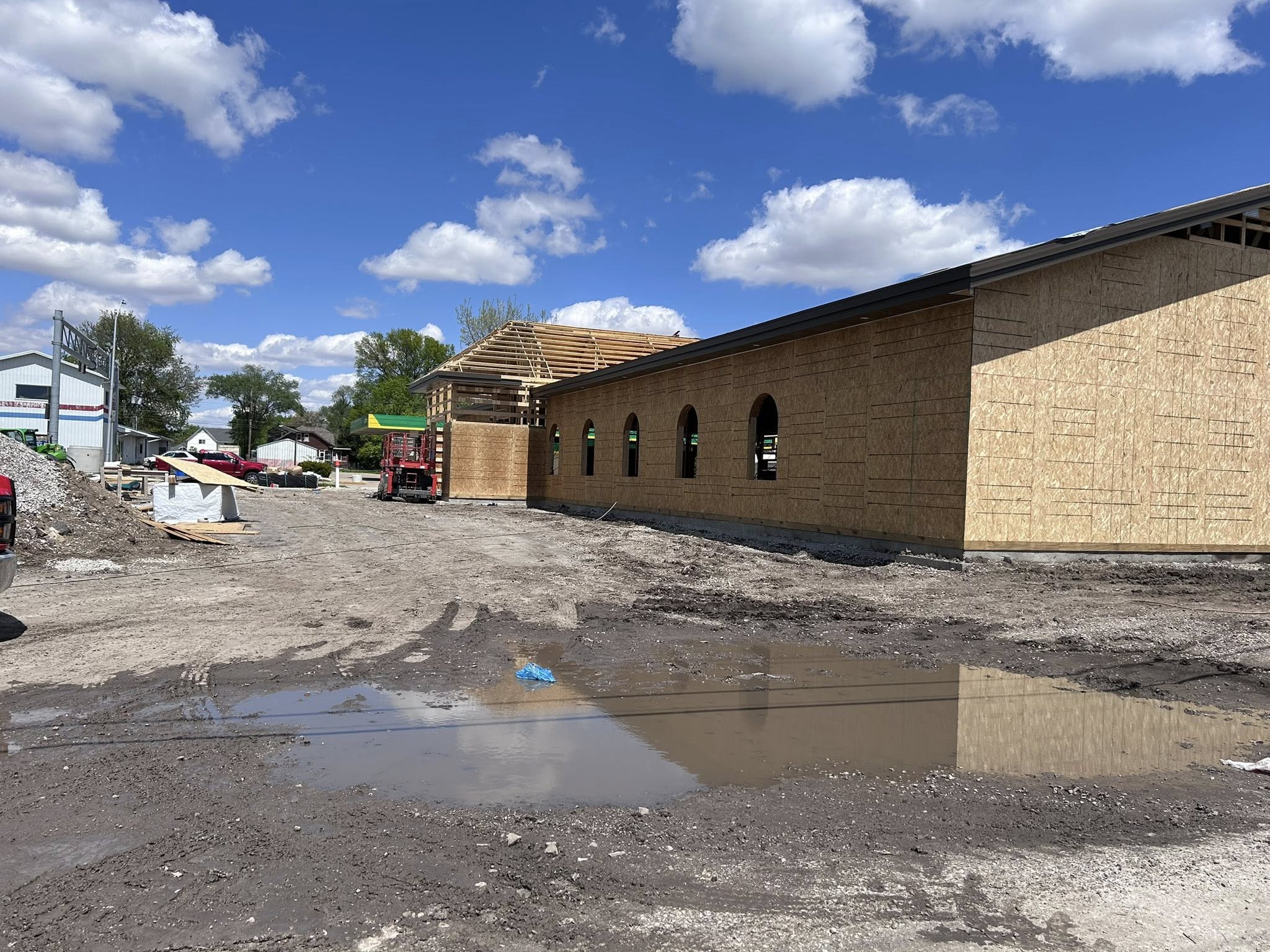

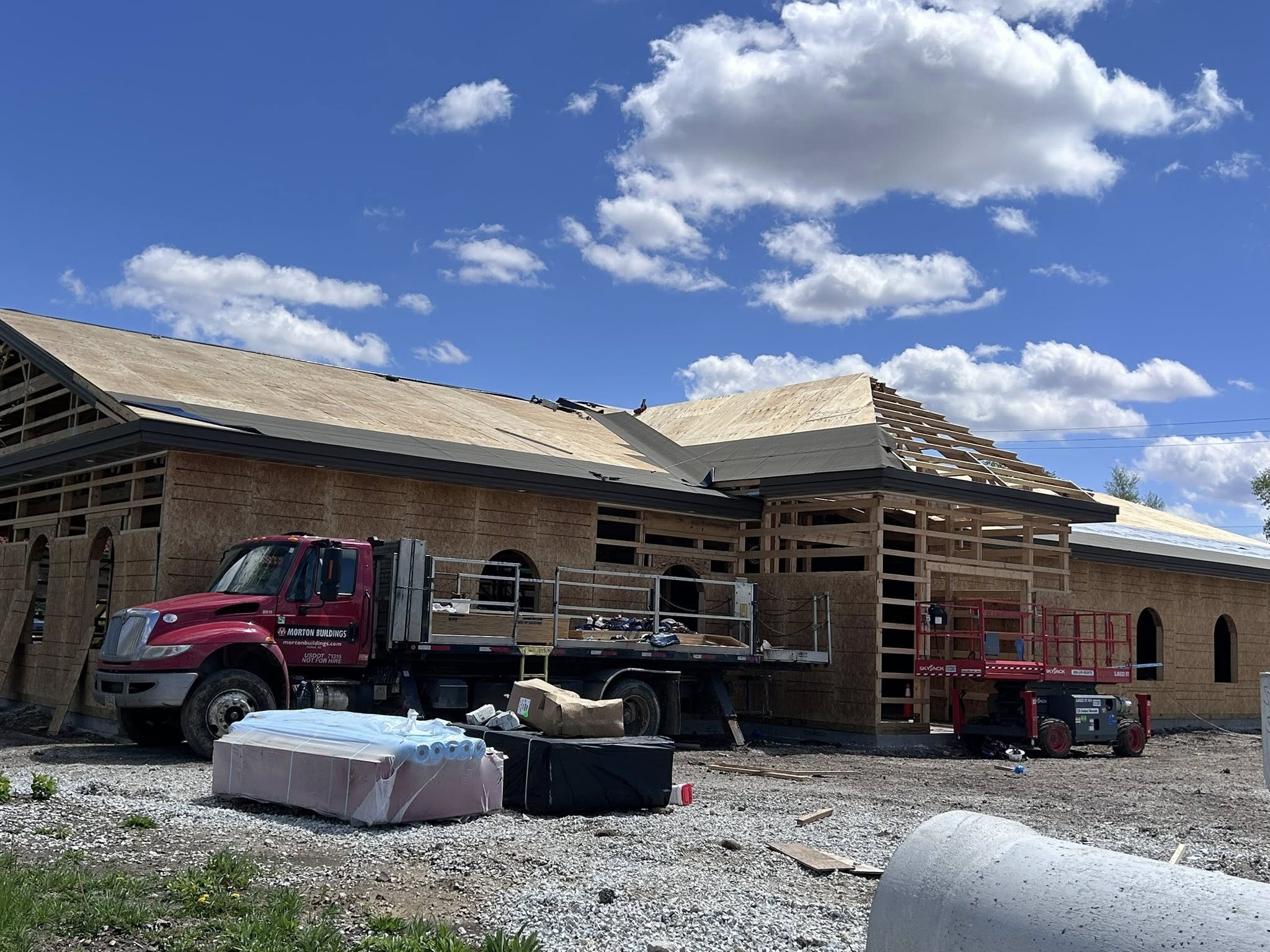

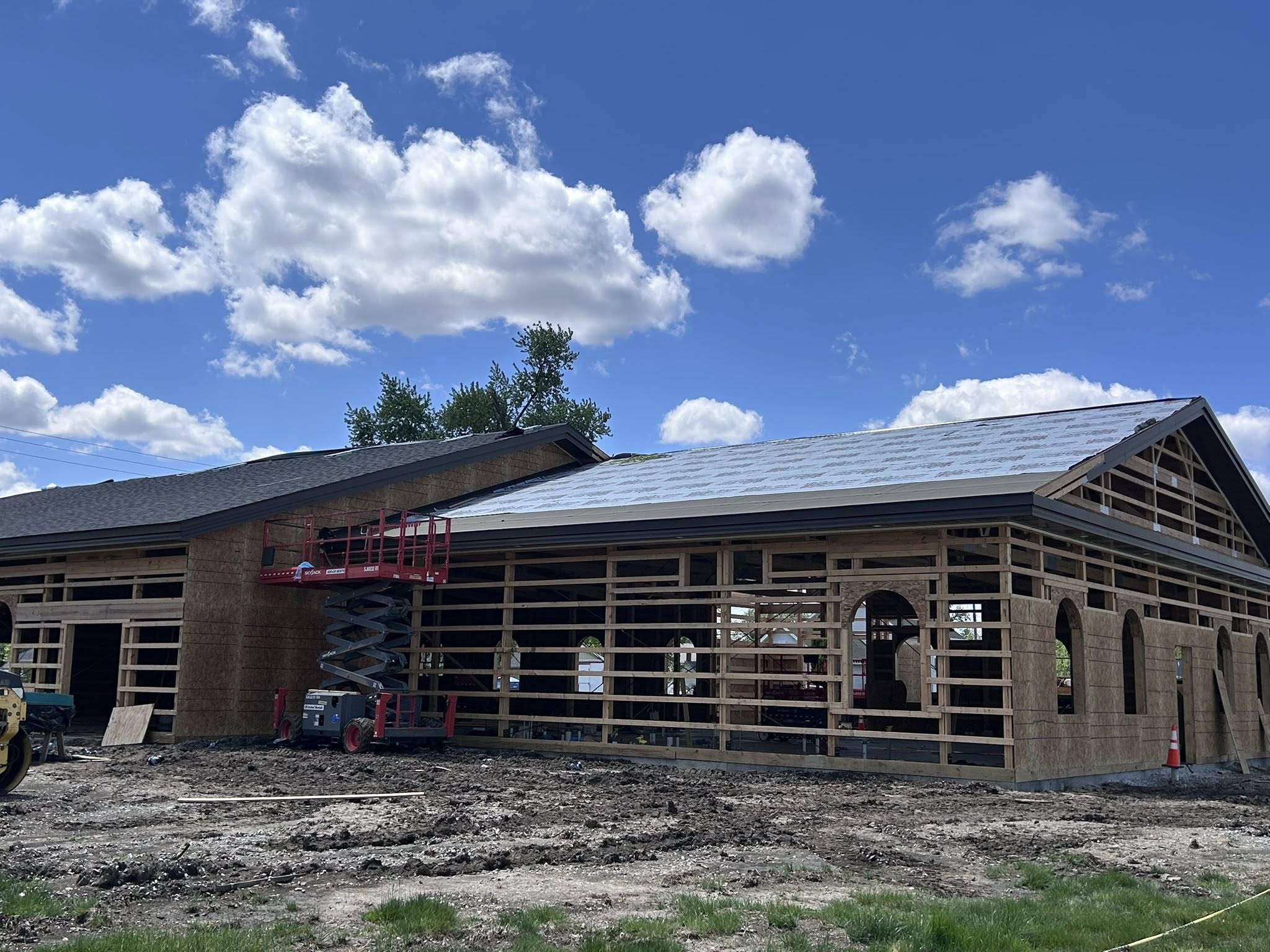

Sheathing Continues

April 29, 2026

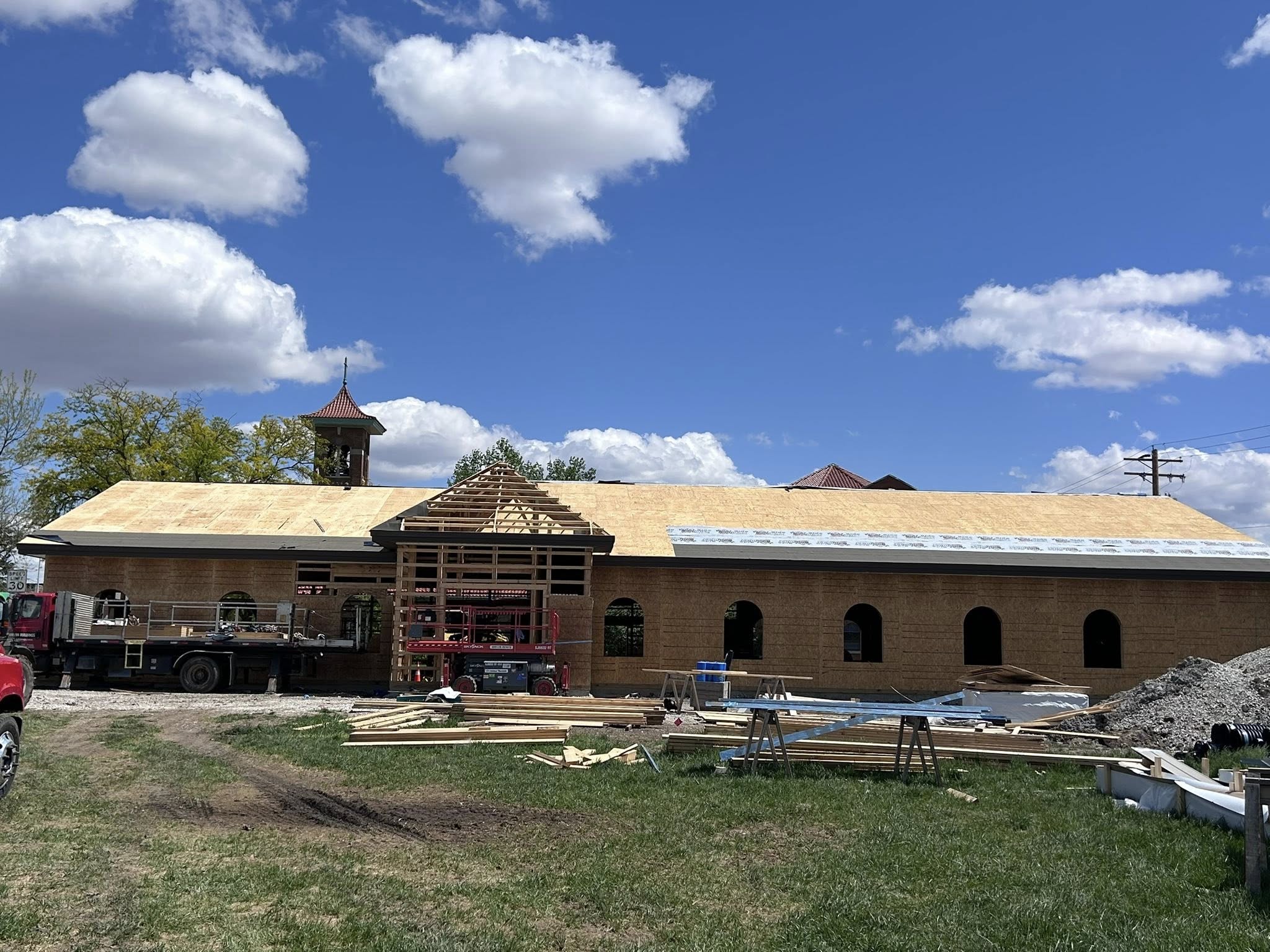

Outside sheathing is almost complete. Tar paper is done on the east side and they have begun the west side.

Finishing the Sheathing

April 30, 2026

Work continues today to finish the sheathing of the exterior walls. Tar paper is up and done.

House wrap is almost done

May 1, 2026

Yesterday, the crew started putting up the house wrap. Today, hopefully they will be able to finish that project. Also working on the east side entrance/exit to the St. Francis garden.

Stay tuned!

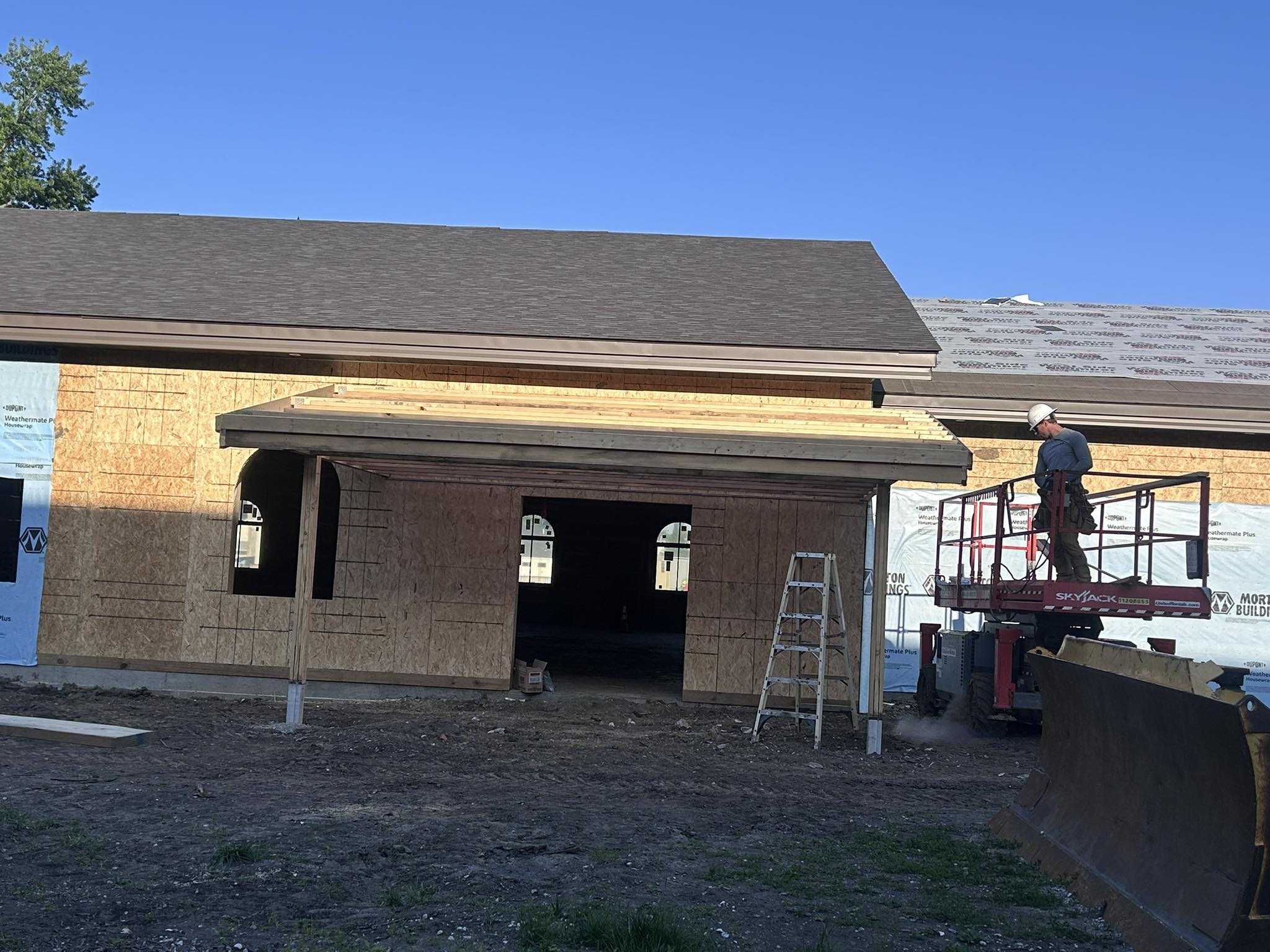

East Entrance work

May 1, 2026

Working on the east entrance/exit to the St. Francis Garden.

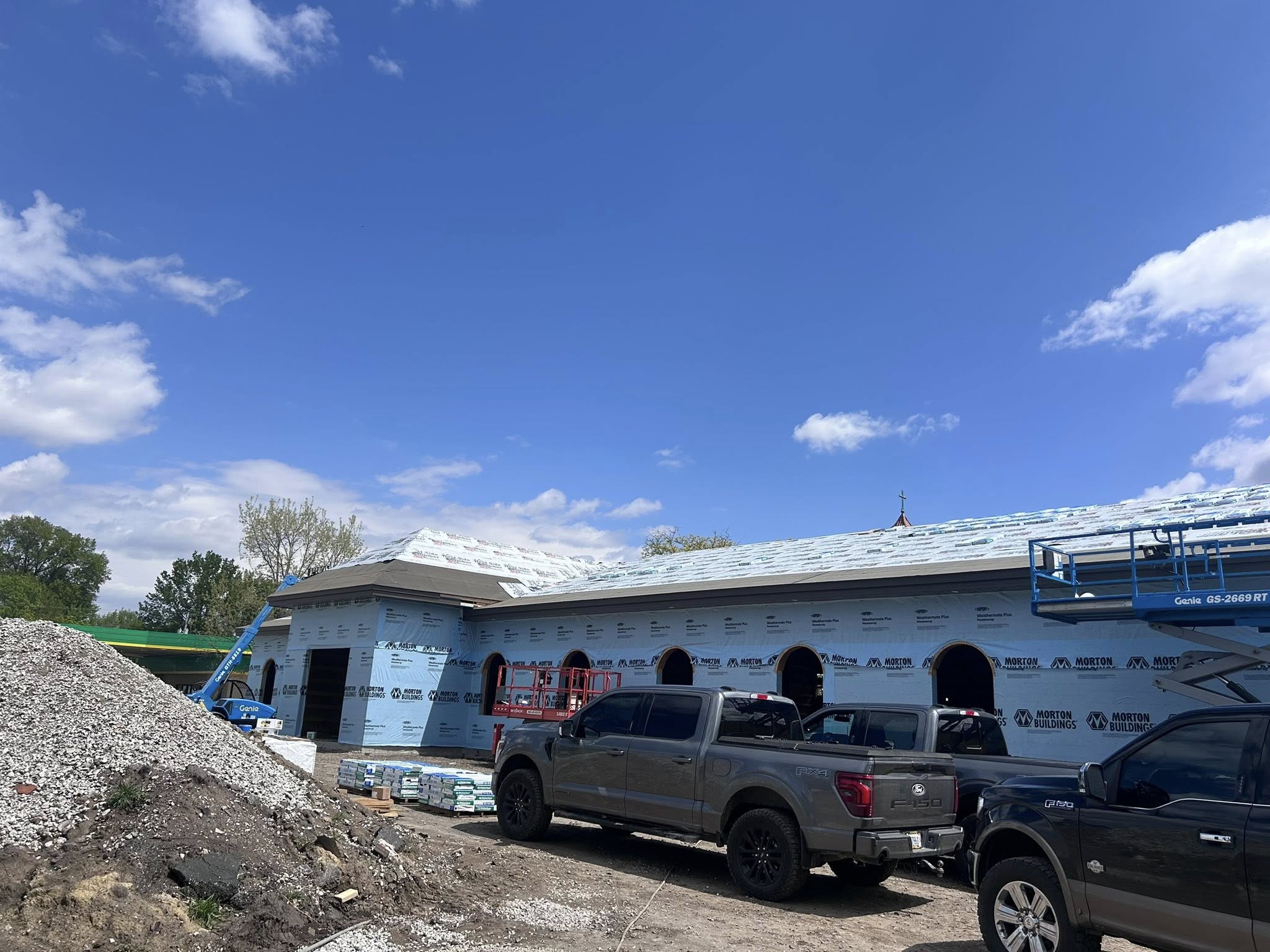

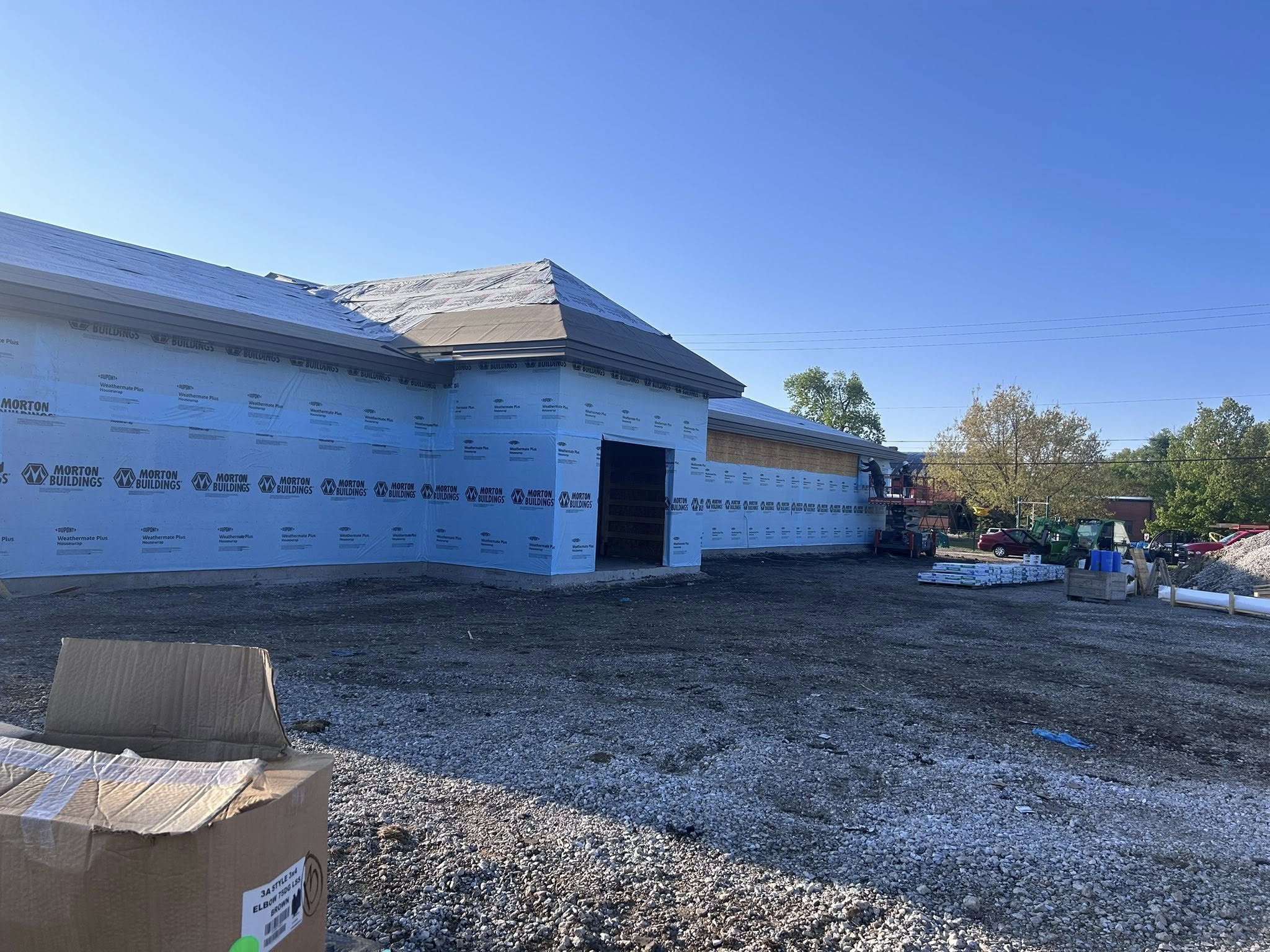

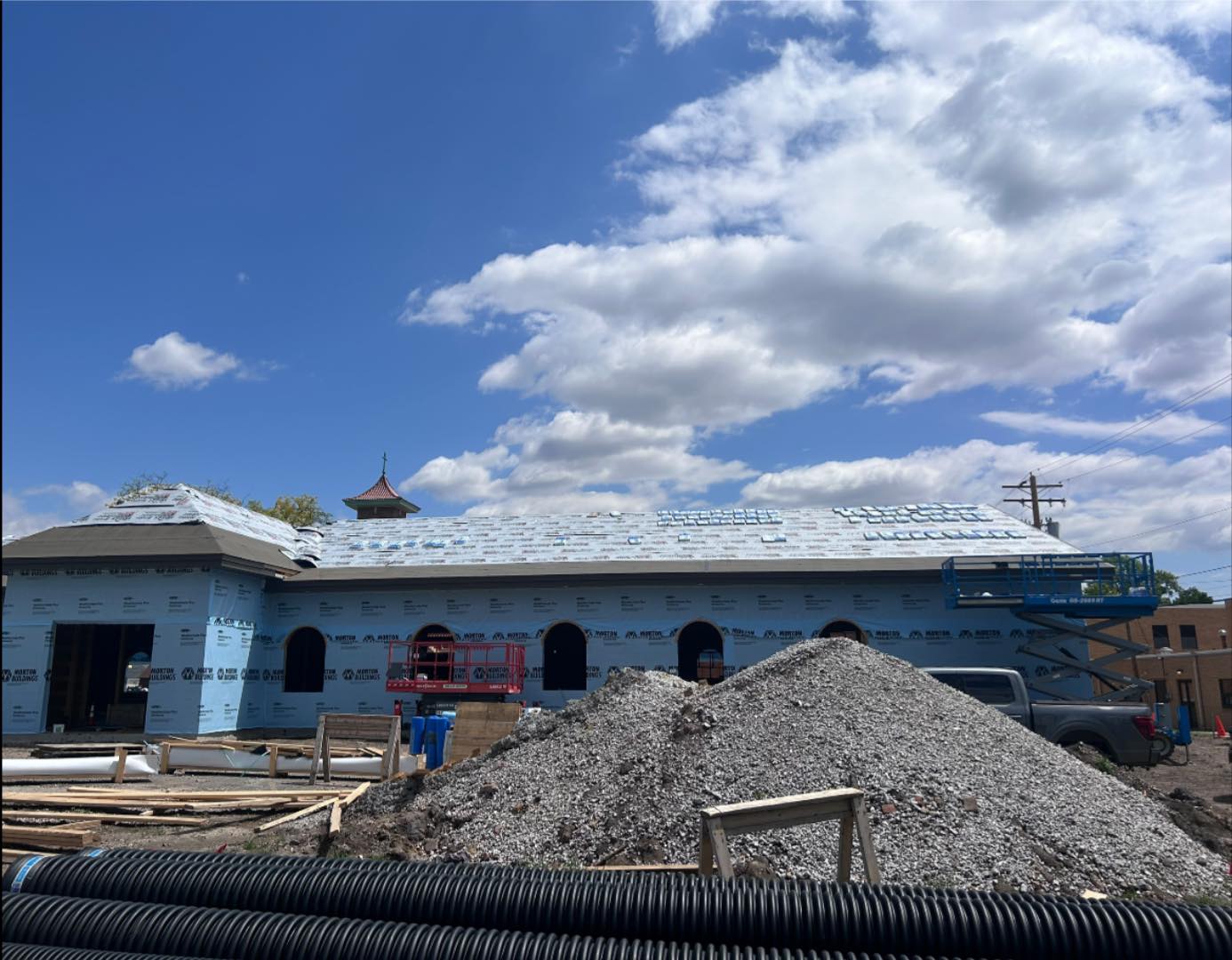

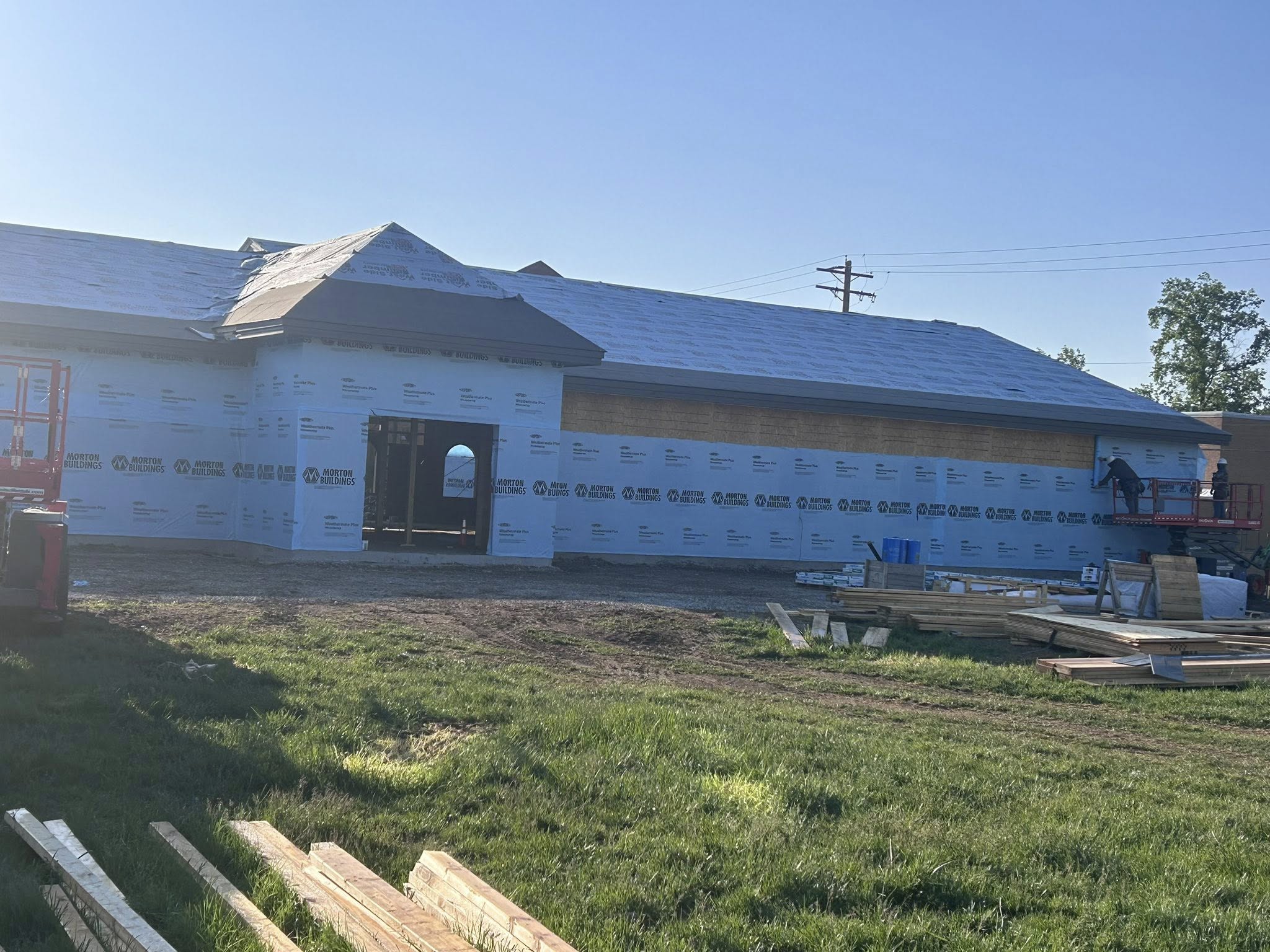

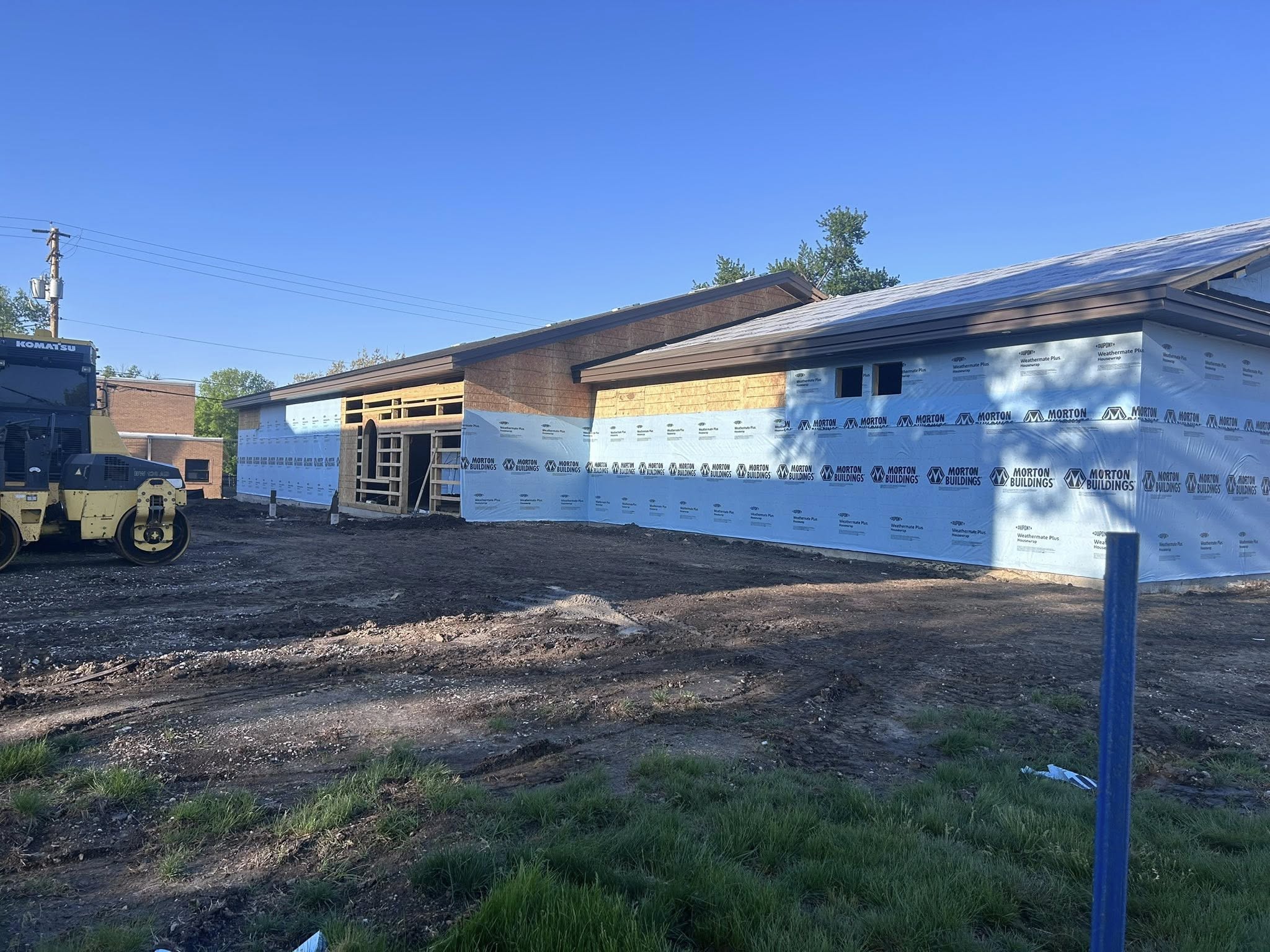

House wrap is done

May 1, 2026

The house wrap is finished and a peak on the inside.

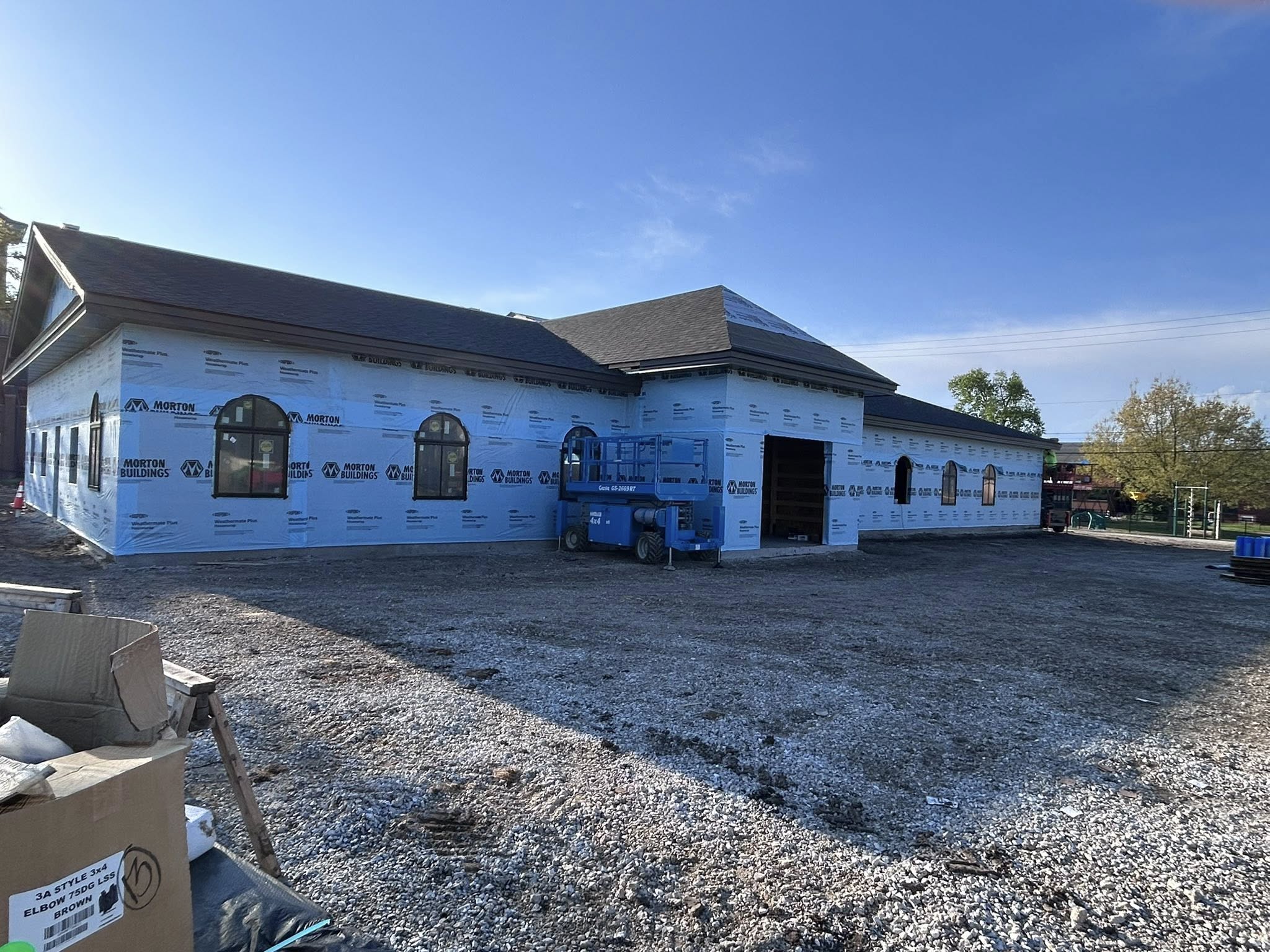

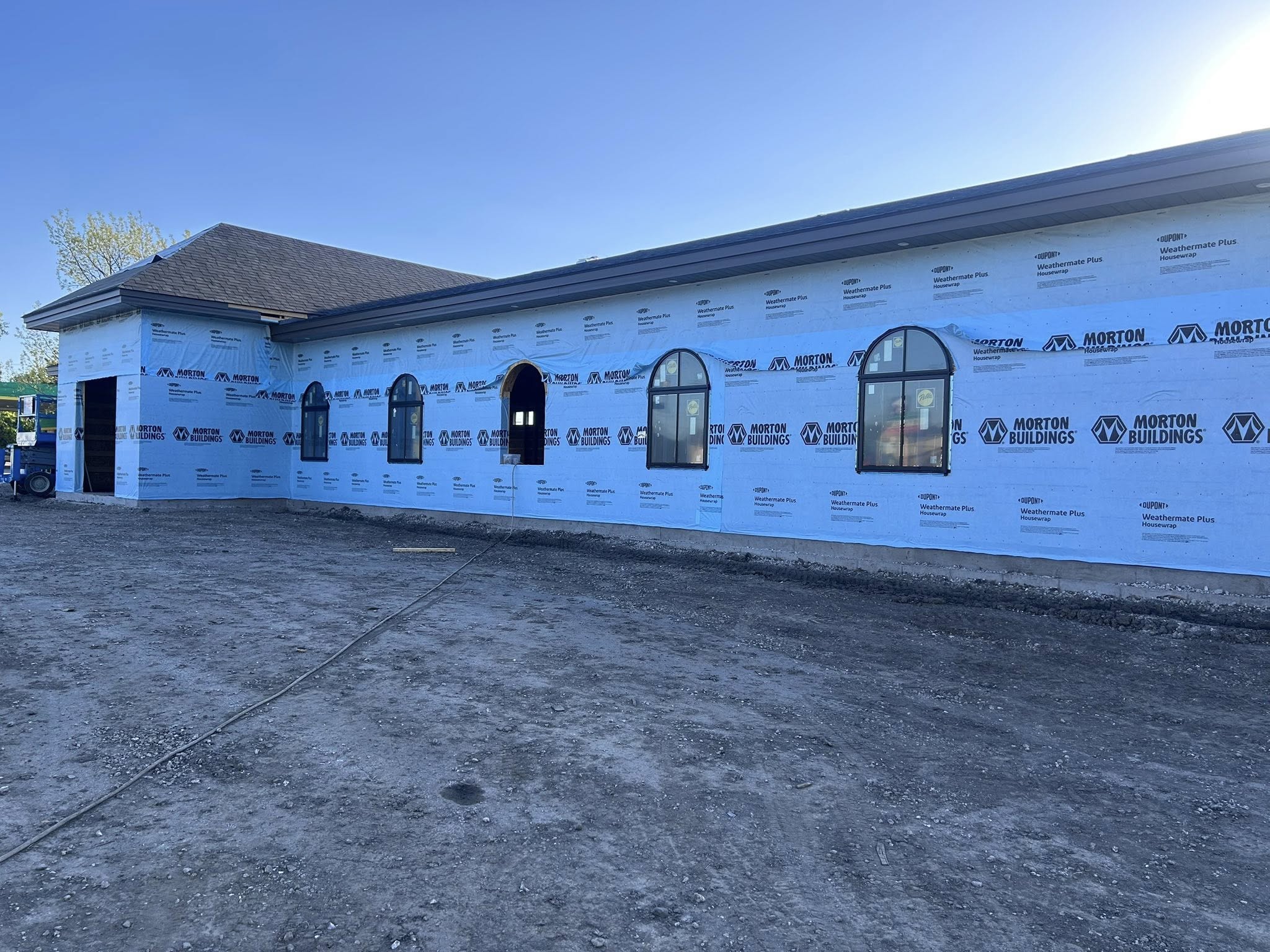

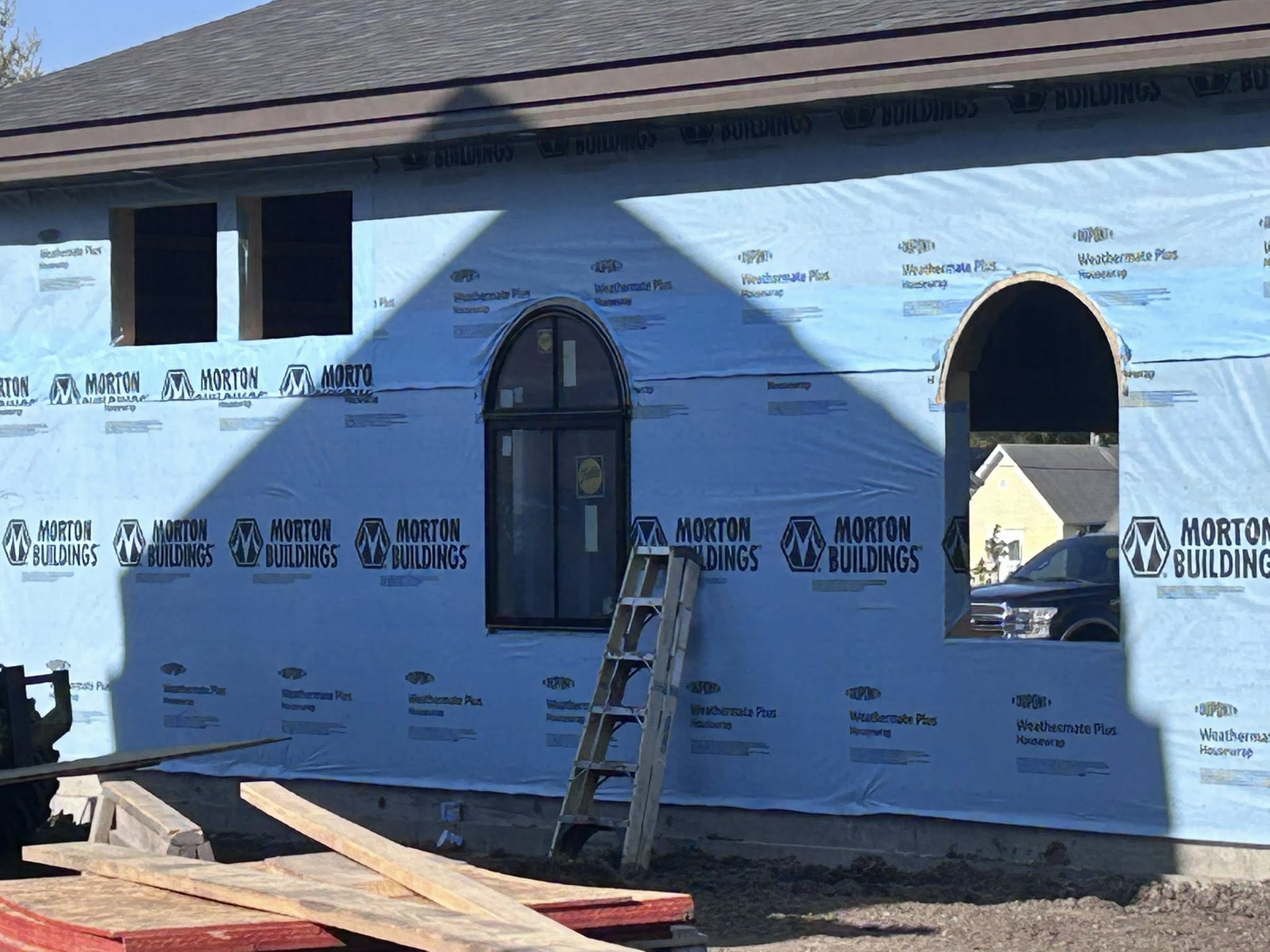

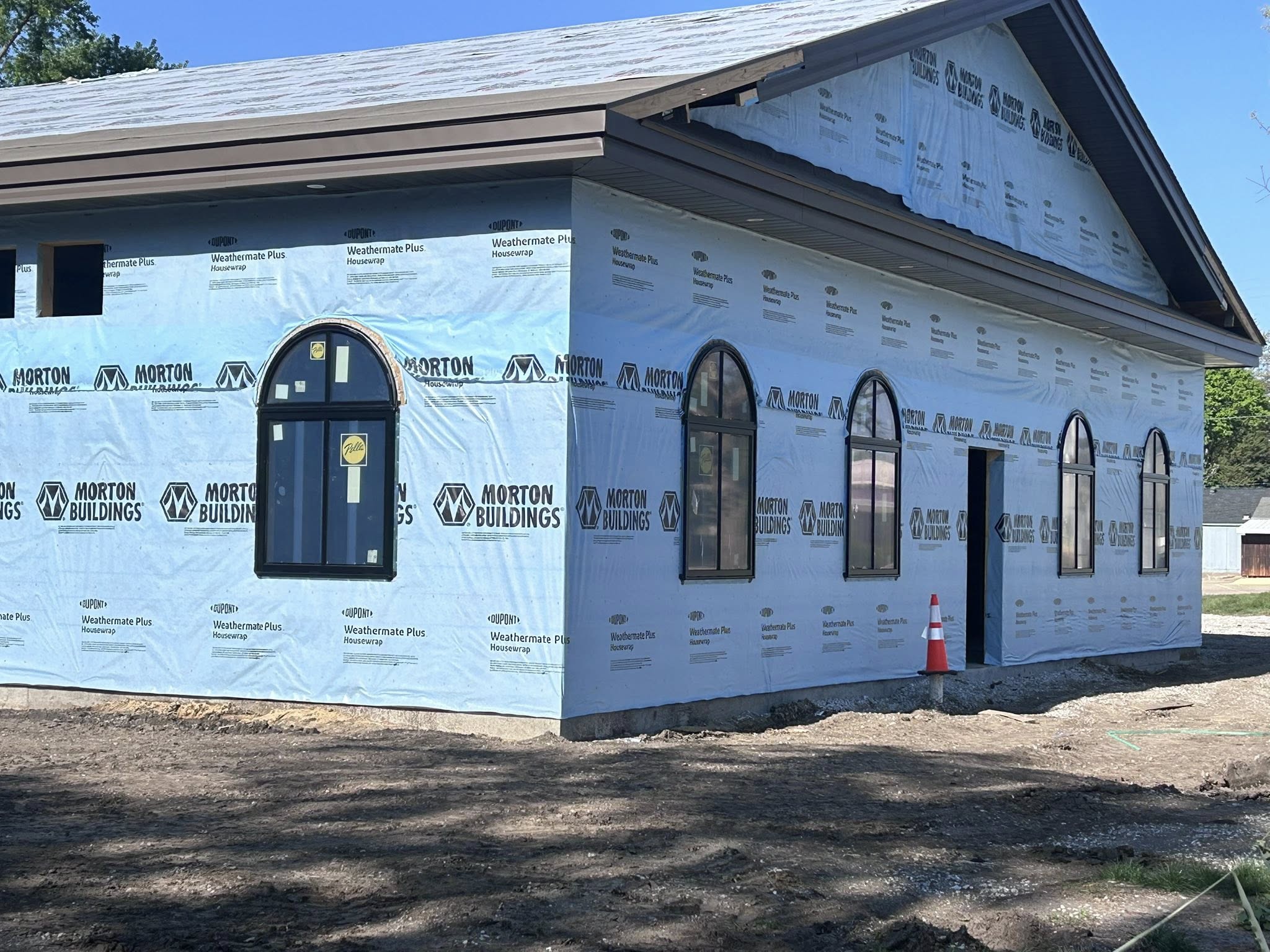

We have windows!

May 4, 2026

We have windows!! They are beautiful!!

May 4, 2026

Office windows are in. And part of the hall windows.

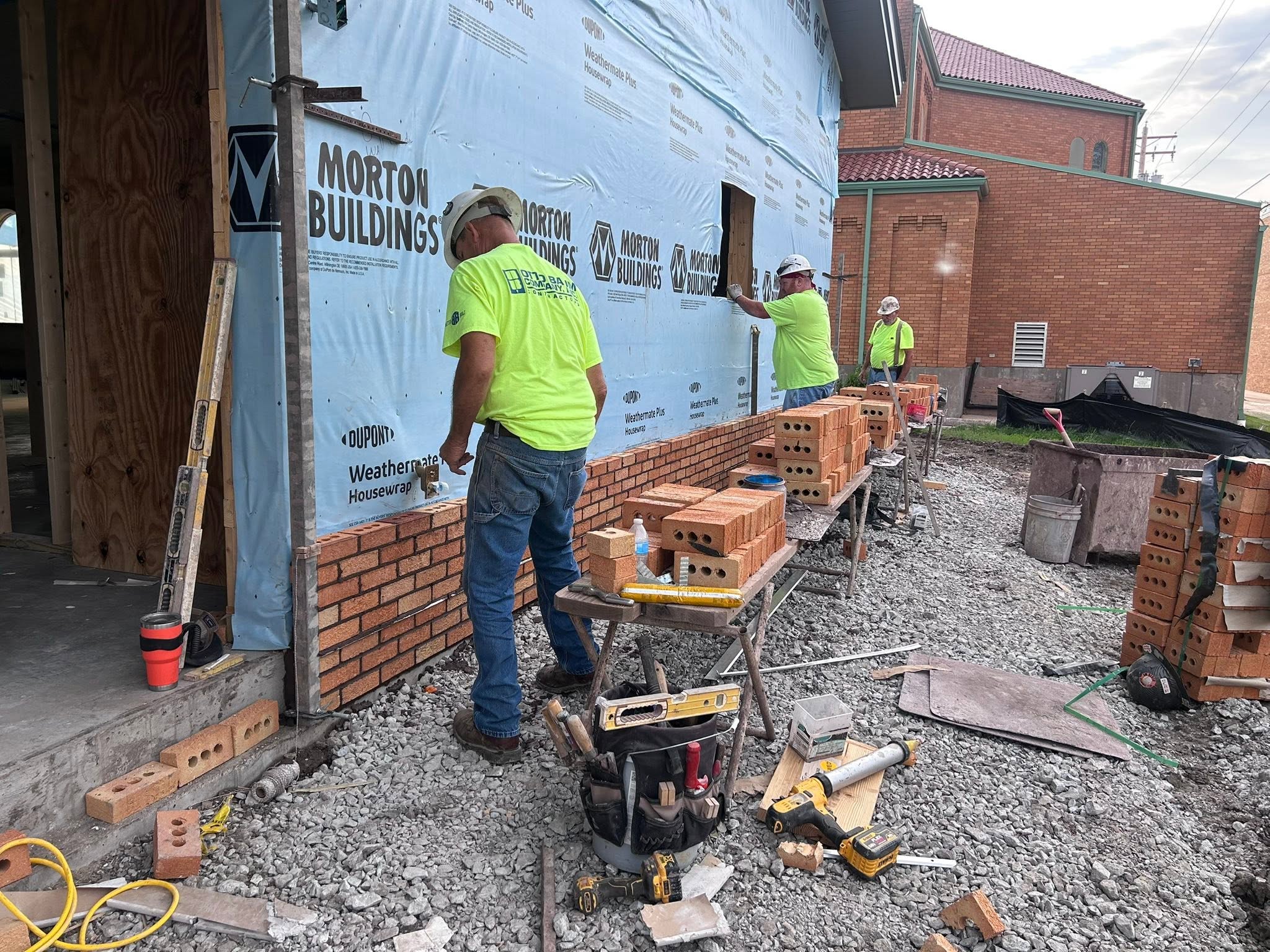

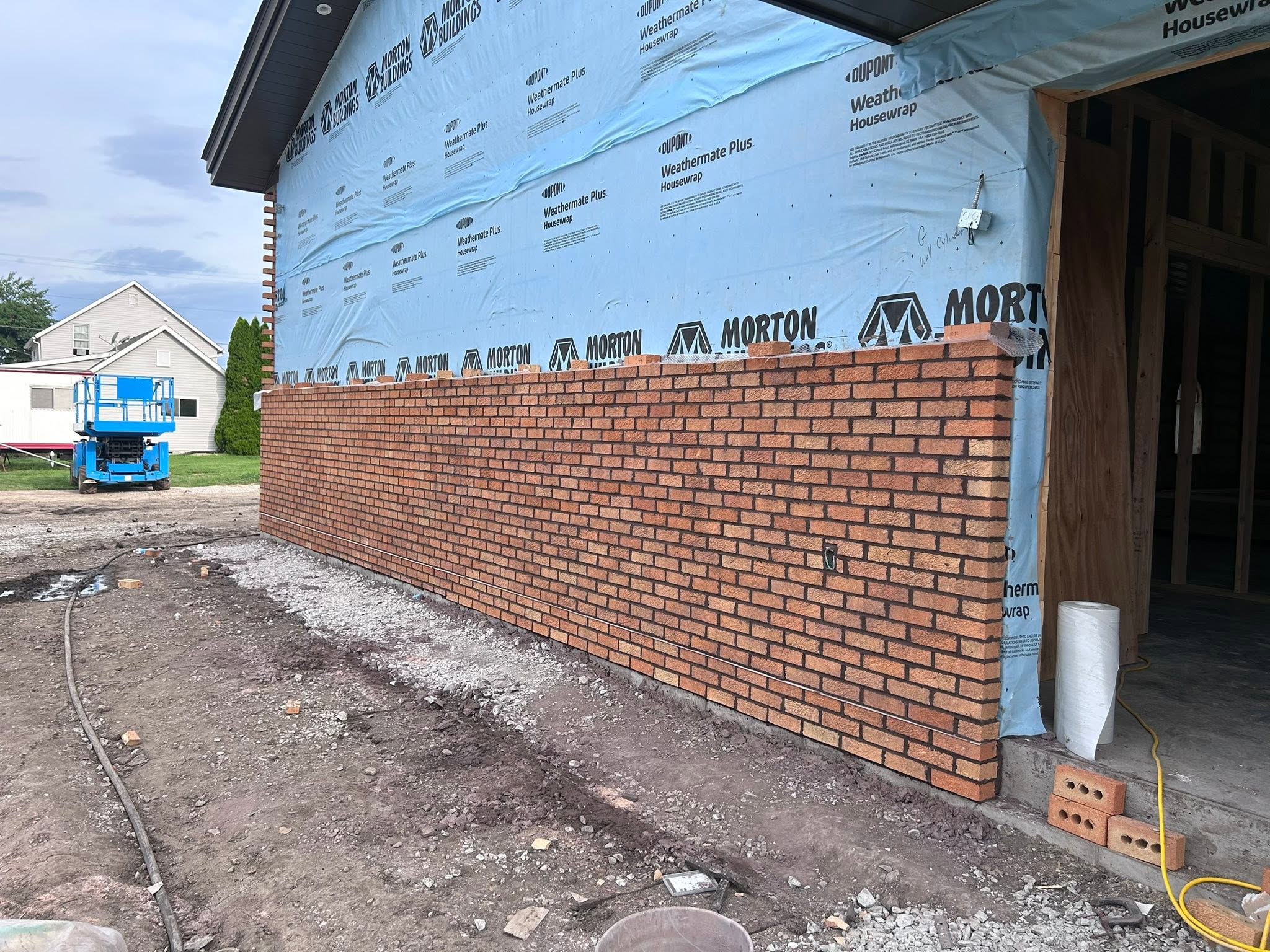

The bricks are here!

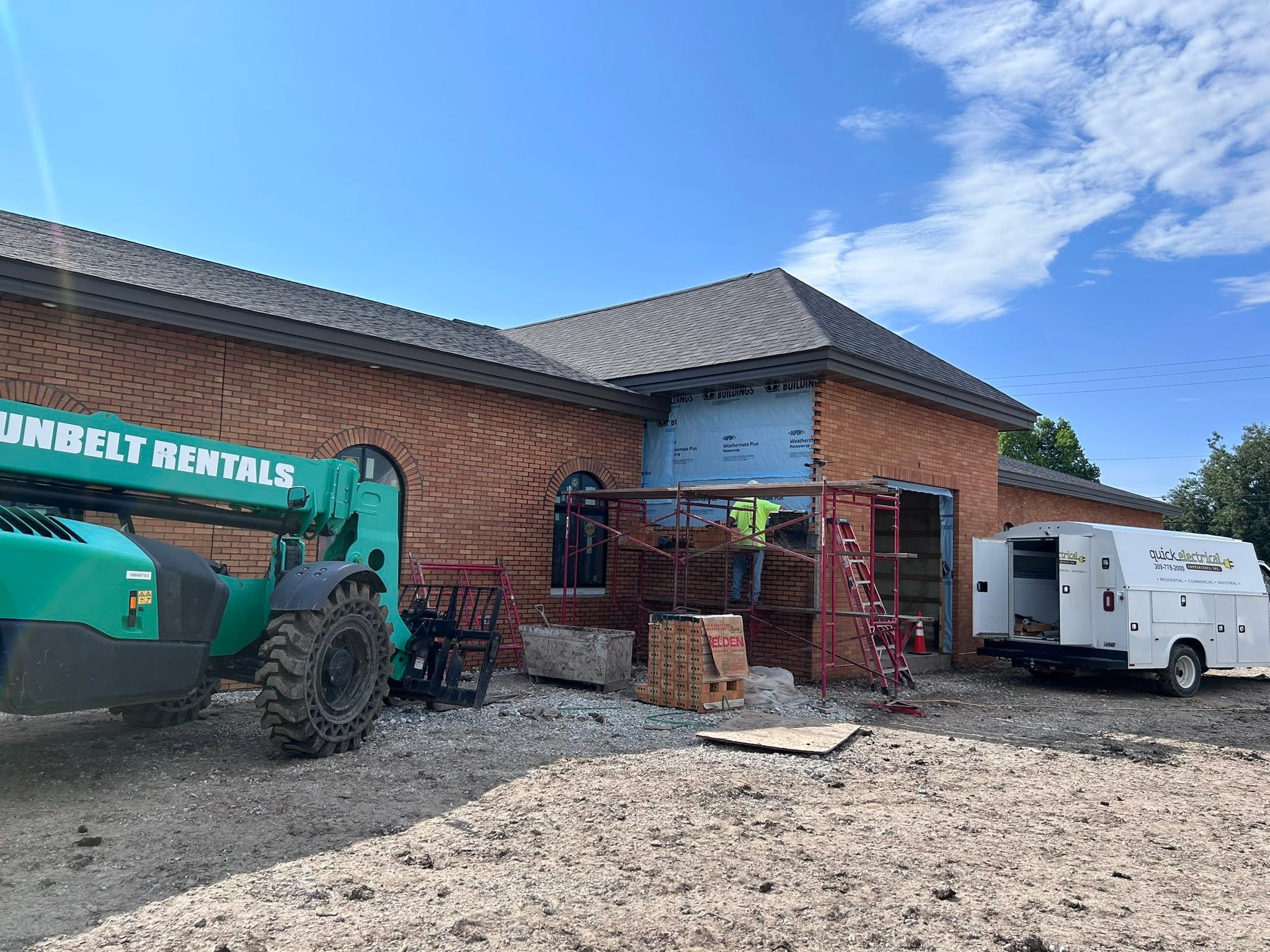

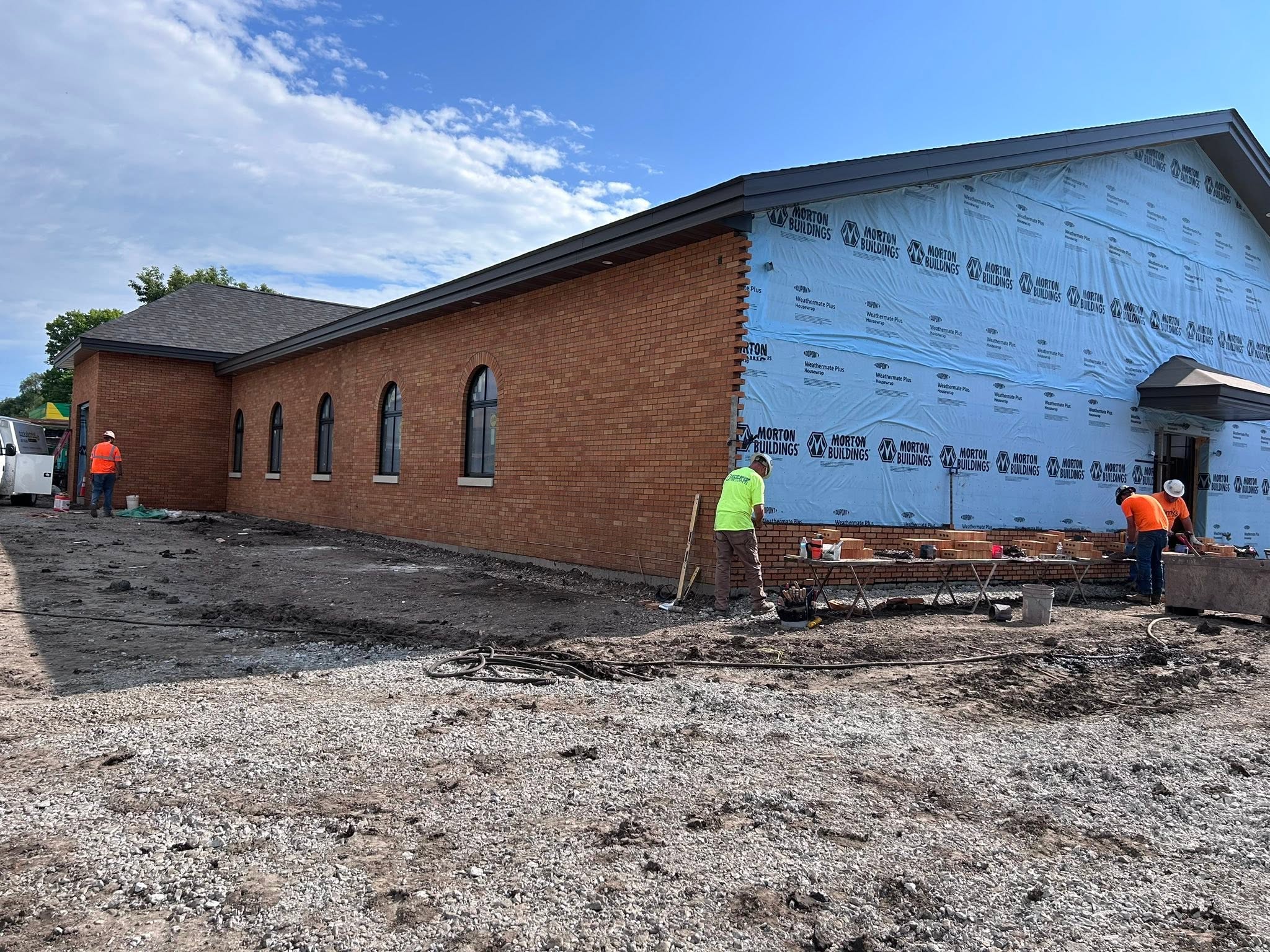

May 6, 2026

The first load of bricks arrived today.

The sprinkler system is going in

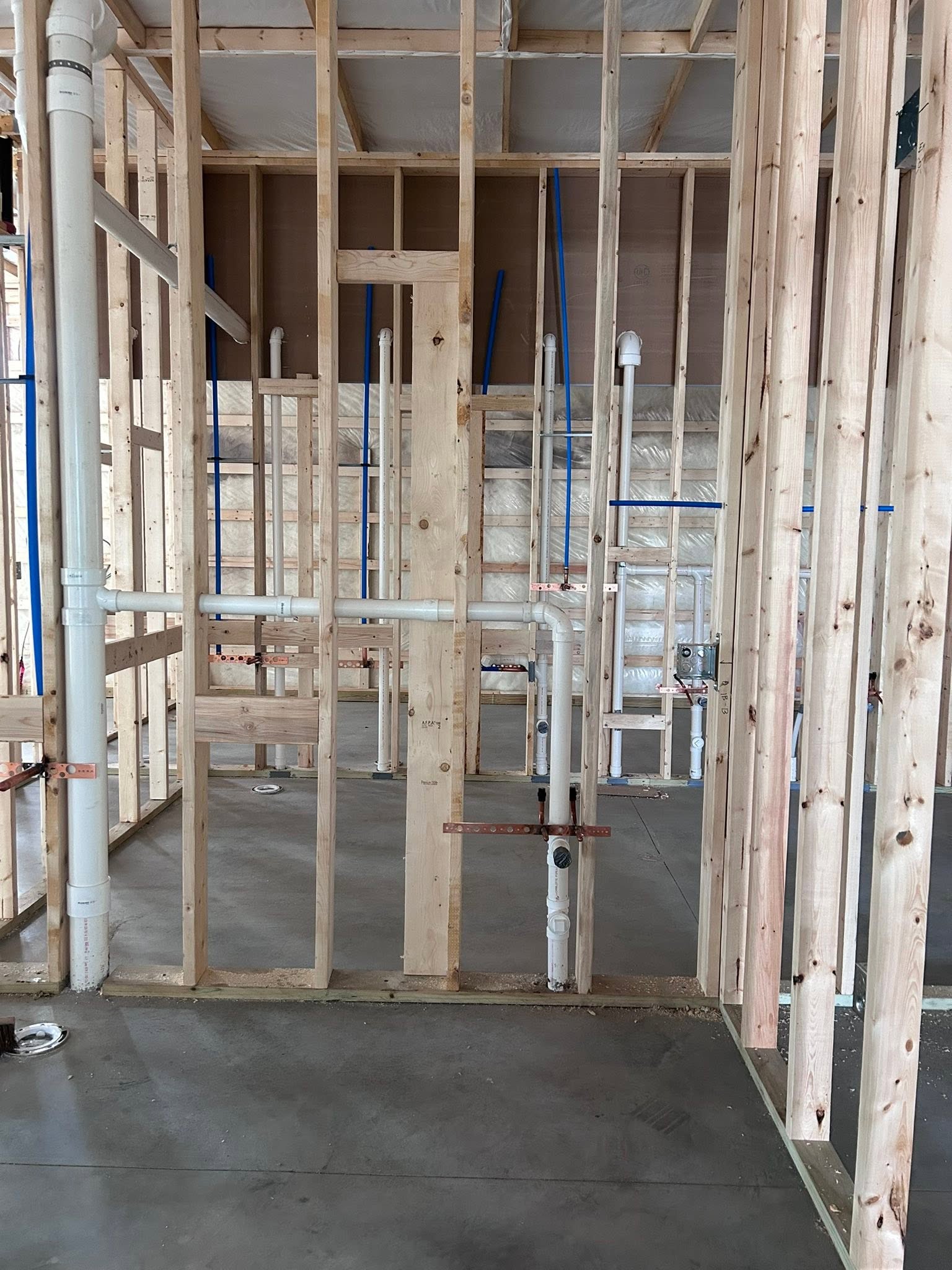

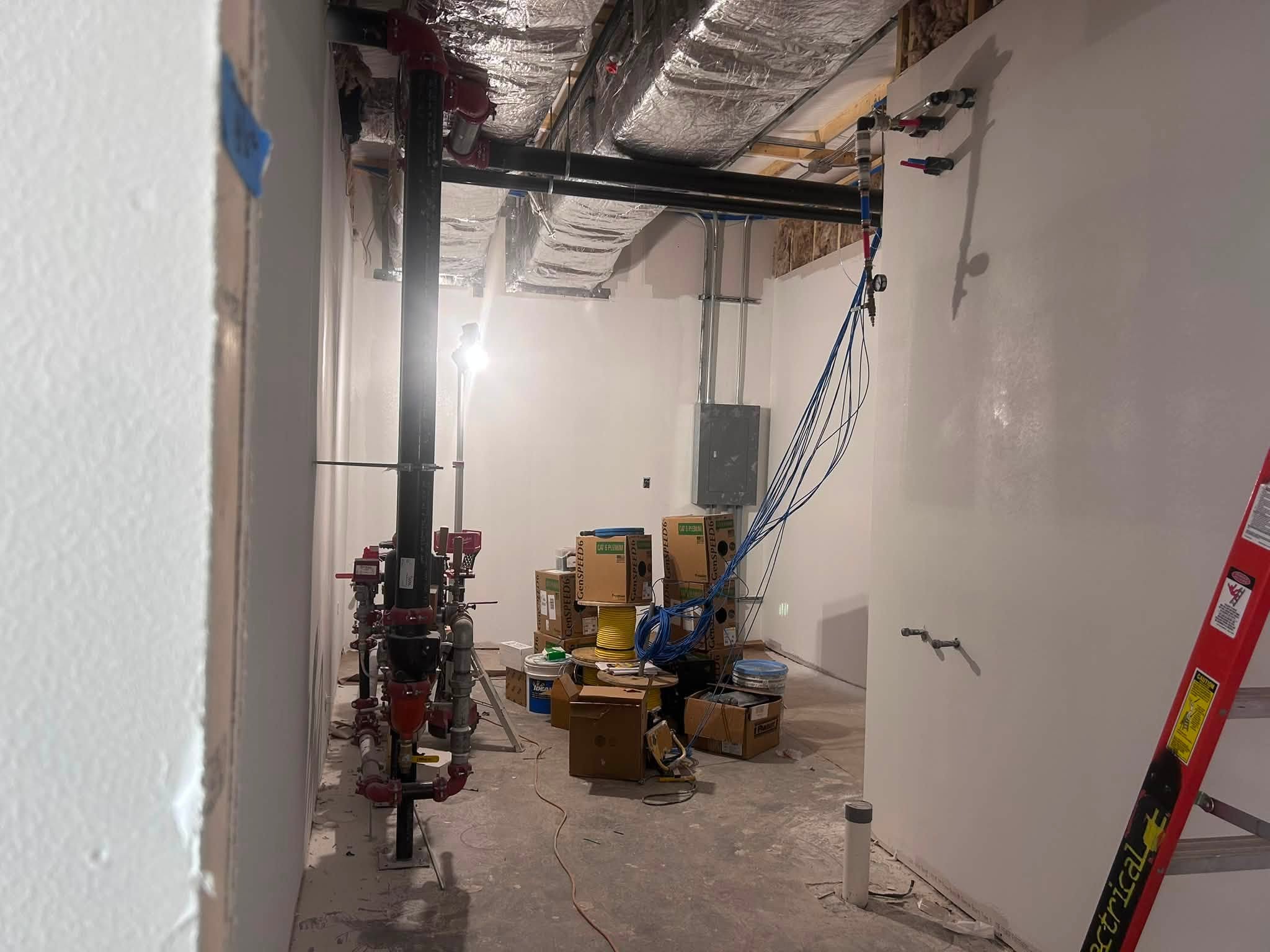

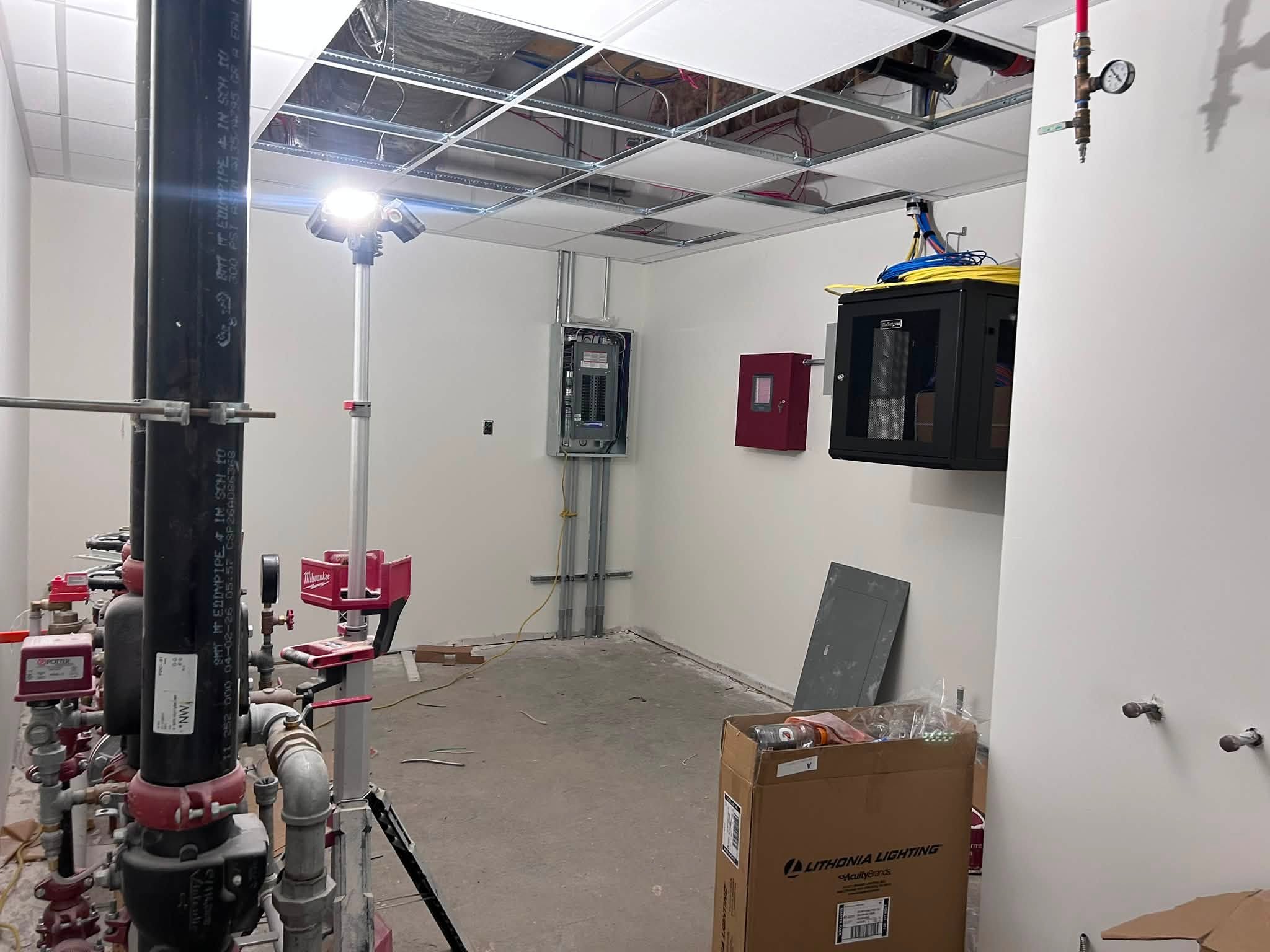

May 6, 2026

The last two days have been spent starting the installation of the sprinkler system.

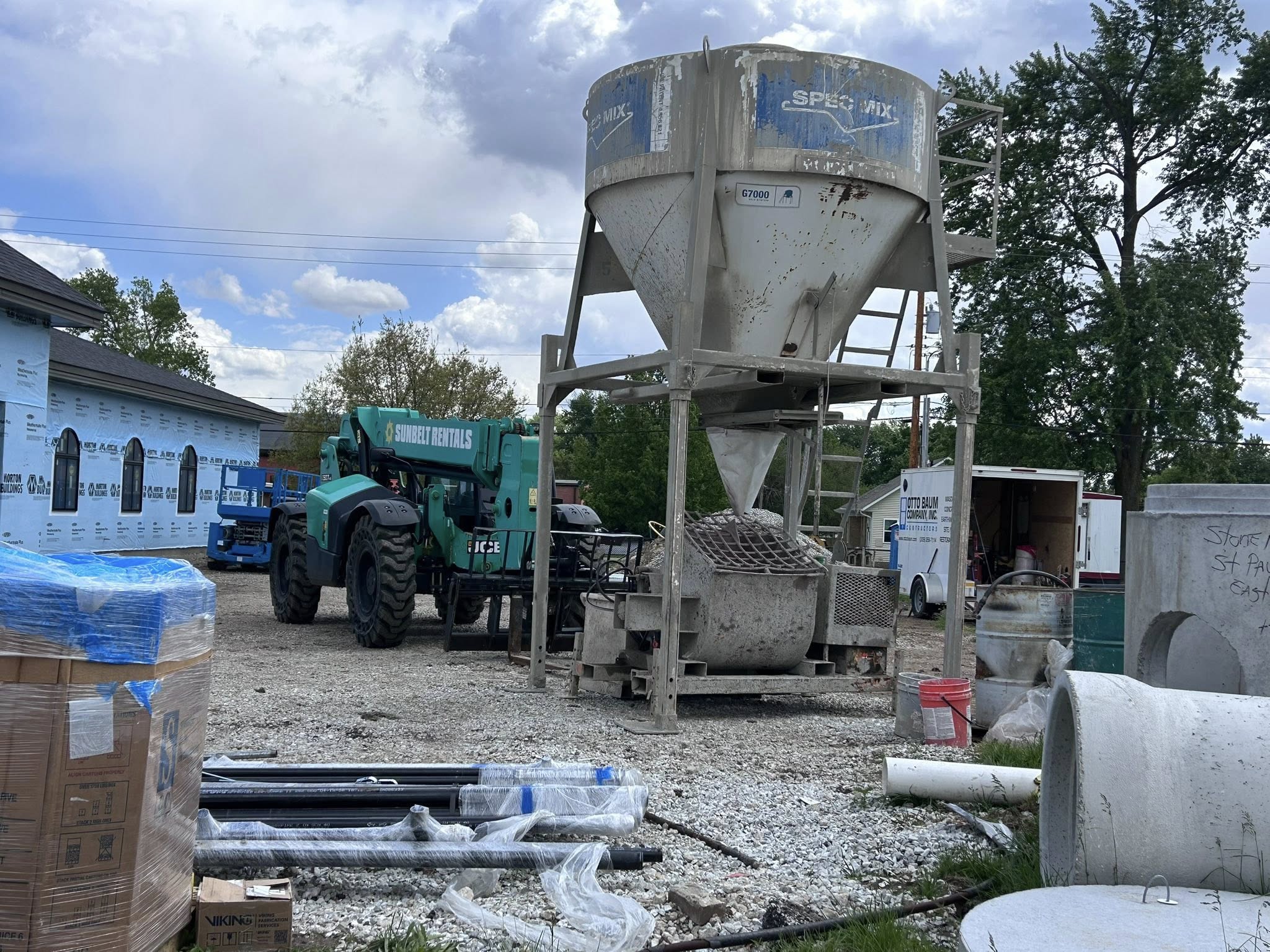

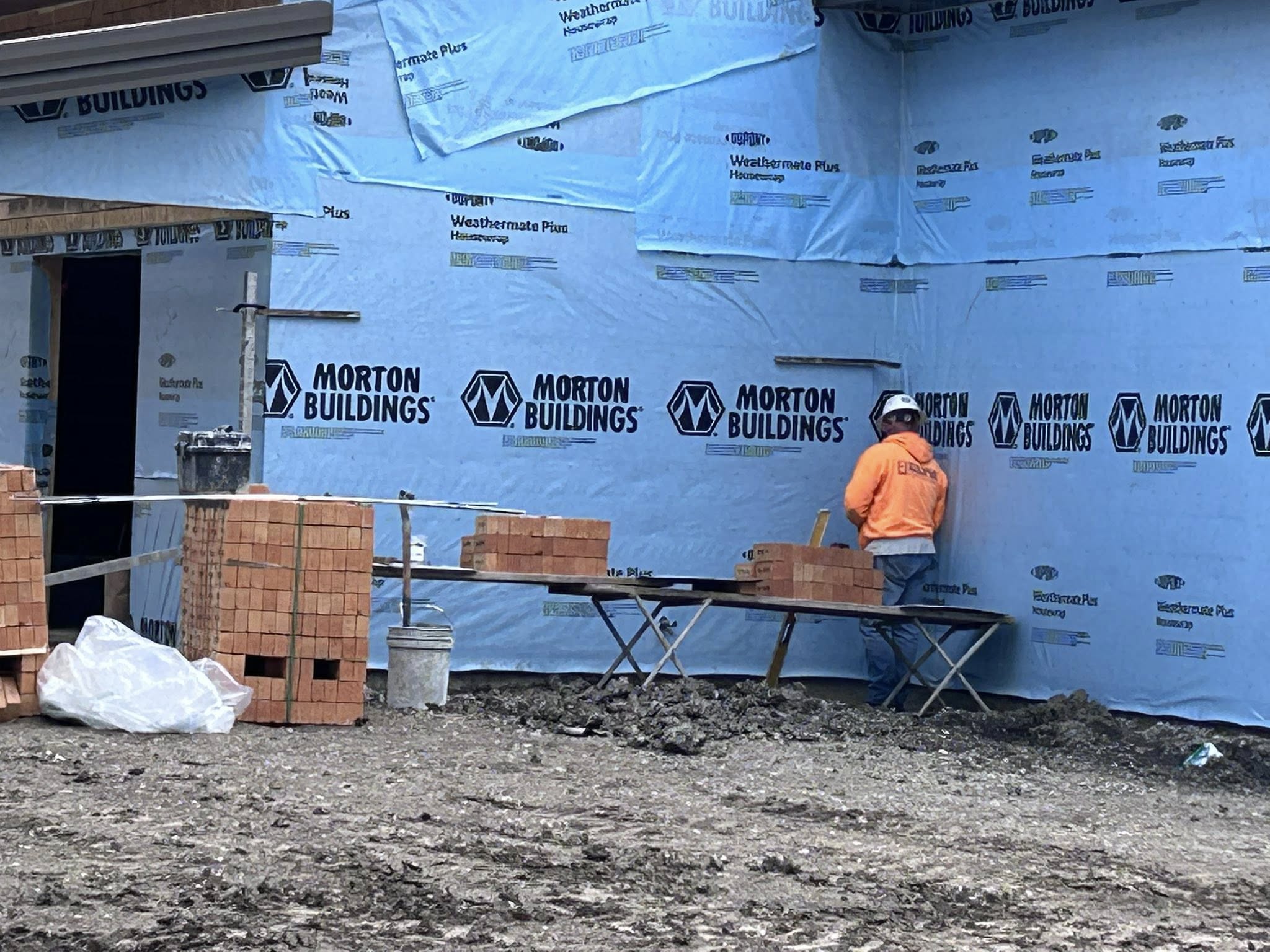

The preparation for bricks

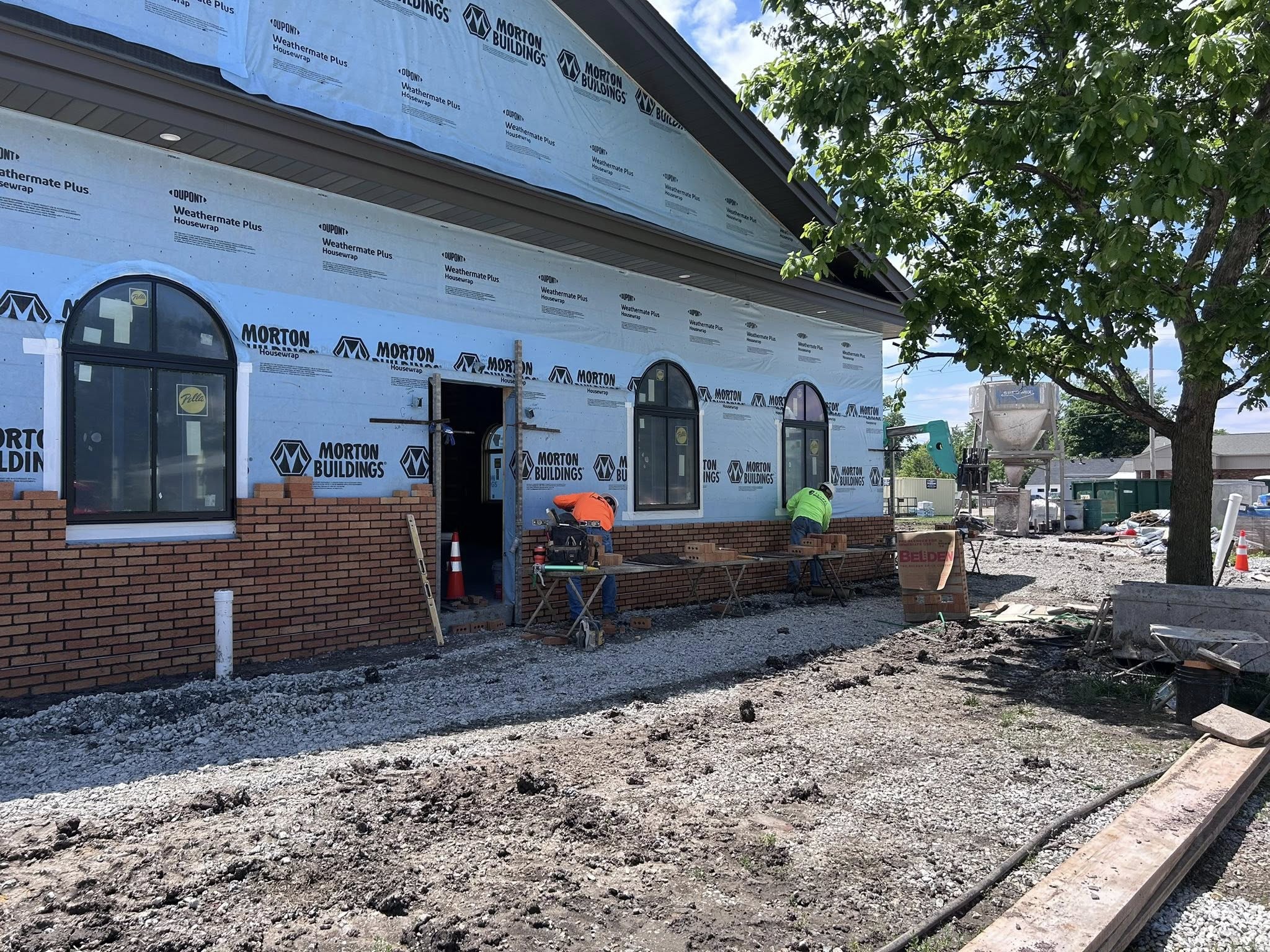

May 7, 2026

Preparing to start the brick work.

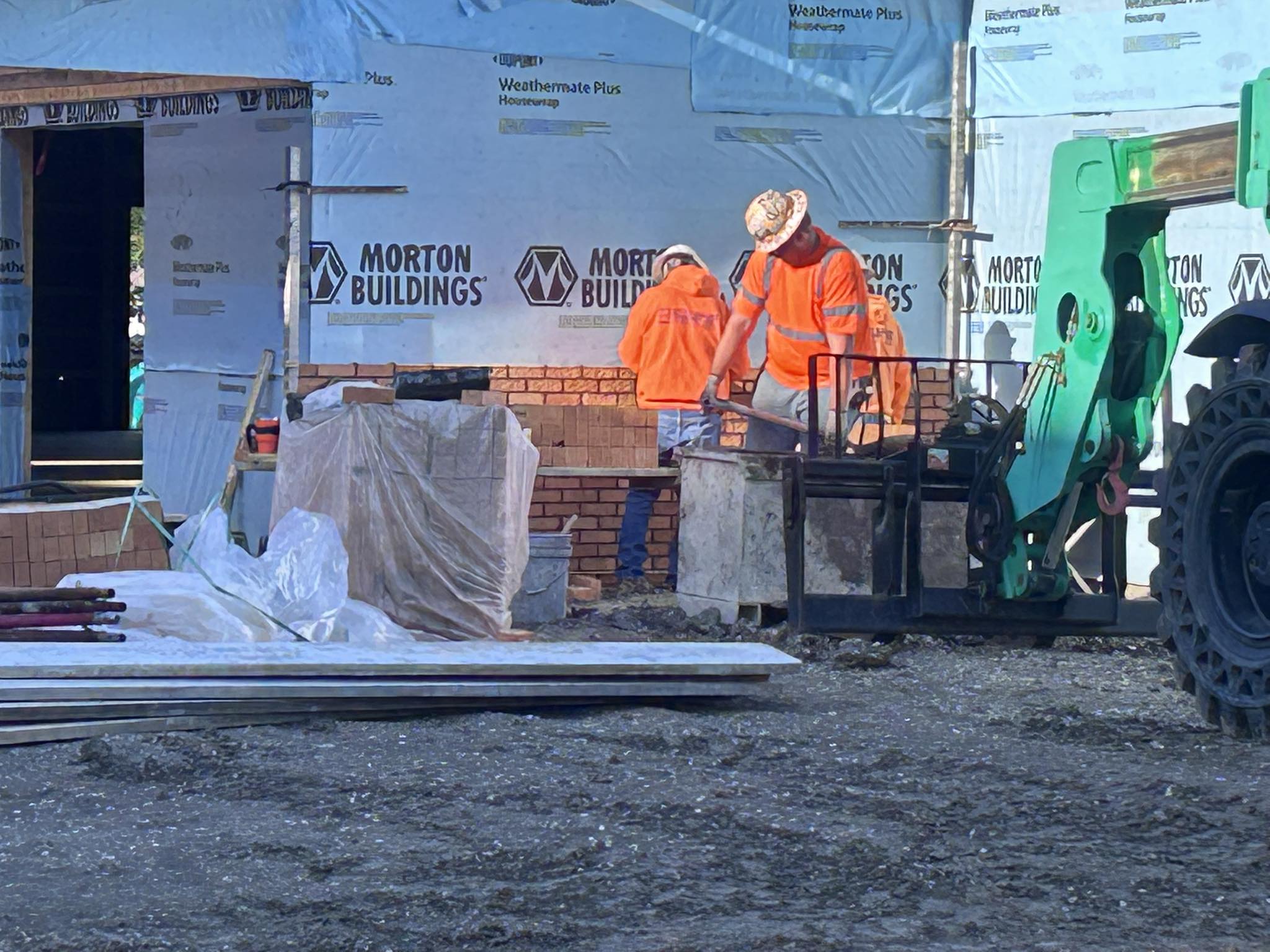

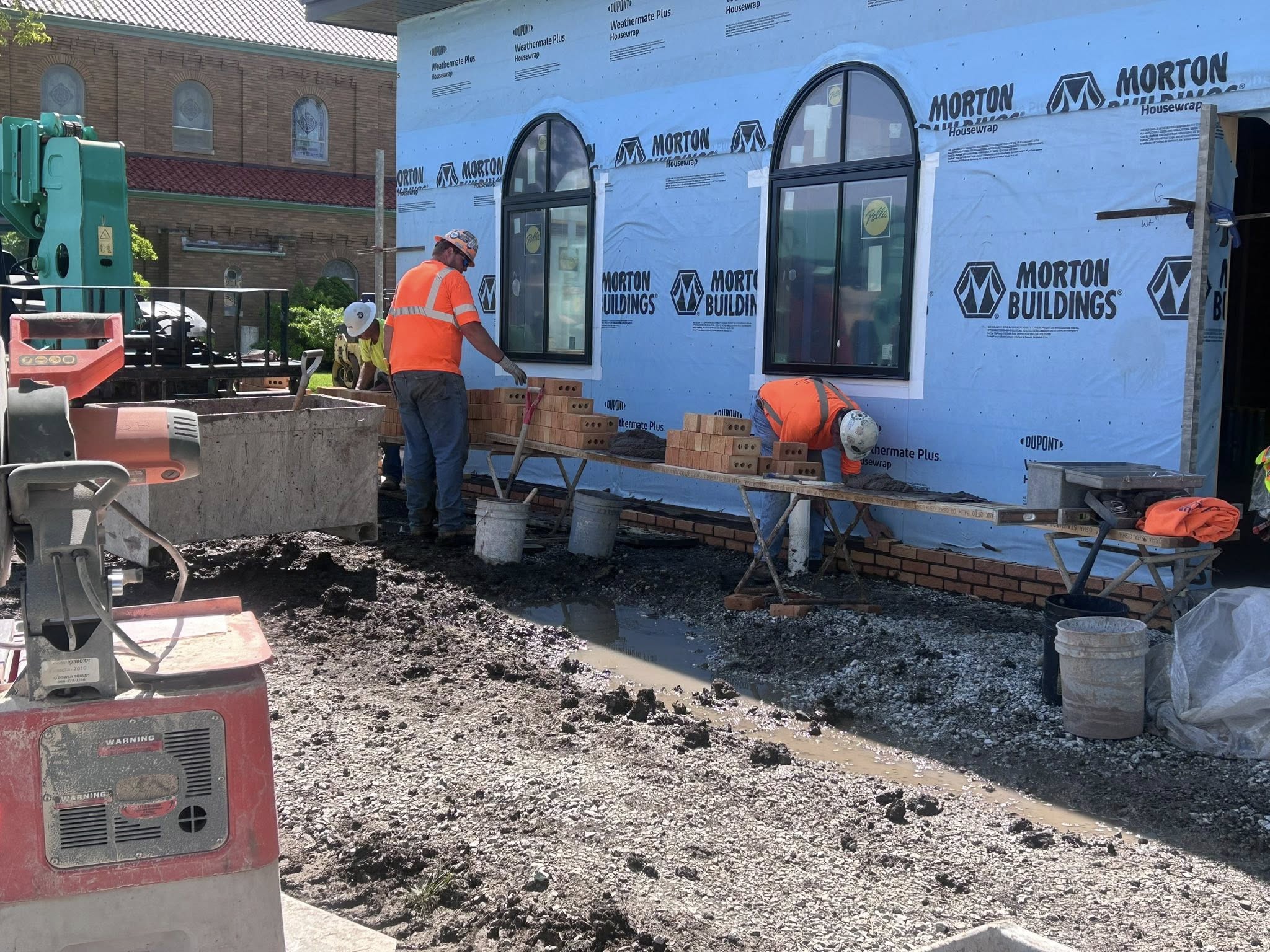

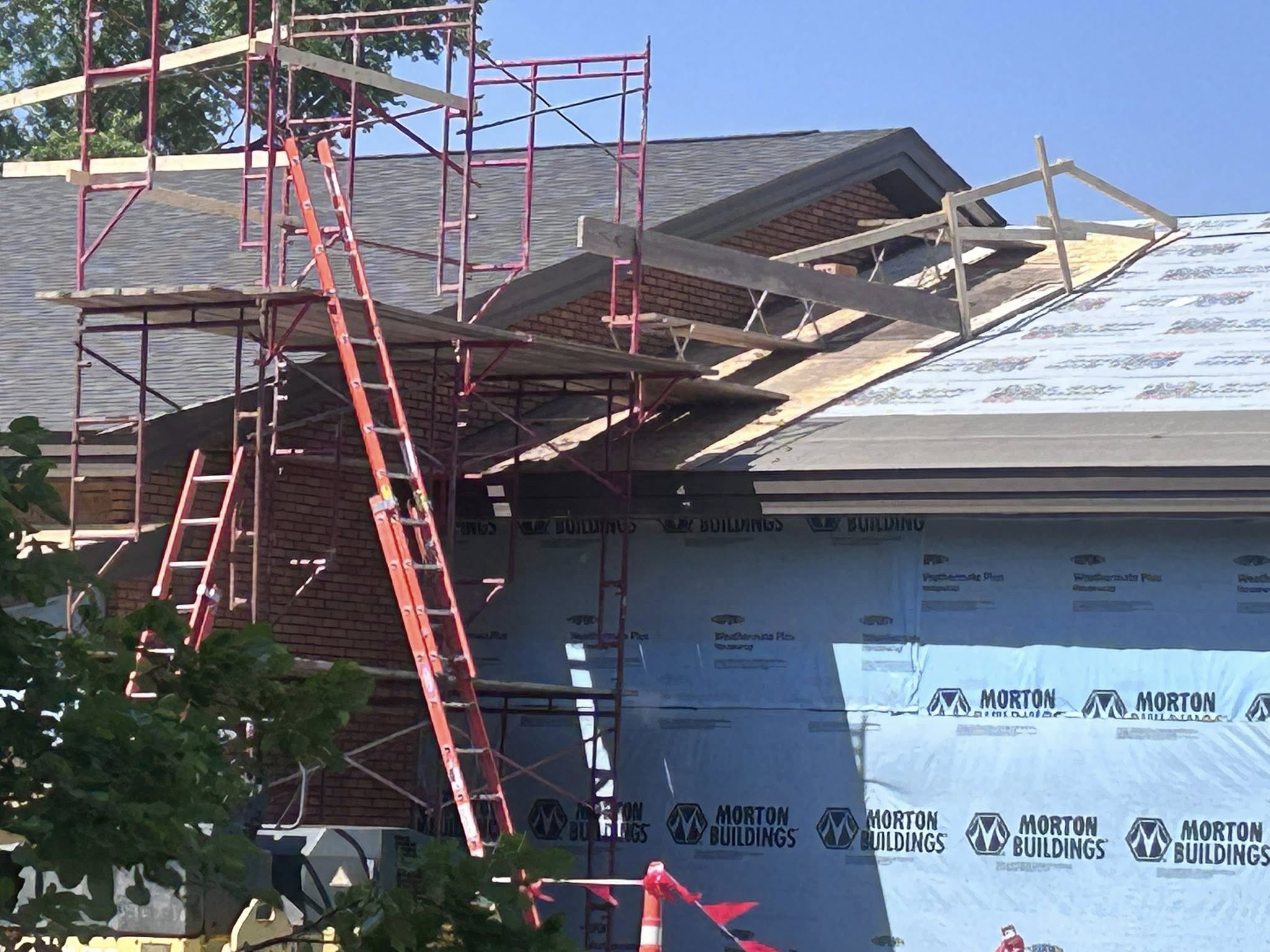

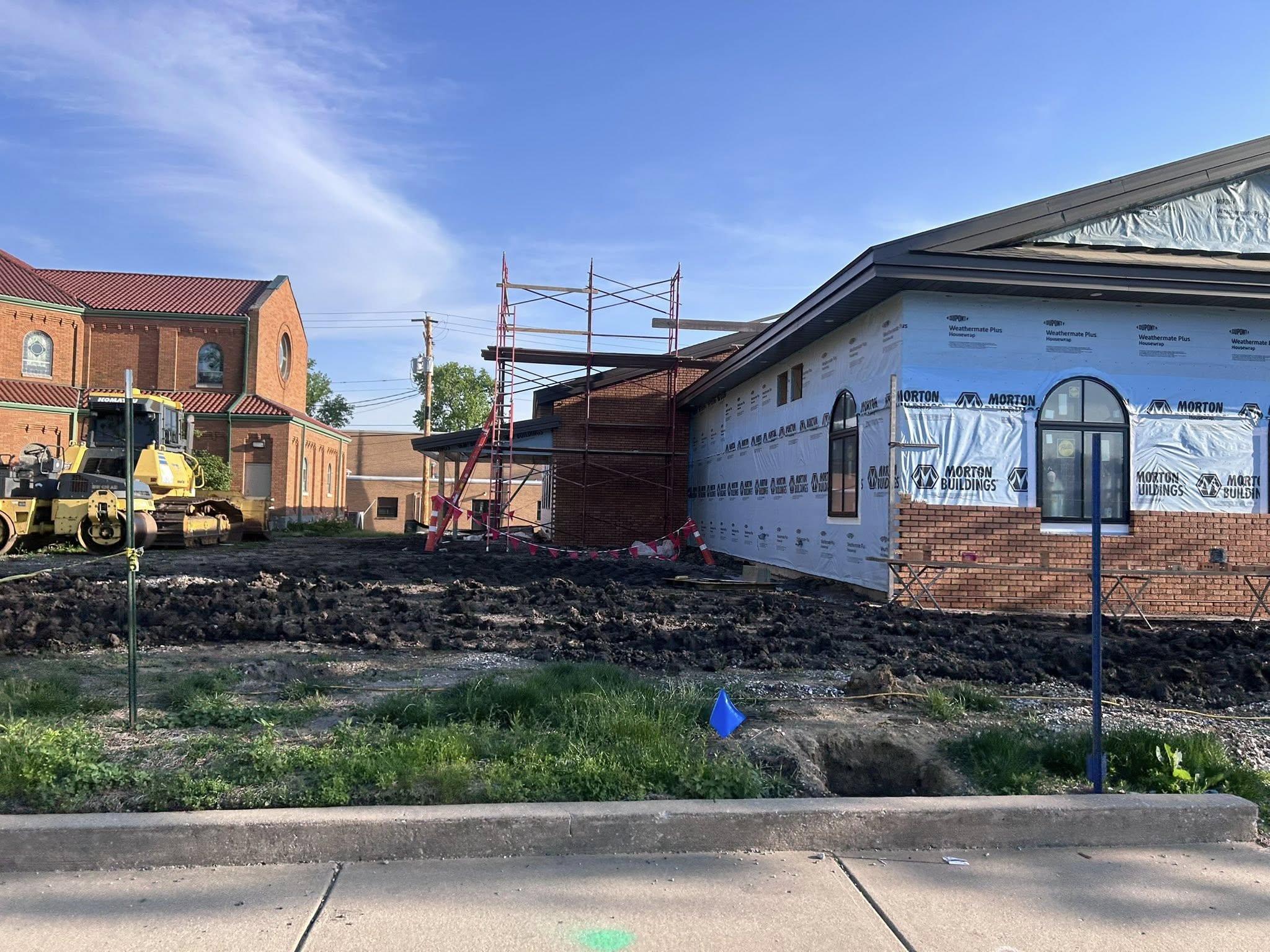

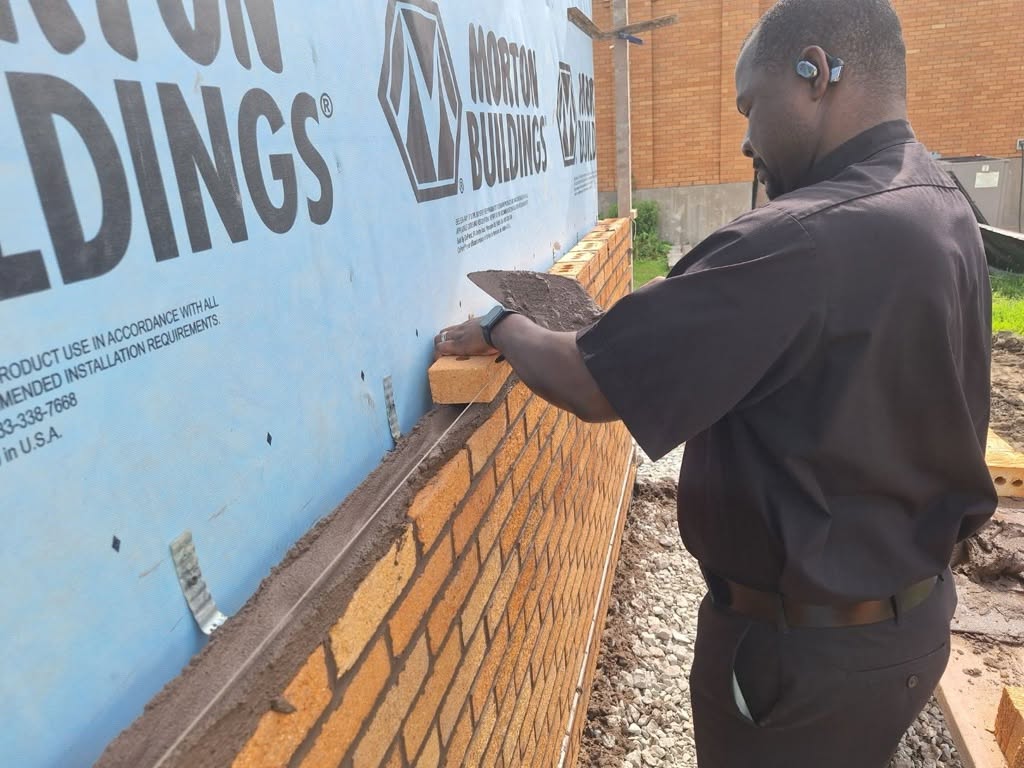

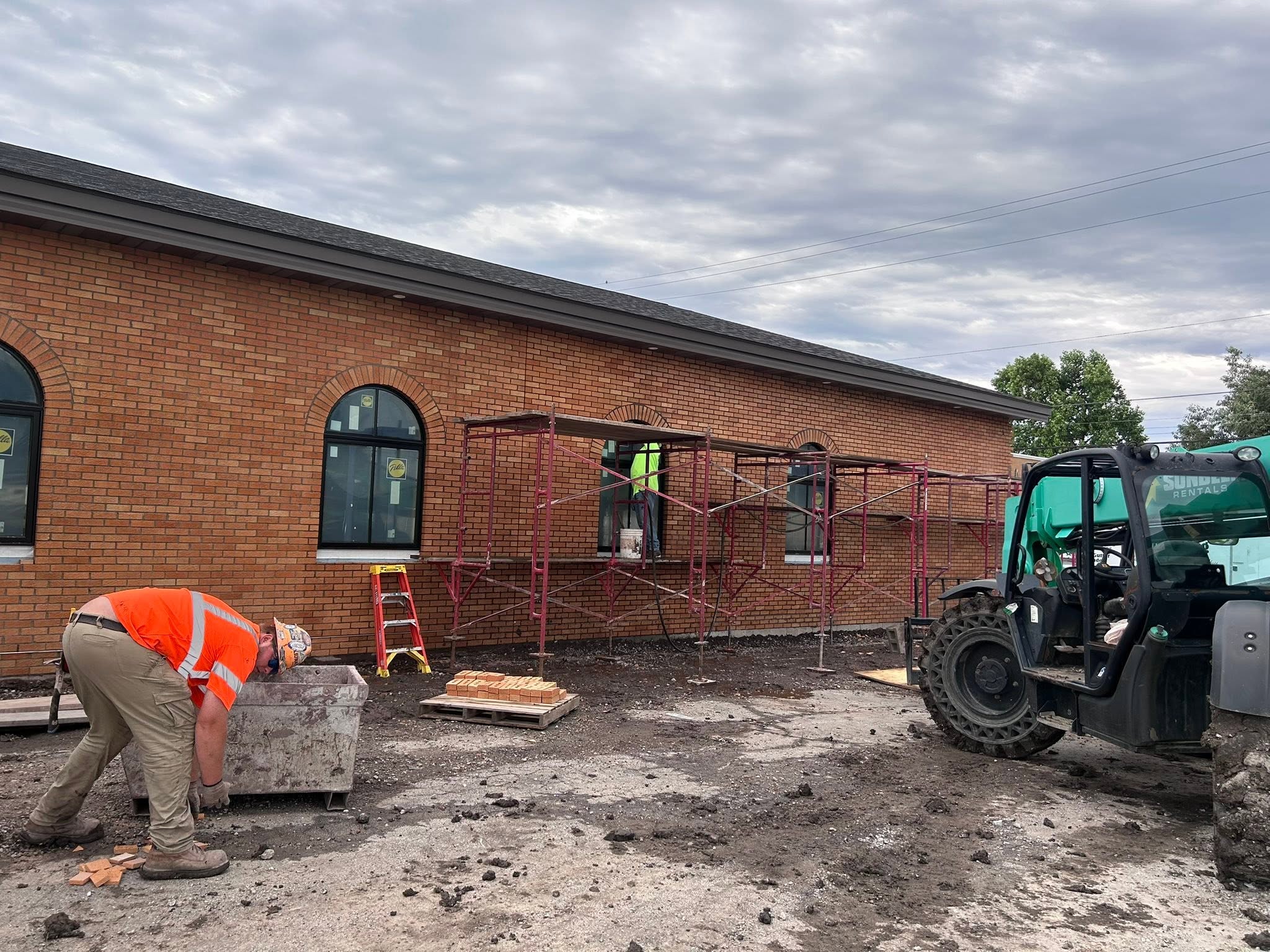

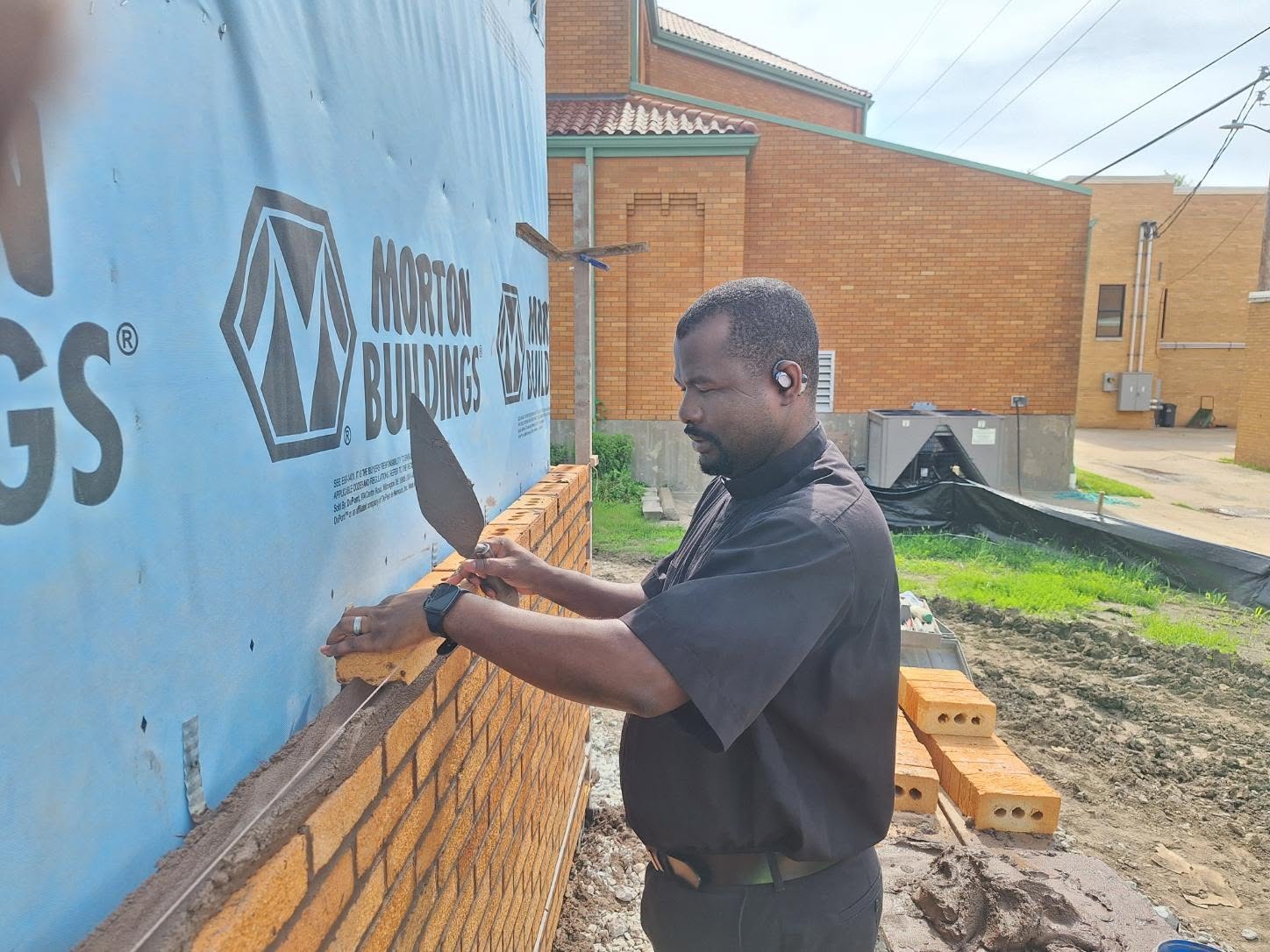

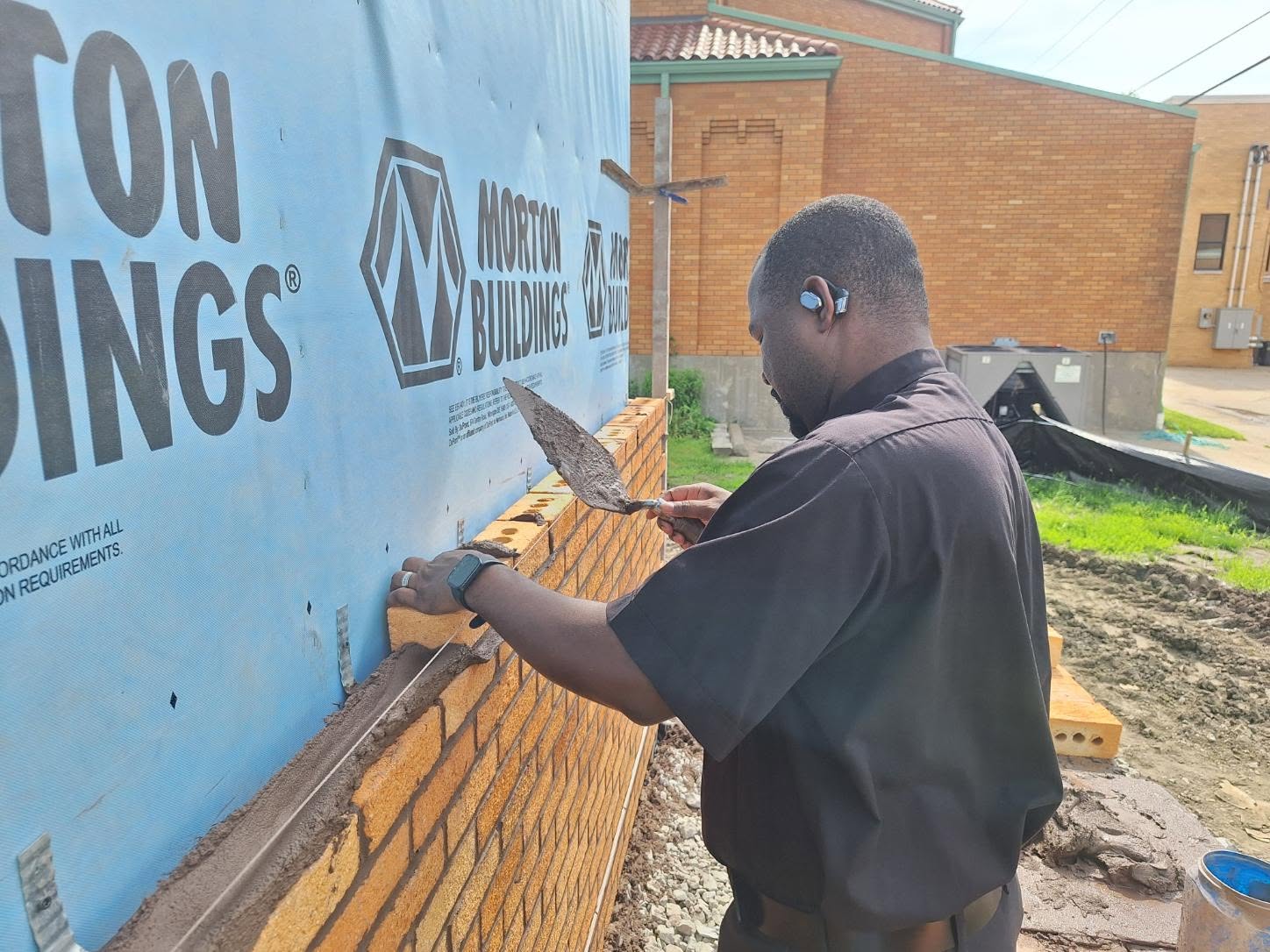

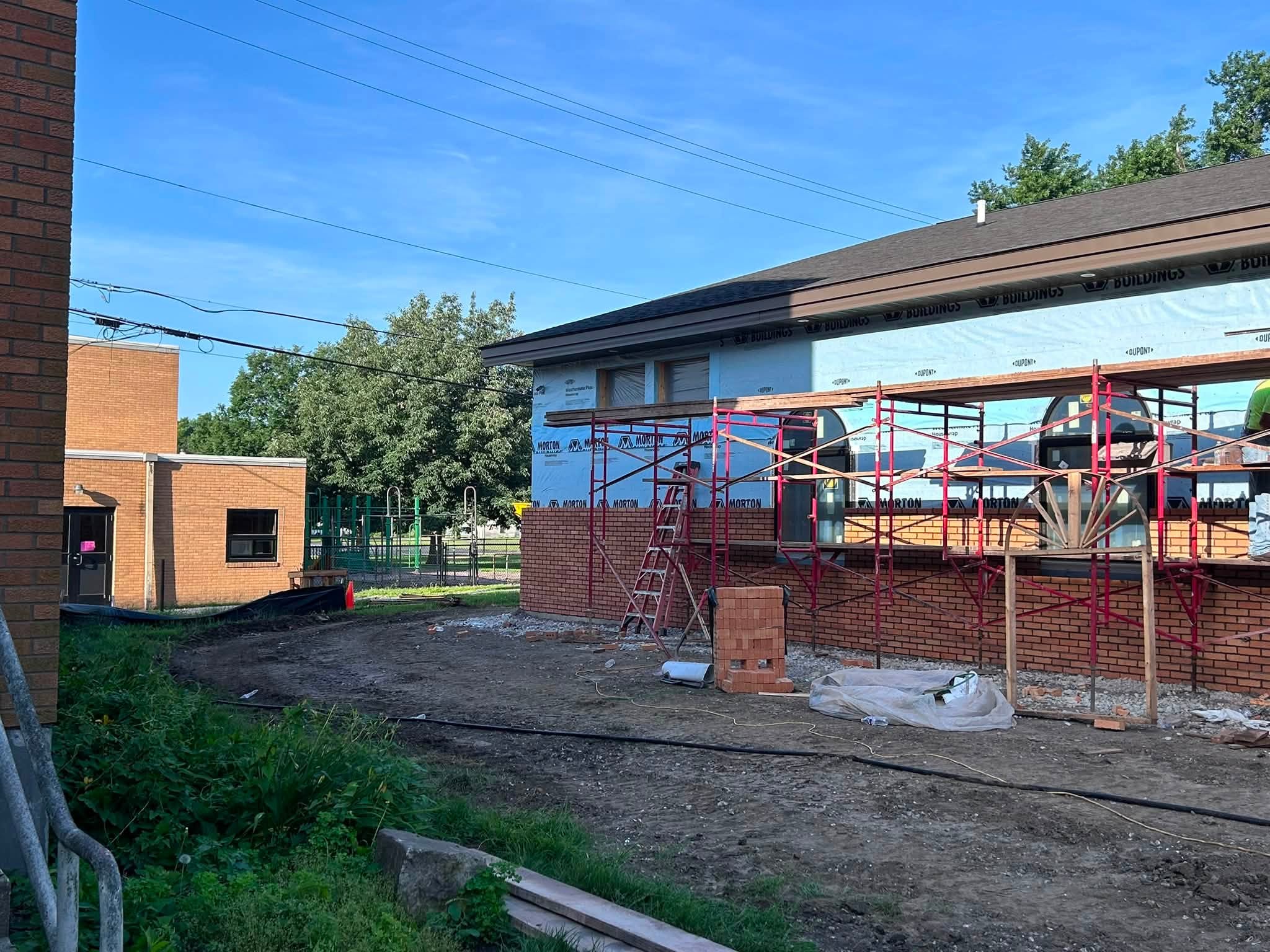

More bricks

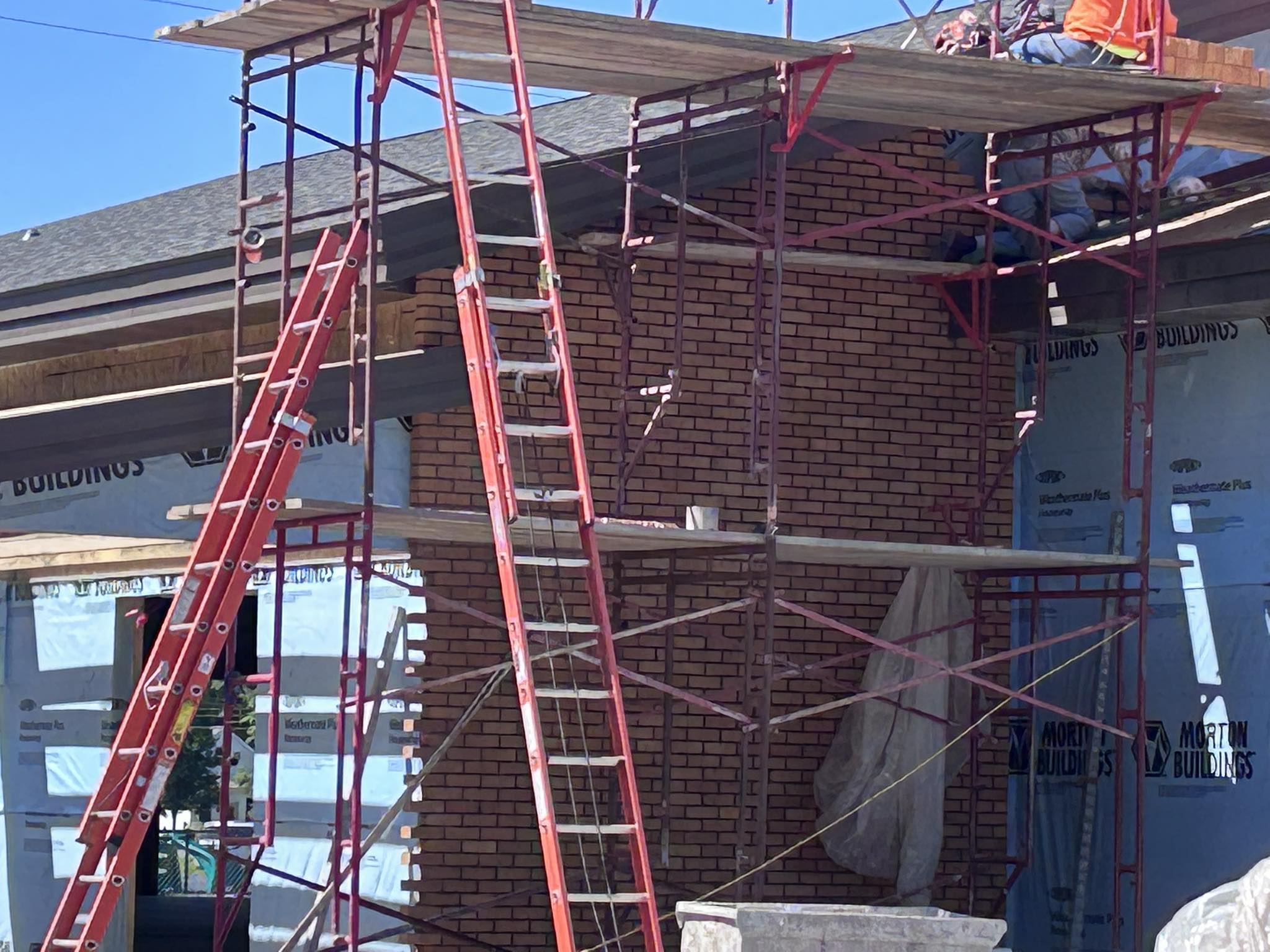

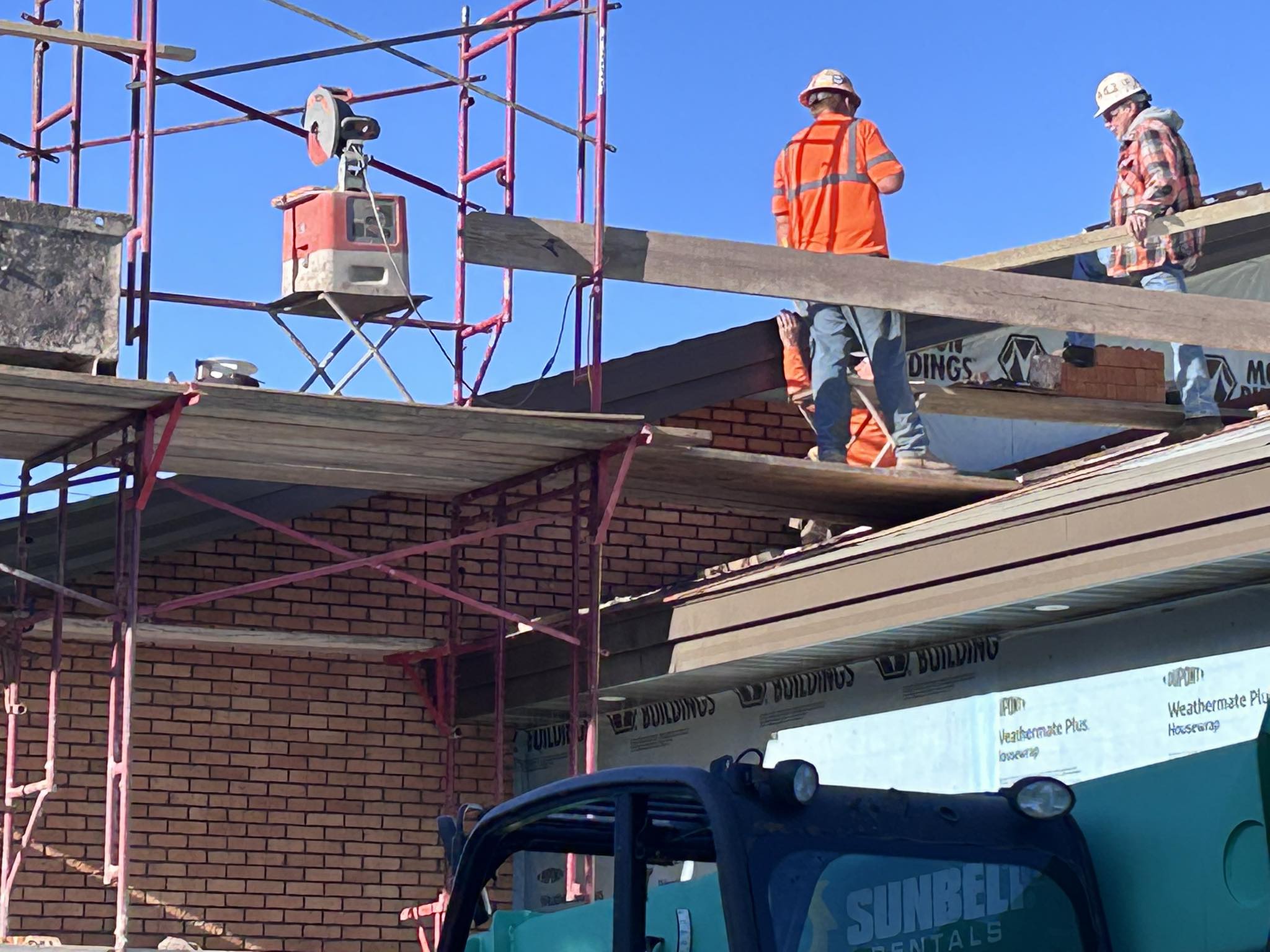

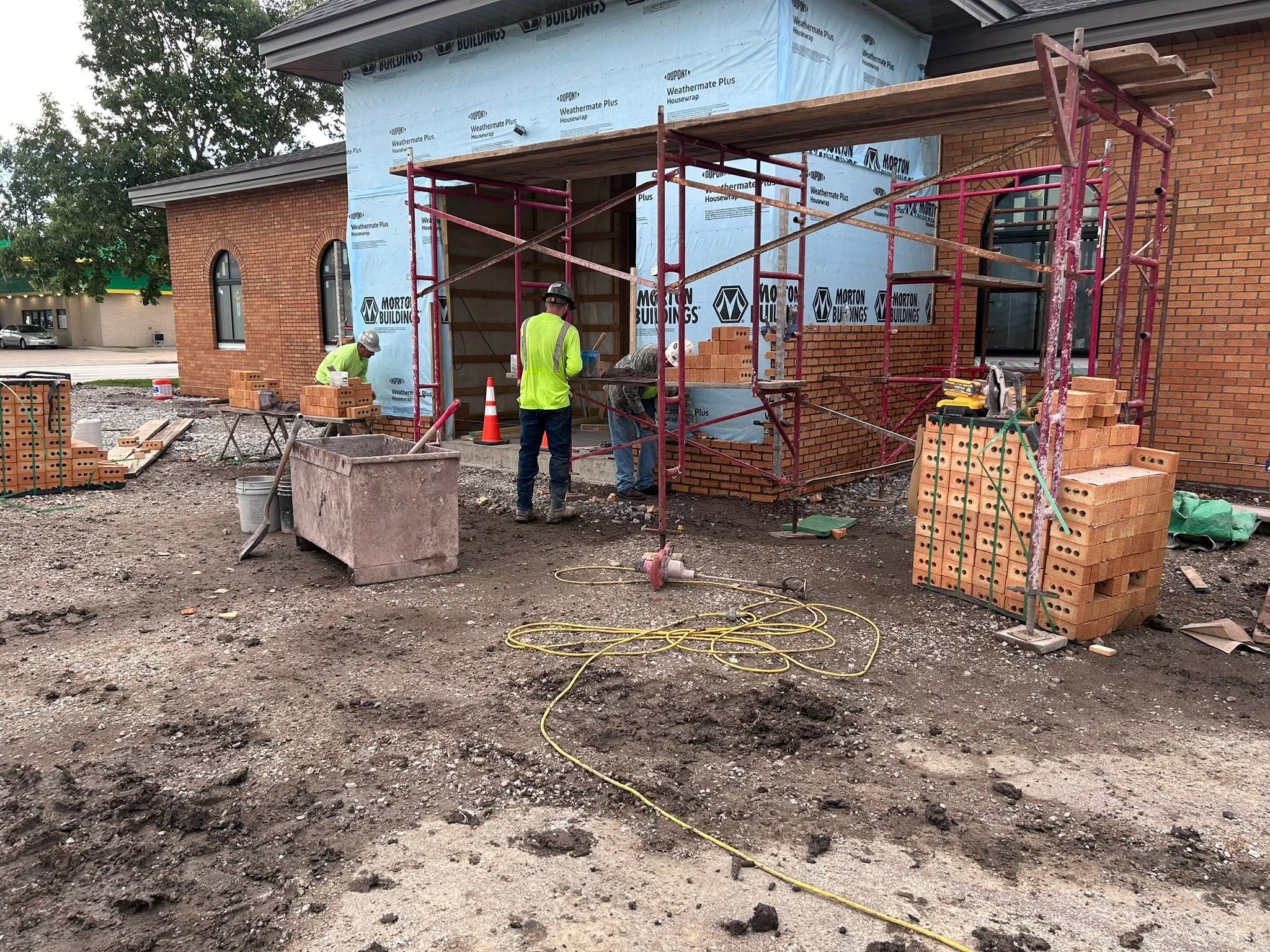

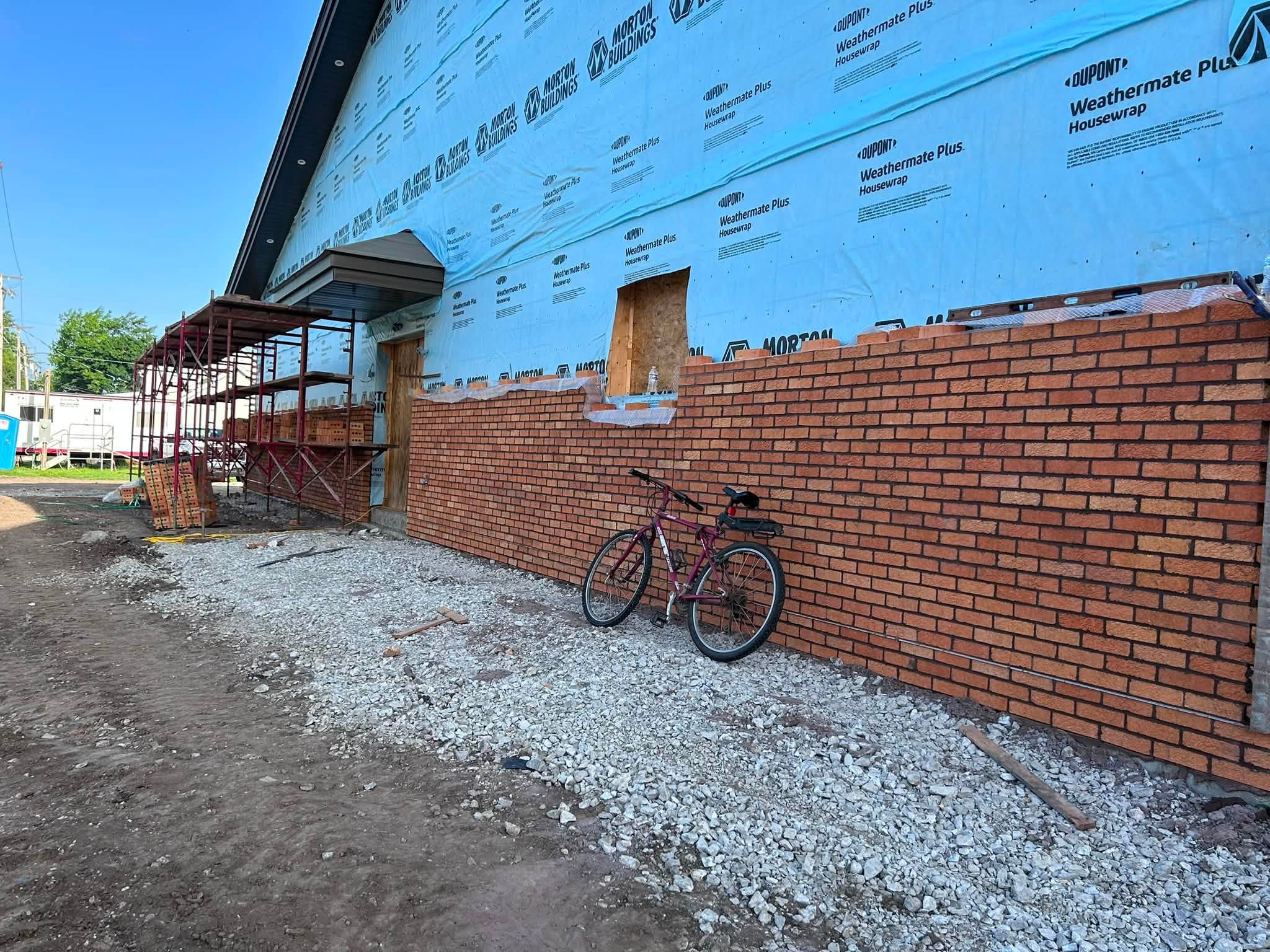

May 11, 2026

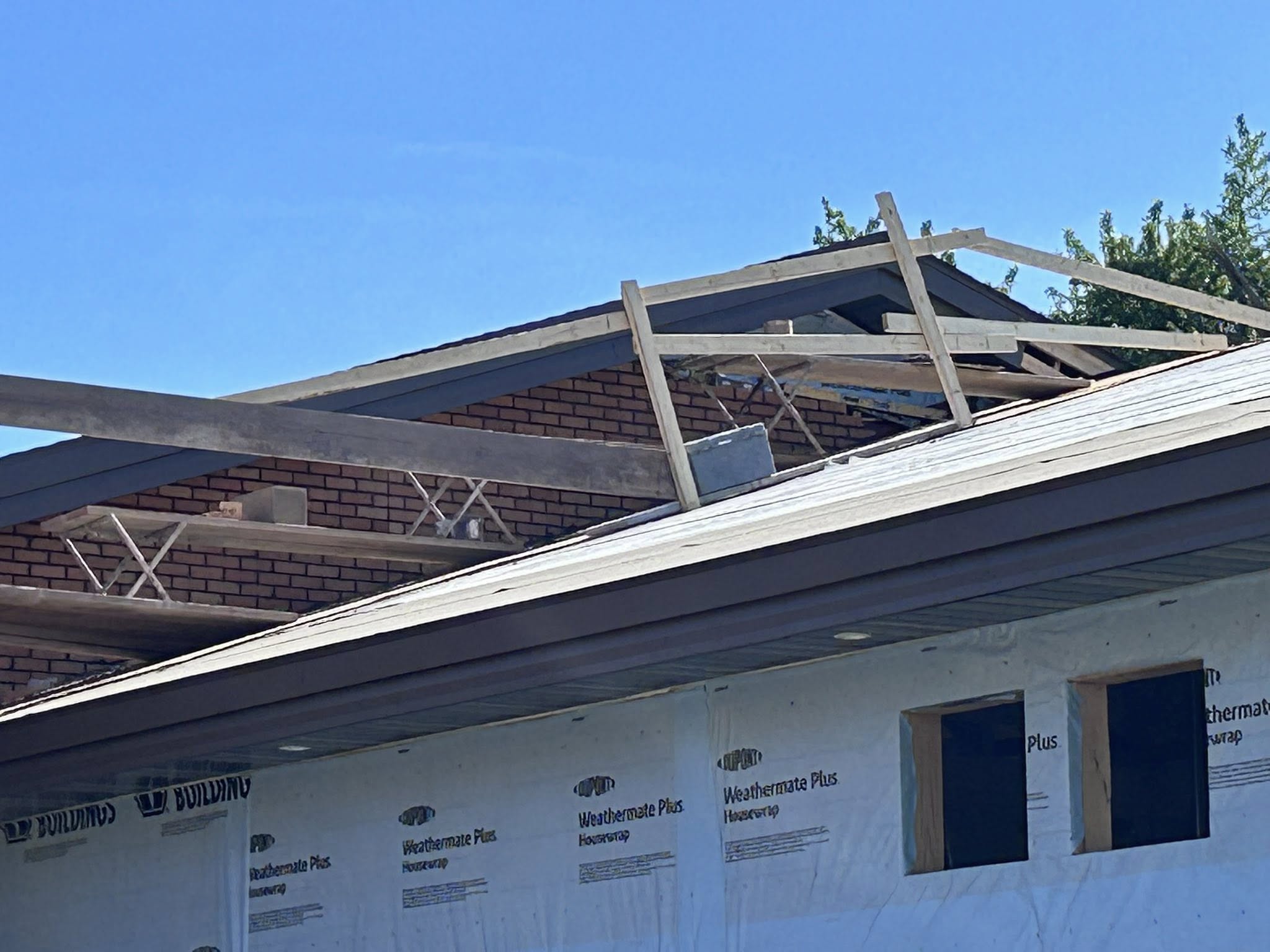

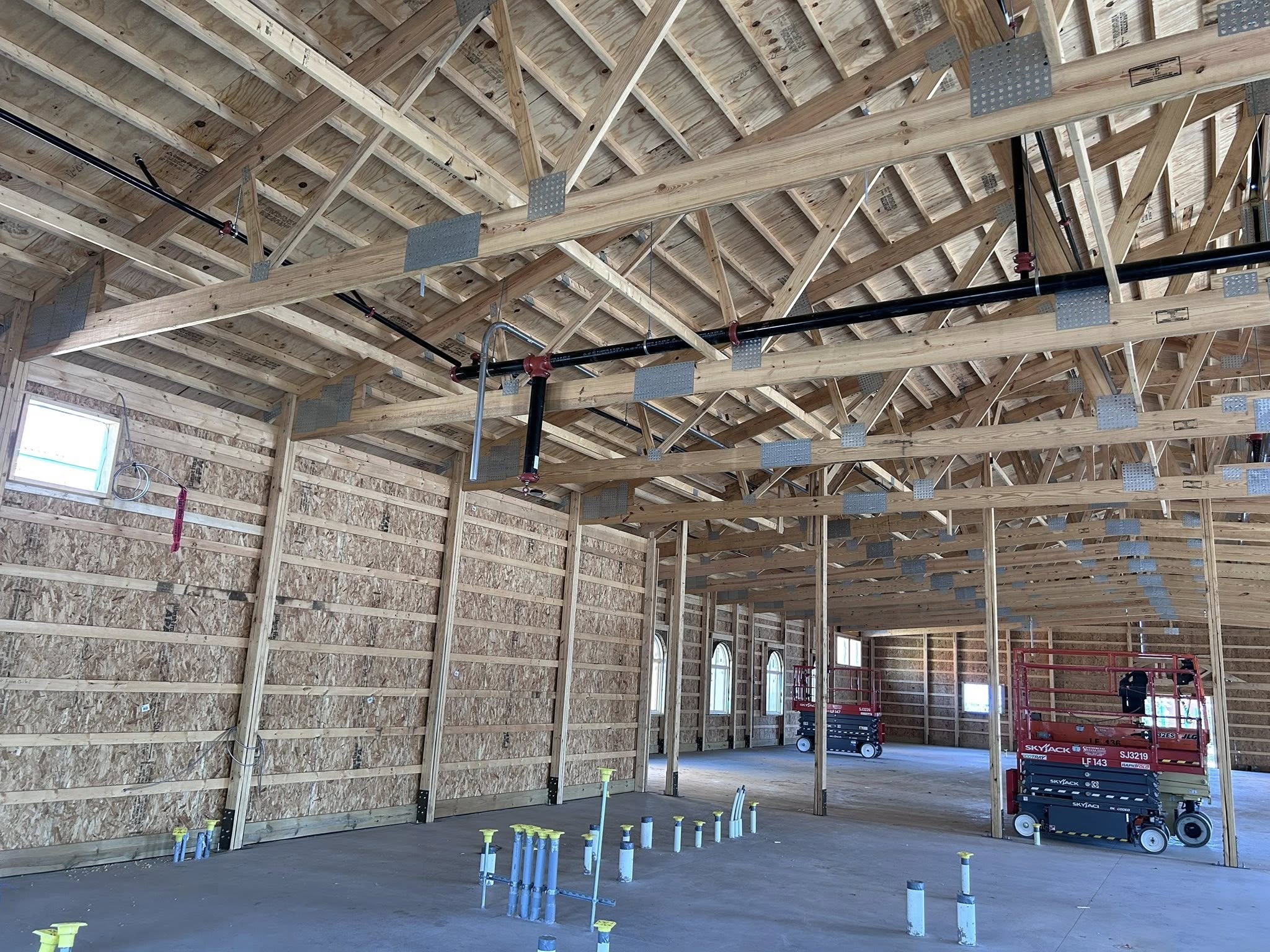

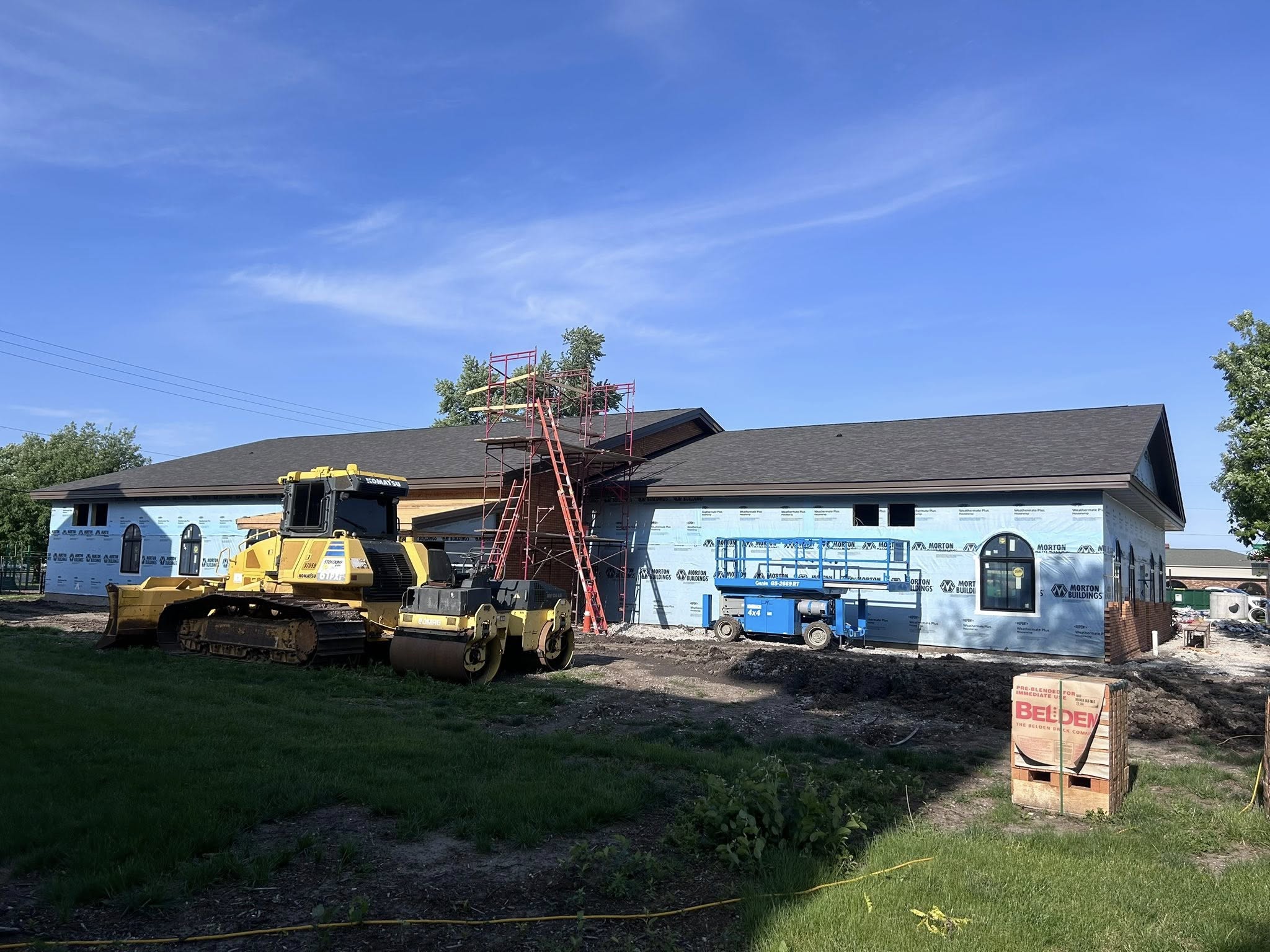

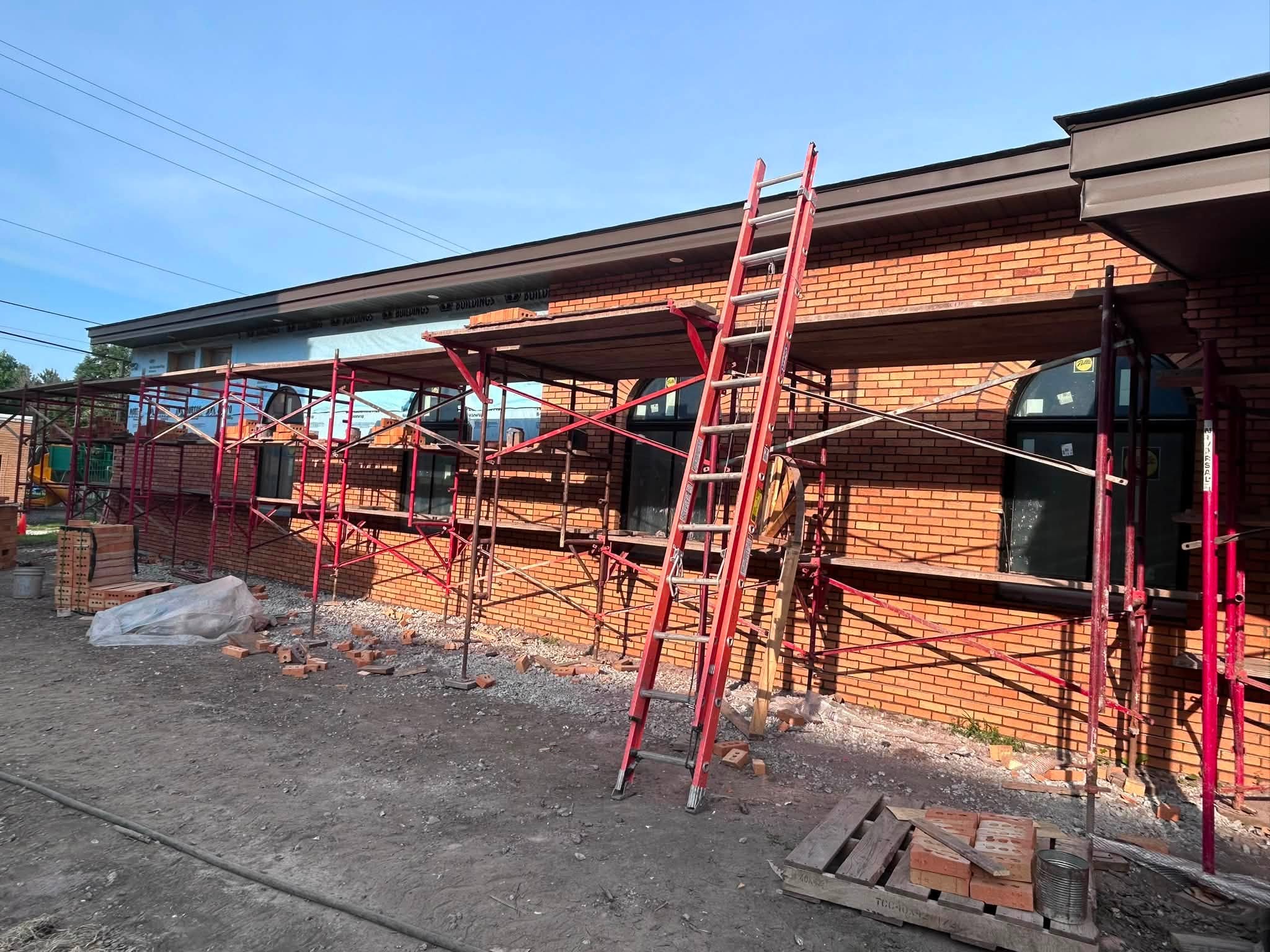

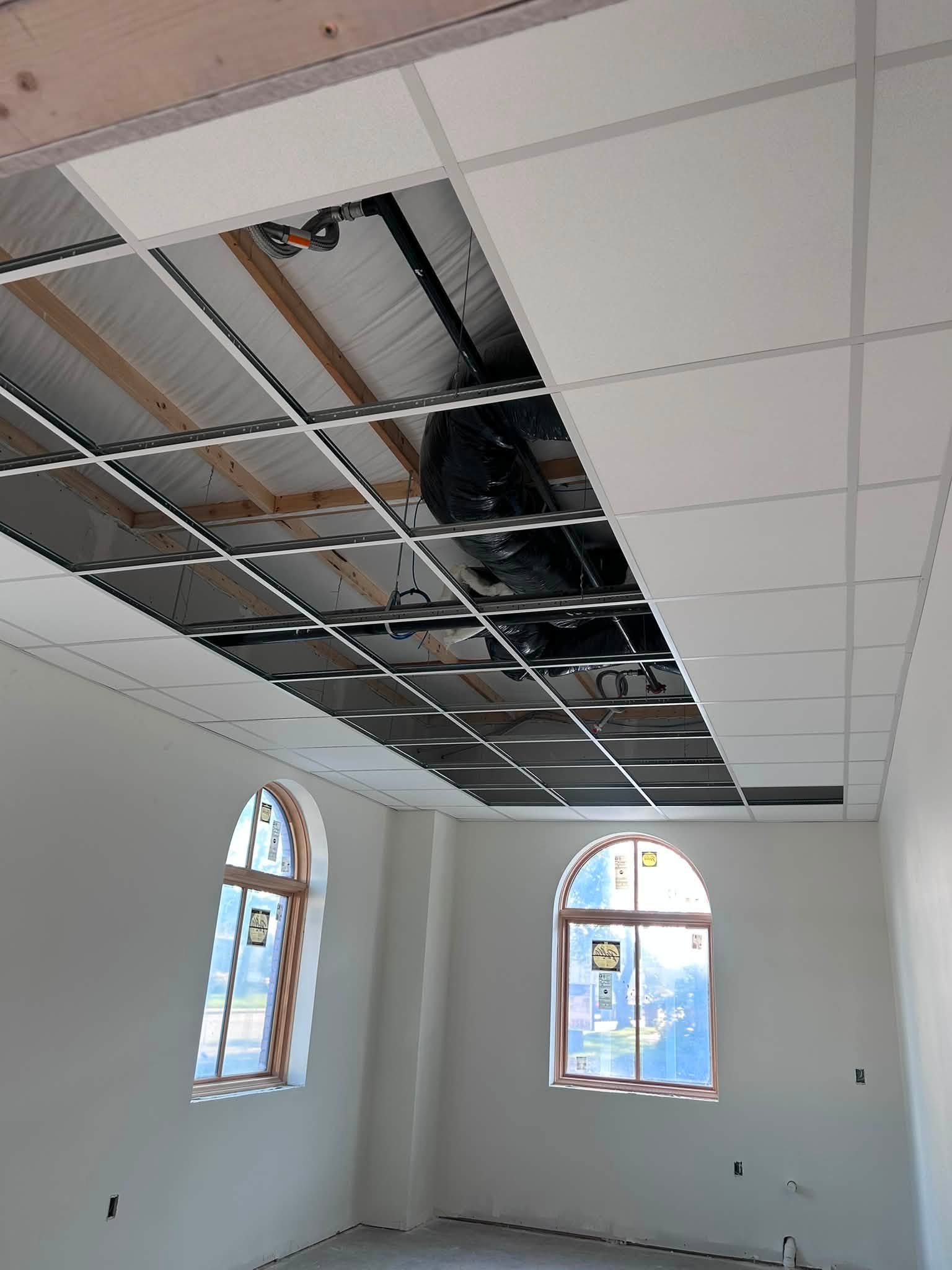

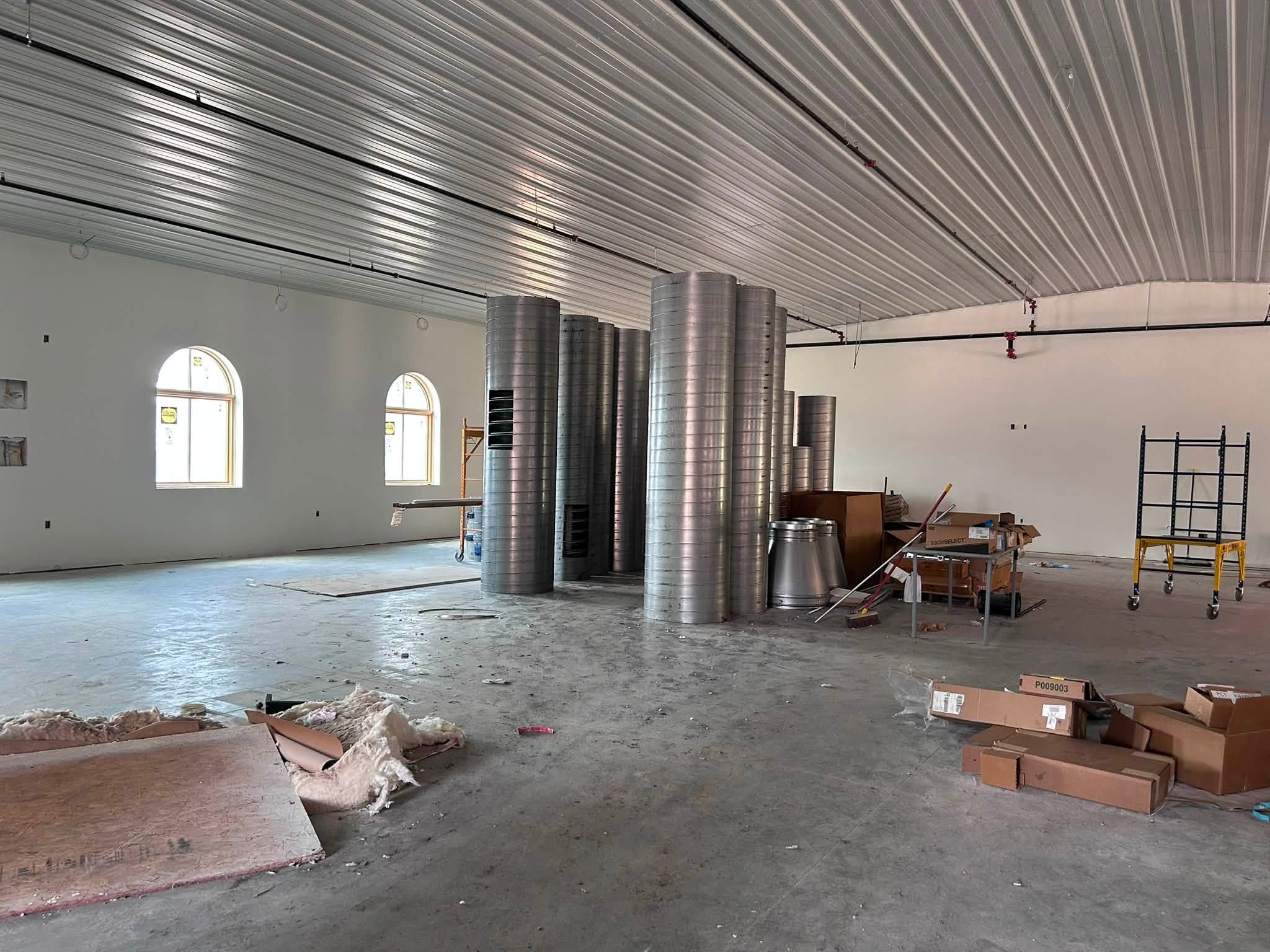

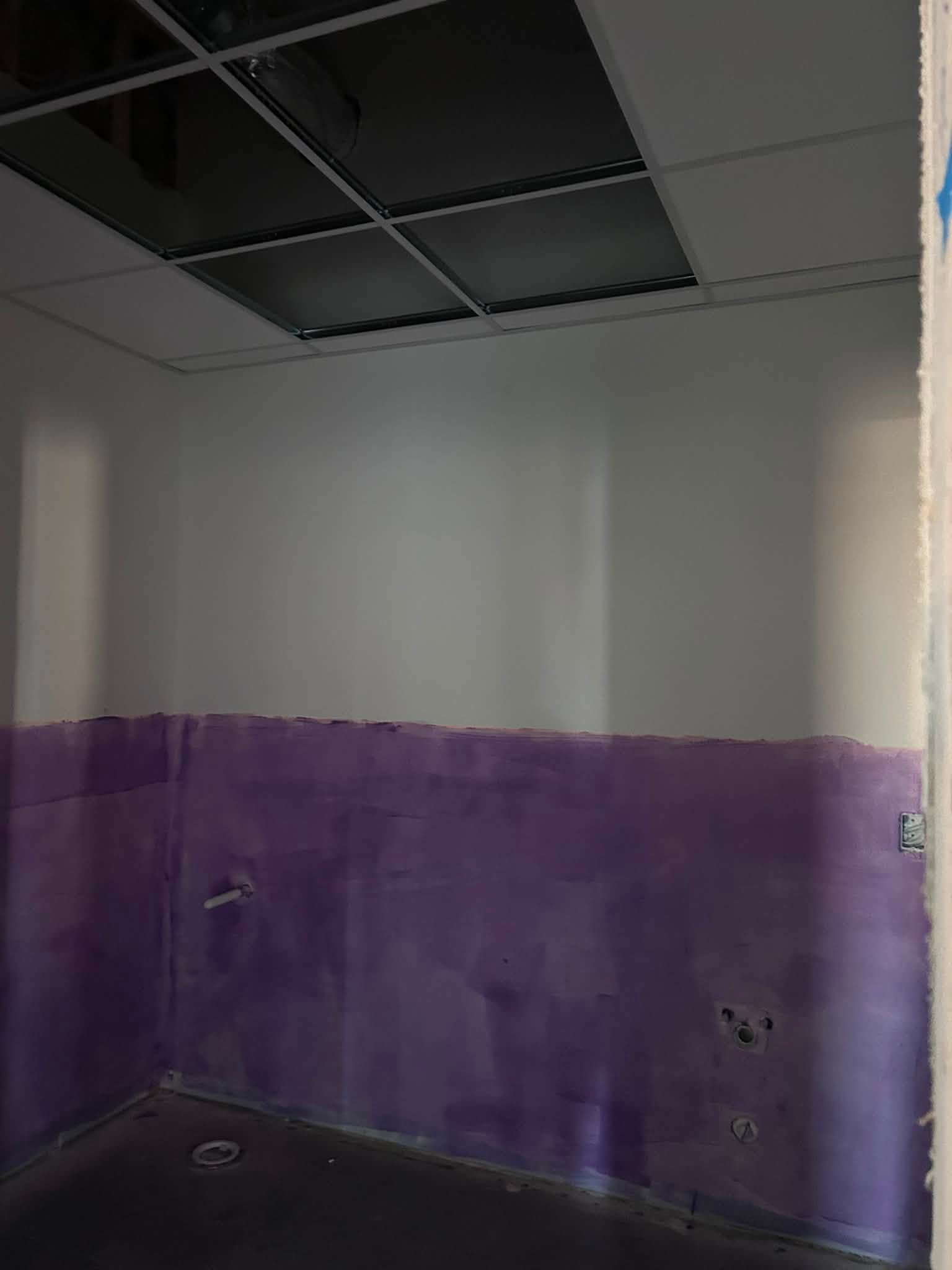

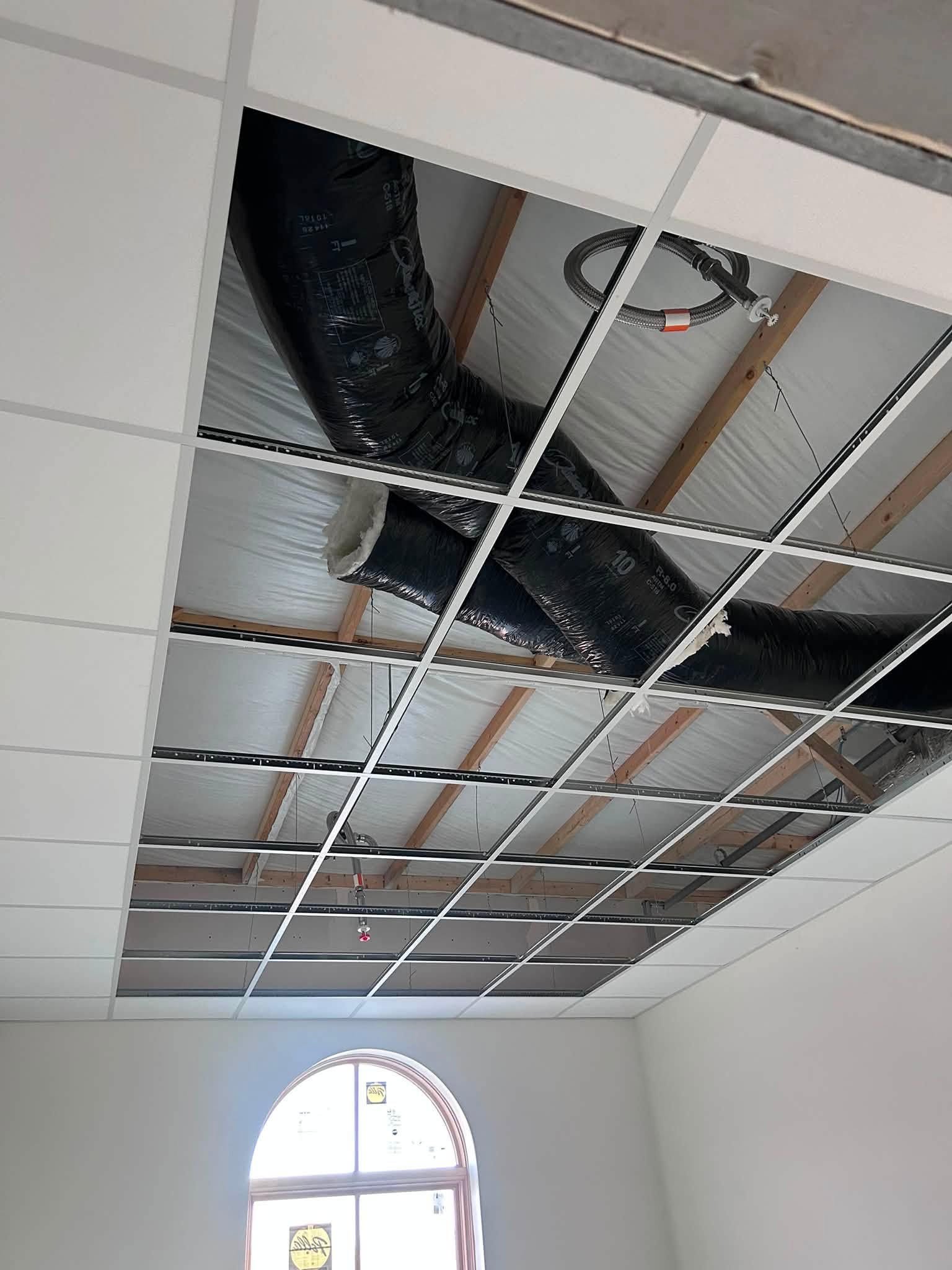

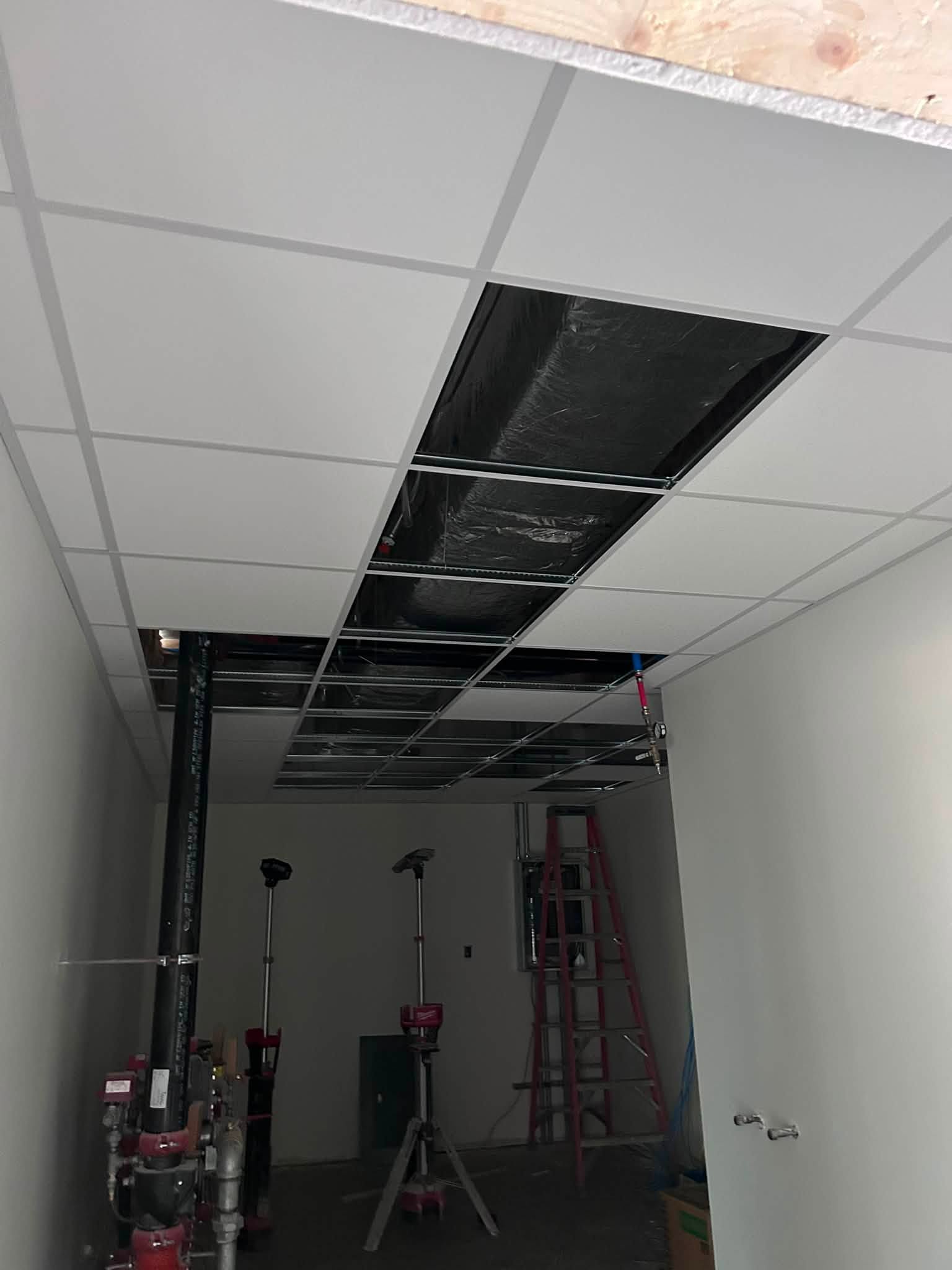

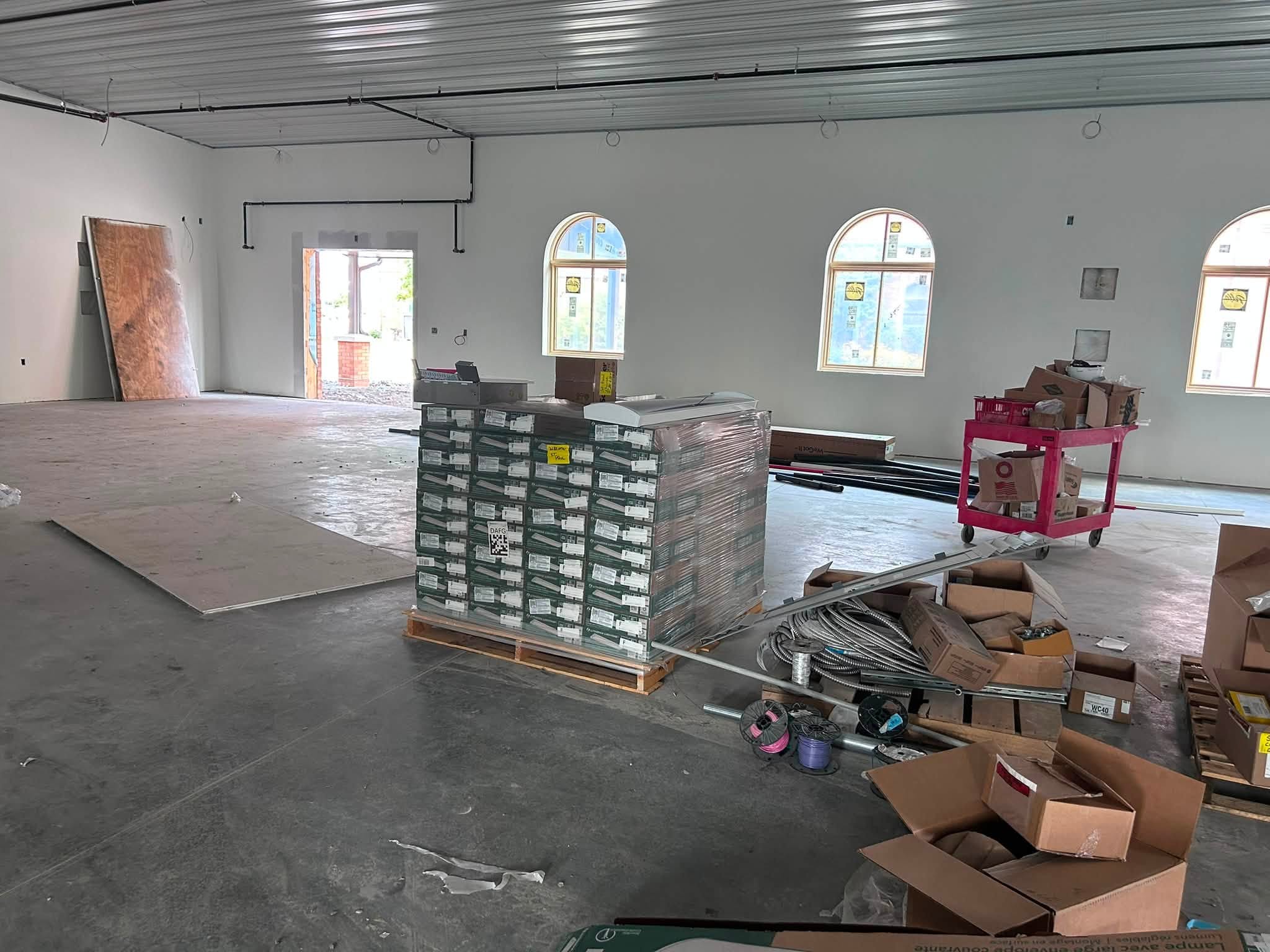

Due to the rain Friday they were only able to tease us with what the brick will look like. Today, with sun shining they are back at it! Looks so good!!
